Synthesizing managerial and technical knowledge to develop a competitive robot under constraints of limited experience, budget, and timeline. Enhancing skills and laying groundwork for continuous improvement over the project's timeline. Reviewing concepts, tools, and project planning to meet stringent competition requirements.
E N D
Guiding a Student Team Through the Process of Developing a Robot for the ATMAE Student Competition Synthesizing managerial and technical knowledge and skills:

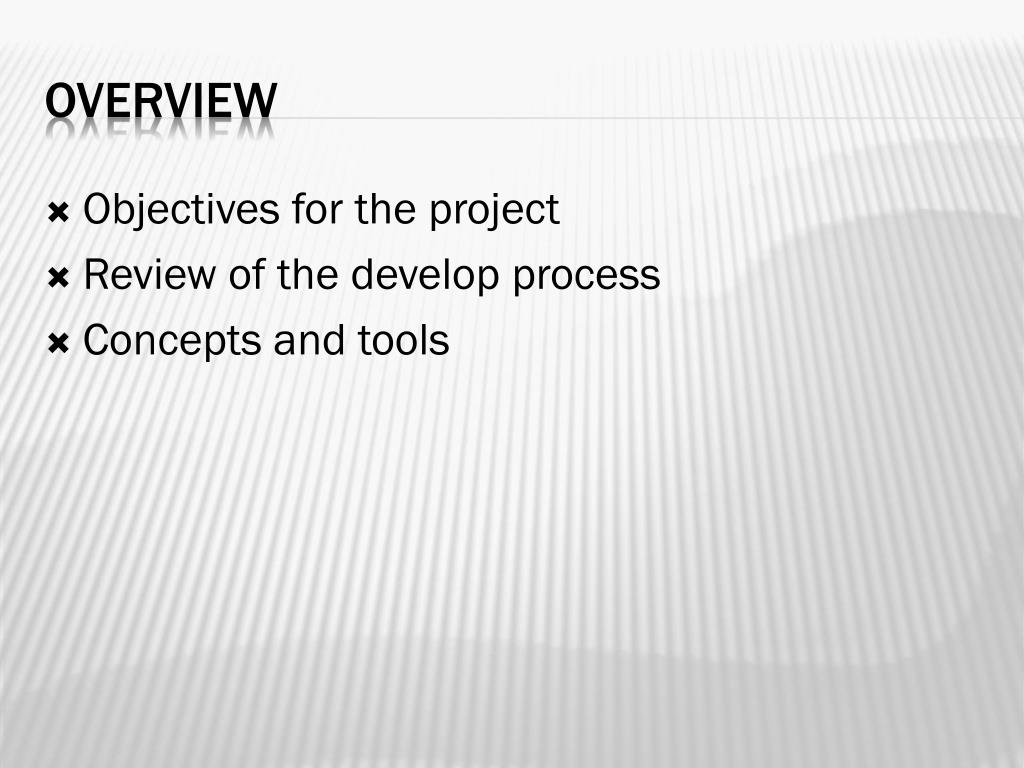

Objectives for the project Review of the develop process Concepts and tools overview
Develop a robot that can compete • Limited timeline • Limited experience • Stringent requirements • Small budget • Teach advanced concepts through application • Emergent objectives • Continuity for future years • Groundwork for continuous improvement objectives
Basic requirements: December 2009 • Complete requirements: February 2010 • Remotely-operated navigation from base to target area • Autonomous operation within target area: Find and retrieve a partially-submerged cylinder • Return cylinder to base • Constraints • Deadline = competition date • Budget = $1,500 from CWU + out of pocket • Limits of team expertise Requirements and constraints
Passive defenses • Heavy & Low CG • Rigid structure • Use a drive-over strategy and a large capture bay (reduces required level of precision) • Ease of service & transport System Design Principles
One successful iteration of task • Increase reliability via simplicity • Minimize parts • Minimize motions • Less sophisticated electronics • Less sophisticated programming Detail Design Principles
Questions? PowerPoint file available at: http://www.cwu.edu/~olsondar/robot Thank you
