JPL Update Danan Dong Michael Heflin Sharon Kedar Brian Newport Frank Webb JPL Status Report, SCIGN Annual Meeting, 4/26/2004

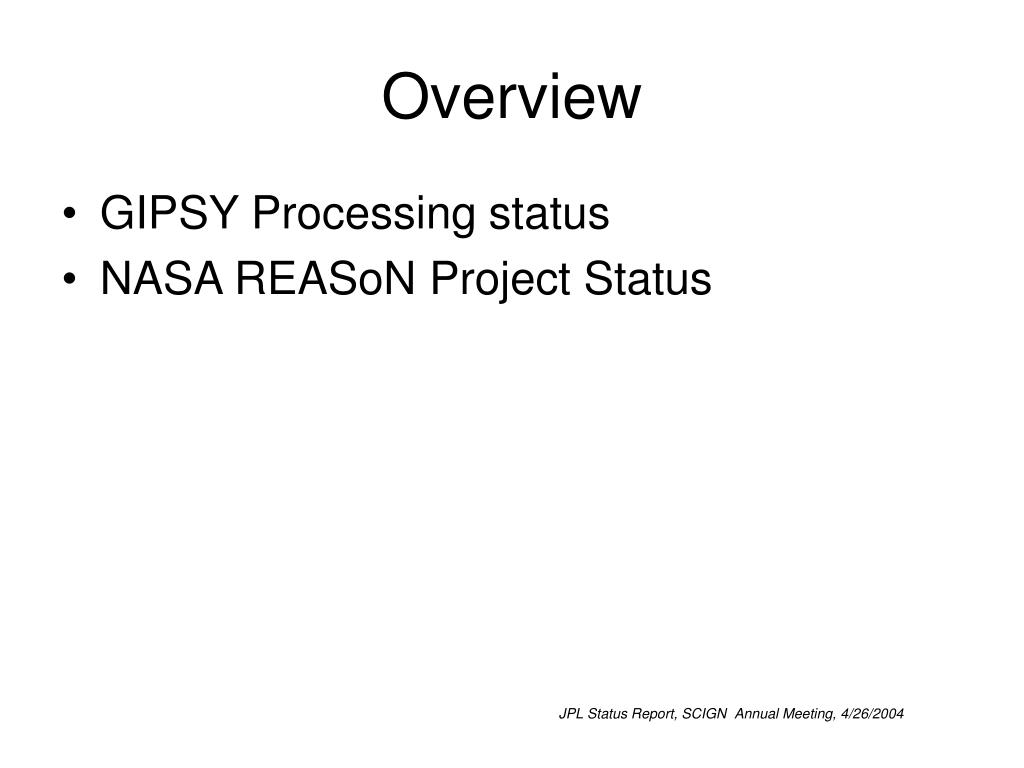

Overview • GIPSY Processing status • NASA REASoN Project Status JPL Status Report, SCIGN Annual Meeting, 4/26/2004

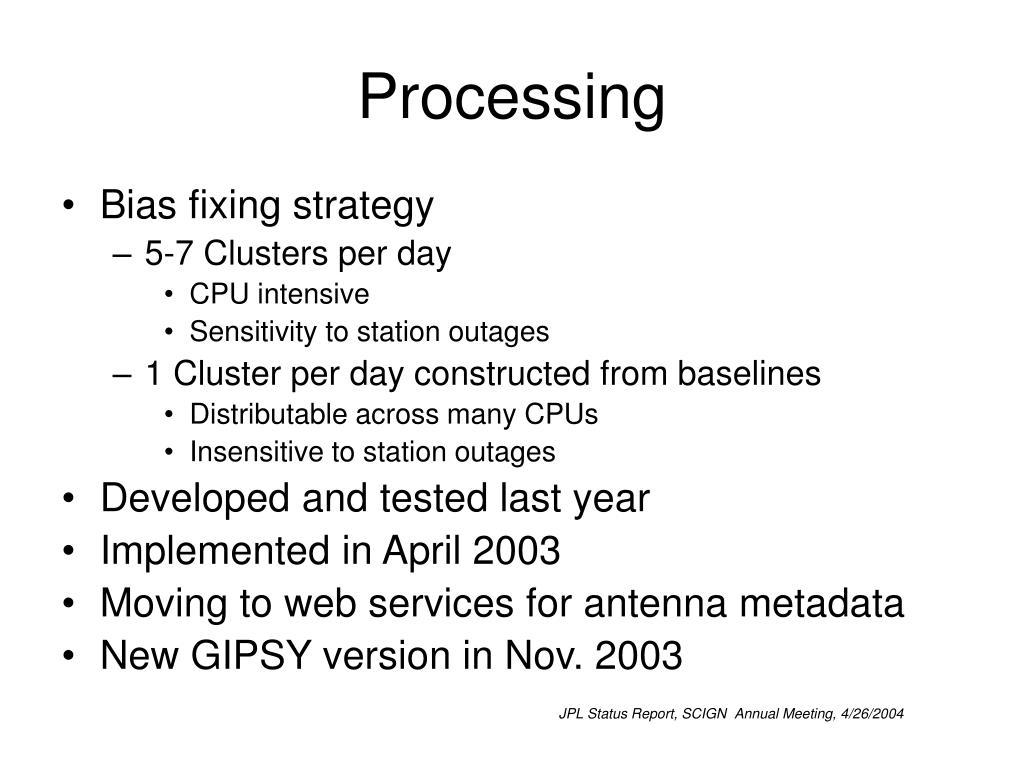

Processing • Bias fixing strategy • 5-7 Clusters per day • CPU intensive • Sensitivity to station outages • 1 Cluster per day constructed from baselines • Distributable across many CPUs • Insensitive to station outages • Developed and tested last year • Implemented in April 2003 • Moving to web services for antenna metadata • New GIPSY version in Nov. 2003 JPL Status Report, SCIGN Annual Meeting, 4/26/2004

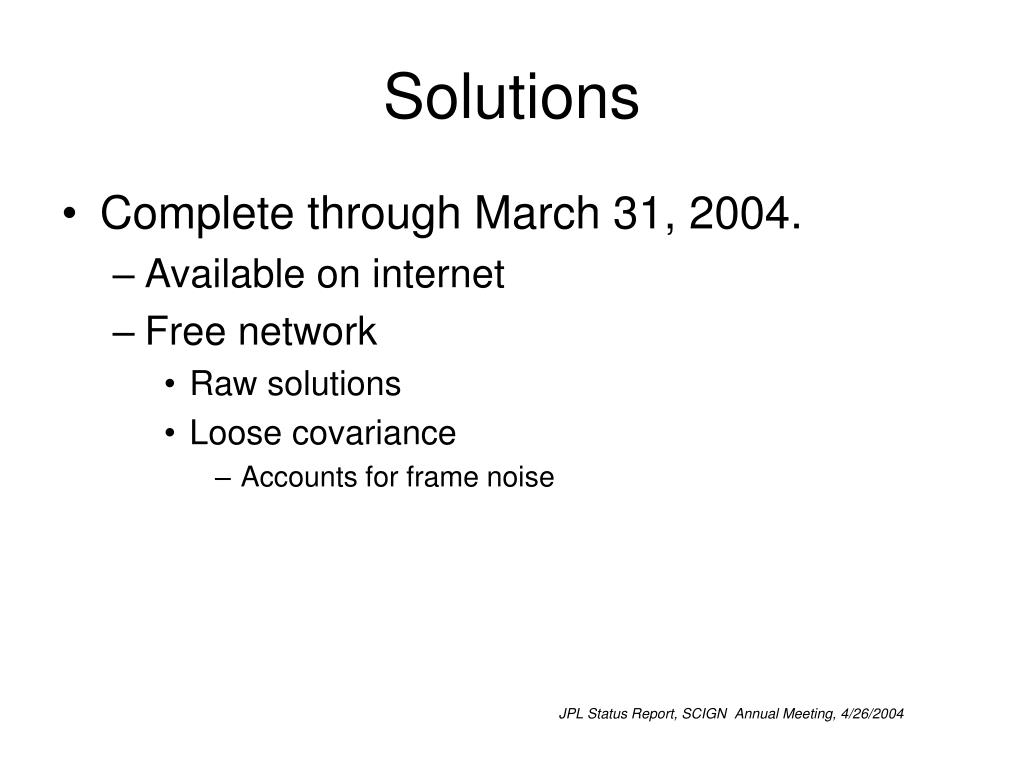

Solutions • Complete through March 31, 2004. • Available on internet • Free network • Raw solutions • Loose covariance • Accounts for frame noise JPL Status Report, SCIGN Annual Meeting, 4/26/2004
REASoN • Reminder of Our Goals • How we are organized • A High Level Requirement • High Level Architecture • Baseline Schedule • Status JPL Status Report, SCIGN Annual Meeting, 4/26/2004

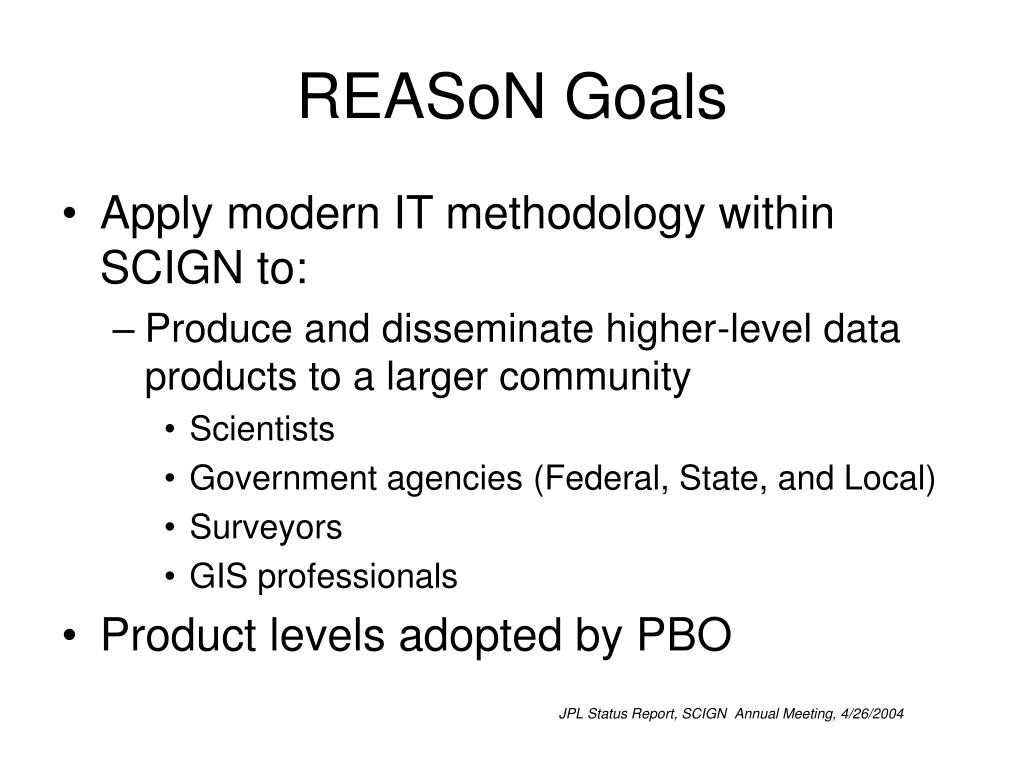

REASoN Goals • Apply modern IT methodology within SCIGN to: • Produce and disseminate higher-level data products to a larger community • Scientists • Government agencies (Federal, State, and Local) • Surveyors • GIS professionals • Product levels adopted by PBO JPL Status Report, SCIGN Annual Meeting, 4/26/2004

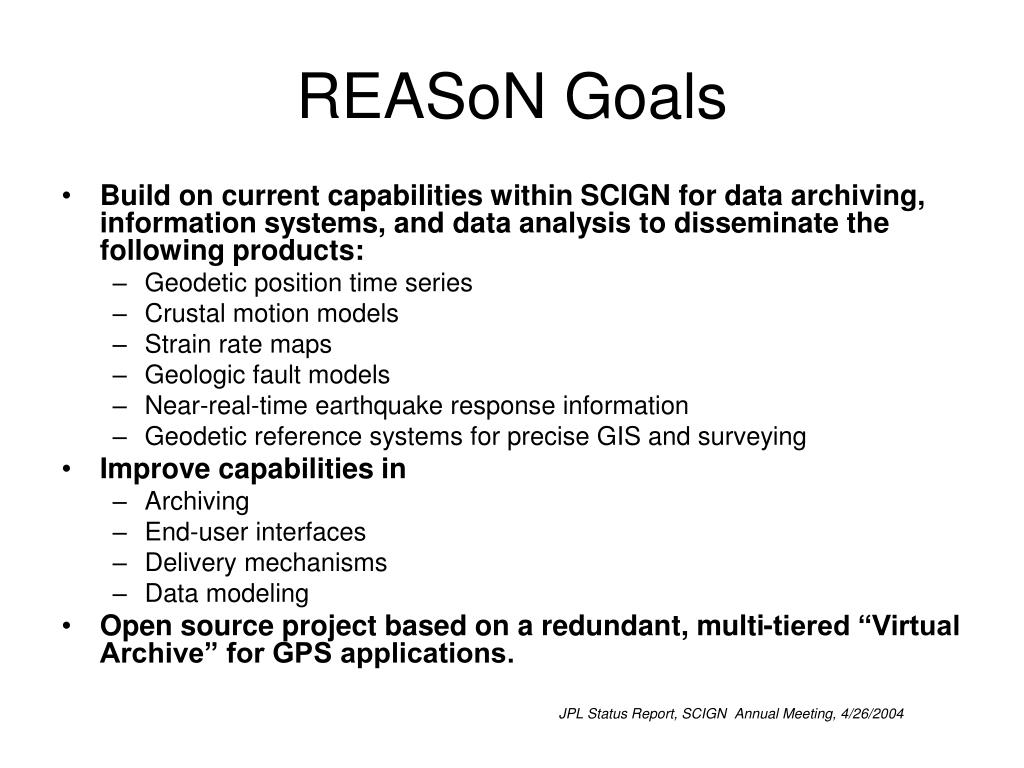

REASoN Goals • Build on current capabilities within SCIGN for data archiving, information systems, and data analysis to disseminate the following products: • Geodetic position time series • Crustal motion models • Strain rate maps • Geologic fault models • Near-real-time earthquake response information • Geodetic reference systems for precise GIS and surveying • Improve capabilities in • Archiving • End-user interfaces • Delivery mechanisms • Data modeling • Open source project based on a redundant, multi-tiered “Virtual Archive” for GPS applications. JPL Status Report, SCIGN Annual Meeting, 4/26/2004
How we are organized • Around Four systems • Product Input • Seamless Archive • Web services • GPS Data Processing • GAMIT and GIPSY • Product Generation • QOCA Based • Product Output • Virtual Archive • Web services • Meta data • Products • Plus two NASA requirements • NASA SEEDs participation • Standards Working Group • Open Source Project • Virtual Archive JPL Status Report, SCIGN Annual Meeting, 4/26/2004
A High Level Requirement • Need • Processing centers and processes use the same input data • Goal • All processing retrieves data from a common source • Objective • Seamless Archive • Web services • Pull data at time of analysis • Push results into archive • Pull products from archive for distribution JPL Status Report, SCIGN Annual Meeting, 4/26/2004
High Level Architecture JPL Status Report, SCIGN Annual Meeting, 4/26/2004
Architecture Interfaces • Next slide shows • Functions on the diagonal • Interfaces on the off diagonals • Who and what in the off diagonal boxes JPL Status Report, SCIGN Annual Meeting, 4/26/2004
Architecture Interfaces JPL Status Report, SCIGN Annual Meeting, 4/26/2004

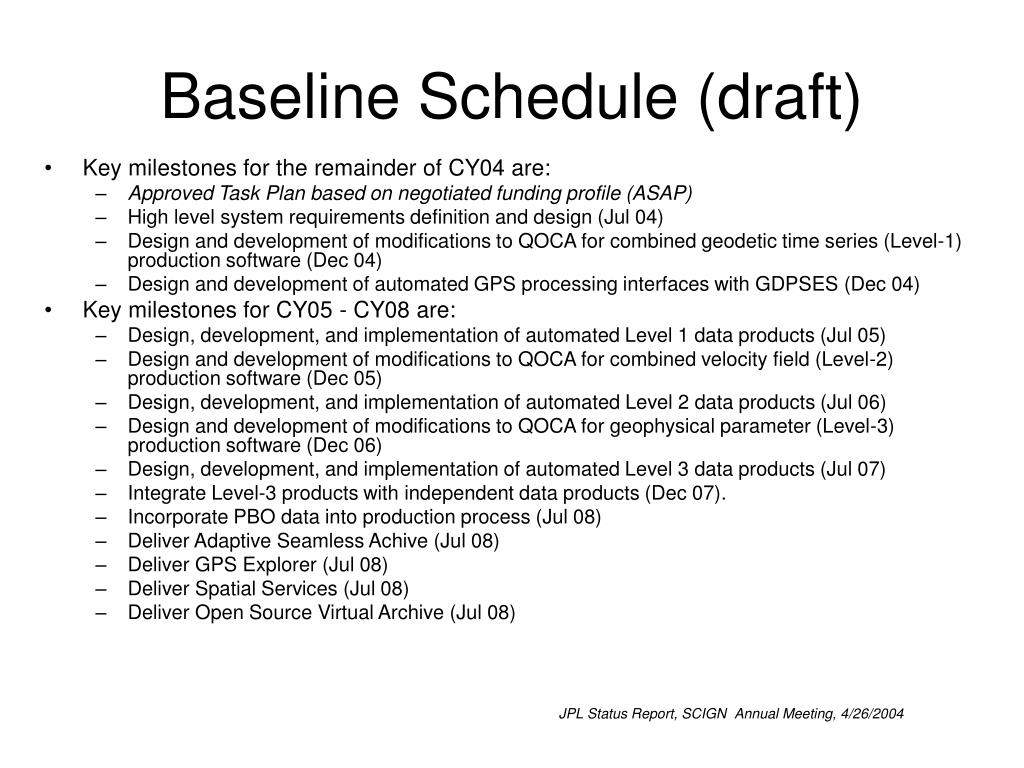

Baseline Schedule (draft) • Key milestones for the remainder of CY04 are: • Approved Task Plan based on negotiated funding profile (ASAP) • High level system requirements definition and design (Jul 04) • Design and development of modifications to QOCA for combined geodetic time series (Level-1) production software (Dec 04) • Design and development of automated GPS processing interfaces with GDPSES (Dec 04) • Key milestones for CY05 - CY08 are: • Design, development, and implementation of automated Level 1 data products (Jul 05) • Design and development of modifications to QOCA for combined velocity field (Level-2) production software (Dec 05) • Design, development, and implementation of automated Level 2 data products (Jul 06) • Design and development of modifications to QOCA for geophysical parameter (Level-3) production software (Dec 06) • Design, development, and implementation of automated Level 3 data products (Jul 07) • Integrate Level-3 products with independent data products (Dec 07). • Incorporate PBO data into production process (Jul 08) • Deliver Adaptive Seamless Achive (Jul 08) • Deliver GPS Explorer (Jul 08) • Deliver Spatial Services (Jul 08) • Deliver Open Source Virtual Archive (Jul 08) JPL Status Report, SCIGN Annual Meeting, 4/26/2004
Status • Organized into initial teams • Worked most of the high level architecture • Working requirements and definitions of interfaces for CY04: • Processing • Archive • Web services • Working formats • Internal product and data sharing • Prototyped XML schema and formats for metadata and time series products • Product generation • Testing QOCA against GLOBK • Loosely constrained agrees to sub-millimeter level • Initial modifications to QOCA for S/T filter has begun JPL Status Report, SCIGN Annual Meeting, 4/26/2004
Status • Project library • Document sharing web site for team • Configuration control • Password protected • https://scign-lib.jpl.nasa.gov • NASA • Currently on startup funds • Draft task plan near completion for remaining funds • PBO • Initial discussions have received a “Ho-Hum” response JPL Status Report, SCIGN Annual Meeting, 4/26/2004
