Preactor. BCT Preactor Interface v11. A tour of the integration between Macola ES / Progression and Preactor V11. About BCT.

habib
Télécharger la présentation

BCT Preactor Interface v11

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Preactor BCT Preactor Interface v11 A tour of the integration between Macola ES / Progression and Preactor V11

  2. About BCT Since 1984, Business Computer Technologies, Inc. has recognized the importance of utilizing current technology within the business processes of companies in the manufacturing and distribution markets. BCT also recognized that in order to provide the best solutions, we needed to have the fundamental skills that enable us to pass on knowledge to the customers we serve. We continue to deploy this business philosophy through the implementation and support of back-office and add-on solutions that provide the highest level of ROI for our customers. In 2003, BCT partnered with Preactor International and Quinn & Associates to provide integration to a World Class Finite Capacity Graphical Scheduling system to our clients.

  3. BCT Preactor Interface v11 The BCT Preactor Interface provides a complete interface between Macola ES / Progression (SQL) and the Preactor V11 Graphical Finite Capacity Scheduling system. The BCT Preactor Interface is bi-directional movement of data. Initially, we draw upon the current orders in the Shop Floor or Production Order modules, then the production planner is allowed to fine tune the schedule to match your needs, and lastly the information is updated in Macola.

  4. Preactor Download Touch Points

  5. Download to Preactor Touch Points Information that is utilized from the Shop Order Header records when creating records in Preactor. Information that is utilized from the Shop Order Detail records when creating records in Preactor. Order Status Operation Status Start Date End Date Order Pegging

  6. Download to Preactor Touch Points Shop Order Detail records: Department Setup Machine Hrs Work Center Setup Labor Hrs Operation Status Machine No Remaining Quantity Machine Hours Labor Hours FCS Start Date Process Hours FCS Start Time Queue Days FCS End Date Outside Processes FCS End Time

  7. Download to Preactor Touch Points Information that is captured from the Preactor uploads to assist in maintaining the continuity of prior finite capacity plans. Locked Operation Resource Group Required Resource

  8. Preactor Smart Material Pegging

  9. Smart Material Pegging Manufacturing order operation’s earliest start date is established from the material availability. Materials that can be pegged from current inventory stock levels are assigned an earliest start date of today. Materials that can be pegged from purchase orders are assigned an earliest start date from the request / promised date. Remaining materials are assigned an earliest start date from today’s date plus the PO Lead time.

  10. Preactor Upload from Preactor Touch Points

  11. Upload from Preactor Touch Points Information that is utilized from Preactor to update the Macola ES / Progression Shop Order Header records. Information that is utilized from Preactor to update the Macola ES / Progression Shop Order Detail records. Start Date End Date Start Date End Date FCS Start Date FCS Start Time

  12. Upload from Preactor Touch Points Shop Order Detail records: To allow the information to be display on the on-line dispatch screen in the same order as it was scheduled in Preactor, the priority code field is updated. FCS End Date FCS End Time FCS Schedule Priority Code

  13. Preactor Configuration Options

  14. Configuration Options General Options: ERP Software Preactor Version Macola ES Macola Progression Version 10 Version 11

  15. Configuration Options Download Options: Upload locked operations Download BOMs Exclude operations X days in the future Resources Resource Groups Secondary Constraints Hours Selection: Labor Hours Machine Hours Greater of Labor or Machine Hours

  16. Configuration Options Upload Options: Update Start Date on Shop Order Header records Update End Date on Shop Order Header records

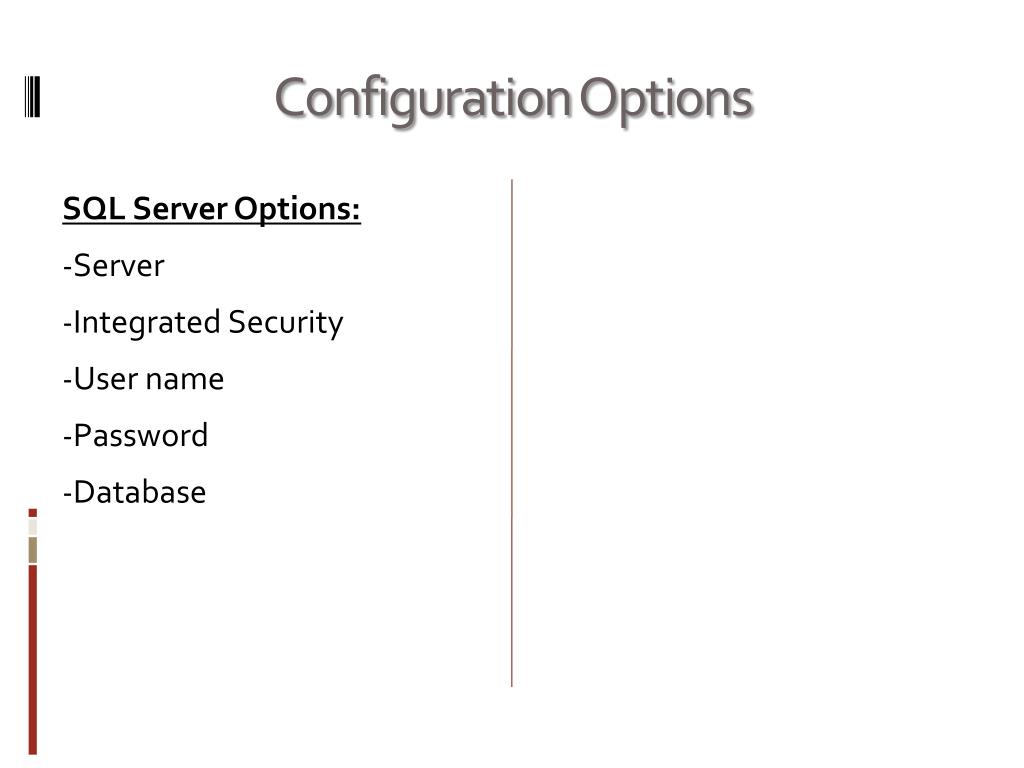

  17. Configuration Options SQL Server Options: Server Integrated Security User name Password Database

  18. Configuration Options Macola Download Options: Include Unreleased Orders Start Date from material availability rather than from the operation start date Select warehouses Use Process Time as Slack Time in Preactor Macola Upload Options: Update Shop Order User Defined Fields with original scheduled dates Export Preactor Material Pegging information to u_BCT_Preactor_Pegging table

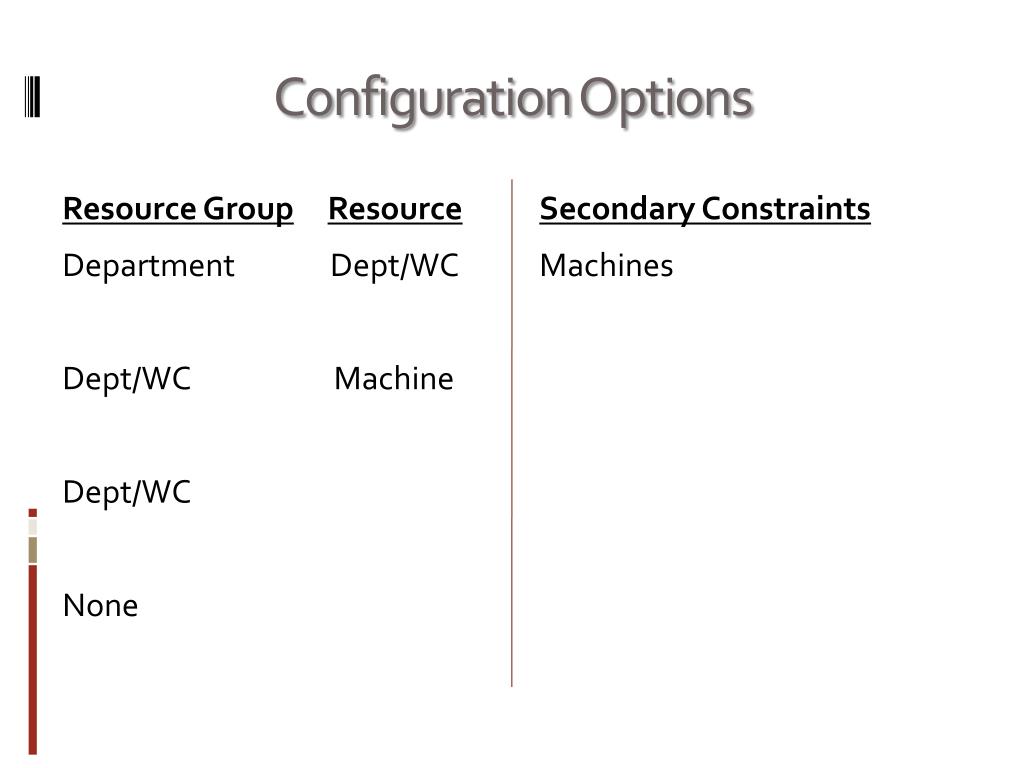

  19. Configuration Options Resource GroupResource Department Dept/WC Dept/WC Machine Dept/WC None Secondary Constraints Machines

  20. BCT Preactor Interface V11 The BCT Preactor Interface is the bridge that connects your Macola ES / Progression system with the most advanced finite capacity scheduling system in the world.
