J.H. Engineering Shaw Group Project Manager: Josh Hinkle Prepared for; Fran Lemieux

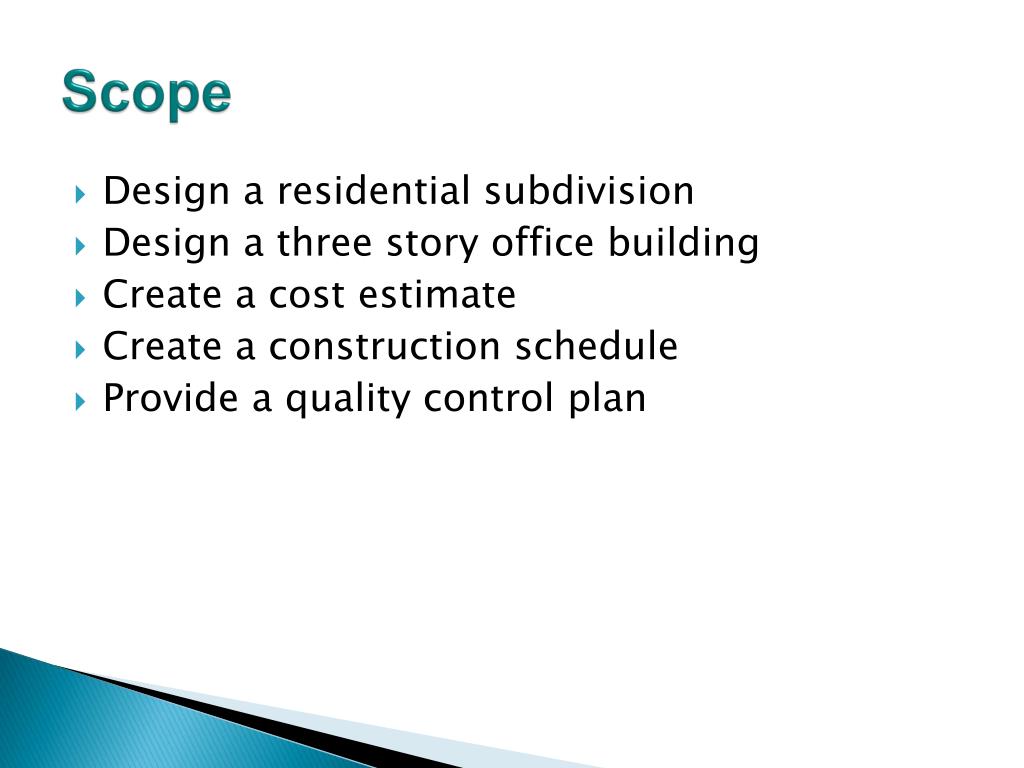

Scope • Design a residential subdivision • Design a three story office building • Create a cost estimate • Create a construction schedule • Provide a quality control plan

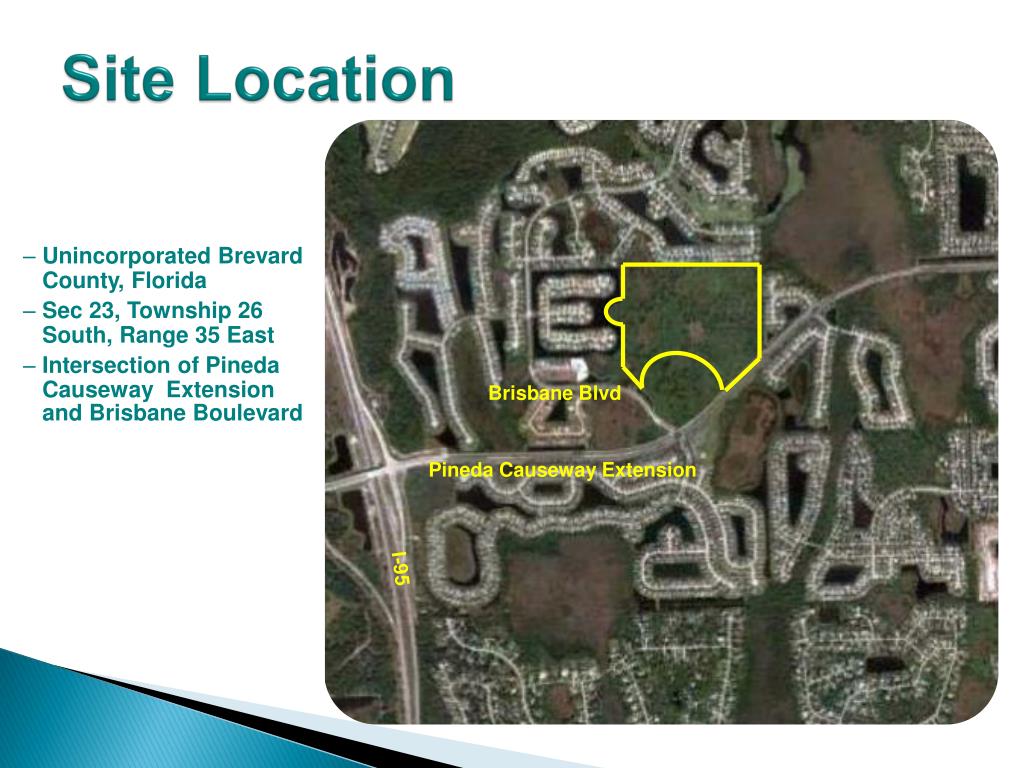

SiteLocation • Unincorporated Brevard County, Florida • Sec 23, Township 26 South, Range 35 East • Intersection of Pineda Causeway Extension and Brisbane Boulevard Brisbane Blvd Pineda Causeway Extension I-95

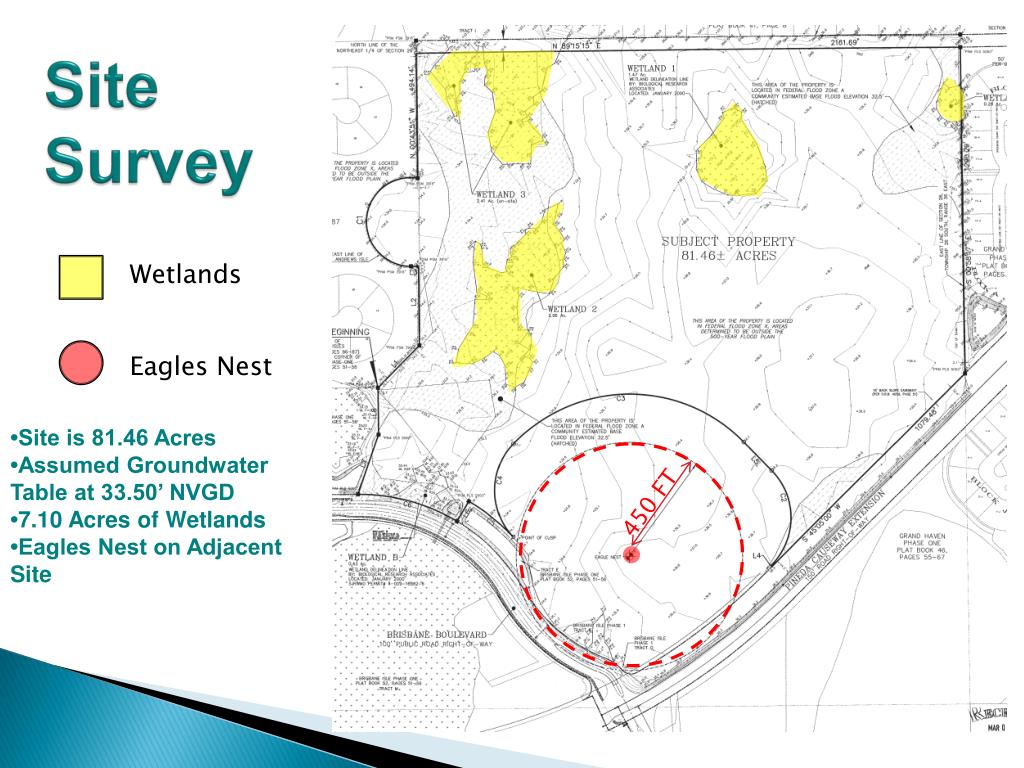

Site Survey Wetlands Eagles Nest •Site is 81.46 Acres •Assumed Groundwater Table at 33.50’ NVGD •7.10 Acres of Wetlands •Eagles Nest on Adjacent Site 450 FT

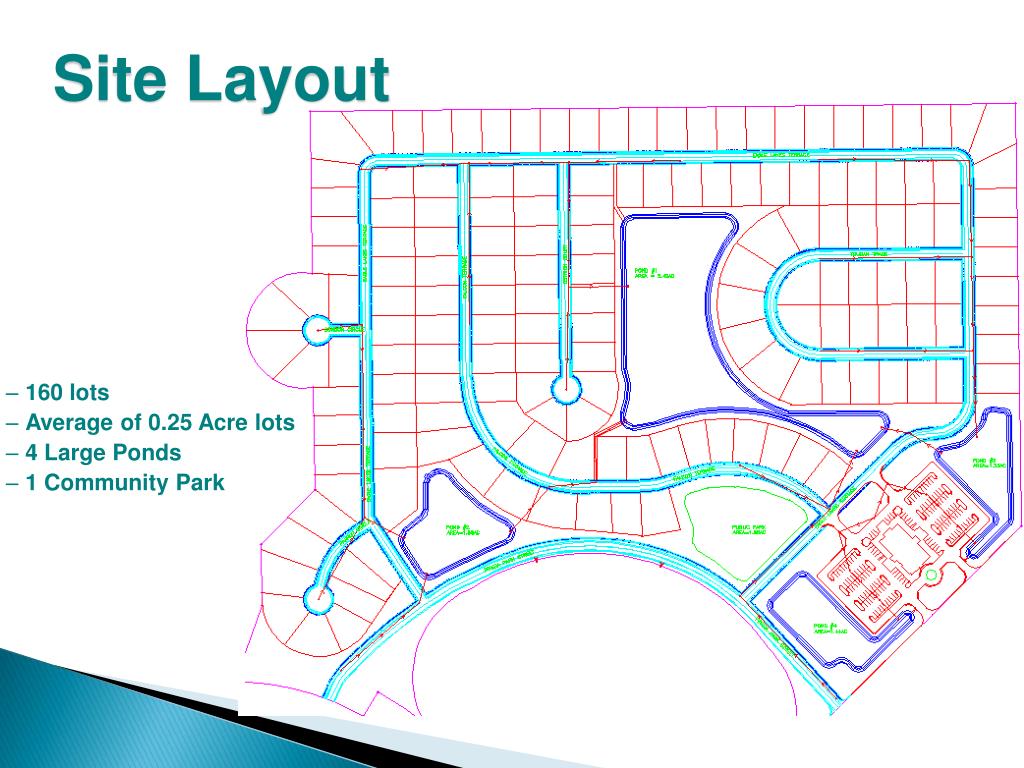

Site Layout • 160 lots • Average of 0.25 Acre lots • 4 Large Ponds • 1 Community Park

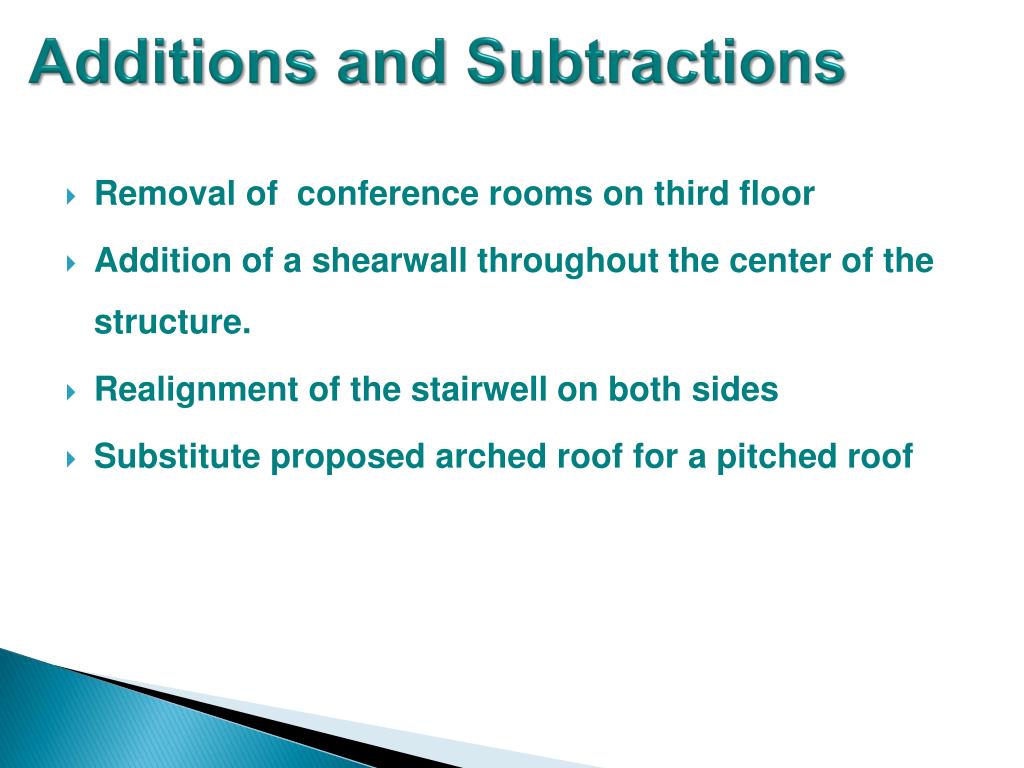

Additions and Subtractions • Removal of conference rooms on third floor • Addition of a shearwall throughout the center of the structure. • Realignment of the stairwell on both sides • Substitute proposed arched roof for a pitched roof

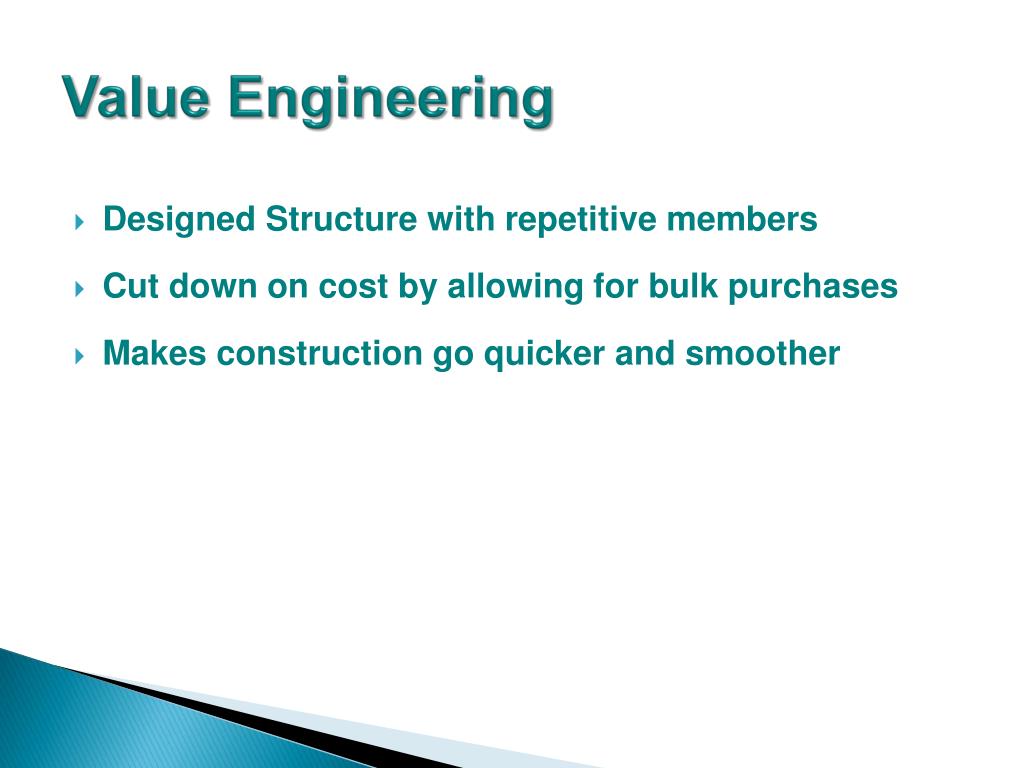

Value Engineering • Designed Structure with repetitive members • Cut down on cost by allowing for bulk purchases • Makes construction go quicker and smoother

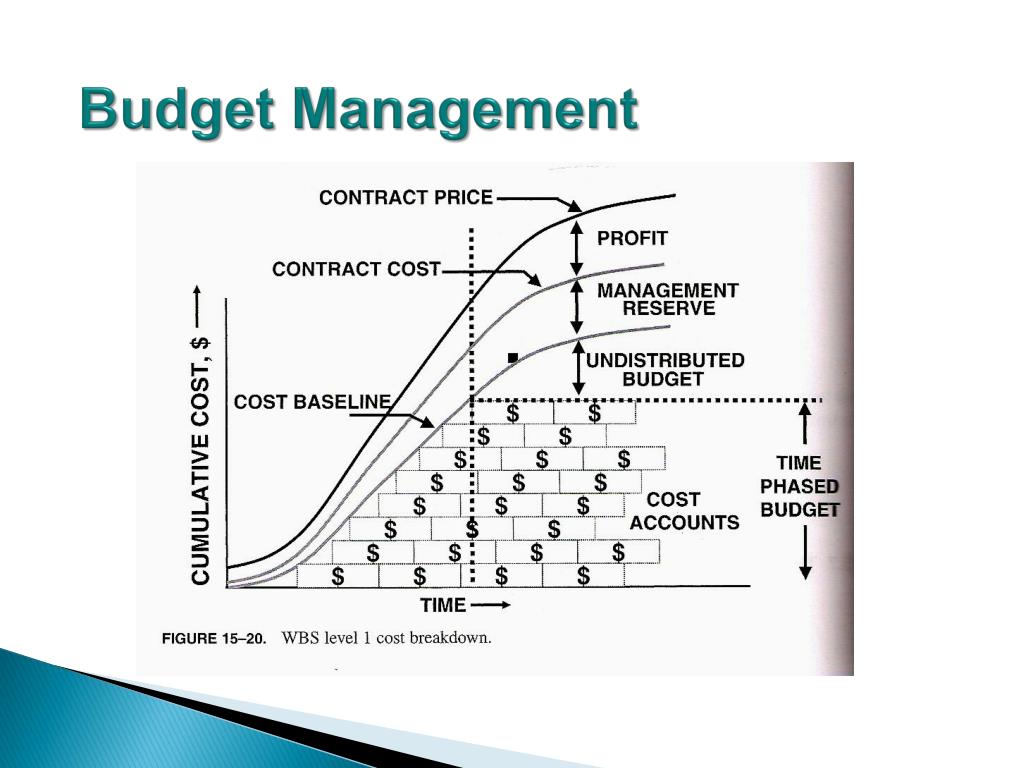

Budget Plan • Pay for: • Design work • Change orders • Building materials • Objectives – to keep final cost at or below the cost baseline to allow for maximum profits.

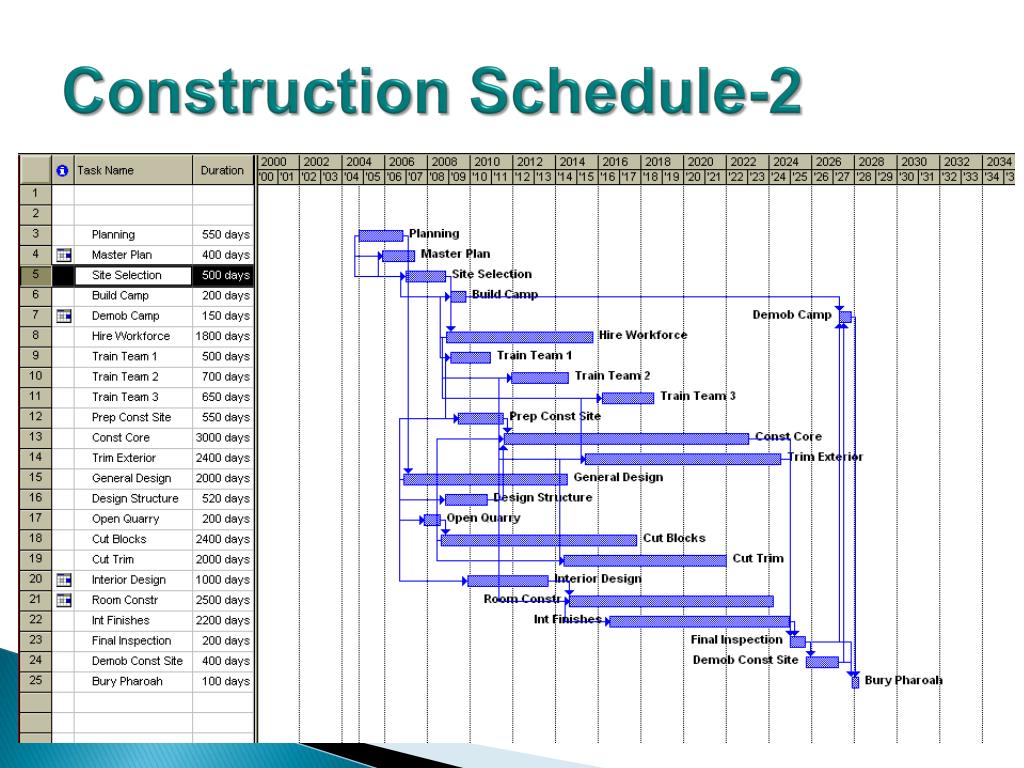

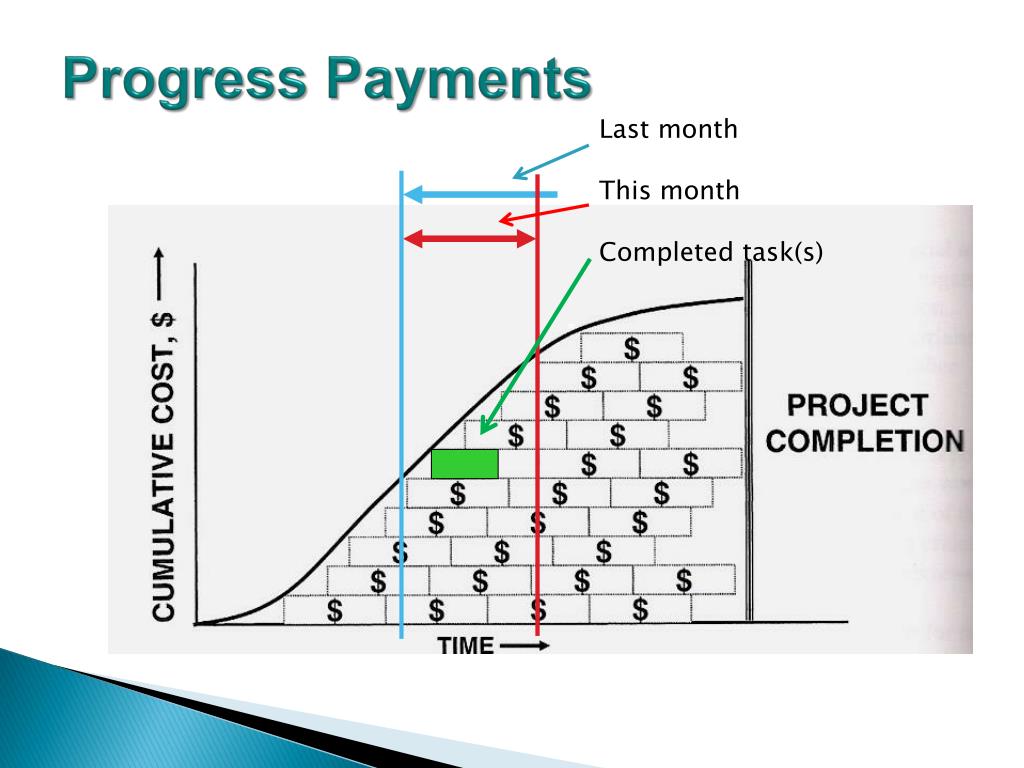

Progress Payments Last month This month Completed task(s)
Quality Control Plan • Preparatory inspection – generally a meeting • Pre-inspection – prior to placement or cover-up • Final inspection – after work completed; prior to payment

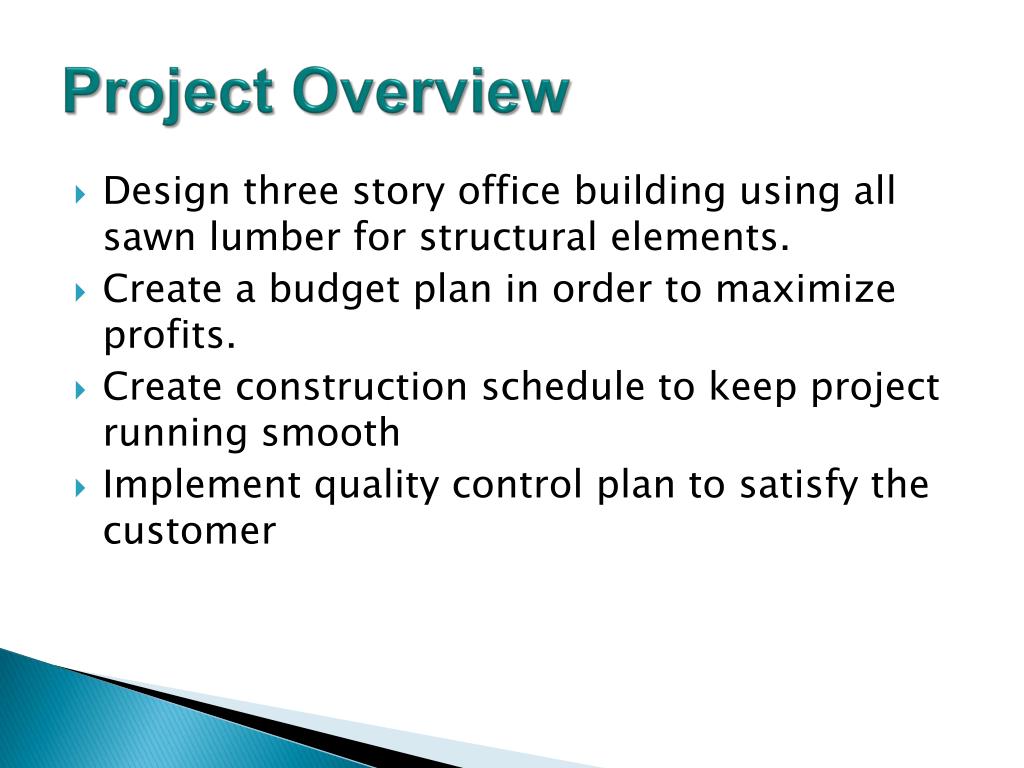

Project Overview • Design three story office building using all sawn lumber for structural elements. • Create a budget plan in order to maximize profits. • Create construction schedule to keep project running smooth • Implement quality control plan to satisfy the customer
Thank You Shaw Group ,Inc. If there are any questions feel free to contact me at: Josh Hinkle jhinkle2008@my.fit.edu (239)-634-4656
