DESCRIPTION

TeamDynamixHE Project Manager Training. Login. http://projects.kennesaw.edu/ Click User Login. Login. https:// www.teamdynamix.com/KennesawTDNext/Login.aspx Log in using KSU Net I.D. and Password. Set Up - Applications.

1 / 86

Télécharger la présentation

TeamDynamixHE Project Manager Training

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. TeamDynamixHEProject Manager Training

  2. Login • http://projects.kennesaw.edu/ • Click User Login

  3. Login • https://www.teamdynamix.com/KennesawTDNext/Login.aspx • Log in using KSU Net I.D. and Password

  4. Set Up - Applications • Click the Application drop down and select Projects from the drop down menu

  5. Set Up - Desktop • Click Projects tab and then Edit Project Desktop

  6. Set Up - Desktop • Click and drag modules to the columns as you see fit then save and close the pop-up.

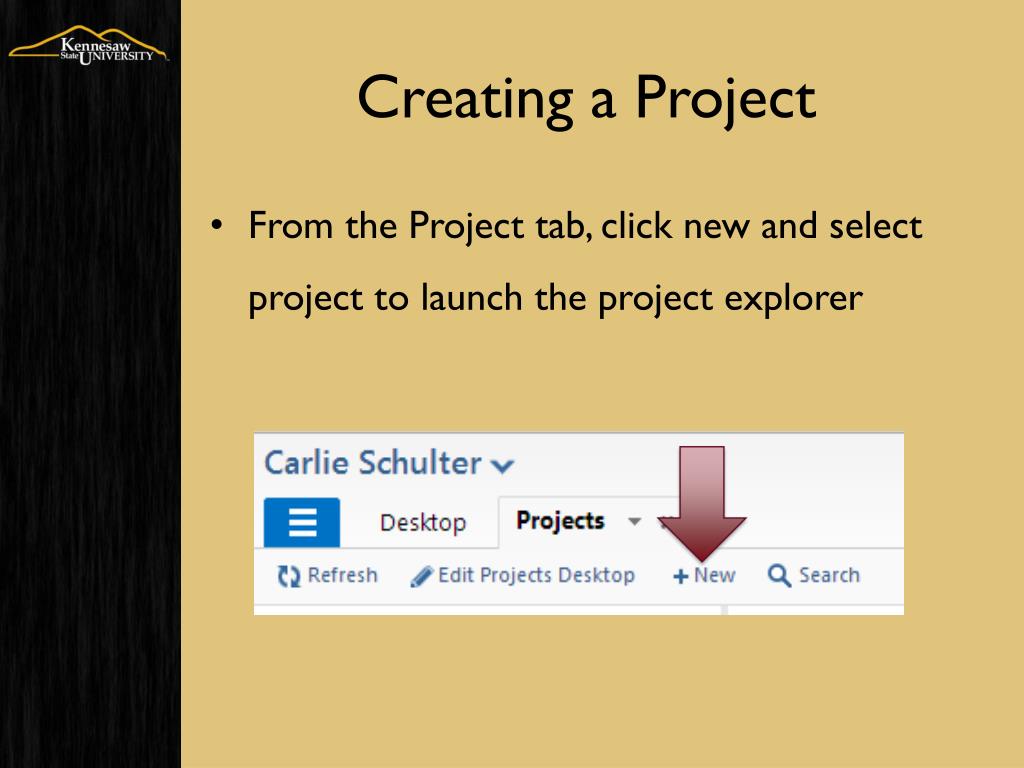

  7. Creating a Project • From the Project tab, click new and select project to launch the project explorer

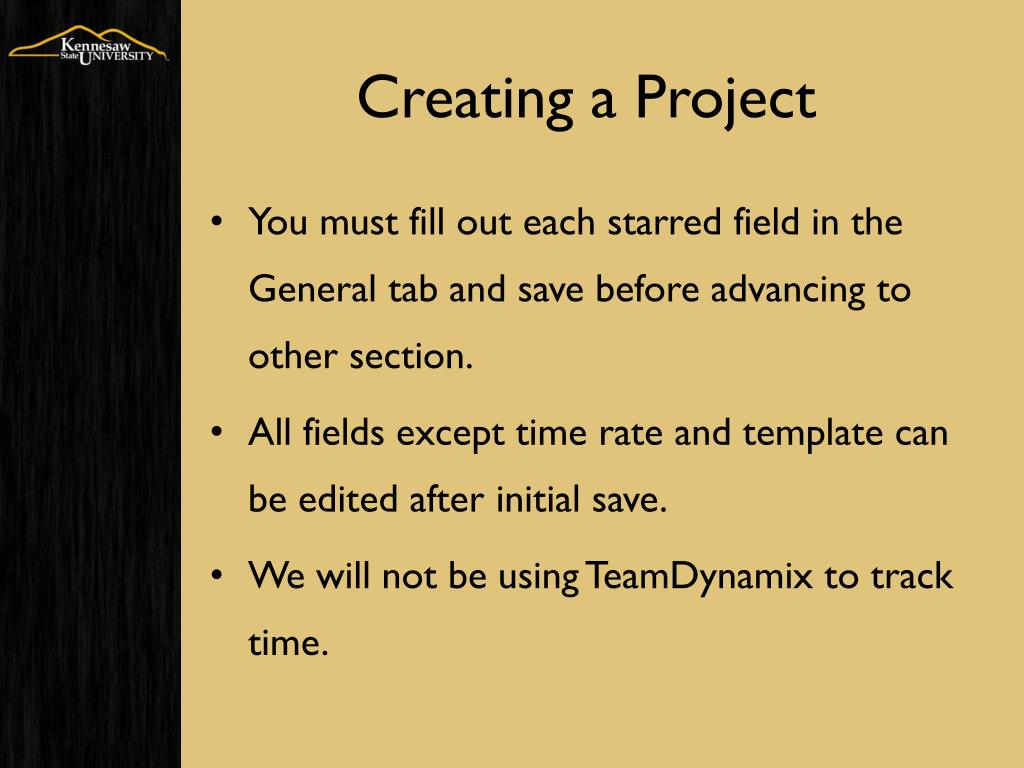

  8. Creating a Project • You must fill out each starred field in the General tab and save before advancing to other section. • All fields except time rate and template can be edited after initial save. • We will not be using TeamDynamix to track time.

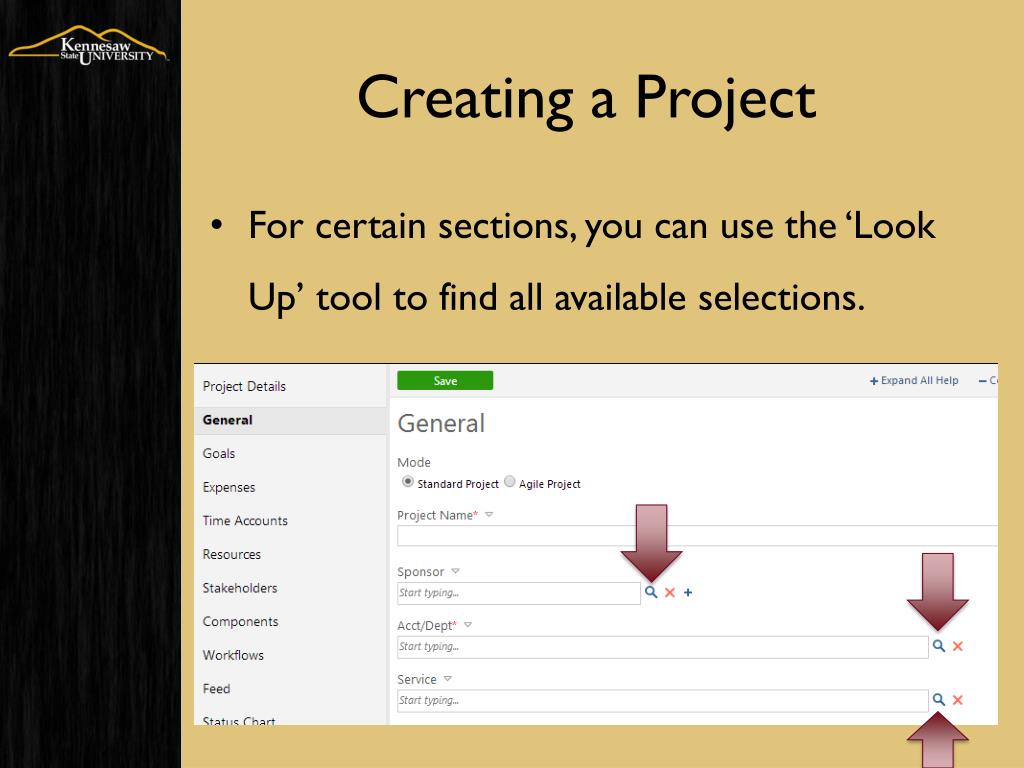

  9. Creating a Project • For clarity of each field, click the dropdown arrow for a brief description.

  10. Creating a Project • For certain sections, you can use the ‘Look Up’ tool to find all available selections.

  11. Creating a Project - Goals • With each project, you should assign the applicable 2012-2017 Strategic Goals and Objectives for KSU on the Goals tab by first selecting the Add button

  12. Creating a Project - Goals • Then selecting the goal from the list and saving it (Must do for each individual goal) • Comments are optional and only show up in the project feed. Optional

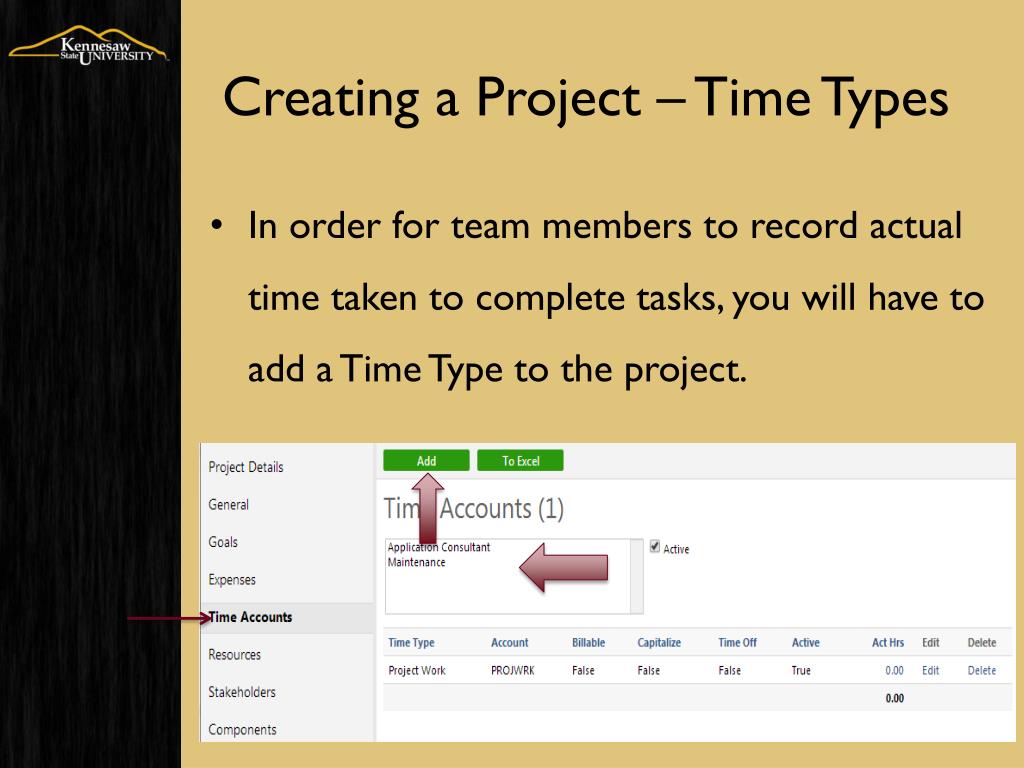

  13. Creating a Project– Time Types • In order for team members to record actual time taken to complete tasks, you will have to add a Time Type to the project.

  14. Creating a Project – Adding Resources • To add resources to your project (must be completed to add resources to plan), click the Resources tab and then Add Resource

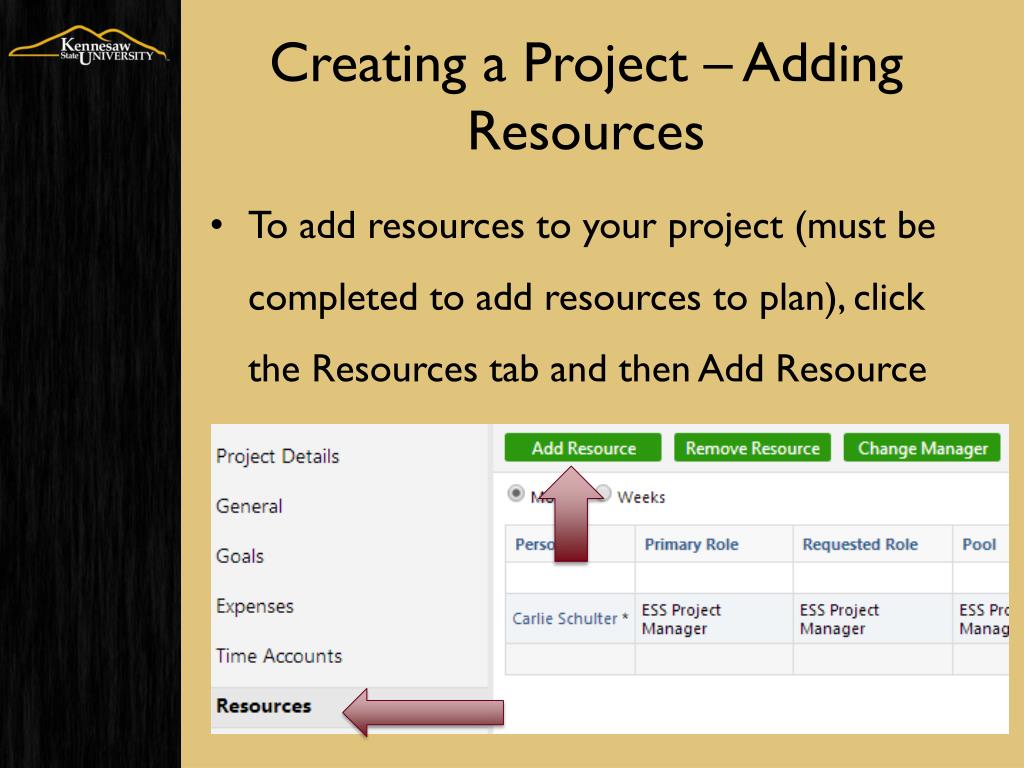

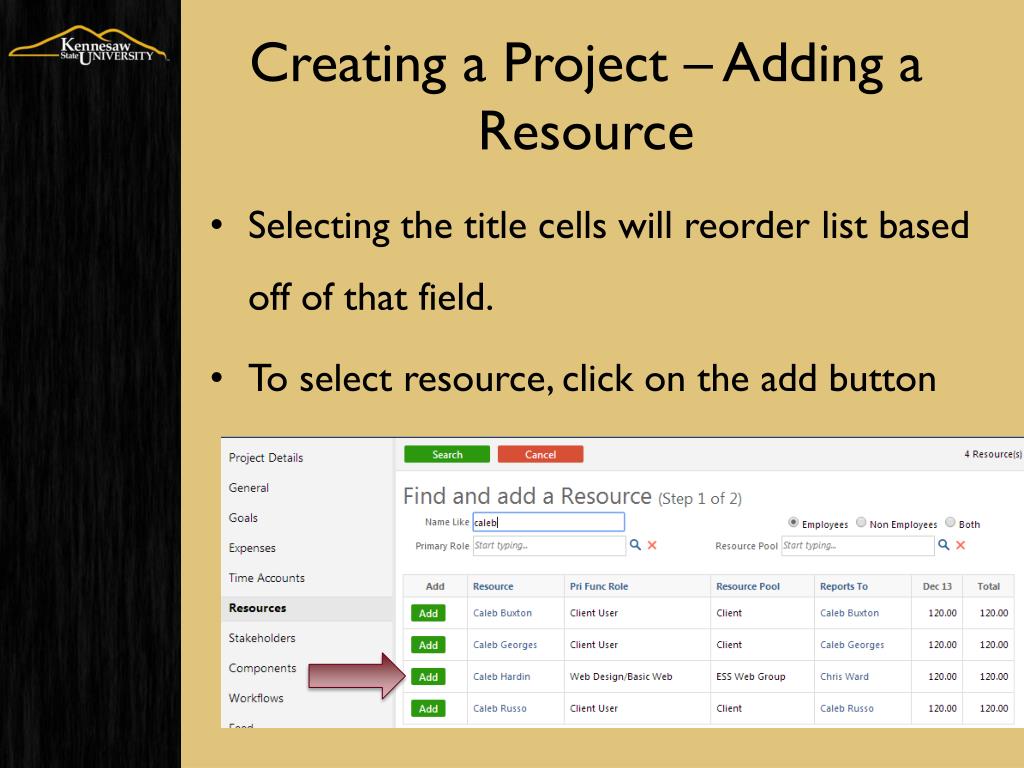

  15. Creating a Project – Adding Resources • Use ‘Name Like’ field to search for a specific user. Hit enter or select Search to populate the list.

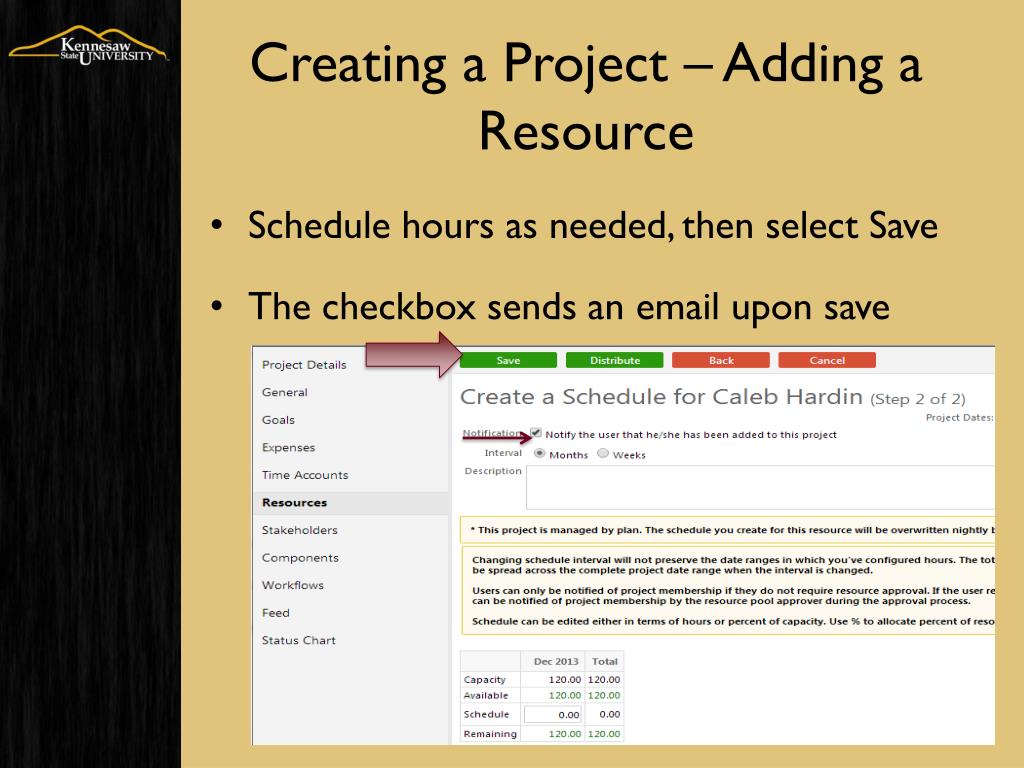

  16. Creating a Project – Adding a Resource • Selecting the title cells will reorder list based off of that field. • To select resource, click on the add button

  17. Creating a Project – Adding a Resource • Schedule hours as needed, then select Save • The checkbox sends an email upon save

  18. Creating a Project - Feed • The Feed tab will list all updates and edits made to the project

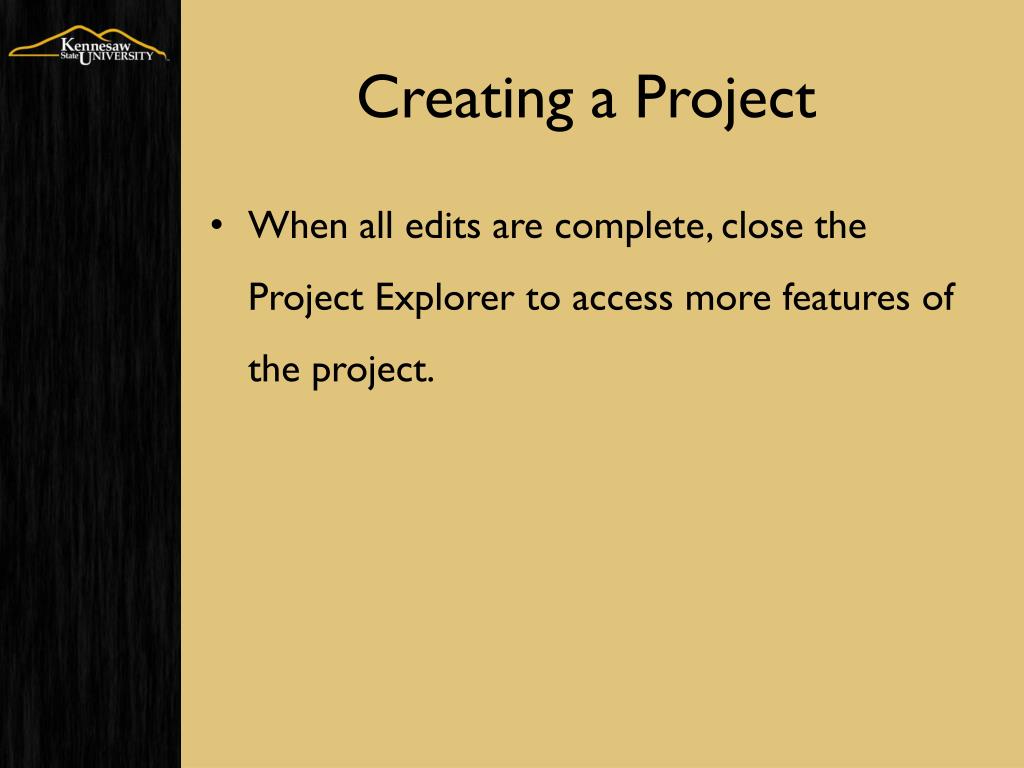

  19. Creating a Project • When all edits are complete, close the Project Explorer to access more features of the project.

  20. Projects • To return to the Project Explorer, select the project title in the Projects module on your Projects Desktop (given that it was added to your desktop).

  21. Project Plans • Click Project tab at the top of the page • If the project has not beenpopulated, select theRefresh button within thetab, not the browser • Select the project • Click Plans to launch the Plan Manager

  22. Creating a Project Plan • Select New in the top left of the Plan Manager

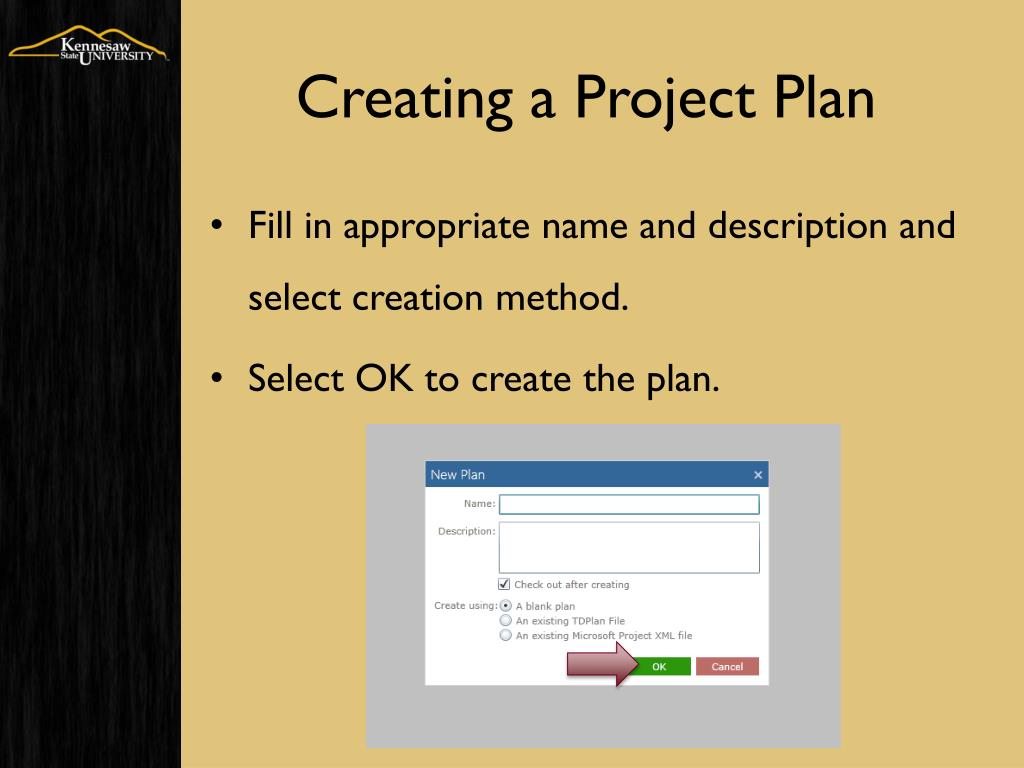

  23. Creating a Project Plan • Fill in appropriate name and description and select creation method. • Select OK to create the plan.

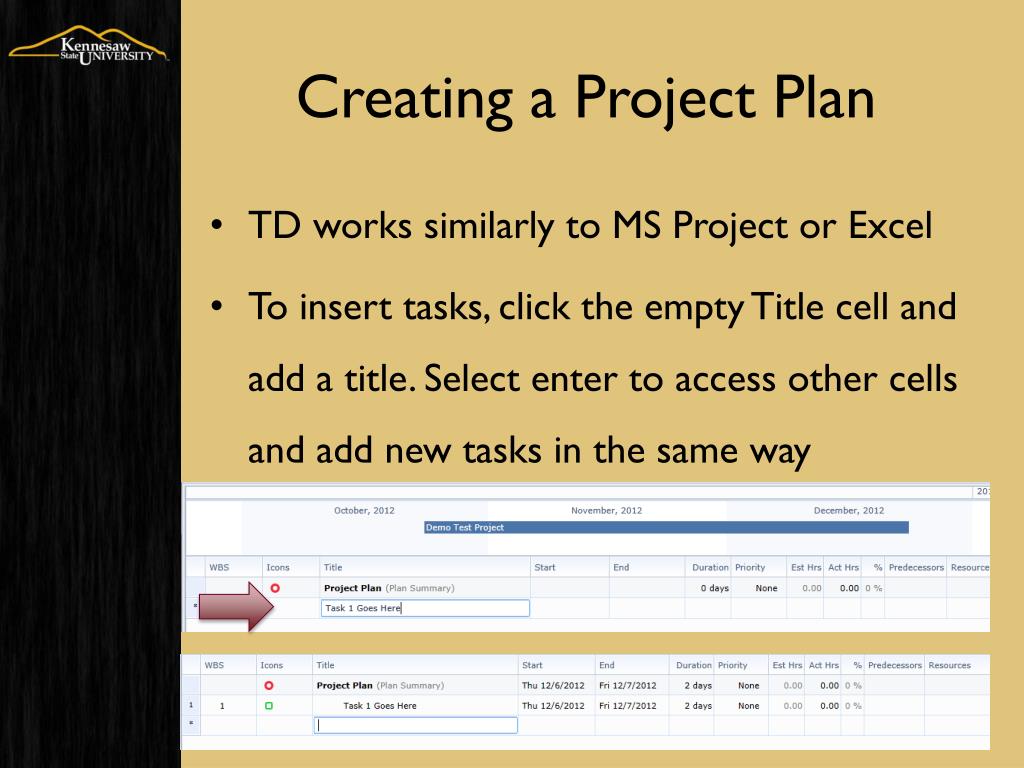

  24. Creating a Project Plan • TD works similarly to MS Project or Excel • To insert tasks, click the empty Title cell and add a title. Select enter to access other cells and add new tasks in the same way

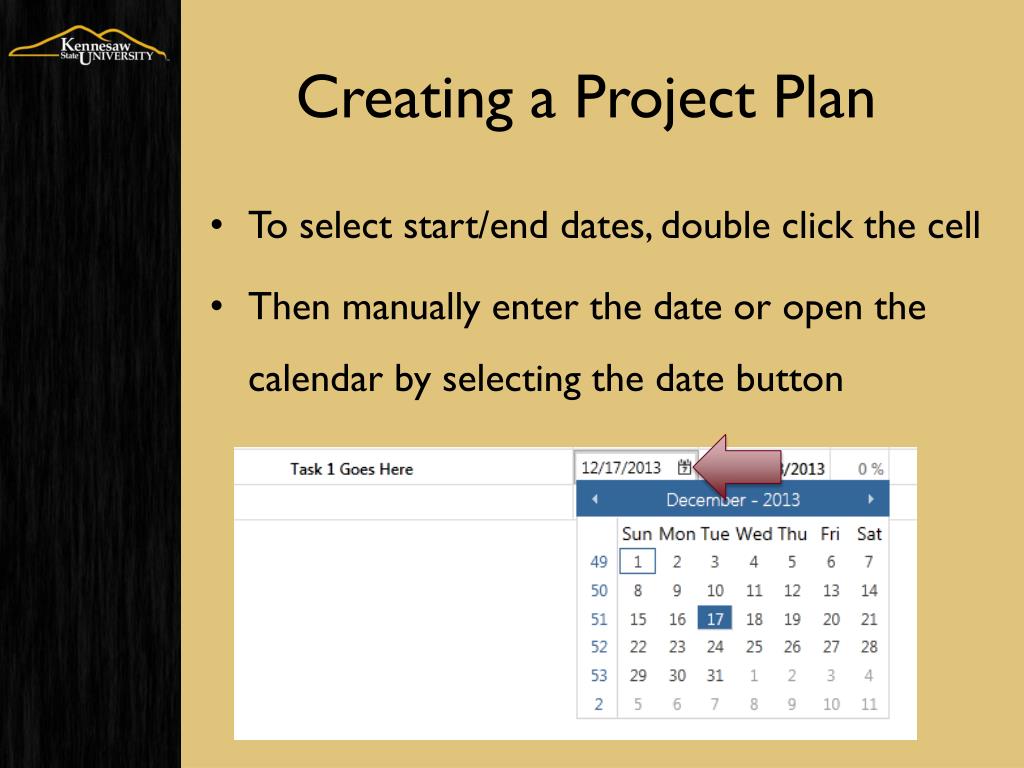

  25. Creating a Project Plan • To select start/end dates, double click the cell • Then manually enter the date or open the calendar by selecting the date button

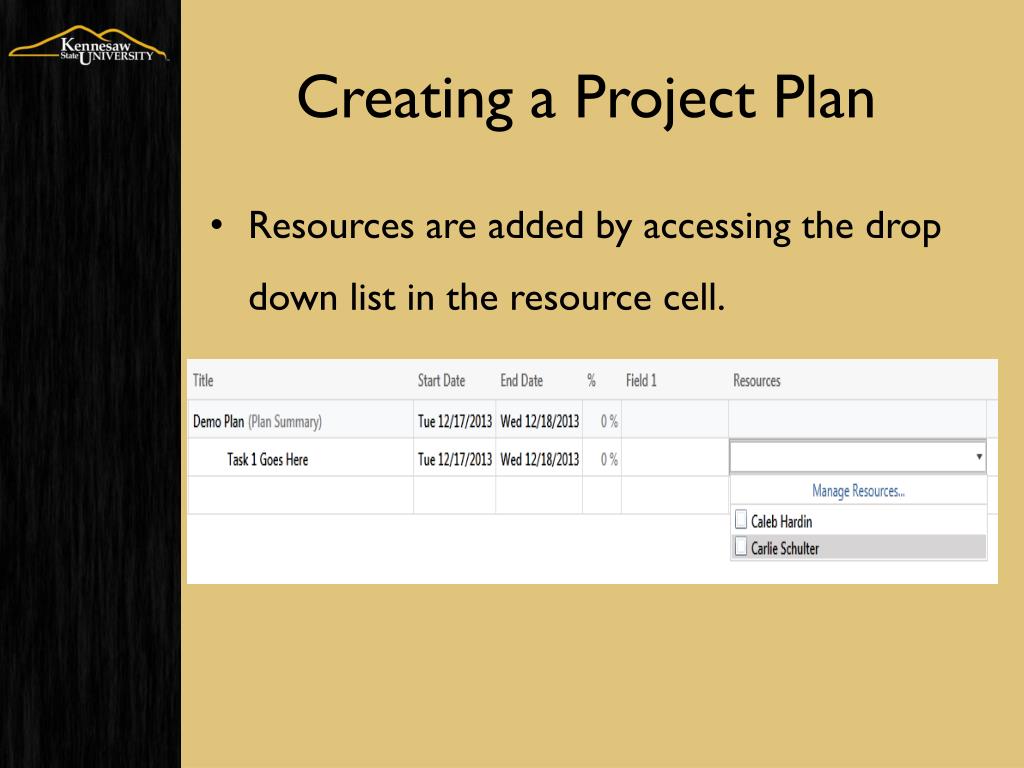

  26. Creating a Project Plan • Resources are added by accessing the drop down list in the resource cell.

  27. Creating a Project Plan • While creating tasks, you may find that a single major task has multiple steps to accomplish it. To denote this, you can use the indent tool, found by right-clicking, to make many tasks fall under a single ‘parent’ task.

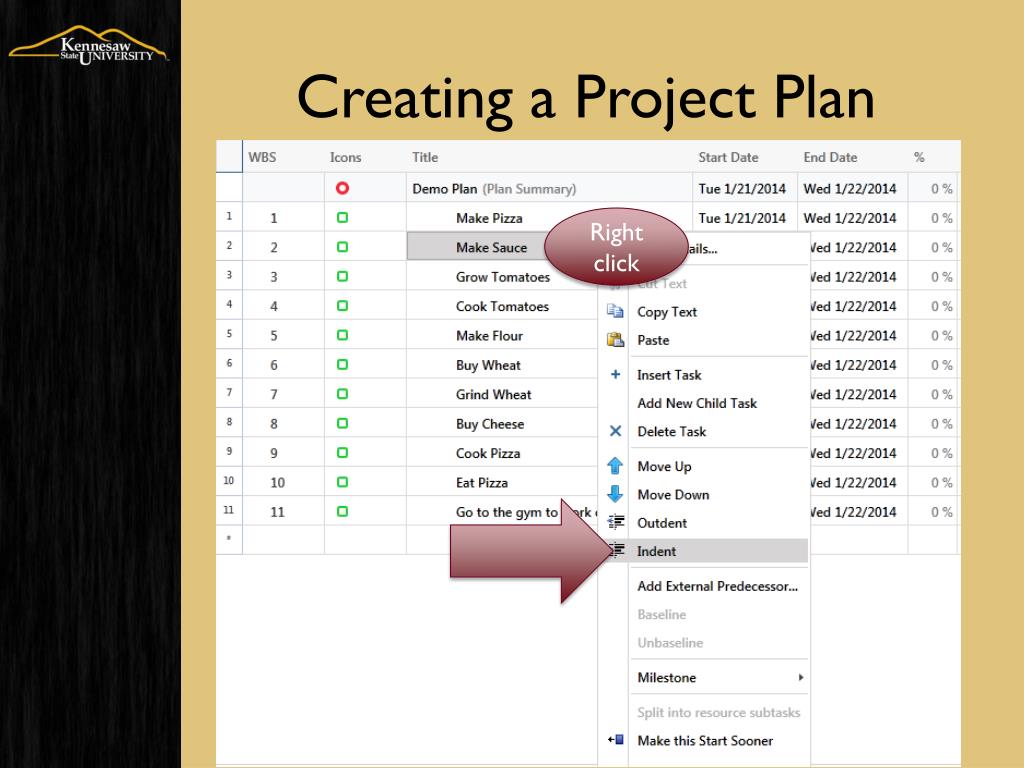

  28. Creating a Project Plan Right click

  29. Creating a Project Plan • The indent tool can be used multiple times to effectively organize your project. Indenting can be undone by using outdent.

  30. Creating a Project Plan • Right-clicking on a cell provides additional options to better organize and edit your plans. • WBS column providesassistance with aligningtasks while indenting and outdenting

  31. Updating Tasks on Plan • Select the % cell associated with the task • Enter correct completion percentage and hit enter

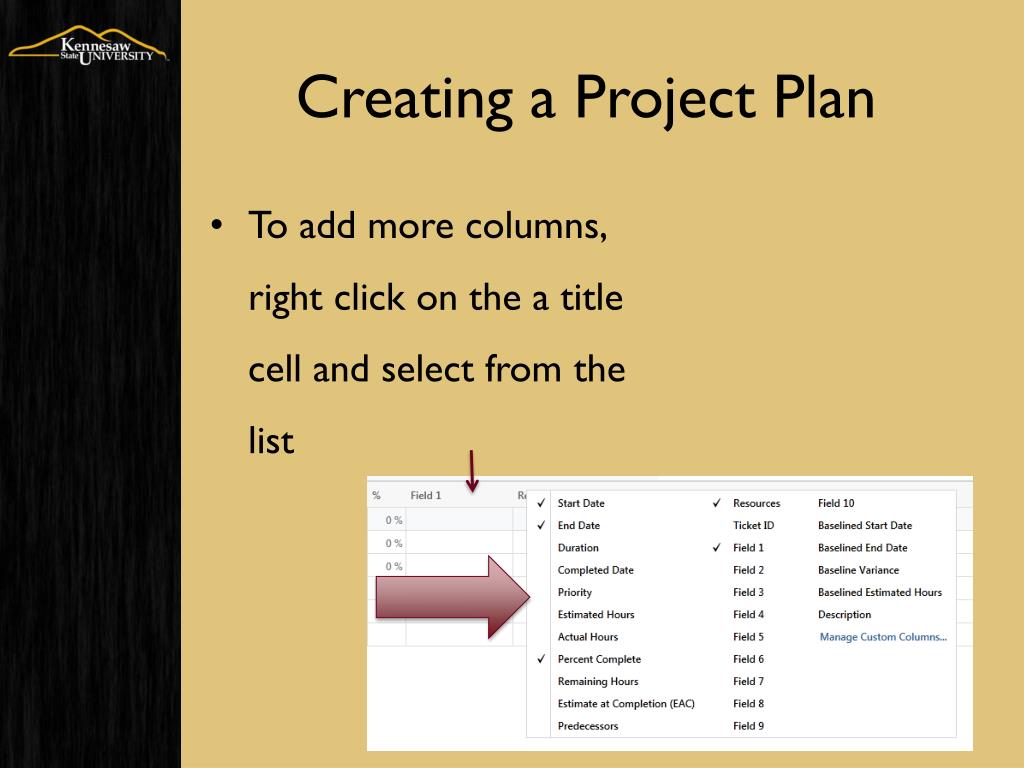

  32. Creating a Project Plan • To add more columns, right click on the a titlecell and select from thelist

  33. Editing a Project Plan • You can click and drag tasks to reorder them • Child tasks will move with parent tasks

  34. Editing a Project Plan • To shift a project plan’s dates, first be sure to have the plan checked out Should show the check mark

  35. Editing a Project Plan • Then select Details

  36. Editing a Project Plan • Select the Shift button and then change the new start date accordingly

  37. Baseline • The baseline feature of TeamDynamix allows project managers to view the differentiation between the originally expected time frame for a task to be completed as opposed to the actual work time. The baselined dates are available as additional columns labeled as “Base Start” and “Base End”.

  38. Baseline • To set a baseline, select the Baseline dropdown, and then “Set” the baseline (up to 10 per plan).

  39. Baseline • The plan will show the baseline dates in the Base Start/End column of the active baseline. Different baselines can be viewed by toggling the Active Baseline.

  40. Baseline

  41. Baseline • If you do not wish to baseline a task, you can toggle the setting on specific tasks under Baseline as well.

  42. Deleting a Project Plan • To delete a project plan, first be sure to have the plan checked out Should show the check mark

  43. Deleting a Project Plan • Next, click on Details • And then select the Delete button

  44. Project Plan • When all edits are complete, check the project back in and close the Plan Manager to access more features of the project.

  45. Project Templates • If you’ll have several projects working around the same plan outline, you can create a template to attach to the project (only available during initial creation). • This will automatically load all the template information into your project.

  46. Project Templates • Select the Project Templates application

  47. Project Templates • Select your Templates tab • Click New Template to create a new template

  48. Project Templates • In the pop-up window, give the new template a name and a description (optional)

  49. Project Templates • The window will close after you select save. • The template will populate on the Templates tab, much like projects on the Projects tab
