The East Kent Access Phase 2 project involves building a jacked deck tunnel under the A299 at Cliffsend. This innovative underpass enhances regional connectivity while minimizing disruptions. Utilizing established jacked structures and alternative abutments, the project emphasizes efficient engineering methods and sustainability. With an average progress rate of 2m per day, the collaboration between VolkerFitzpatrick and HOCHTIEF JV ensures optimal execution. The design and construct submission reflects thorough value engineering, setting a precedence for future infrastructure developments in compact environments.
E N D
Innovating in a compact environment EAST KENT ACCESS PHASE 2 CLIFFSEND UNDERPASS JACKED DECK TUNNEL
ALTERNATIVE ABUTMENTS Jacked Access Box and piled abutments Jacked foundation and wall boxes Tunnel and piled abutments
SCHEME LAYOUT A299 CLIFFSEND A256
CLIFFSEND UNDERPASS Looking West Picture courtesy of VolkerFitzpatrick HOCHTIEF JV
VolkerFitzpatrick HOCHTIEF JVDesign and Construct Submission Following Value Engineering

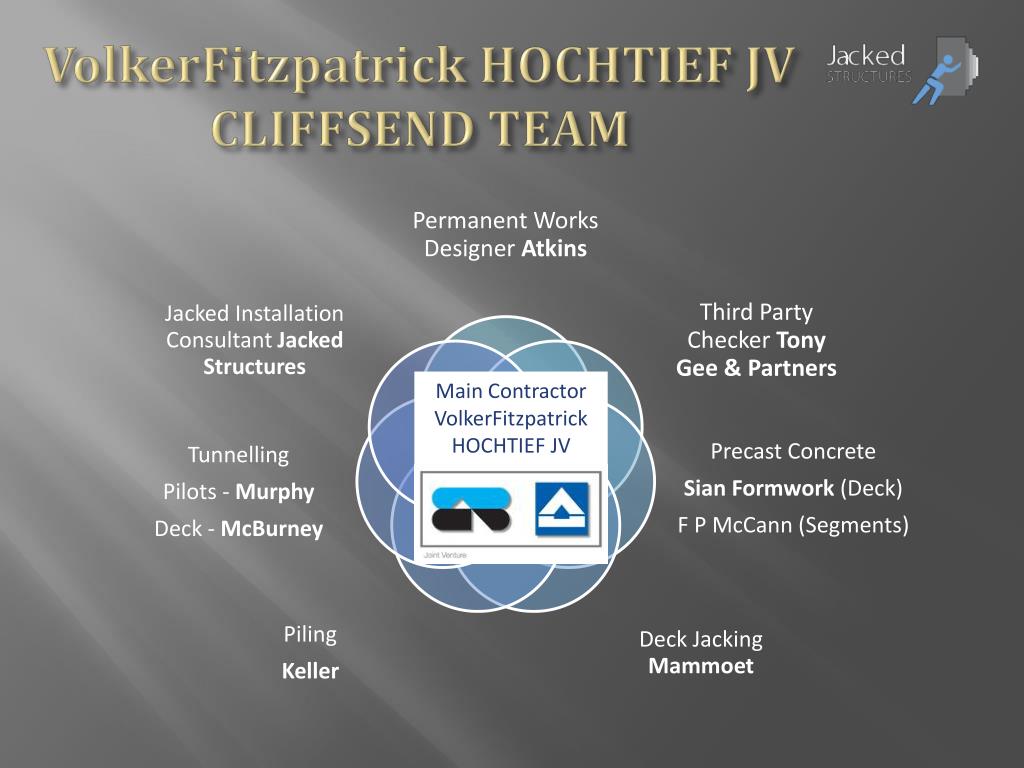

VolkerFitzpatrick HOCHTIEF JVCLIFFSEND TEAM Main Contractor VolkerFitzpatrickHOCHTIEF JV
EXCAVATION Average progress 2m / day
