1 / 67

October 26, 2009

Presentation to the . October 26, 2009. Citizens’ Oversight Committee. Presented By : Kelvin Okino Bernards’ Program Director. Overview. Aerial Views of Chaffey College-Rancho Cucamonga Early Construction Activities Completed Projects 2002-2008 Completed Projects in 2007

jenis
Télécharger la présentation

October 26, 2009

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Presentation to the October 26, 2009 Citizens’ Oversight Committee • Presented By: • Kelvin Okino • Bernards’ Program Director

  2. Overview • Aerial Views of Chaffey College-Rancho Cucamonga • Early Construction Activities • Completed Projects 2002-2008 • Completed Projects in 2007 • Completed Projects in 2008 • Completed Projects in 2009 • Projects under Construction • Projects in Bid and Award • Projects in Design • Projects in Planning • Program Schedule • Status of Measure ‘L’ Funds COC Presentation October 26, 2009

  3. Chaffey Community College • Aerial View-1958 Rancho Cucamonga Campus COC Presentation October 26, 2009

  4. Chaffey Community College • Aerial View-2009 Rancho Cucamonga Campus COC Presentation October 26, 2009

  5. Early Construction Activities • Groundbreaking—Alta Loma Campus-1958 COC Presentation October 26, 2009

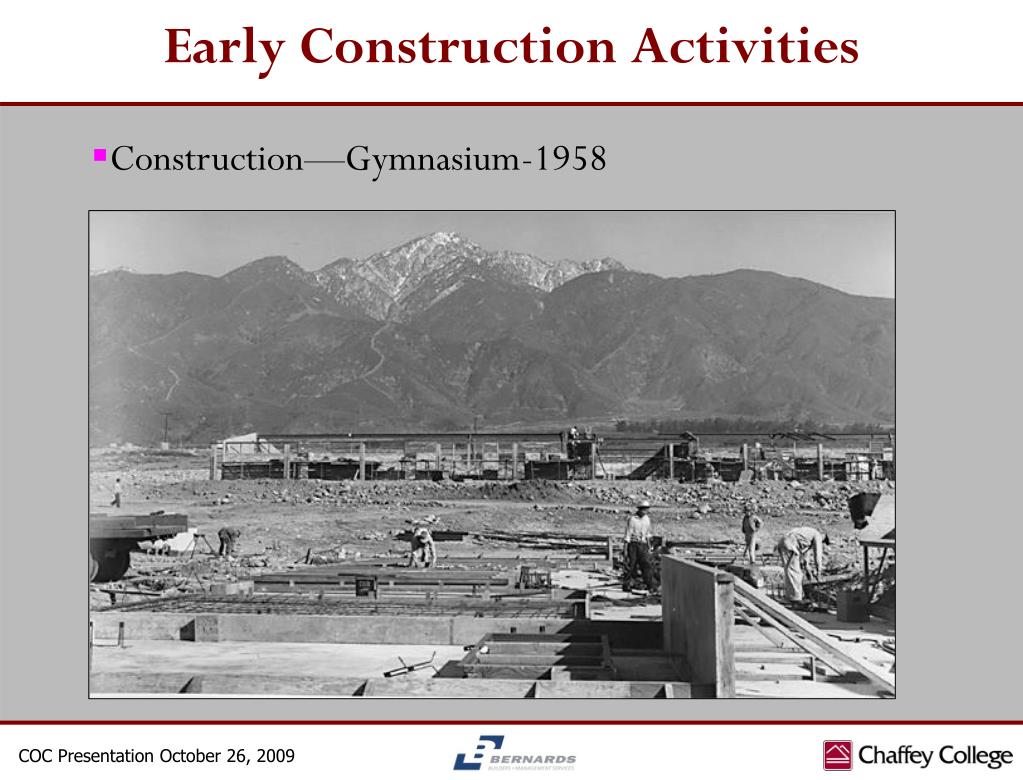

  6. Early Construction Activities • Construction—Gymnasium-1958 COC Presentation October 26, 2009

  7. Early Construction Activities • Construction—1958 COC Presentation October 26, 2009

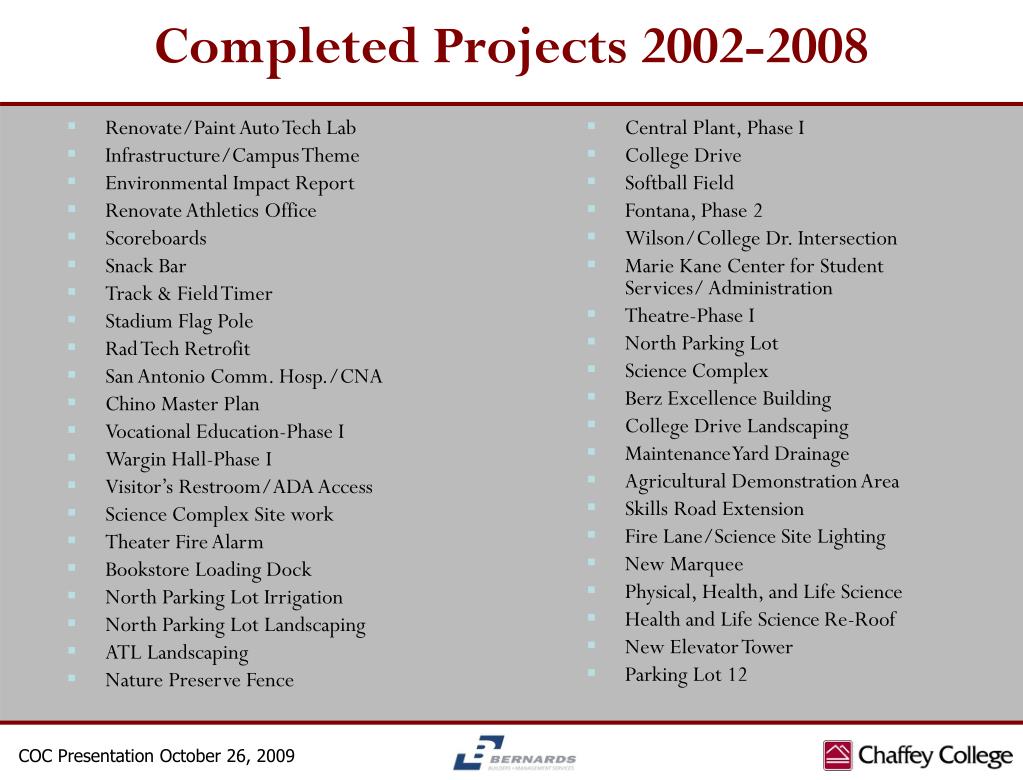

  8. Completed Projects 2002-2008 • Renovate/Paint Auto Tech Lab • Infrastructure/Campus Theme • Environmental Impact Report • Renovate Athletics Office • Scoreboards • Snack Bar • Track & Field Timer • Stadium Flag Pole • Rad Tech Retrofit • San Antonio Comm. Hosp./CNA • Chino Master Plan • Vocational Education-Phase I • Wargin Hall-Phase I • Visitor’s Restroom/ADA Access • Science Complex Site work • Theater Fire Alarm • Bookstore Loading Dock • North Parking Lot Irrigation • North Parking Lot Landscaping • ATL Landscaping • Nature Preserve Fence • Central Plant, Phase I • College Drive • Softball Field • Fontana, Phase 2 • Wilson/College Dr. Intersection • Marie Kane Center for Student Services/ Administration • Theatre-Phase I • North Parking Lot • Science Complex • Berz Excellence Building • College Drive Landscaping • Maintenance Yard Drainage • Agricultural Demonstration Area • Skills Road Extension • Fire Lane/Science Site Lighting • New Marquee • Physical, Health, and Life Science • Health and Life Science Re-Roof • New Elevator Tower • Parking Lot 12 COC Presentation October 26, 2009

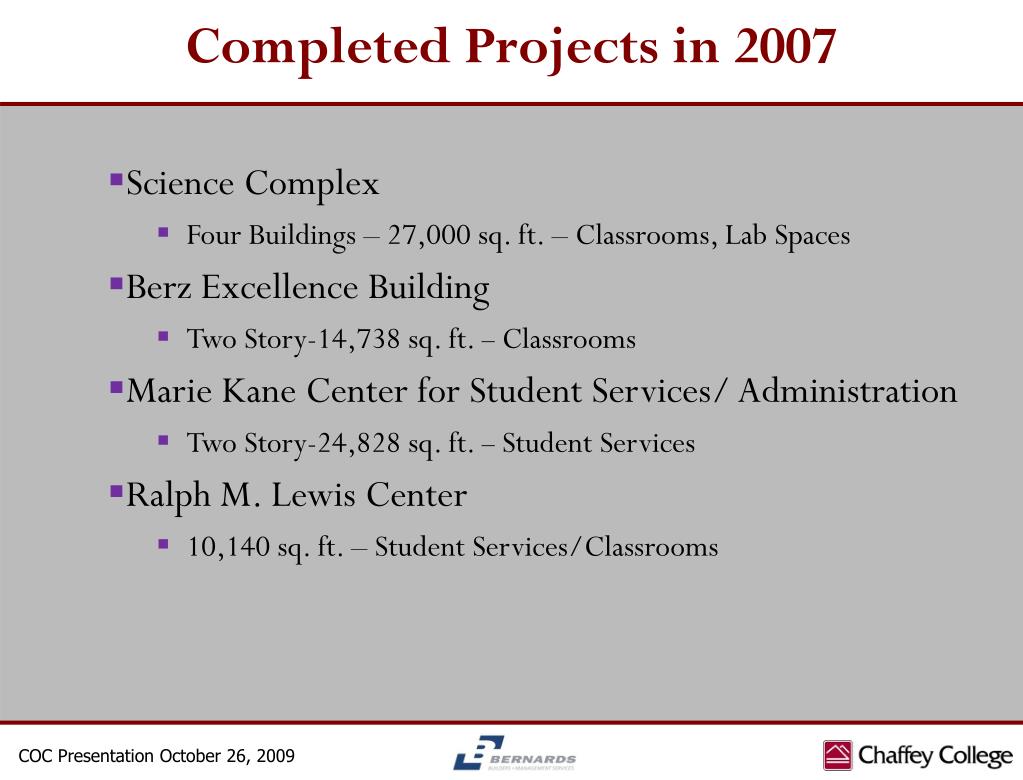

  9. Completed Projects in 2007 • Science Complex • Four Buildings – 27,000 sq. ft. – Classrooms, Lab Spaces • Berz Excellence Building • Two Story-14,738 sq. ft. – Classrooms • Marie Kane Center for Student Services/ Administration • Two Story-24,828 sq. ft. – Student Services • Ralph M. Lewis Center • 10,140 sq. ft. – Student Services/Classrooms COC Presentation October 26, 2009

  10. Completed Projects in 2007 Berz Excellence Building Marie Kane Center for Student Services/ Administration Science Complex Rancho Cucamonga Campus COC Presentation October 26, 2009

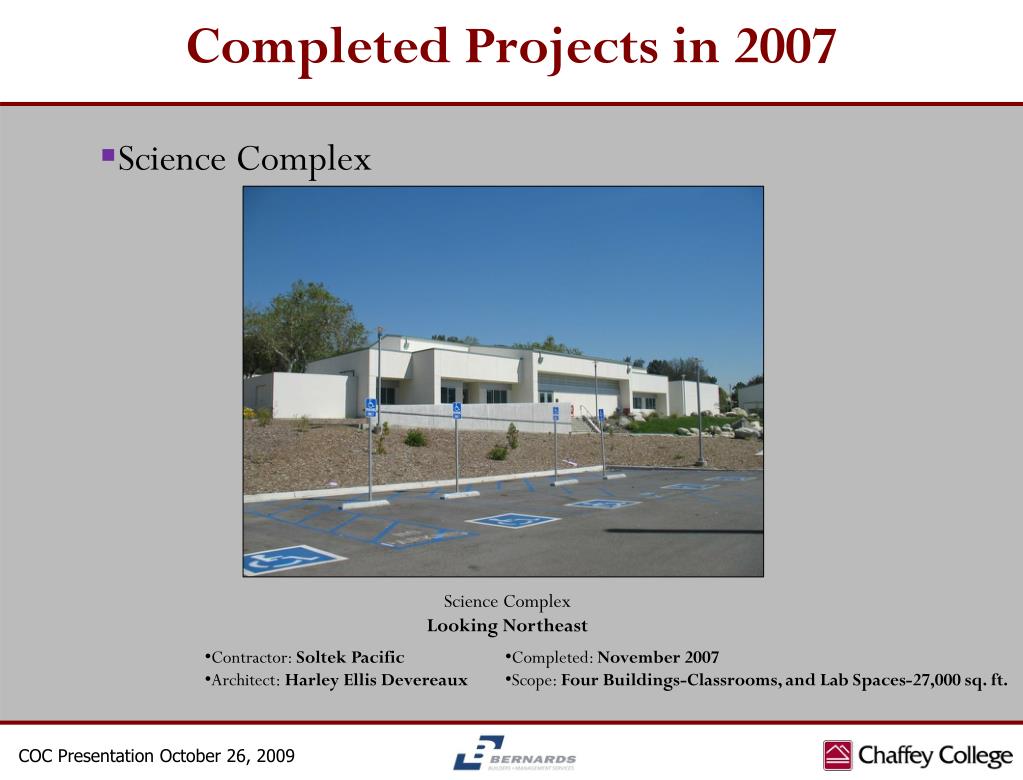

  11. Completed Projects in 2007 • Science Complex Science Complex Looking Northeast • Contractor: Soltek Pacific • Architect: Harley Ellis Devereaux • Completed: November 2007 • Scope: Four Buildings-Classrooms, and Lab Spaces-27,000 sq. ft. COC Presentation October 26, 2009

  12. Completed Projects in 2007 • Berz Excellence Building Berz Excellence Building Looking North • Contractor: RC Construction Services • Architect: Harley Ellis Devereaux • Completed: November 2007 • Scope: Two Story-14,738 sq. ft. -Classrooms COC Presentation October 26, 2009

  13. Completed Projects in 2007 • Marie Kane Center for Student Services /Administration Marie Kane Center for Student Services/Administration Looking North • Contractor: USS Cal Builders • Architect: GKK Works • Completed: December 2007 • Scope: Two Story-24,828 sq. ft.-Student Services COC Presentation October 26, 2009

  14. Completed Projects in 2007 Ralph M. Lewis Center Fontana Campus COC Presentation October 26, 2009

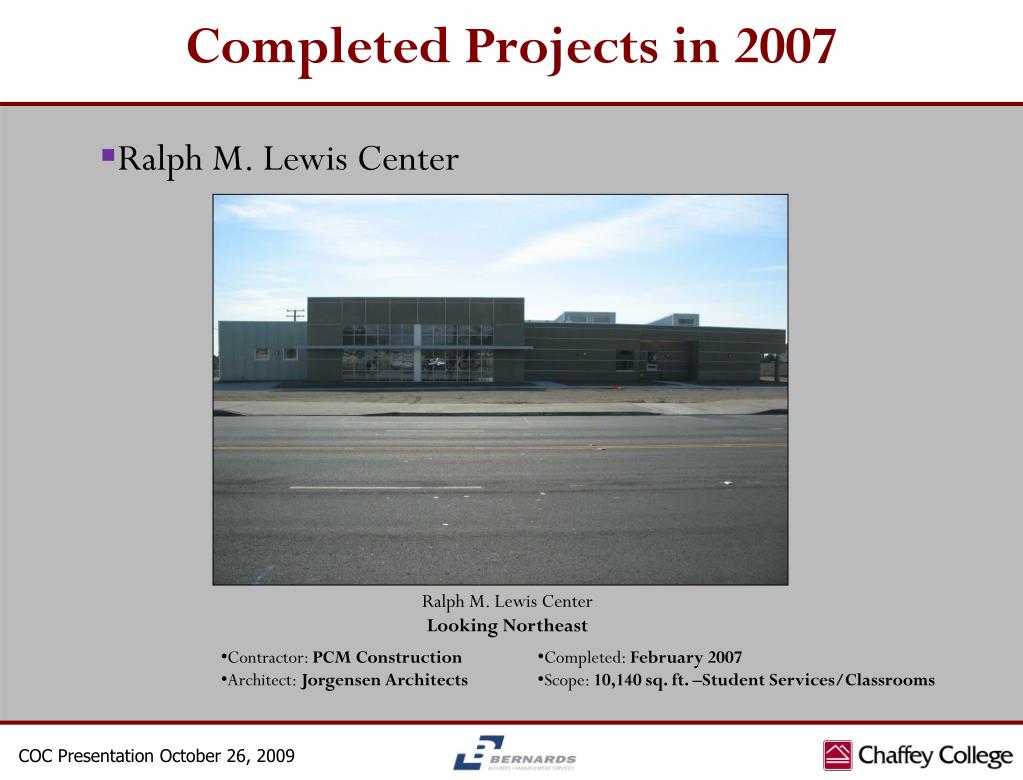

  15. Completed Projects in 2007 • Ralph M. Lewis Center Ralph M. Lewis Center Looking Northeast • Contractor: PCM Construction • Architect: Jorgensen Architects • Completed: February 2007 • Scope: 10,140 sq. ft. –Student Services/Classrooms COC Presentation October 26, 2009

  16. Completed Projects in 2008 • New Elevator Tower • New Elevator Tower for Accessibility from the VSS Building to the Marie Kane Center for Student Services/Administration • Parking Lot 12 • New Parking Lot for Accessibility to the Marie Kane Center for Student Services/Administration • New Marquee • New High Visibility Sign at the Main College Entrance • Physical, Health, and Life Sciences Renovation • Renovation/Modernization of Existing Classrooms • Health and Life Science Re-Roof • Installation of New Standing Seam Metal Roof COC Presentation October 26, 2009

  17. Completed Projects in 2008 Health and Life Science Re-Roof Parking Lot 12/ New Elevator Tower Physical, Health, and Life Sciences Renovation New Marquee Rancho Cucamonga Campus COC Presentation October 26, 2009

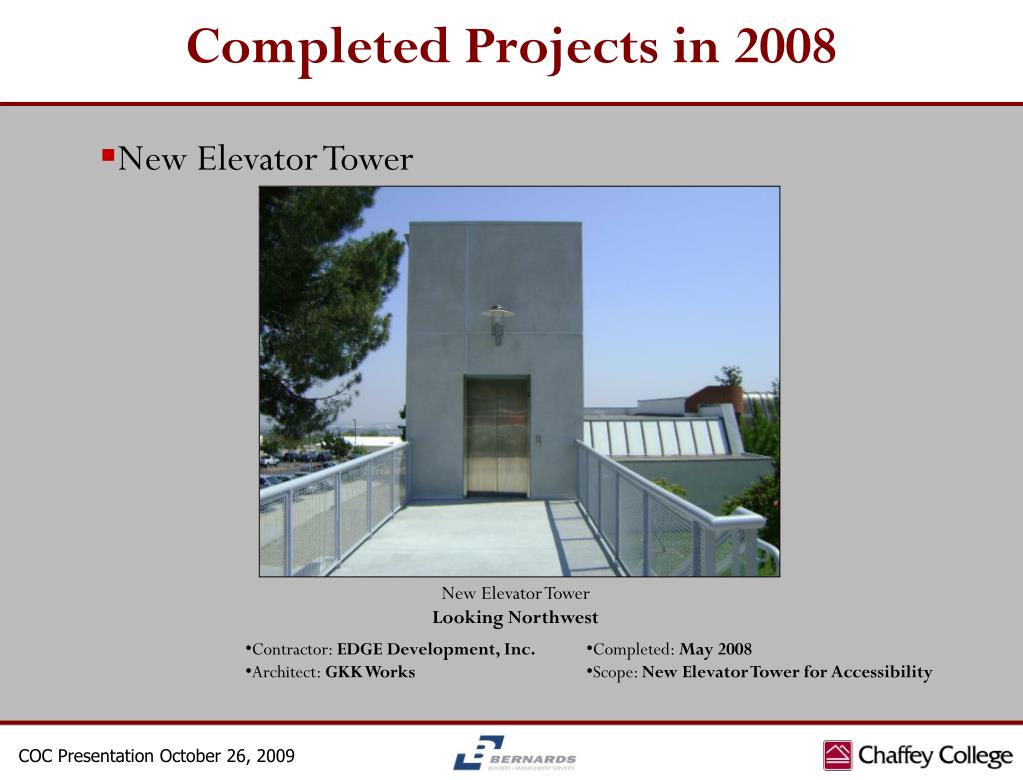

  18. Completed Projects in 2008 • New Elevator Tower New Elevator Tower Looking Northwest • Contractor: EDGE Development, Inc. • Architect: GKK Works • Completed: May 2008 • Scope: New Elevator Tower for Accessibility COC Presentation October 26, 2009

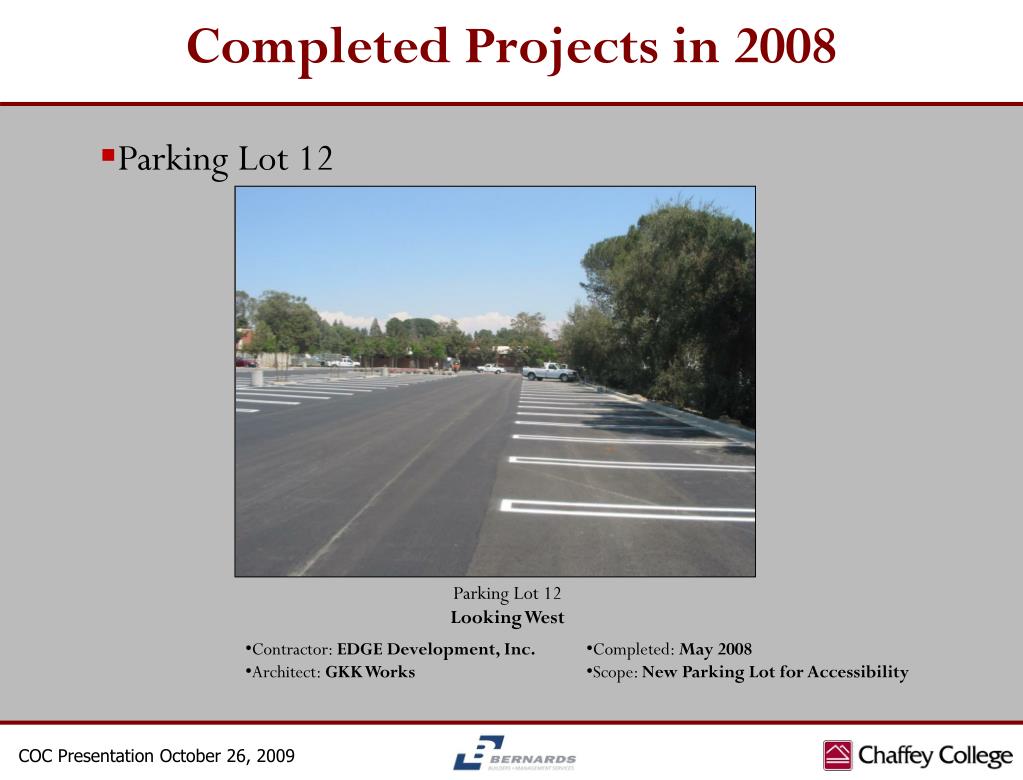

  19. Completed Projects in 2008 • Parking Lot 12 Parking Lot 12 Looking West • Contractor: EDGE Development, Inc. • Architect: GKK Works • Completed: May 2008 • Scope: New Parking Lot for Accessibility COC Presentation October 26, 2009

  20. Completed Projects in 2008 • New Marquee New Marquee Looking North • Contractor: Quiel Bros. Signs • Architect: HGA Architects • Completed: June 2008 • Scope: New Entrance Marquee Sign COC Presentation October 26, 2009

  21. Completed Projects in 2008 • Physical, Health, and Life Sciences Renovation Physical, Health, and Life Sciences Renovation Looking North • Contractor: PW Construction • Architect: WWCOT Architects • Completed: August 2008 • Scope: Interior Renovations/Modernization COC Presentation October 26, 2009

  22. Completed Projects in 2008 • Health and Life Science Re-Roof Health and Life Science Re-Roof Looking South • Contractor: Best Contracting • Architect: WWCOT Architects • Completed: August 2008 • Scope: New Standing Seam Metal Roof COC Presentation October 26, 2009

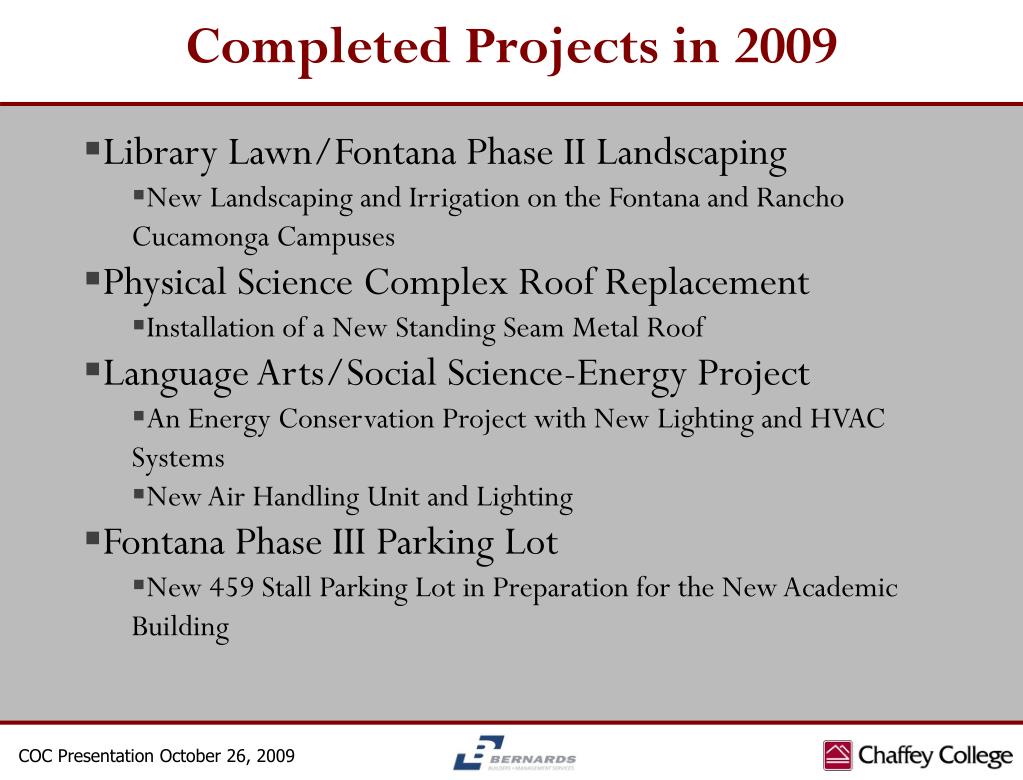

  23. Completed Projects in 2009 • Library Lawn/Fontana Phase II Landscaping • New Landscaping and Irrigation on the Fontana and Rancho Cucamonga Campuses • Physical Science Complex Roof Replacement • Installation of a New Standing Seam Metal Roof • Language Arts/Social Science-Energy Project • An Energy Conservation Project with New Lighting and HVAC Systems • New Air Handling Unit and Lighting • Fontana Phase III Parking Lot • New 459 Stall Parking Lot in Preparation for the New Academic Building COC Presentation October 26, 2009

  24. Completed Projects in 2009 Library Lawn Landscape and Irrigation Rancho Cucamonga Campus COC Presentation October 26, 2009

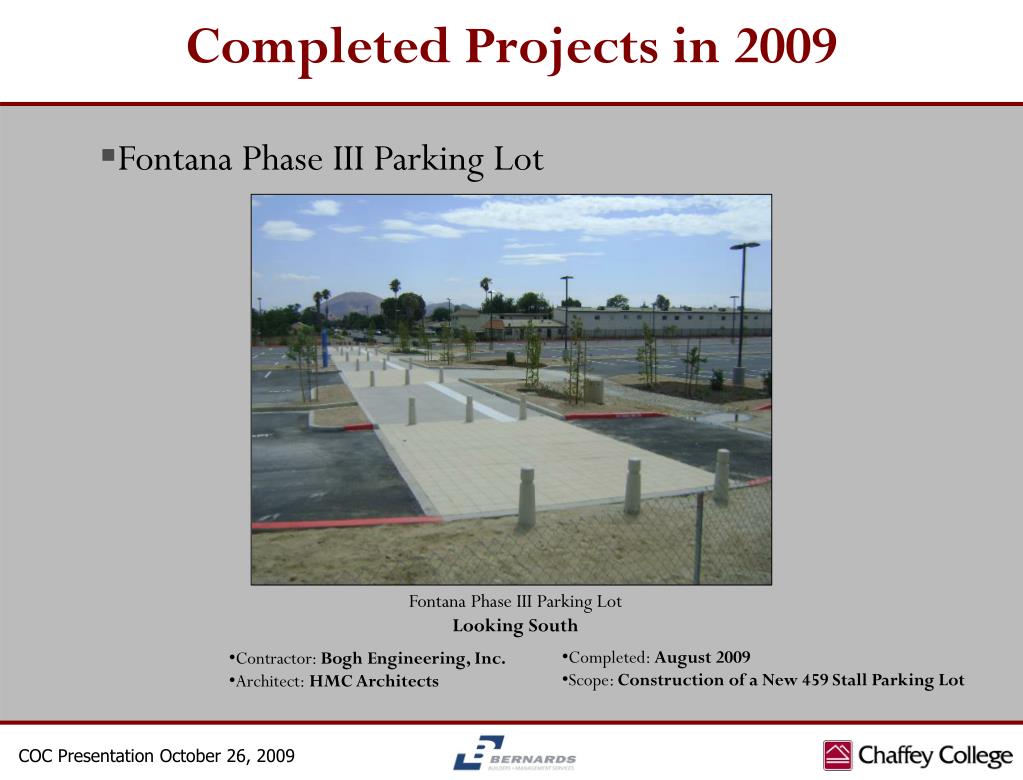

  25. Completed Projects in 2009 • Library Lawn Landscaping-Rancho Cucamonga Campus Library Lawn Landscaping-Rancho Cucamonga Campus Looking Northwest • Completed: August 2009 • Scope: New Landscaping and Irrigation • Contractor: Landforms Landscape Construction • Architect: Steven Frenken Landscape Architecture COC Presentation October 26, 2009

  26. Completed Projects in 2009 Fontana Phase II Landscape and Irrigation Fontana Campus COC Presentation October 26, 2009

  27. Completed Projects in 2009 • Fontana Phase II Landscaping-Fontana Campus Fontana Phase II Landscaping-Fontana Campus Looking Northeast • Completed: August 2009 • Scope: New Landscaping and Irrigation • Contractor: Landforms Landscape Construction • Architect: Steven Frenken Landscape Architecture COC Presentation October 26, 2009

  28. Completed Projects in 2009 Physical Science Complex Roof Replacement Rancho Cucamonga Campus COC Presentation October 26, 2009

  29. Completed Projects in 2009 • Physical Science Complex Roof Replacement Physical Science Complex Roof Replacement Looking West • Contractor: Cabral Roofing and Waterproofing Corp. • Architect: WWCOT Architects • Completed: August 2009 • Scope: New Metal Seam Standing Roof COC Presentation October 26, 2009

  30. Completed Projects in 2009 Social Science Building-Energy Upgrades Language Arts Building-Energy Upgrades Rancho Cucamonga Campus COC Presentation October 26, 2009

  31. Completed Projects in 2009 • Social Science Building-Energy Upgrades Social Science Building-Energy Upgrades Looking North • Completed : August 2009 • Scope: New Air Handling Unit • Contractor: Siemens • Architect: P2S Engineering, Inc. COC Presentation October 26, 2009

  32. Completed Projects in 2009 • Language Arts Building-Energy Upgrades Language Arts Building-Energy Upgrades Looking North • Completed : August 2009 • Scope: Installation of Lighting Upgrades • Contractor: Siemens • Architect: P2S Engineering, Inc. COC Presentation October 26, 2009

  33. Completed Projects in 2009 Fontana Phase III Parking Lot Fontana Campus COC Presentation October 26, 2009

  34. Completed Projects in 2009 • Fontana Phase III Parking Lot Fontana Phase III Parking Lot Looking South • Completed: August 2009 • Scope: Construction of a New 459 Stall Parking Lot • Contractor: Bogh Engineering, Inc. • Architect: HMC Architects COC Presentation October 26, 2009

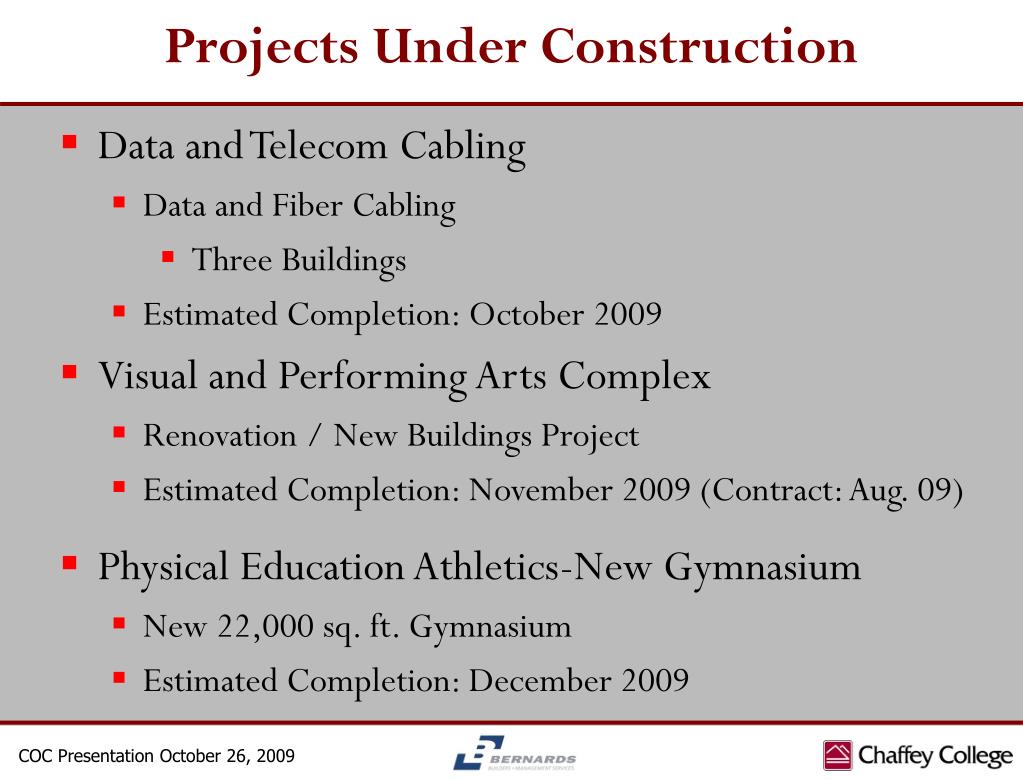

  35. Projects Under Construction • Data and Telecom Cabling • Data and Fiber Cabling • Three Buildings • Estimated Completion: October 2009 • Visual and Performing Arts Complex • Renovation / New Buildings Project • Estimated Completion: November 2009 (Contract: Aug. 09) • Physical Education Athletics-New Gymnasium • New 22,000 sq. ft. Gymnasium • Estimated Completion: December 2009 COC Presentation October 26, 2009

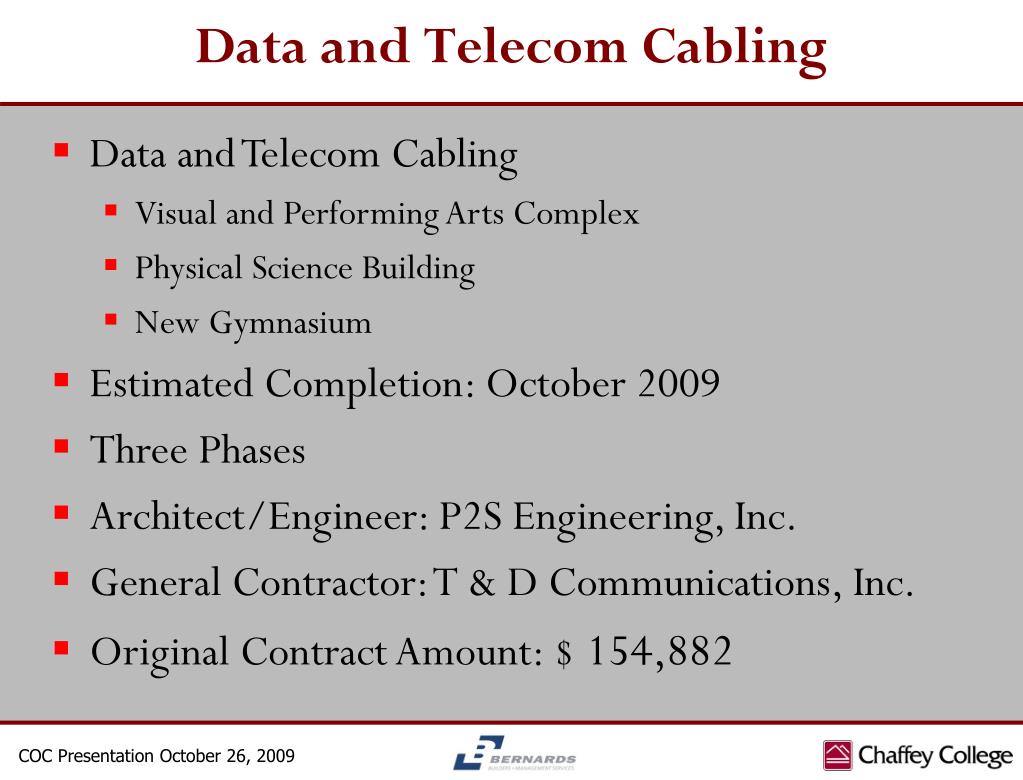

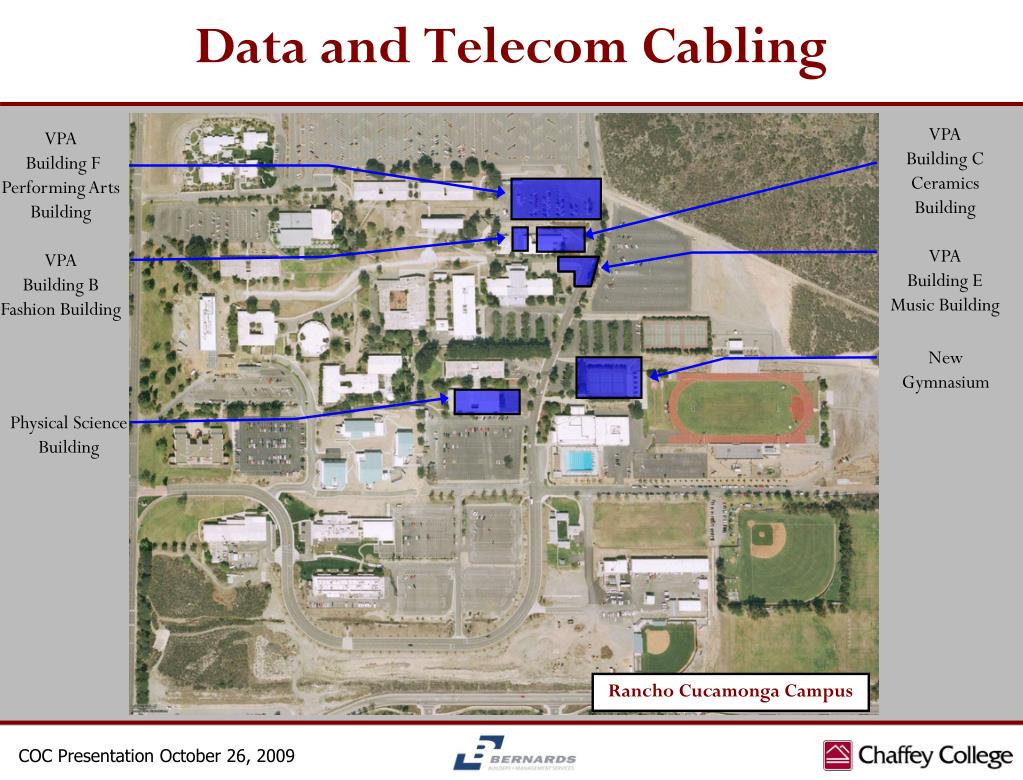

  36. Data and Telecom Cabling • Data and Telecom Cabling • Visual and Performing Arts Complex • Physical Science Building • New Gymnasium • Estimated Completion: October 2009 • Three Phases • Architect/Engineer: P2S Engineering, Inc. • General Contractor: T & D Communications, Inc. • Original Contract Amount: $ 154,882 COC Presentation October 26, 2009

  37. Data and Telecom Cabling VPA Building C Ceramics Building VPA Building E Music Building VPA Building F Performing Arts Building VPA Building B Fashion Building New Gymnasium Physical Science Building Rancho Cucamonga Campus COC Presentation October 26, 2009

  38. Data and Telecom Cabling • Progress Photos Installation of pull box for the New Gymnasium media. Looking West Installation of new splice case for the Stadium Press Box. Looking West COC Presentation October 26, 2009

  39. Visual and Performing Arts Complex • Renovation / New Buildings Project • Estimated Completion: Nov. 2009 (Contract: Aug. 09) • Phased Milestones • Phase 1: Building F, Site/Utilities – November 2, 2009 (August 22, 2009) • Phase 2A: Building E, Utility Connections – (December 30, 2008) • Phase 2B: Building E, Site/Utilities –August 4, 2009 (June 7, 2009) • Phase 2C: Theater Loading Dock Access – (August 22, 2008) • Phase 3: Renovation Courtyard B/C – (May 24, 2008) • Phase 4A: Renovations Ceramics Yard – (August 9, 2008) • Phase 4B: Building B/C Renovations – (July 30, 2009) • Phase 5: Renovation Accessible Route – (June 21, 2008) • Architect: HGA Architects • General Contractor: ProWest Constructors • Contract Amount: $22,145,000 COC Presentation October 26, 2009

  40. Visual and Performing Arts Complex • Performing Arts Building Rendering (Exterior) COC Presentation October 26, 2009

  41. Visual and Performing Arts Complex VPA Building C Ceramics Building VPA Building E Music Building VPA Building F Performing Arts Building VPA Building B Fashion Building F B C E Rancho Cucamonga Campus COC Presentation October 26, 2009

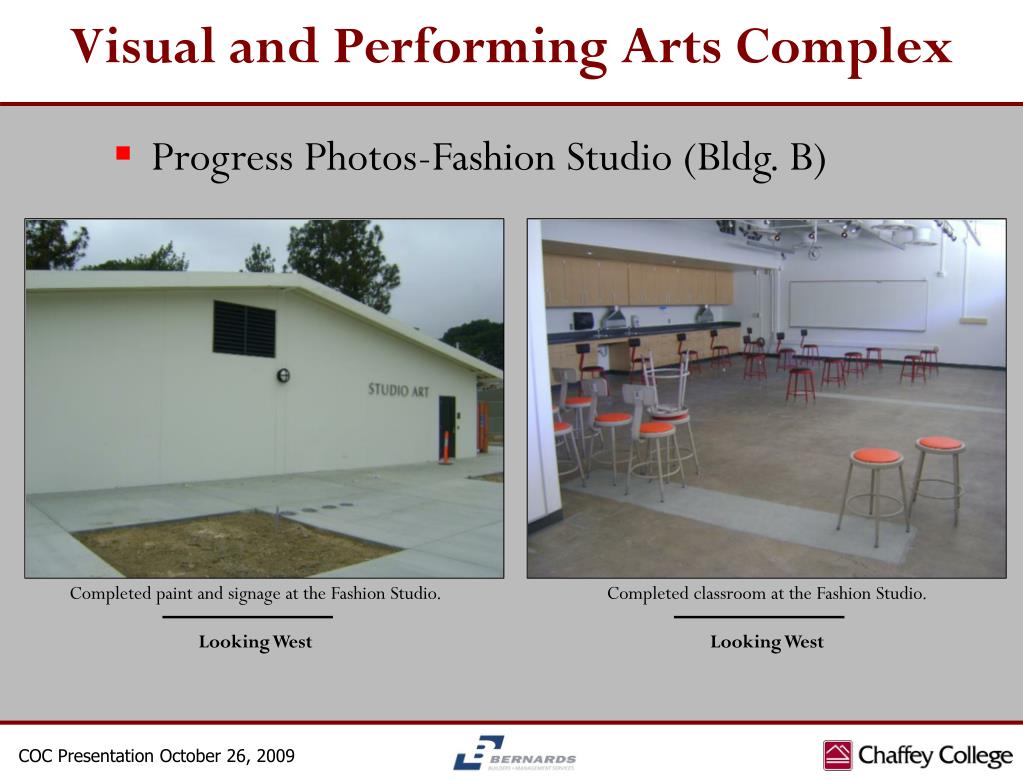

  42. Visual and Performing Arts Complex • Progress Photos-Fashion Studio (Bldg. B) Completed paint and signage at the Fashion Studio. Looking West Completed classroom at the Fashion Studio. Looking West COC Presentation October 26, 2009

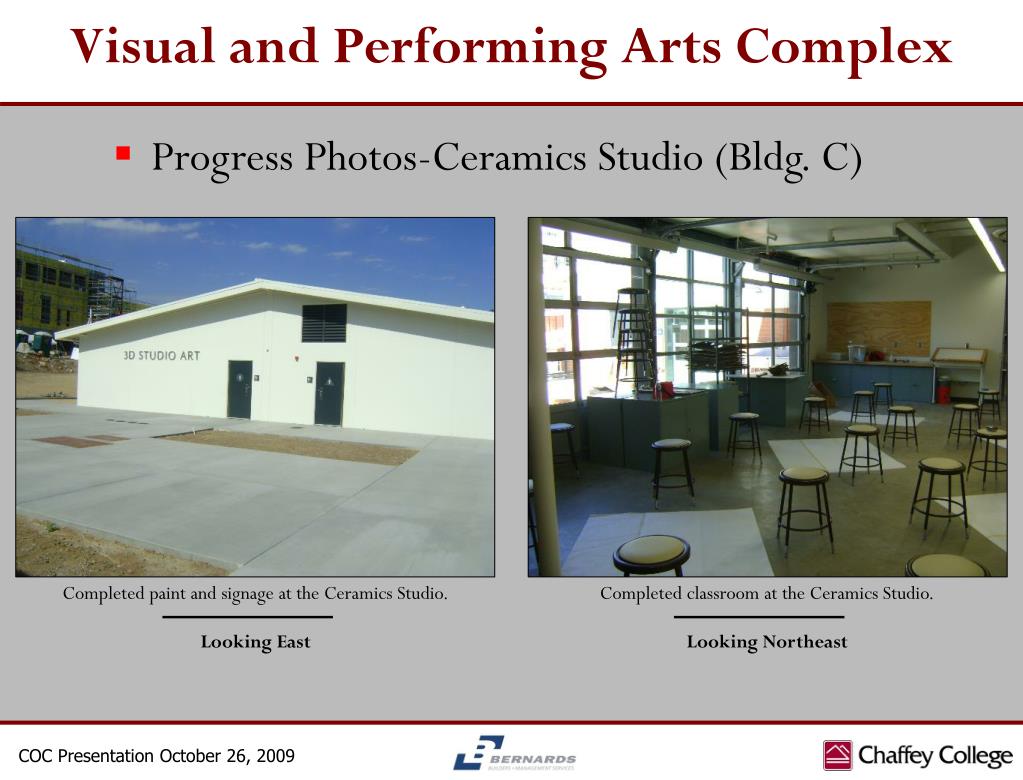

  43. Visual and Performing Arts Complex • Progress Photos-Ceramics Studio (Bldg. C) Completed paint and signage at the Ceramics Studio. Looking East Completed classroom at the Ceramics Studio. Looking Northeast COC Presentation October 26, 2009

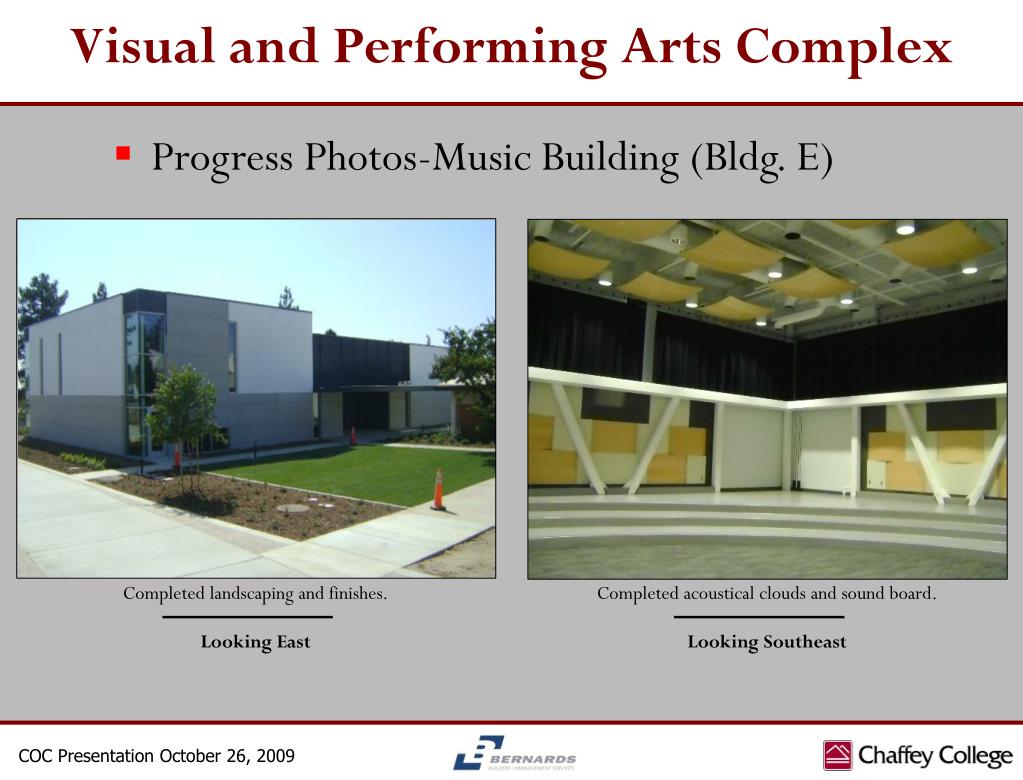

  44. Visual and Performing Arts Complex • Progress Photos-Music Building (Bldg. E) Completed landscaping and finishes. Looking East Completed acoustical clouds and sound board. Looking Southeast COC Presentation October 26, 2009

  45. Visual and Performing Arts Complex • Progress Photos-Performing Arts Building (Bldg. F) Construction of site work. Looking Northeast Installation of bi-fold door glazing. Looking Southeast COC Presentation October 26, 2009

  46. Visual and Performing Arts Complex • Progress Photos-Performing Arts Building (Bldg. F) Installation of finishes at the Photography Work Room. Looking East Installation of casework at the Material Library. Looking North COC Presentation October 26, 2009

  47. Physical Education Athletics – New Gym • New 22,000 sq. ft. Gymnasium • Estimated Completion: December 2009 • Basketball/Volleyball Courts • Locker Rooms • Snack Bar • Bleachers for 984 Individuals • Architect: NTD Architecture • General Contractor: EDGE Development, Inc. • Contract Amount: $8,560,543 COC Presentation October 26, 2009

  48. Physical Education Athletics – New Gym • Project Rendering(Aerial Perspective) COC Presentation October 26, 2009

  49. Physical Education Athletics – New Gym • Project Rendering (Main Entrance Perspective) COC Presentation October 26, 2009

  50. Physical Education Athletics – New Gym Physical Education Athletics- New Gymnasium Rancho Cucamonga Campus COC Presentation October 26, 2009

More Related
