1 / 27

ERP Project Status Report for CFC Apr 201 4

ERP Project Status Report for CFC Apr 201 4. Current ERP Project Progress and Achievements.

joylyn
Télécharger la présentation

ERP Project Status Report for CFC Apr 201 4

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. ERP Project Status Reportfor CFCApr 2014

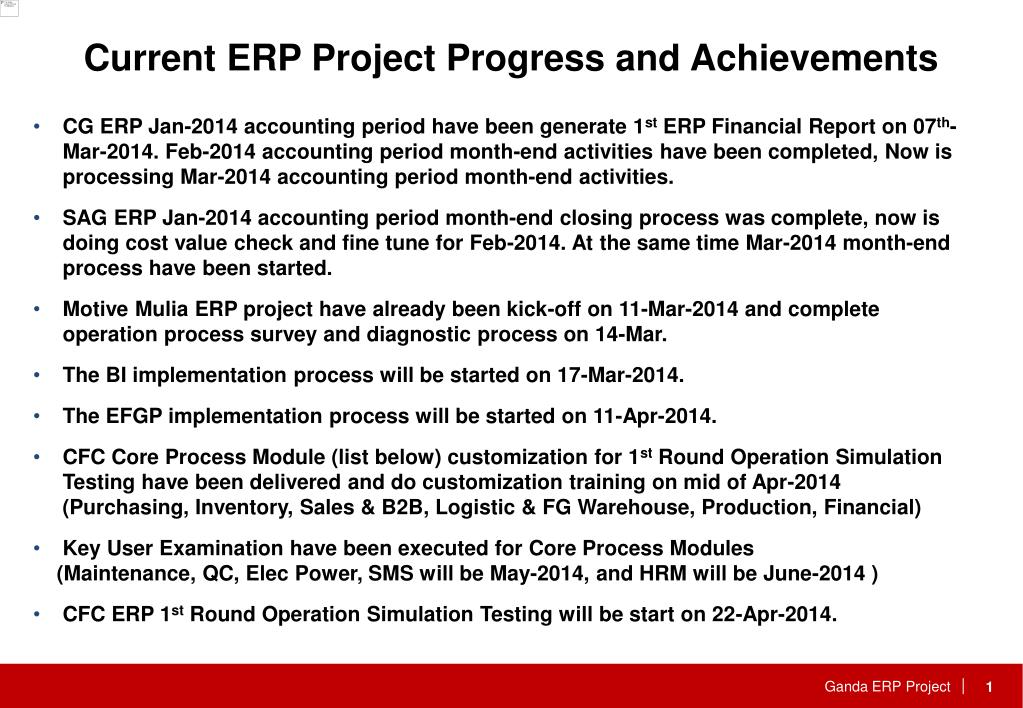

  2. Current ERP Project Progress and Achievements • CG ERP Jan-2014 accounting period have been generate 1st ERP Financial Report on 07th-Mar-2014. Feb-2014 accounting period month-end activities have been completed, Now is processing Mar-2014 accounting period month-end activities. • SAG ERP Jan-2014 accounting period month-end closing process was complete, now is doing cost value check and fine tune for Feb-2014. At the same time Mar-2014 month-end process have been started. • Motive Mulia ERP project have already been kick-off on 11-Mar-2014 and complete operation process survey and diagnostic process on 14-Mar. • The BI implementation process will be started on 17-Mar-2014. • The EFGP implementation process will be started on 11-Apr-2014. • CFC Core Process Module (list below) customization for 1st Round Operation Simulation Testing have been delivered and do customization training on mid of Apr-2014 (Purchasing, Inventory, Sales & B2B, Logistic & FG Warehouse, Production, Financial) • Key User Examination have been executed for Core Process Modules (Maintenance, QC, Elec Power, SMS will be May-2014, and HRM will be June-2014 ) • CFC ERP 1st Round Operation Simulation Testing will be start on 22-Apr-2014. 1

  3. ERP Project Milestone 2014 Oct Sep Dec Jan Feb Mar Apr May June July Aug Nov CG Month-end Closing • Check Up • Reconciliation & Report 15/8 20/8 05/7 05/6 10/5 15/4 20/3 05/8 20/2 CFC Cement • UAT & Training • Basic data preparation • Operation Simulation • Launch CFC – Cement Kick off 1/07/2013 – Go-Live 1/7/2014 (Operation Simulation Testing : 1st Round 22/4 ; 2nd Round 12/5) AASTAR / WHI K-off 12/05 – Go-Live 01/07 Transport - ANP Kick off 10/6/2014– Go-Live 1/11/2014 Phase 2 development 1. Survey & Diagnosis 2. Application Training 3. Operation Training 4. S.O.P. Modeling 5. Gap Analysis & Customization 6. HRM Application Training /Gap Analysis RMC & Transport • Design & Development • Basic data preparation • UAT • Training • Launch RMC – Motive Mulia Kick off 11/3/2014 – Go-Live 1/10/2014 (All of RMC) AASTAR / WHI • Basic data preparation • Training • Launch B I • Workshop • Design & Development • UAT • Launch Business Intelligence Kick off 18/3/2014 – Go-Live 01/07 2014 (Pilot) Easy flow (EFGP) • Design & Develop • UAT • Launch Easyflow (EFGP) / Online approval • Kick off 14/4/2014 Go-Live 01/07 2014 Payroll Kick off 05/2/2014 – Go-Live 01/06/2014 (CG) ESS (Employee Self Service) – Integrated with EFGP Kick Off 14/4/2014 – Go-Live 01/07/2014 HR • Payroll • ESS 2

  4. The Schedule to Go-Live for CFC • GO - LIVE ERP Go Live Simulation Testing50% (12-May) Simulation Testing10% (22-Apr) ERP Go Live Customization • Parallel Test Run • Test / Simulation • Basic Data upload • End User Training 3

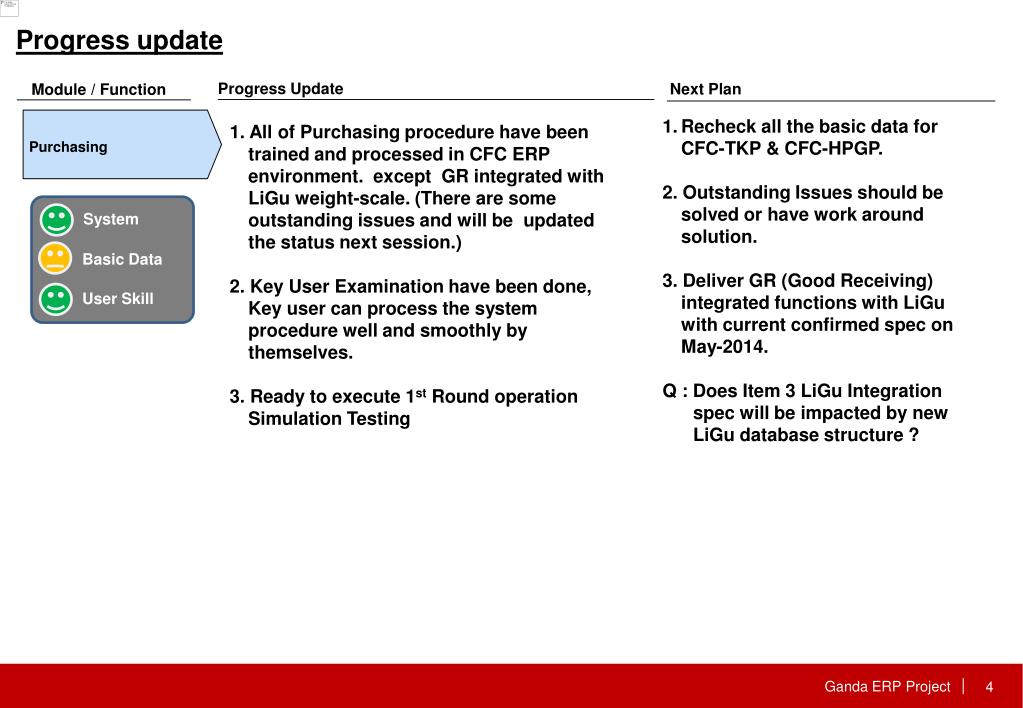

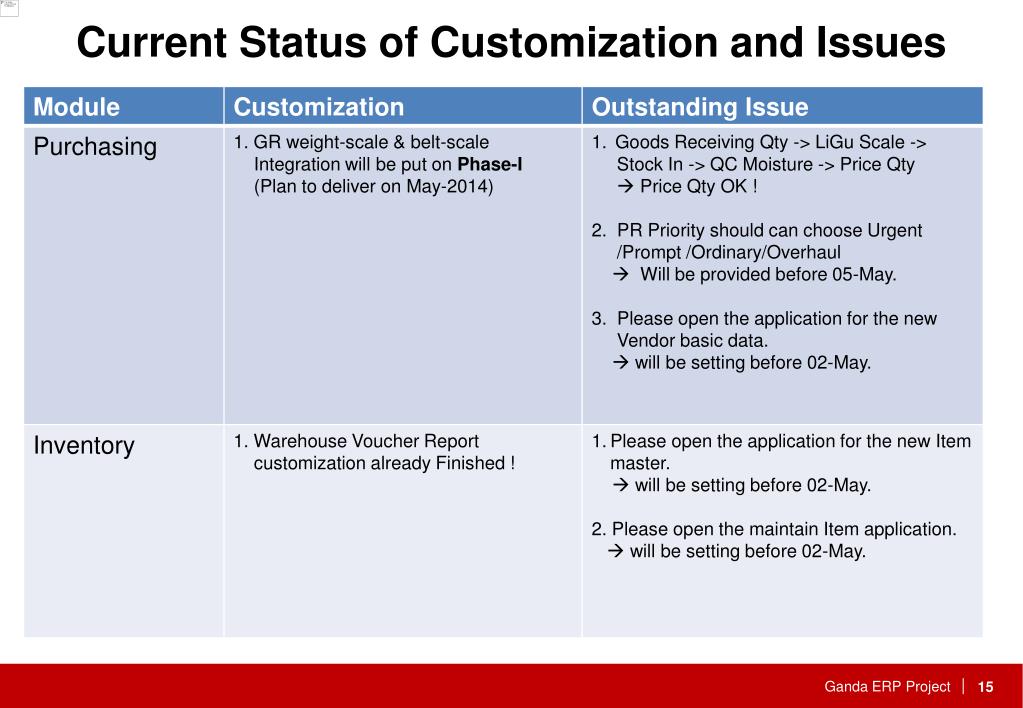

  5. Progress update Purchasing Progress Update Next Plan Module / Function • Recheck all the basic data for CFC-TKP & CFC-HPGP. • 2. Outstanding Issues should be solved or have work around solution. • 3. Deliver GR (Good Receiving) integrated functions with LiGu with current confirmed spec on May-2014. • Q : Does Item 3 LiGu Integration • spec will be impacted by new • LiGu database structure ? 1. All of Purchasing procedure have been trained and processed in CFC ERP environment. except GR integrated with LiGu weight-scale. (There are some outstanding issues and will be updated the status next session.) 2. Key User Examination have been done, Key user can process the system procedure well and smoothly by themselves. 3. Ready to execute 1st Round operation Simulation Testing System User Skill Basic Data 4

  6. Progress update Inventory Progress Update Next Plan Module / Function • Recheck all the basic data for CFC-TKP & CFC-HPGP. • (Item’s CoA attribute should be • maintained) 1. All of Inventory procedure have been trained and processed in CFC ERP environment. 2. Key User Examination have been done, Key user can process the system procedure well and smoothly by themselves. 3. Ready to execute 1st Round operation Simulation Testing System User Skill Basic Data 5

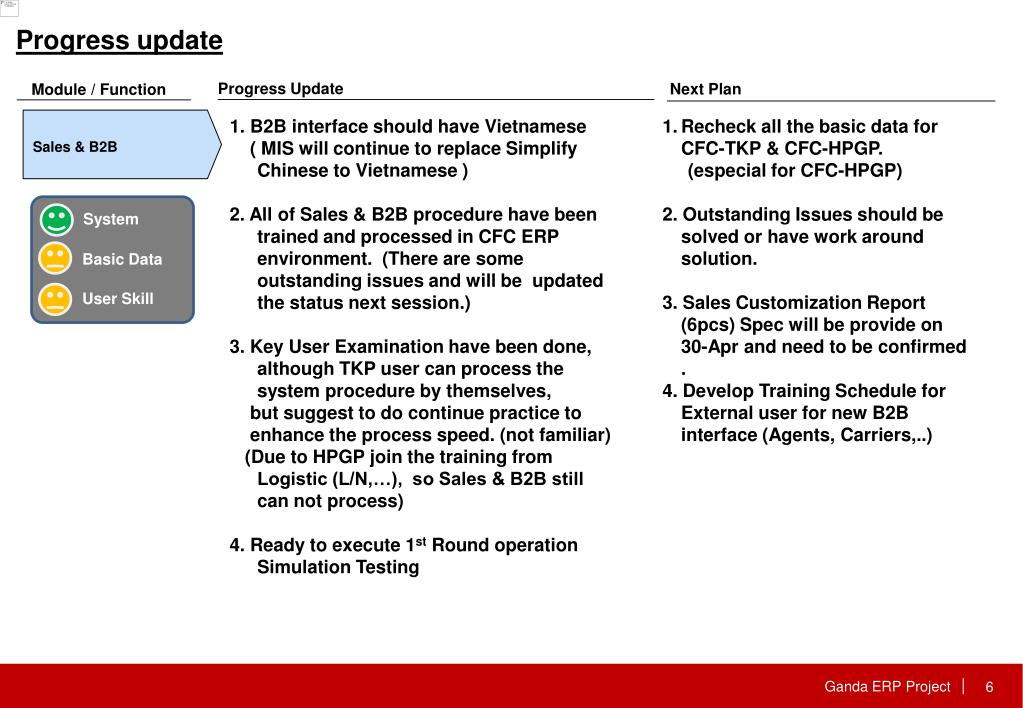

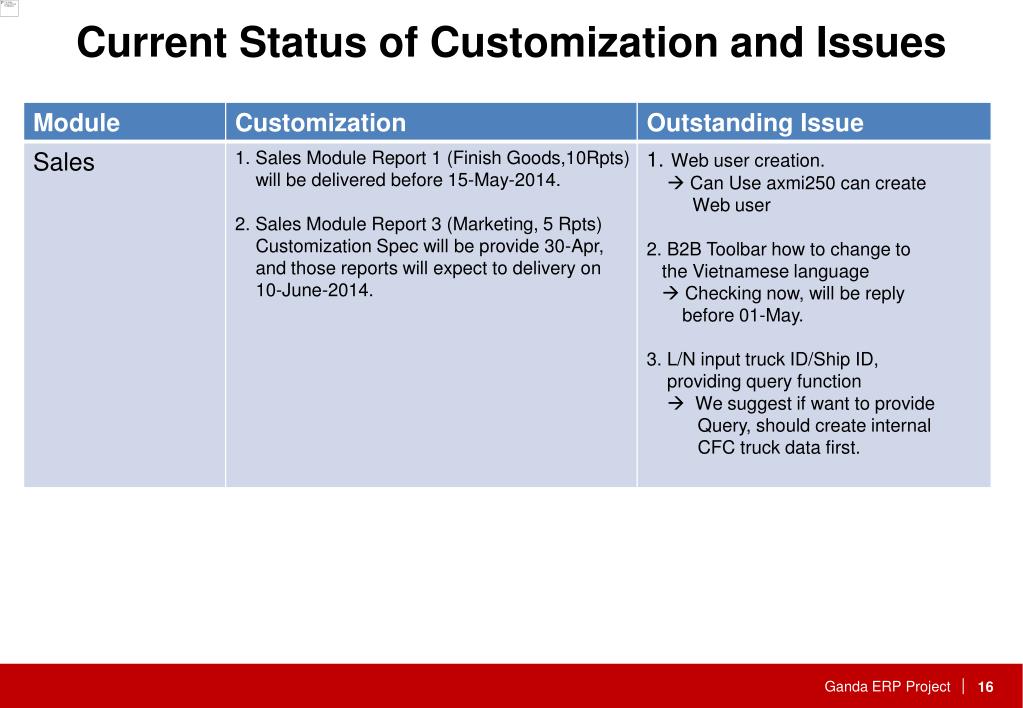

  7. Progress update Sales & B2B Progress Update Next Plan Module / Function 1. B2B interface should have Vietnamese ( MIS will continue to replace Simplify Chinese to Vietnamese ) 2. All of Sales & B2B procedure have been trained and processed in CFC ERP environment. (There are some outstanding issues and will be updated the status next session.) 3. Key User Examination have been done, although TKP user can process the system procedure by themselves, but suggest to do continue practice to enhance the process speed. (not familiar) (Due to HPGP join the training from Logistic (L/N,…), so Sales & B2B still can not process) 4. Ready to execute 1st Round operation Simulation Testing • Recheck all the basic data for CFC-TKP & CFC-HPGP. • (especial for CFC-HPGP) • 2. Outstanding Issues should be solved or have work around solution. • 3. Sales Customization Report (6pcs) Spec will be provide on 30-Apr and need to be confirmed . • 4. Develop Training Schedule for External user for new B2B interface (Agents, Carriers,..) System Basic Data User Skill 6

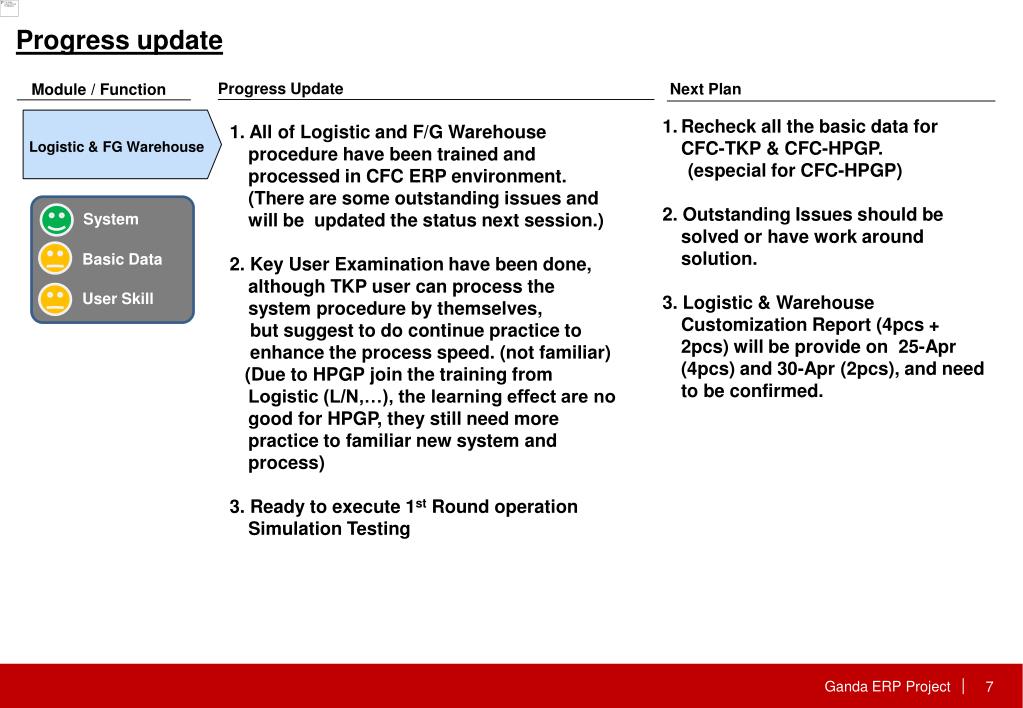

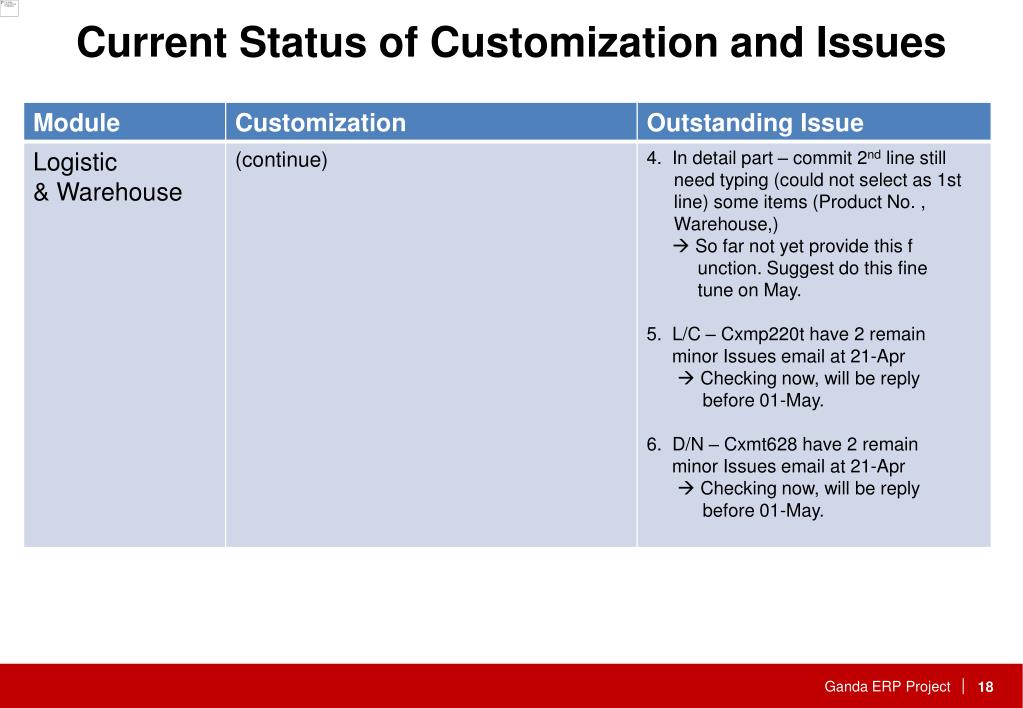

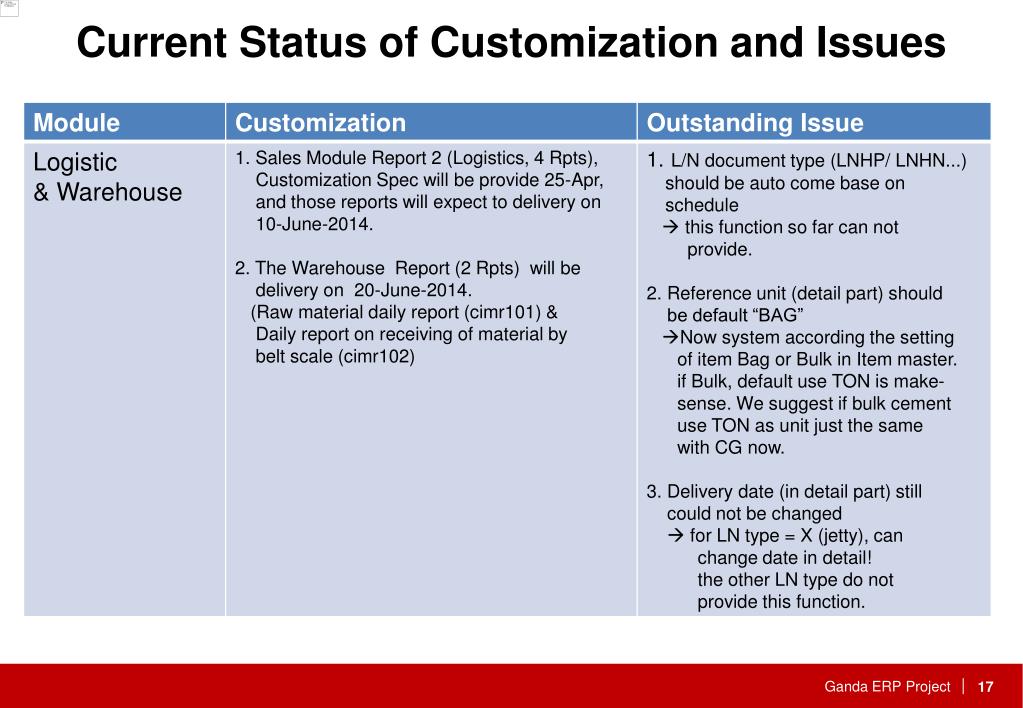

  8. Progress update Logistic & FG Warehouse Progress Update Next Plan Module / Function • Recheck all the basic data for CFC-TKP & CFC-HPGP. • (especial for CFC-HPGP) • 2. Outstanding Issues should be solved or have work around solution. • 3. Logistic & Warehouse Customization Report (4pcs + 2pcs) will be provide on 25-Apr (4pcs) and 30-Apr (2pcs), and need to be confirmed. 1. All of Logistic and F/G Warehouse procedure have been trained and processed in CFC ERP environment. (There are some outstanding issues and will be updated the status next session.) 2. Key User Examination have been done, although TKP user can process the system procedure by themselves, but suggest to do continue practice to enhance the process speed. (not familiar) (Due to HPGP join the training from Logistic (L/N,…), the learning effect are no good for HPGP, they still need more practice to familiar new system and process) 3. Ready to execute 1st Round operation Simulation Testing System Basic Data User Skill 7

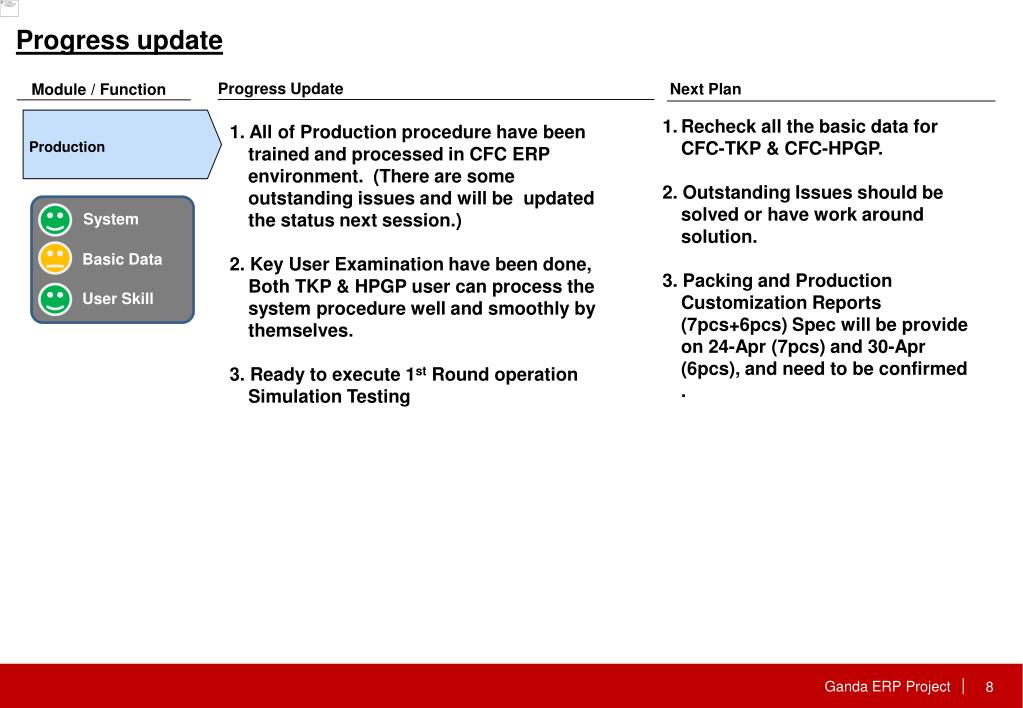

  9. Progress update Production Progress Update Next Plan Module / Function • Recheck all the basic data for CFC-TKP & CFC-HPGP. • 2. Outstanding Issues should be solved or have work around solution. • 3. Packing and Production Customization Reports (7pcs+6pcs) Spec will be provide on 24-Apr (7pcs) and 30-Apr (6pcs), and need to be confirmed . 1. All of Production procedure have been trained and processed in CFC ERP environment. (There are some outstanding issues and will be updated the status next session.) 2. Key User Examination have been done, Both TKP & HPGP user can process the system procedure well and smoothly by themselves. 3. Ready to execute 1st Round operation Simulation Testing System Basic Data User Skill 8

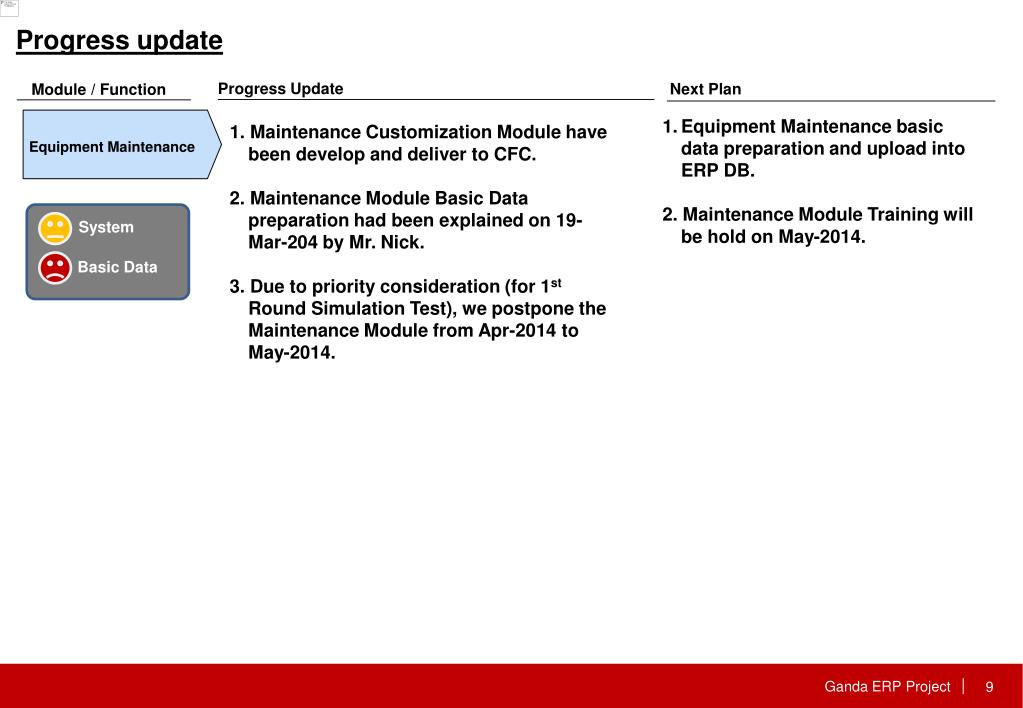

  10. Progress update Equipment Maintenance Progress Update Next Plan Module / Function • Equipment Maintenance basic data preparation and upload into ERP DB. • 2. Maintenance Module Training will be hold on May-2014. 1. Maintenance Customization Module have been develop and deliver to CFC. 2. Maintenance Module Basic Data preparation had been explained on 19-Mar-204 by Mr. Nick. 3. Due to priority consideration (for 1st Round Simulation Test), we postpone the Maintenance Module from Apr-2014 to May-2014. System Basic Data 9

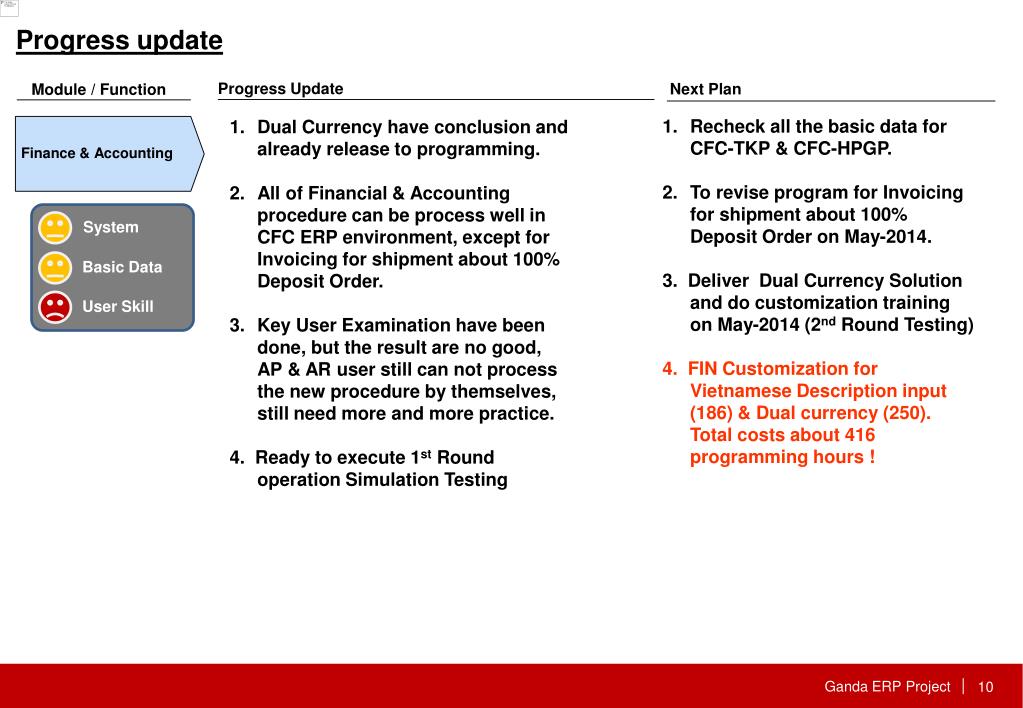

  11. Progress update Finance & Accounting Progress Update Next Plan Module / Function • Recheck all the basic data for CFC-TKP & CFC-HPGP. • 2. To revise program for Invoicing for shipment about 100% Deposit Order on May-2014. • 3. Deliver Dual Currency Solution and do customization training on May-2014 (2nd Round Testing) • 4. FIN Customization for Vietnamese Description input (186) & Dual currency (250). Total costs about 416 programming hours ! • Dual Currency have conclusion and already release to programming. • All of Financial & Accounting procedure can be process well in CFC ERP environment, except for Invoicing for shipment about 100% Deposit Order. • Key User Examination have been done, but the result are no good, AP & AR user still can not process the new procedure by themselves, still need more and more practice. • 4. Ready to execute 1st Round operation Simulation Testing System Basic Data User Skill 10

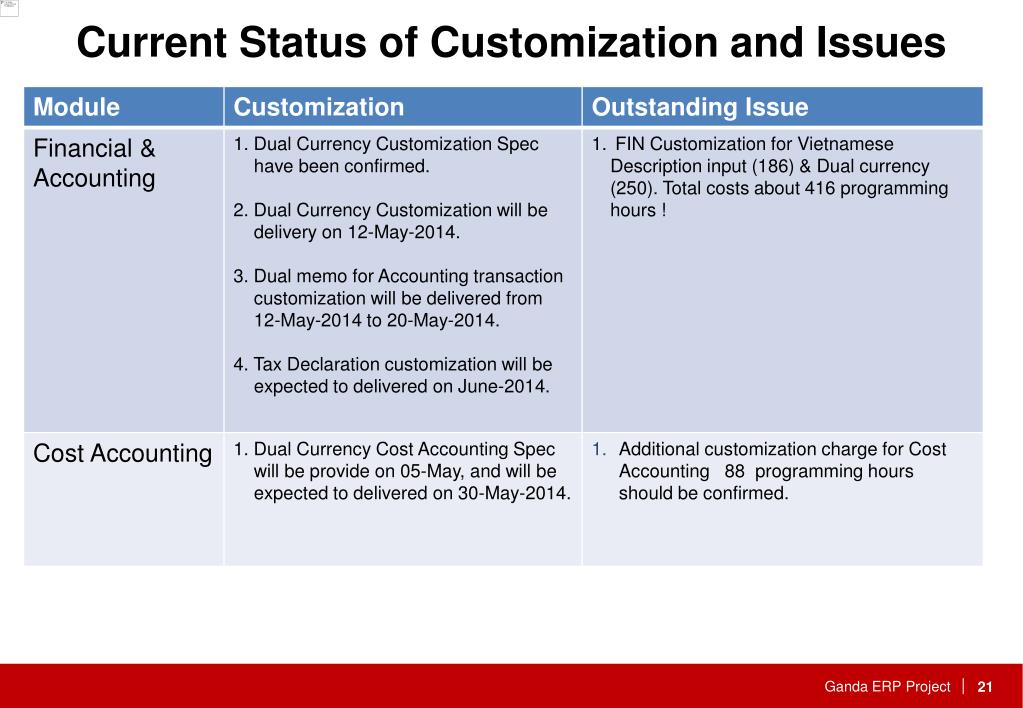

  12. Progress update Cost Accounting Progress Update Next Plan Module / Function • Deliver Dual Currency Solution for Cost Accounting and do customization training on May-2014 (2nd Round Testing) • Additional customization charge for Cost Accounting 88 programming hours should be confirmed. • Dual Currency Solution for Cost Accounting have been confirm and now developing customization spec. • 2. Because of this additional level process need to auto generate related transaction from system. That will cause additional customization charge (88 hours). System Basic Data 11

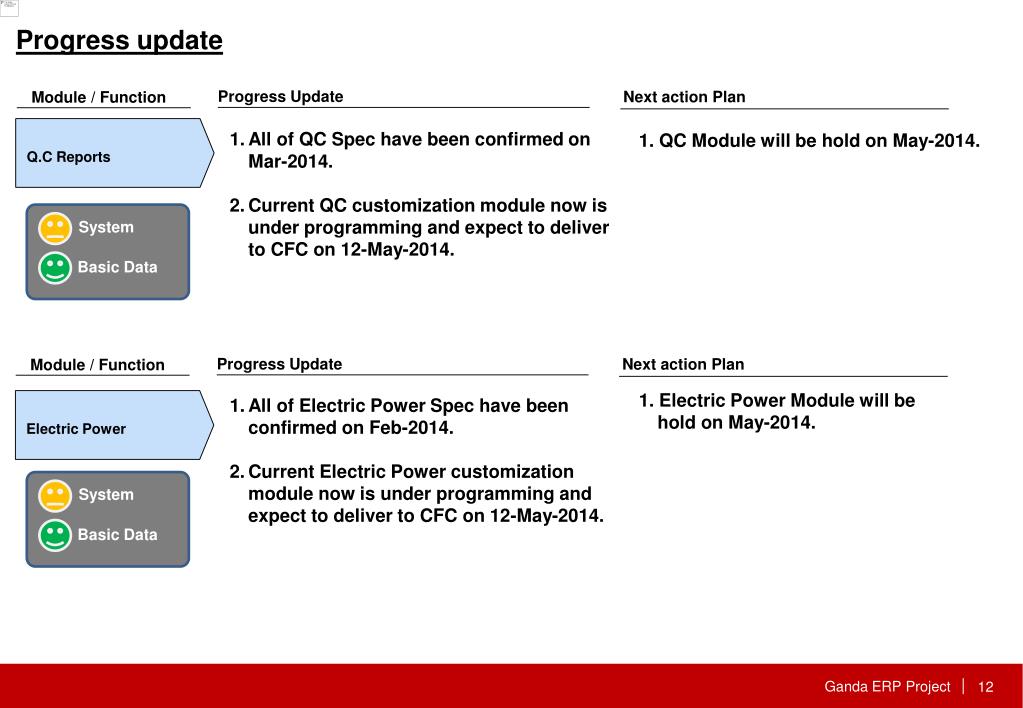

  13. Progress update Electric Power Q.C Reports Progress Update Next action Plan Module / Function • All of QC Spec have been confirmed on Mar-2014. • Current QC customization module now is under programming and expect to deliver to CFC on 12-May-2014. 1. QC Module will be hold on May-2014. System System Basic Data Basic Data Progress Update Next action Plan Module / Function 1. Electric Power Module will be hold on May-2014. • All of Electric Power Spec have been confirmed on Feb-2014. • Current Electric Power customization module now is under programming and expect to deliver to CFC on 12-May-2014. 12

  14. Progress update Customization Reports SMS Progress Update Next action Plan Module / Function 1. SMS Customization Spec have already delivered to CFC on Mar-2014. 2. SMS Platform and SMS Service Message Program have been develop (and revised). 3. Now is testing SMS Modem integration function. 1. Doing CFC SMS Modem Compatibility Testing on May-2014. 2. CFC SMS Customization Technical Transfer on June-2014. System System Basic Data Basic Data Progress Update Next action Plan Module / Function 1. Have already provide 25 customization Reports Spec to CFC confirmed on 05-Apr. 2. There are some delay on remaining customization reports , and Digiwin should to catch-up the schedule. ( Original Plan (52 RPTs) : 28/3 : 25 RPTs ; 5/4 : 10 RPTs; 11/4 : 8 RPTs ; 18/4 : 5 RPTs ; 25/4 : 4 RPTs ) 1. To catch-up delay schedule and provide Cust. reports Spec as below: on 24-Apr : a. Packing Report (7pcs) b. Elec Power Report (4pcs) c. Logistic Report (4pcs) on 30-Apr : d. Sales Report (6pcs) e. Production Report (6pcs) f. Warehouse Report (2pcs) 13

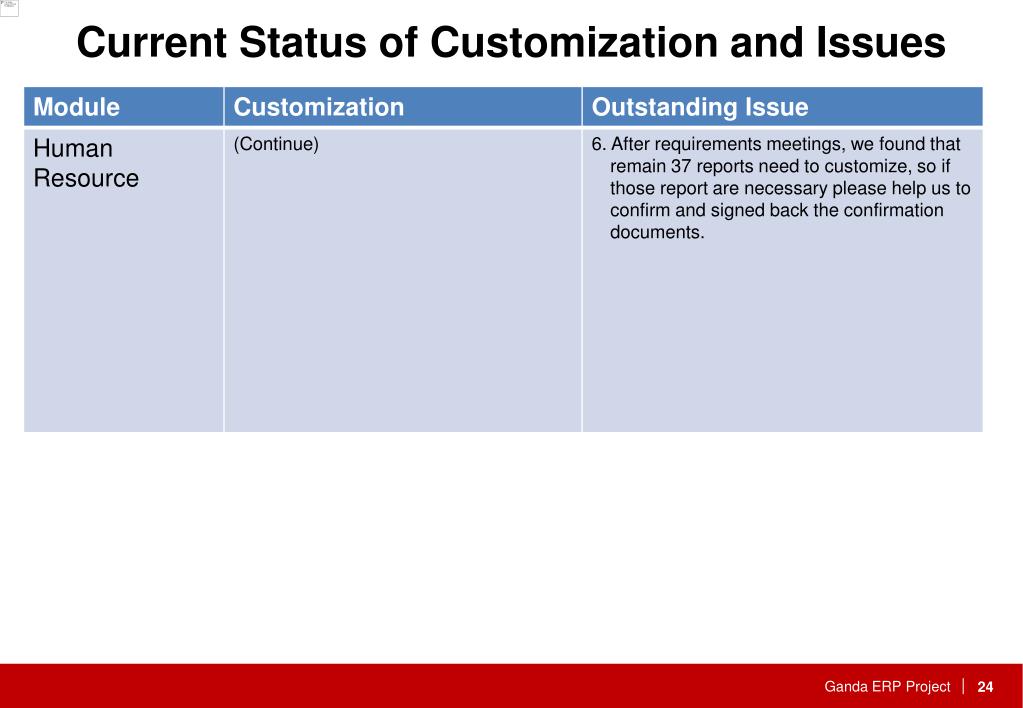

  15. Progress update HRM & ESS Progress Update Next action Plan Module / Function 1. Provide P/S Bonus Spec to confirm before 02-May-2014. ( P/S Bonus will be separate into P/S bonus parameters P/S Bonus Calculation and P/S Bonus ) 2. HRM Customization Progress, and start to deliver from end of May-2014. 3. Checking HRM Go-Live Strategy : (1) HRM Go-Live first (01-July) , then ESS Go-Live Second step. (2) HRM + ESS Go-Live at same time (will impact original HRM 01-July Go-live Schedule, the expect Parallel testing on Aug-2014, and go-live on Sep-2014) • All of HRM confirmation spec have been provide except P/S Bonus Spec. • 2. CFC Organization Data already upload into HRM System. • 3. Basic Salary formula already been setting • 4. Waiting CFC Sign-back customization Spec. (annual leave,…) System Basic Data 14

  16. Current Status of Customization and Issues 15

  17. Current Status of Customization and Issues 16

  18. Current Status of Customization and Issues 17

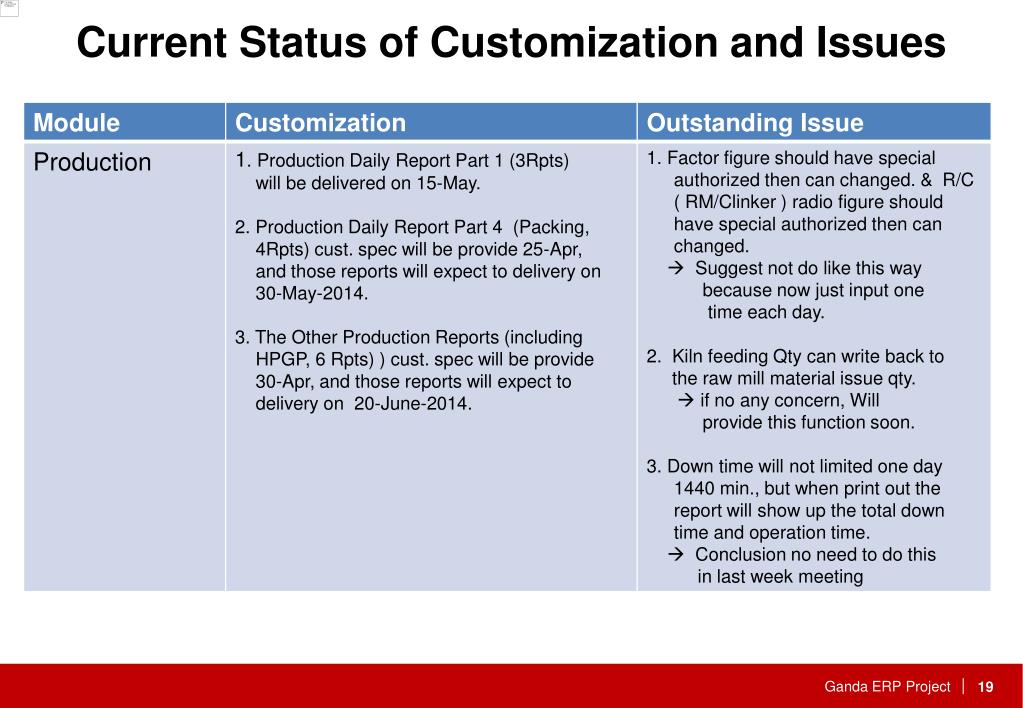

  19. Current Status of Customization and Issues 18

  20. Current Status of Customization and Issues 19

  21. Current Status of Customization and Issues 20

  22. Current Status of Customization and Issues 21

  23. Current Status of Customization and Issues 22

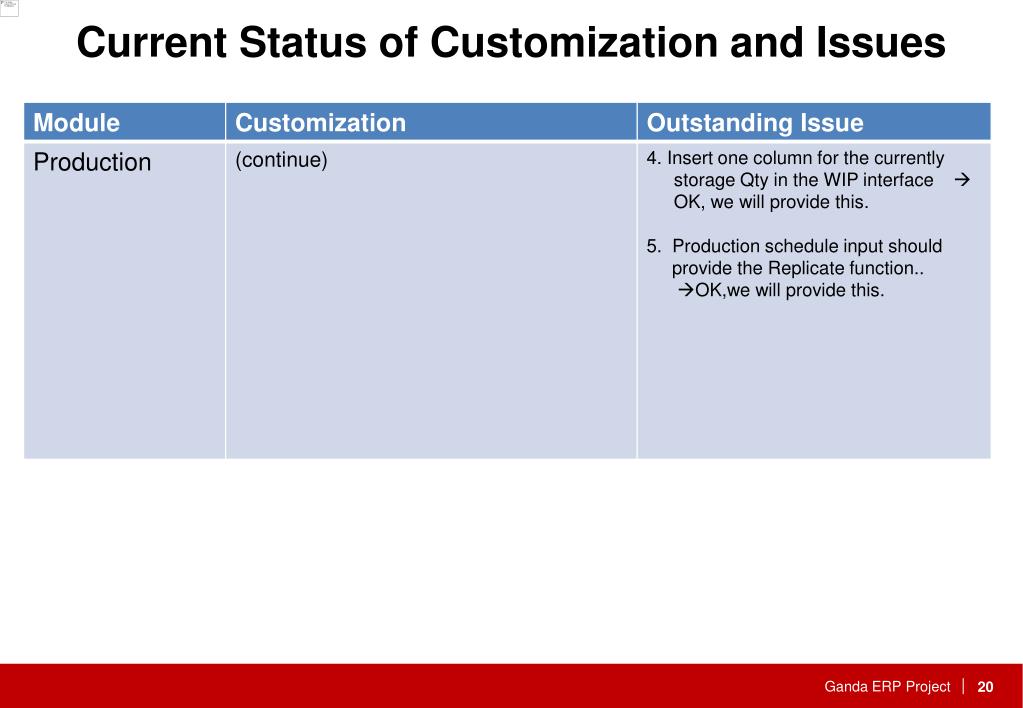

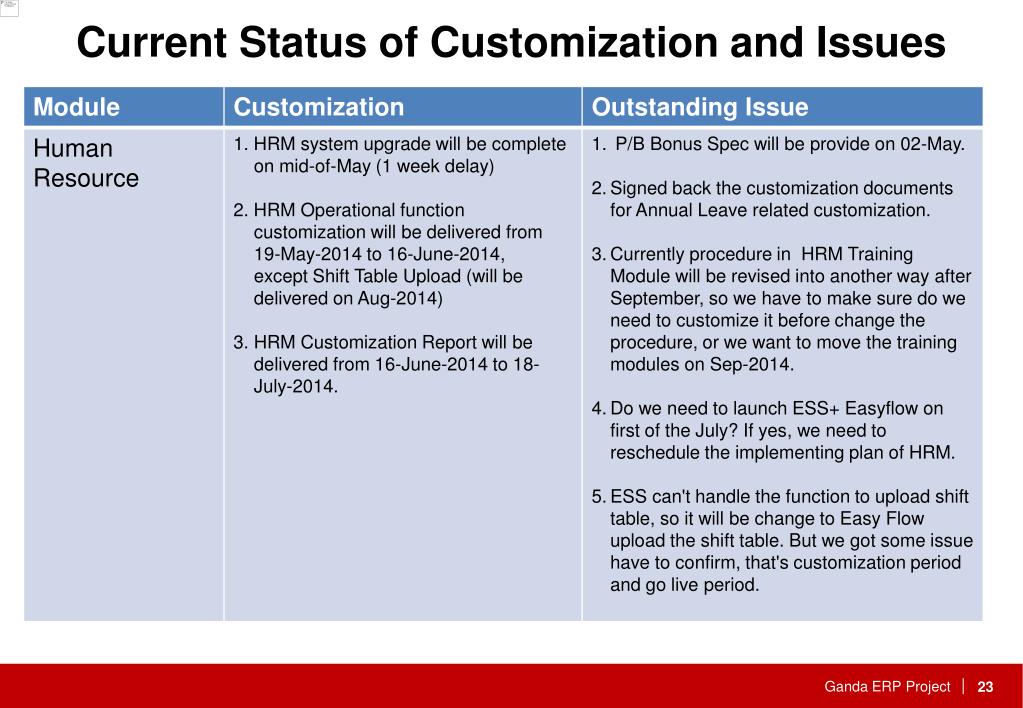

  24. Current Status of Customization and Issues 23

  25. Current Status of Customization and Issues 24

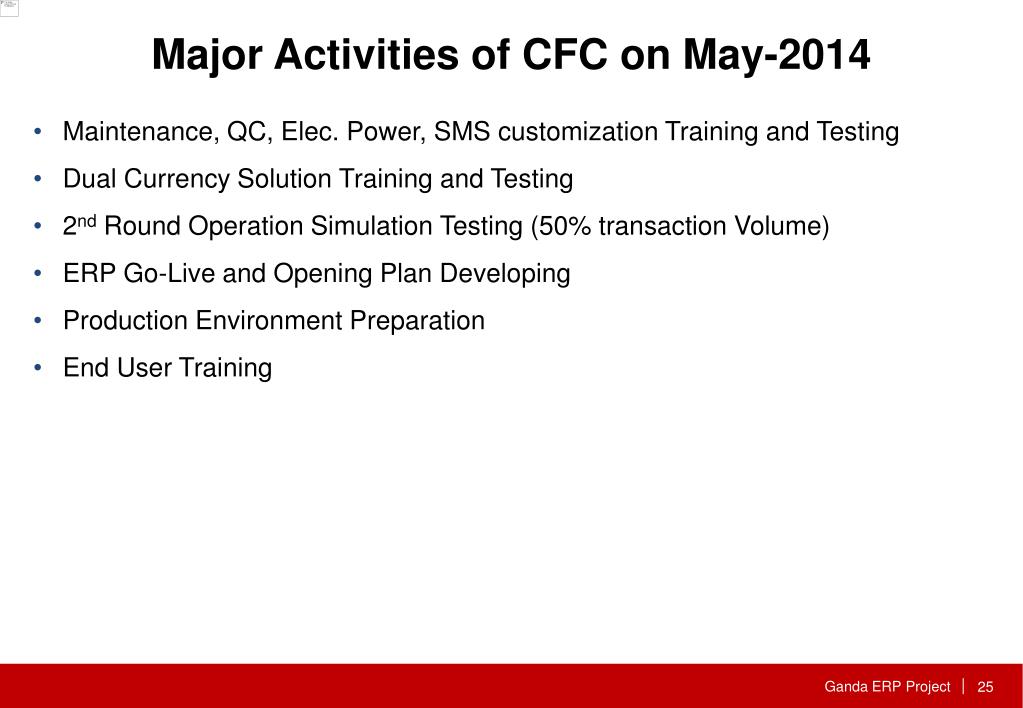

  26. Major Activities of CFC on May-2014 • Maintenance, QC, Elec. Power, SMS customization Training and Testing • Dual Currency Solution Training and Testing • 2nd Round Operation Simulation Testing (50% transaction Volume) • ERP Go-Live and Opening Plan Developing • Production Environment Preparation • End User Training 25

  27. THANK YOU

More Related
