SlideServe
Menu
Préférences
© SlideServe · v2026

UAT Launch

karina-morrison avatar
8 diapositives · 315 Views · Nov 19, 2014

UAT Launch. 5th February 2003. Introduction. There are 8 distinct parts of UAT to take place between January-April 2003 pre-implementation: RDM/ Sorter Tests x 2 Initial User Validation RMS data set-up-(13 scripts) Parallel Run 1 & 2 –(24 scripts) Foundation Data User Validation

UAT Launch - slide 1
01 / 8UAT Launch
1 / 17

Télécharger la présentation

UAT Launch
Une image / un lien ci-dessous est fourni (tel quel) pour télécharger la présentation

Politique de téléchargement : le contenu du site vous est fourni TEL QUEL pour votre information et votre usage personnel ; il ne peut être vendu, concédé sous licence ni partagé sur d’autres sites sans l’accord de son auteur.Le contenu vous est fourni TEL QUEL, pour votre information et votre usage personnel uniquement. Téléchargez la présentation en cliquant sur ce lien. Lors du téléchargement, si vous ne parvenez pas à télécharger une présentation, l’éditeur a peut-être supprimé le fichier de son serveur.Pendant le téléchargement, si vous ne parvenez pas à obtenir une présentation, le fichier a peut-être été supprimé par l’éditeur.

F I N

Plus de contenu associé

Transcription de la présentation
  1. UAT Launch 5th February 2003

  2. Introduction • There are 8 distinct parts of UAT to take place between January-April 2003 pre-implementation: • RDM/ Sorter Tests x 2 • Initial User Validation • RMS data set-up-(13 scripts) • Parallel Run 1 & 2 –(24 scripts) • Foundation Data User Validation • Data Validation of 4c in Parallel Run 2 • Data Integrity • Ongoing System Test of CRs, retests, ad hoc functionality

  3. Purpose • Project Odyssey is undertaking these two phases of User Acceptance Testing to allow business users to test that the Odyssey solution provides the requisite functionality, within acceptable tolerances • This is designed to build confidence in the solution before real users commence using it • A number of scripts have been created to be executed during these phases • There will be two elements of testing via scripts performed by the business users: • RMS data set-up 06/02-14/02 • Parallel Run 1 tbc • A second phase of UAT using scripts to test the solution will be performed by Super-users from the business in March • UAT is interlinked with PPT, especially the running of the integrated batch. This is a critical part of PPT, and timings might vary from plan so flexibility & pragmatism will be required within UAT • There will be a different feel to UAT than System Test as users will only be accessing the RMS front end –so more enjoyable!

  4. Team & Structure

  5. Script Ownership

  6. Environment • 8 desks on ground floor of new building-previous System test location • RMS installed on each PC for the users • RMS Production Environment to be used for testing • New log-ons for access to UAT environments • Daily administration like System test • Access to RMS governed by PPT batch running-need for flexibility • Current timetable depends on PPT success in starting running the batch • Need to be aware of updates/ checkpoints during the day at which decisions will be taken on timings of system availability for UAT • Likely updates for this week • Wednesday 5.00pm • Thursday 9.00am, 1.00pm & 5.00pm • Friday 9.00am

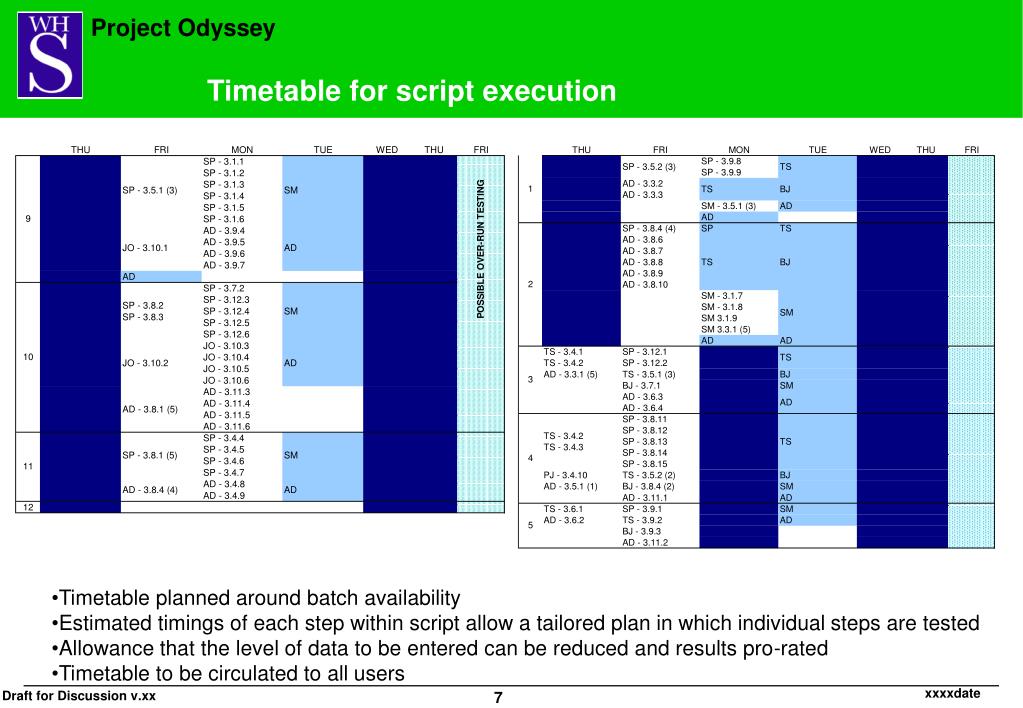

  7. Timetable for script execution • Timetable planned around batch availability • Estimated timings of each step within script allow a tailored plan in which individual steps are tested • Allowance that the level of data to be entered can be reduced and results pro-rated • Timetable to be circulated to all users

  8. Administration & Reporting Back-up worksheet capturing red sections where time taken to execute step of script was outside tolerance Similar admin spreadsheet to monitor successful testing by section
