Norfolk Naval Shipyard Cable Storage Rack
130 likes | 278 Vues
Addressing disorganization, safety hazards, and damage to cable spools, this project proposes a structural steel rack with environmental protection features. |
Norfolk Naval Shipyard Cable Storage Rack
E N D
Presentation Transcript
Norfolk Naval ShipyardCable Storage Rack Faculty Advisor: Dr. Han P. Bao Group Leader: Parker Harding Group Members: Christina Toroc Hunter Hughes Deborah C. McHugh

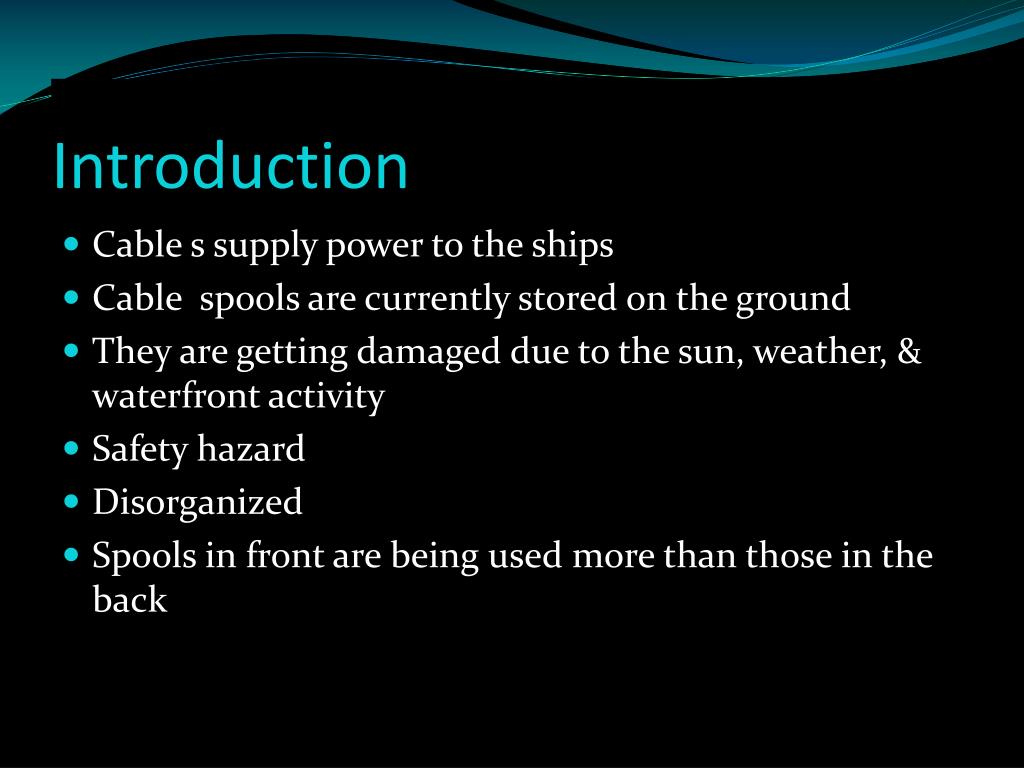

Introduction • Cable s supply power to the ships • Cable spools are currently stored on the ground • They are getting damaged due to the sun, weather, & waterfront activity • Safety hazard • Disorganized • Spools in front are being used more than those in the back

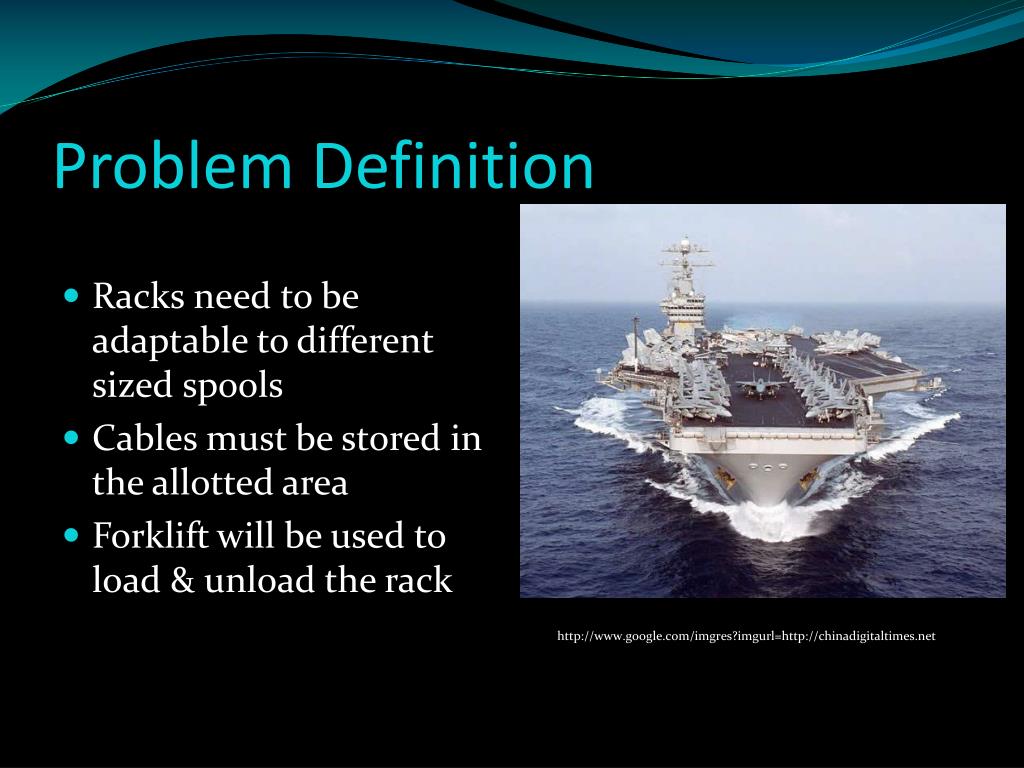

Problem Definition • Racks need to be adaptable to different sized spools • Cables must be stored in the allotted area • Forklift will be used to load & unload the rack http://www.google.com/imgres?imgurl=http://chinadigitaltimes.net

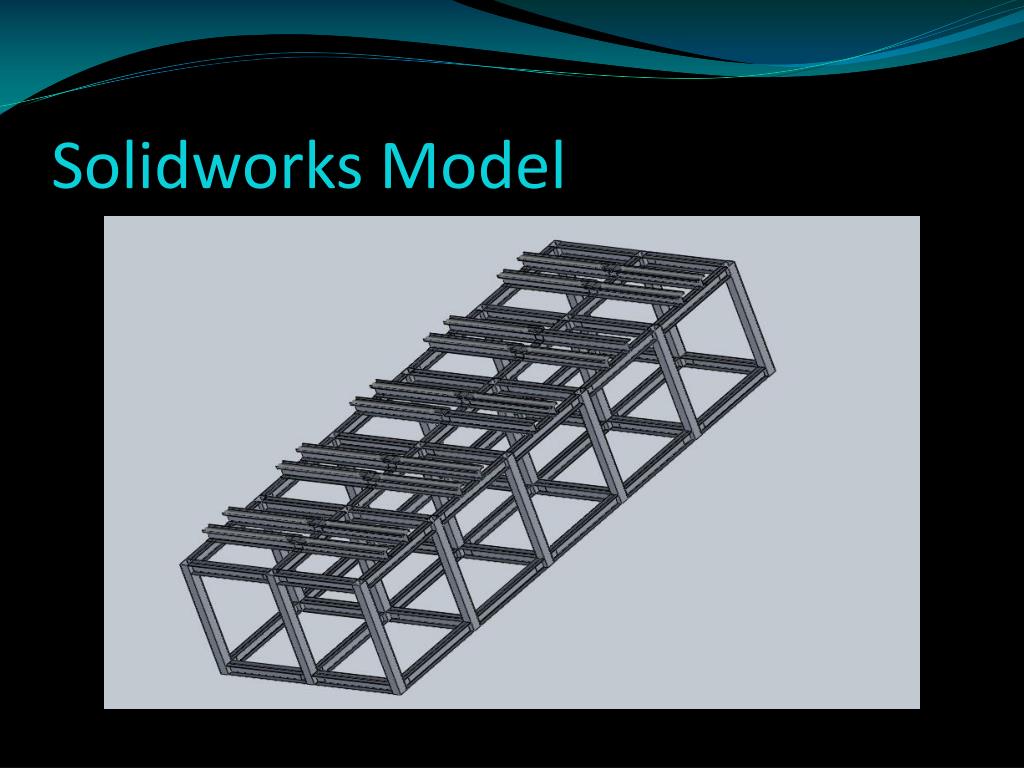

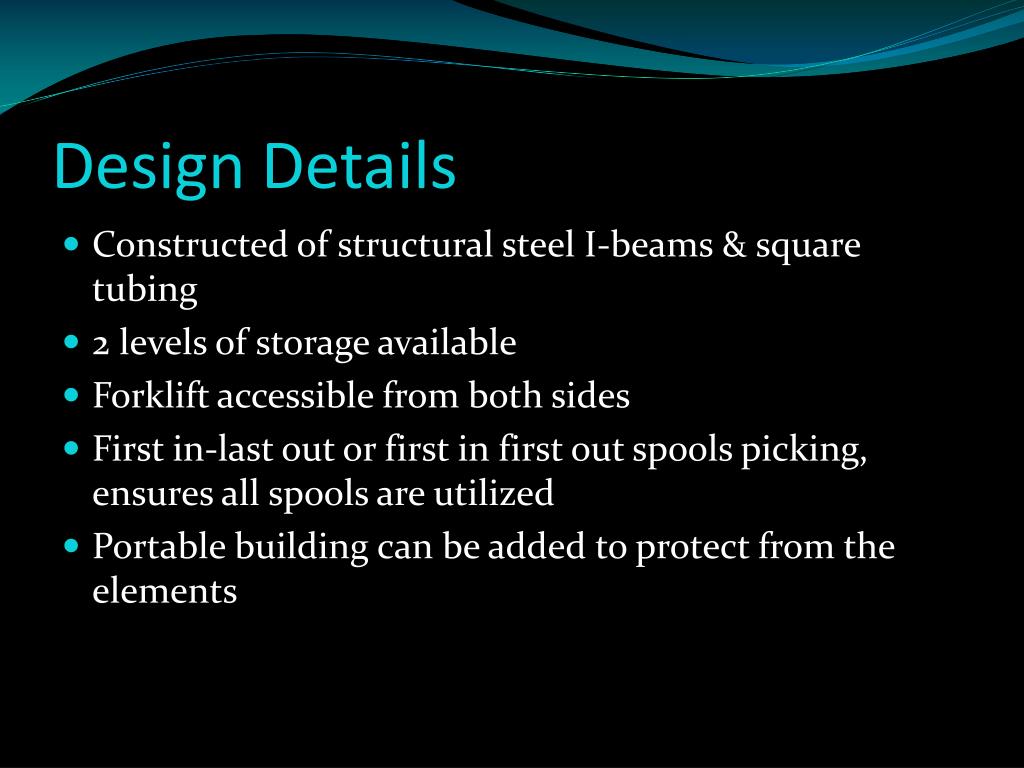

Design Details • Constructed of structural steel I-beams & square tubing • 2 levels of storage available • Forklift accessible from both sides • First in-last out or first in first out spools picking, ensures all spools are utilized • Portable building can be added to protect from the elements
Environmental Protection • Portable Building • Polyolefin Covered Shelters • 5-8 yr lifetime expectancy • Bolted construction, to withstand up to 70 mph winds • Can be manufactured to withstand up to 110 mph winds • Flame retardant, UV, & mildew treated • 5 year pro-rated warranty http://1southerncomfortshelters.com/services.nxg

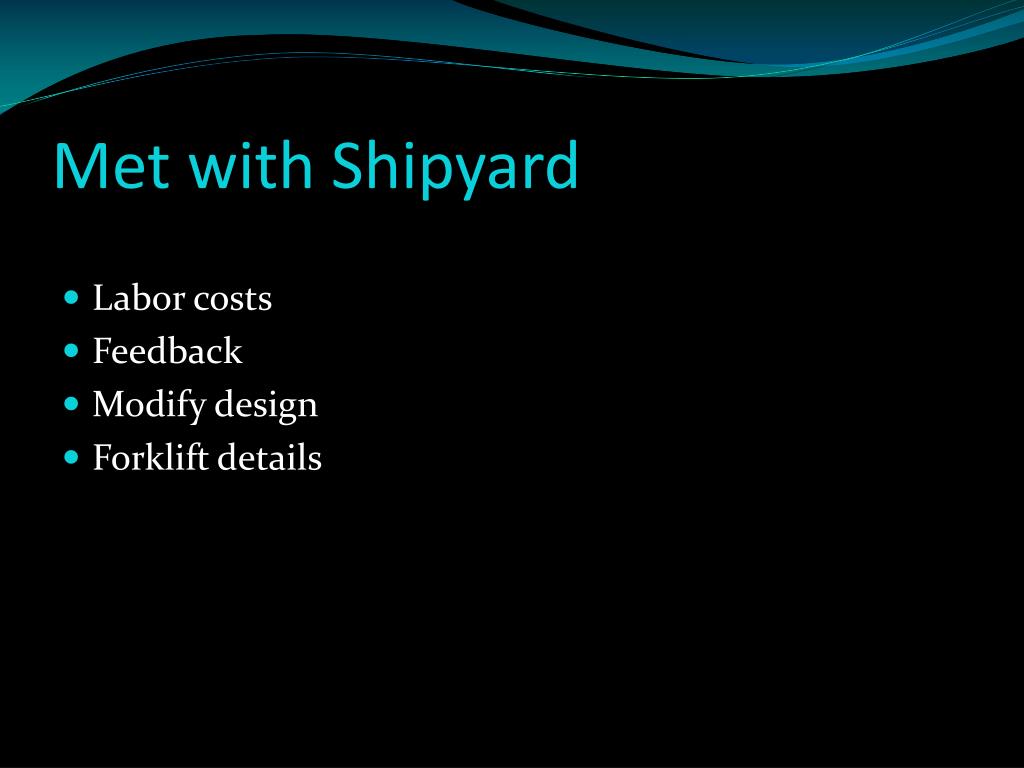

Met with Shipyard • Labor costs • Feedback • Modify design • Forklift details

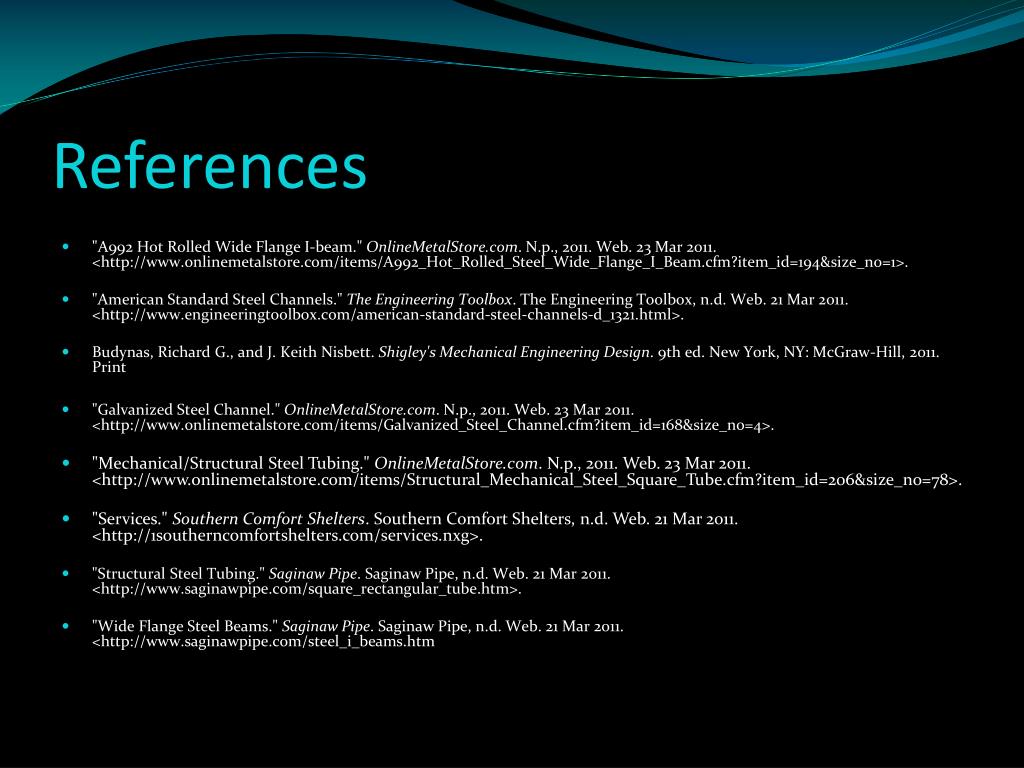

References • "A992 Hot Rolled Wide Flange I-beam." OnlineMetalStore.com. N.p., 2011. Web. 23 Mar 2011. <http://www.onlinemetalstore.com/items/A992_Hot_Rolled_Steel_Wide_Flange_I_Beam.cfm?item_id=194&size_no=1>. • "American Standard Steel Channels." The Engineering Toolbox. The Engineering Toolbox, n.d. Web. 21 Mar 2011. <http://www.engineeringtoolbox.com/american-standard-steel-channels-d_1321.html>. • Budynas, Richard G., and J. Keith Nisbett. Shigley's Mechanical Engineering Design. 9th ed. New York, NY: McGraw-Hill, 2011. Print. • "Galvanized Steel Channel." OnlineMetalStore.com. N.p., 2011. Web. 23 Mar 2011. <http://www.onlinemetalstore.com/items/Galvanized_Steel_Channel.cfm?item_id=168&size_no=4>. • "Mechanical/Structural Steel Tubing." OnlineMetalStore.com. N.p., 2011. Web. 23 Mar 2011. <http://www.onlinemetalstore.com/items/Structural_Mechanical_Steel_Square_Tube.cfm?item_id=206&size_no=78>. • "Services." Southern Comfort Shelters. Southern Comfort Shelters, n.d. Web. 21 Mar 2011. <http://1southerncomfortshelters.com/services.nxg>. • "Structural Steel Tubing." Saginaw Pipe. Saginaw Pipe, n.d. Web. 21 Mar 2011. <http://www.saginawpipe.com/square_rectangular_tube.htm>. • "Wide Flange Steel Beams." Saginaw Pipe. Saginaw Pipe, n.d. Web. 21 Mar 2011. <http://www.saginawpipe.com/steel_i_beams.htm>.
