NETWORK ON CHIP ROUTER PART A Midterm presentation Students : Itzik Ben - shushan Jonathan Silber Instructor : Isaschar Walter Winter 2006
Problem: Power, size and performance not practical for multi-processor chips using a single bus interconnection. Solution: Network on Chip, based interconnection: fast, reliable data and low power consumption.

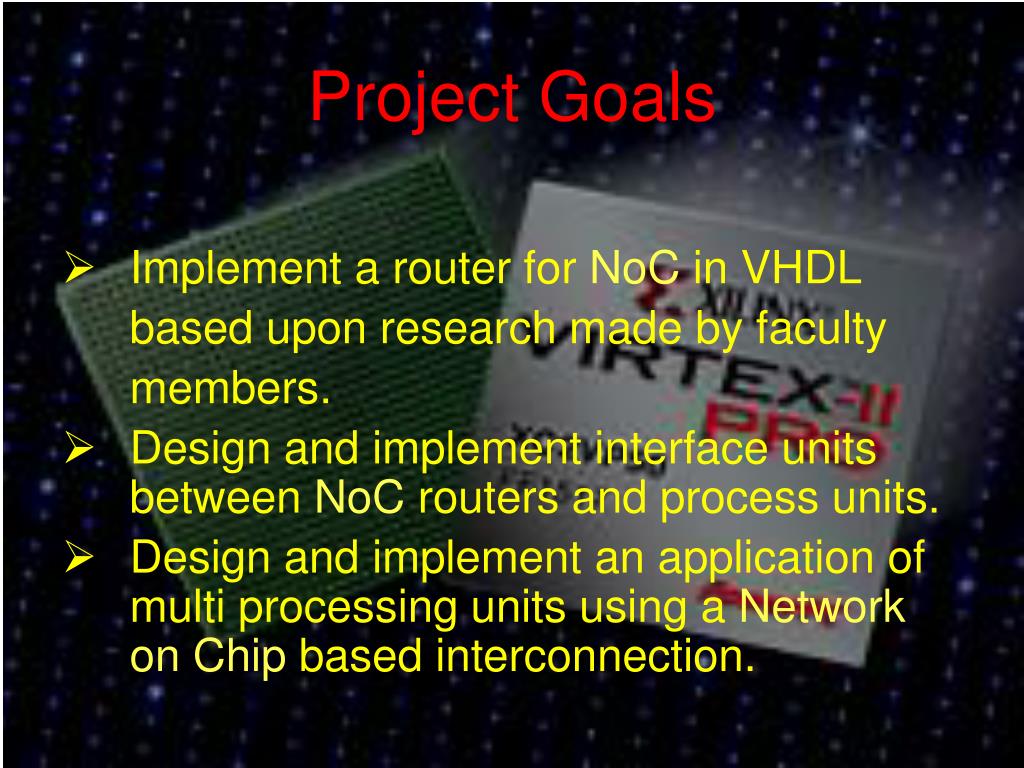

Project Goals • Implement a router forNoCin VHDL based upon research made by faculty members. • Design and implement interface units between NoCrouters and process units. • Design and implement an application of multi processing units using a Network on Chip based interconnection.
Interface Interface Interface Interface ROUTER ROUTER ROUTER ROUTER ROUTER ROUTER Interface Interface Processing Unit NoC General Schematic NoC Interface Interface ROUTER ROUTER ROUTER Interface
Input Port Output Port Router 5x5 Processing Unit ROUTER Interface North West Crossbar Data East Control Data Control South

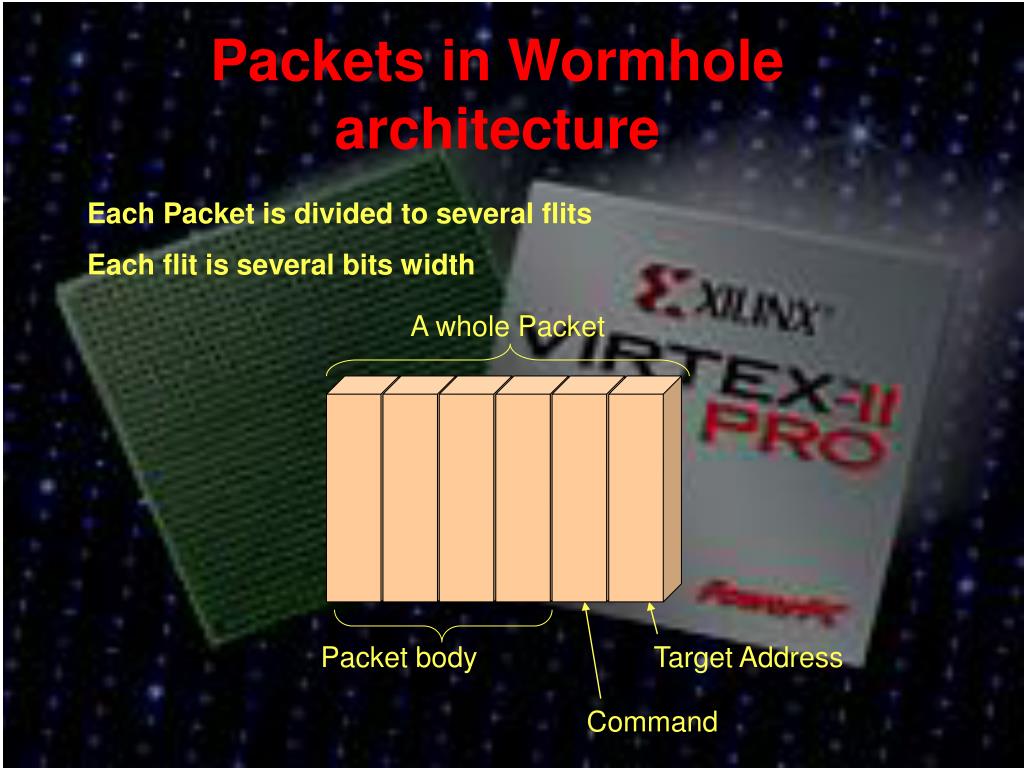

Packets in Wormholearchitecture • Each Packet is divided to several flits • Each flit is several bits width A whole Packet Packet body Target Address Command

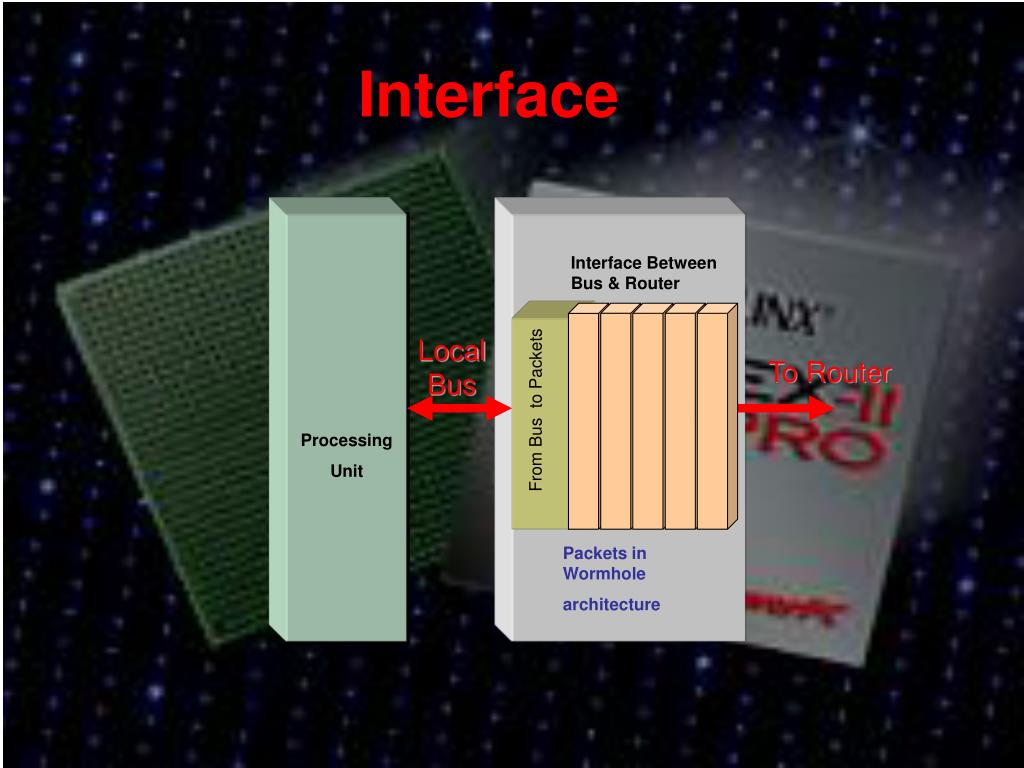

Process Unit Process Unit Process Unit Process Unit Process Unit Interface Interface Between Bus & Router Local Bus To Router From Bus to Packets Processing Unit Packets in Wormhole architecture
Wormhole Packets in Service Type : Idle FP Body EP Data out x N flit x 2 Type SL : Signaling Real-Time RD/WR Block Transfer Service Level x 2
FIFO FIFO CRT CRT Router Input Port Current Routing Table ROUTER • Input • Port Crossbar Data Per Service- Level PREVIOUS ROUTER IN PATH Data In flits Switching SL Input Buffer Control Input Port Control Buffer credits
Crossbar Example for 2 Service Levels From Input Port To Output port switch Round Robin To Output Port From Input Port CrossbarControl CRT+Type CSIP+NBS
CSIP CSIP NBS NBS Router Output Port Currently Serviced Input Port Next Buffer State ROUTER • Output • Port Crossbar Data Per Service- Level NEXT ROUTER IN PATH Data In flits Switching SL Control Output Port Control Buffer credits Buffer credits
The Router Control Inputs : • Type/SL – from flit data. • FIFO control lines. • CRT,NBS (from buffer credits) ,CSIP.

Project schedule - First Semester Goals • Implement On Virtex II Pro, week 8 . • Operate peripherals on board, week 9. • Operate PPC on board, week 10. • Design an architecture of a simple router, week 11. • Implement and Simulate the router, weeks 12-13. • Debug of the router, week 14.
Final GoalPart A • 3x3 Router • 2 Service Levels • Receiving/Transmitting A One Flit Packet (FP)
Project schedule - Second Semester Goals • Adding Virtual-Channel to Router architecture . • Development of interface to the network • Final Goal : Implement a QNoC based application on a FPGA.

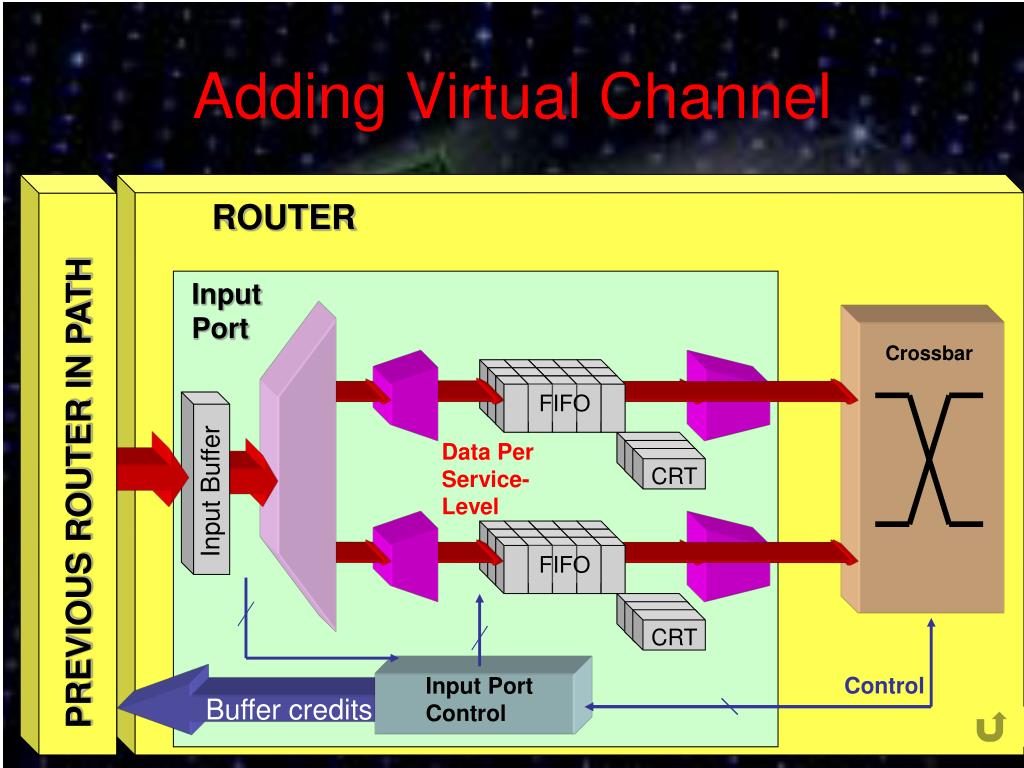

FIFO FIFO FIFO FIFO FIFO FIFO CRT CRT CRT CRT CRT CRT PREVIOUS ROUTER IN PATH Input Buffer Adding Virtual Channel ROUTER • Input • Port Crossbar Data Per Service- Level Switching SL Control Input Port Control Buffer credits
