Uncertain activity duration (P14)

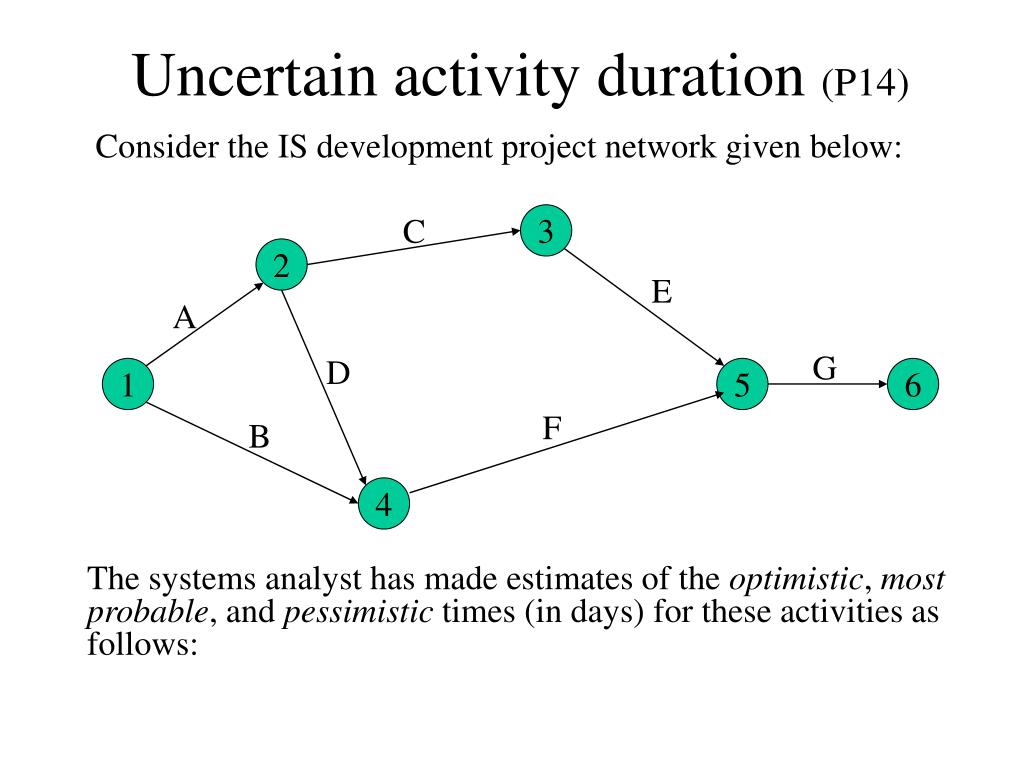

Uncertain activity duration (P14). Consider the IS development project network given below:. C. 3. 2. E. A. G. D. 1. 5. 6. F. B. 4. The systems analyst has made estimates of the optimistic , most probable , and pessimistic times (in days) for these activities as follows:.

laszlo
Télécharger la présentation

Uncertain activity duration (P14)

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Uncertain activity duration (P14) Consider the IS development project network given below: C 3 2 E A G D 1 5 6 F B 4 The systems analyst has made estimates of the optimistic, most probable, and pessimistic times (in days) for these activities as follows:

  2. Uncertain duration estimates (P14) Activity Optimistic Most Probable Pessimistic A 5 6 7 B 5 12 13 C 6 8 10 D 4 10 10 E 5 6 13 F 7 7 10 G 4 7 10 a) Find the critical path. b) How much slack time, if any, is there for activity C? c) Determine the expected project completion time and the variance. d) Find the probability that the project will be completed in 30 days or less.

  3. Analyst planning a training (P15) Activity Description Immediate Optimistic Most Pessimistic Predecessors Prob. A Plan topic - 1.5 2 2.5 B Arrange speakers A 2 2.5 6 C List locations - 1 2 3 D Select location C 1.5 2 2.5 E Speaker travel plan B,D 0.5 1 1.5 F Finalize speakers E 1 2 3 G Prepare brochure B,D 3 3.5 7 H Take reservations G 3 4 5 I Last-minute details F,H 1.5 2 2.5 a. Show the PERT/CPM network for this project. b. What are the critical path activities and expected project completion time? c. Prepare the activity schedule for this project. d. If the analyst wants a 0.99 probability of completing the project on time, how far ahead of the scheduled meeting date should she begin working on the project?

  4. Critical and non-critical paths (p16) Q1- Why the probability of completing a project on time is based on the analysis of the critical path? Q2- In what case, if any, would it be desirable to make the probability computation for a non-critical path?
