leia
Uploaded by
49 SLIDES
701 VUES
500LIKES

Enhanced Production Audit Program (EPAP)

DESCRIPTION

Enhanced Production Audit Program (EPAP). CAPPA Conference Panel Hosted by: Al McCue 21 October 2009. How we will proceed. Each panellist will present for 6 – 7 minutes We’ll spend the bulk of the time responding to your questions We’ll close with short remarks from some panellists . 2.

1 / 49

Télécharger la présentation

Enhanced Production Audit Program (EPAP)

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Enhanced Production Audit Program(EPAP) CAPPA Conference Panel Hosted by: Al McCue 21 October 2009

  2. How we will proceed • Each panellist will present for 6 – 7 minutes • We’ll spend the bulk of the time responding to your questions • We’ll close with short remarks from some panellists 2

  3. Question period After all panellists have made their presentations, we will open up the session to your questions Your package contains index cards Write your questions legibly on a card Hold it high in the air where a volunteer will run it up to the podium 3

  4. Colby Ruff Rhon Rose Al Davis Eric Hazeldine Yogi Schulz Earl Quantz ERCB BP Canada (IMG) NAL Resources (CAPPA) Quorum Business Solutions Corvelle (ERCB – EPAP Project Manager) CAPPA Today’s Panel 4

  5. Enhanced Production Audit ProgramERCB Overview CAPPA Conference Panel Presented by: Colby Ruff 21 October 2009

  6. Presentation Outline • EPAP Goals • EPAP Philosophy • EPAP Benefits 6

  7. EPAP Goals • Raise level of compliance to ERCB measurement and reporting requirements • Raise level of assurance over compliance to ERCB measurement and reporting requirements 7

  8. EPAP Philosophy “Trust, but verify” - Ronald Reagan 8

  9. Benefits to Operators Appropriate level of assurance over compliance with ERCB requirements Improved compliance with ERCB requirements Improved volumetric business processes & controls Higher quality volumetric data 9

  10. Enhanced Production Audit ProgramNew Business Practices CAPPA Conference Panel Presented by: Rhon Rose 21 October 2009

  11. General Context • EPAP targets long term improvement in the compliance to: • Directive 007 reporting • Directive 017 measurement • Reporting is more visible • IMG is building a set of business practices for measurement • Most of the IMG areas will impact/involve the Production Accounting community 11

  12. IMG Business Practices PA Impact Schematic Metering Diagrams High Gas and Liquid Analysis High Gas Chart Readings Low Calibrations and Proving Low SCADA/EFM/Automation Low Fuel, Flare, and Vent Medium Oil Well Testing Medium Gas Well Testing Medium Effluent Well Testing Medium 12

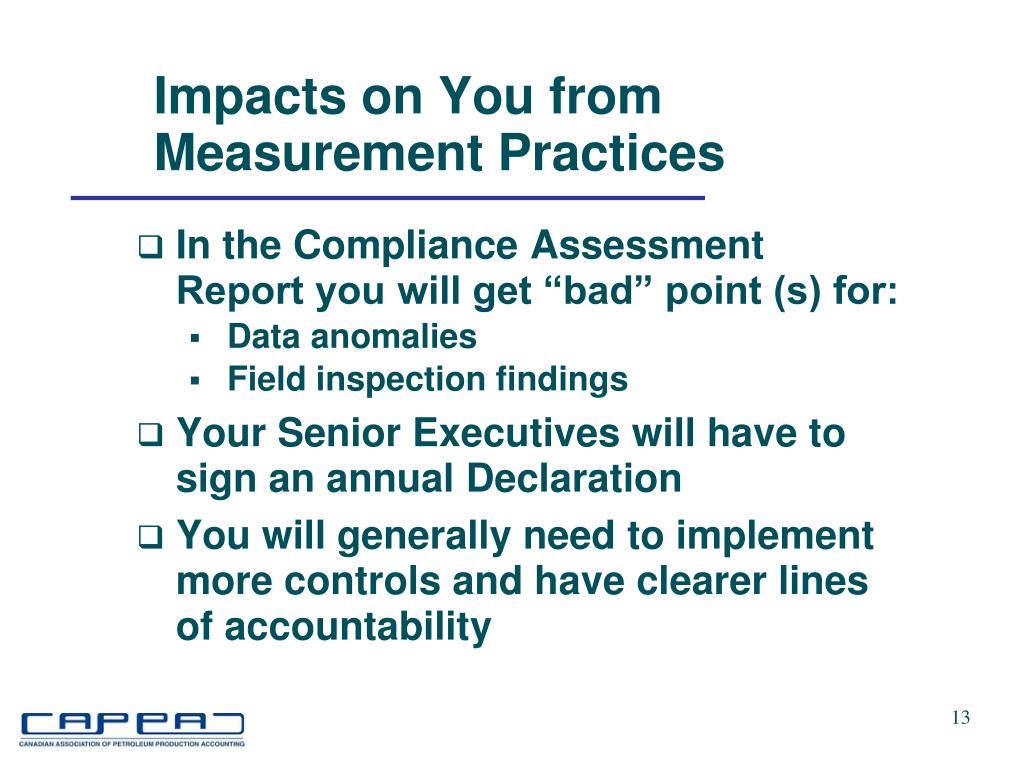

  13. Impacts on You from Measurement Practices • In the Compliance Assessment Report you will get “bad” point (s) for: • Data anomalies • Field inspection findings • Your Senior Executives will have to sign an annual Declaration • You will generally need to implement more controls and have clearer lines of accountability 13

  14. Metering Schematics • Do you have current ones? • Does it match how you do your allocations? • Do they contain the required information? • Has someone been assigned responsibility to maintain them? • Does your company have a control in place to ensure they are done and kept up to date? 14

  15. Metering Schematics IMG Document BP Example Note: Any party tied to a BP plant is asked to request and review these with your PA 15

  16. Enhanced Production Audit ProgramPA Business Process Best Practices CAPPA Conference Panel Presented by: Al Davis 21 October 2009

  17. CAPPA Objectives Strengthen the profession of Production accounting Represent P.A. industry technically and procedurally Provide education program for P.A. Promote cordial relations among members Provide production statistics forum 17

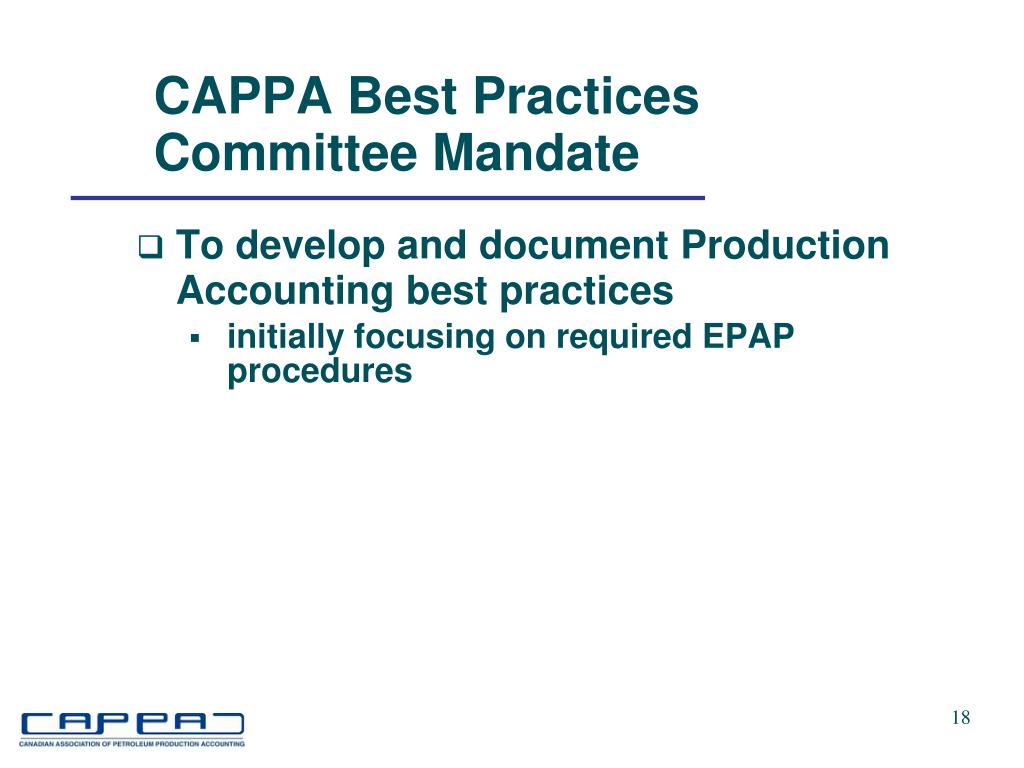

  18. CAPPA Best Practices Committee Mandate To develop and document Production Accounting best practices initially focusing on required EPAP procedures 18

  19. Process ERCB has identified 74 non-compliance issues CAPPA has determined that 33 of these are production accounting Committee is developing processes Using ERCB process template 19

  20. Status 33 processes to be developed 9 are high risk, 24 are low risk Draft completed for 6 high risk processes Draft completed for 16 low risk processes 66% have drafts completed currently starting draft reviews 20

  21. Next Steps Complete remaining drafts – Nov. Review and finalize all drafts – Jan. Standardize formats – Feb. Review with CAPPA board - ongoing Post on CAPPA website, access to industry Plan to post some processes for year end 21

  22. ERCB Process Template Components Process Description: Process background Risk of noncompliance Process owners Process description Process map/flow chart Process control matrix 22

  23. Process ExampleGas Disposition Reporting Background Gas disposition volumes are used to calculate gas volumes at a facility or well therefore the gas volumes must be reported in an accurate and timely manner 23

  24. Process ExampleGas Disposition Reporting Associated risk of non-compliance Incorrect reporting results in inaccurate production, inaccurate revenue, incorrect royalty payments, increased government monitoring, audits and penalties, incorrect partner information and additional costs associated with reworks. 24

  25. Process ExampleGas Disposition Reporting Process owners Field operator Production accountant for the receiving facility Production Accountant for the delivering facilities 25

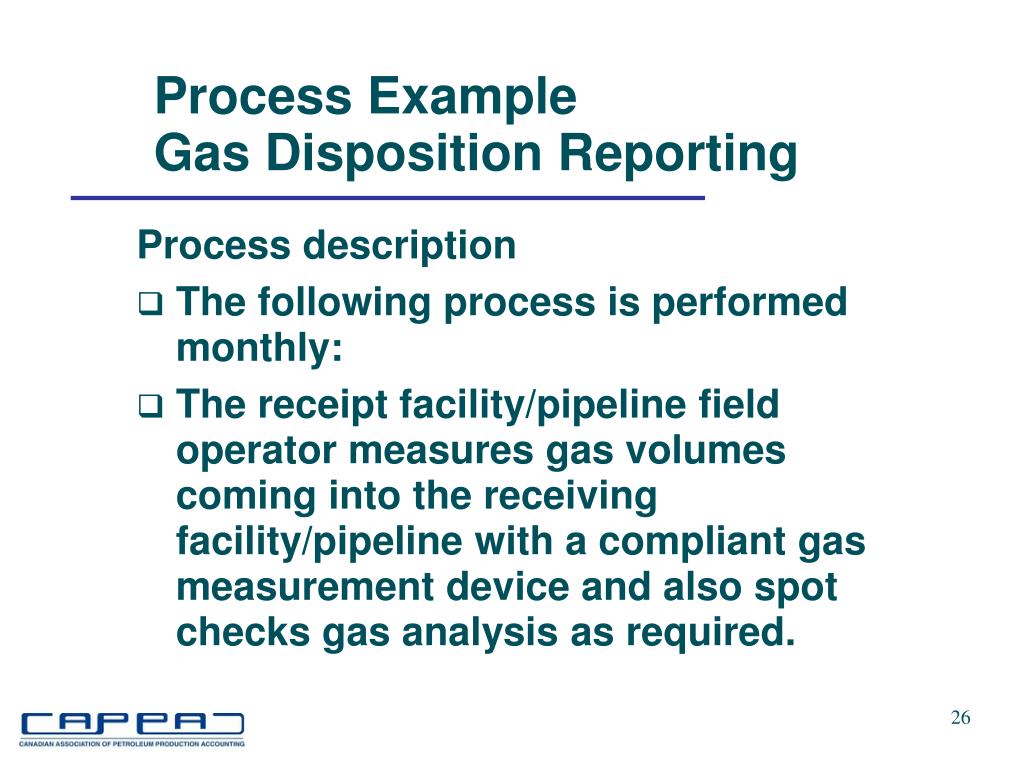

  26. Process ExampleGas Disposition Reporting Process description The following process is performed monthly: The receipt facility/pipeline field operator measures gas volumes coming into the receiving facility/pipeline with a compliant gas measurement device and also spot checks gas analysis as required. 26

  27. Process ExampleGas Disposition Reporting Process map/flow chart Outlines the process steps, how they all hang together and associated controls. 27

  28. Process ExampleGas Disposition Reporting Process control matrix Defines the details of every associated control 28

  29. Enhanced Production Audit ProgramPreparing for EPAP CAPPA Conference Panel Presented by: Eric Hazeldine 21 October 2009

  30. High-Level Considerations • All operators have measurement and reporting business processes • Are they documented? • Do they leave an audit trail? • Also have controls that assure timely and quality results from processes • Automated or manual? • Facility-level or Company-level? • Do they assure D007 & D017 compliance? • Answers influence EPAP approach 30

  31. Measurement ProgramBest Practices • Processes and Controls: • Strengthening is easier than creating and replacing • Modifications that move toward automation with full audit trail are most valuable • Consideration of D-007 and D-017 requirements in context of process modifications will yield appropriate controls 31

  32. Measurement ProgramBest Practices, continued • Strive for uniform processes and controls across fields / assets • Greatly simplifies evaluations of controls • Lower cost to implement and maintain processes and controls • Job sharing and job transfers are easier • Change Management is key when processes are being changed • Increases long-term adherence and buy-in • More than documentation and training 32

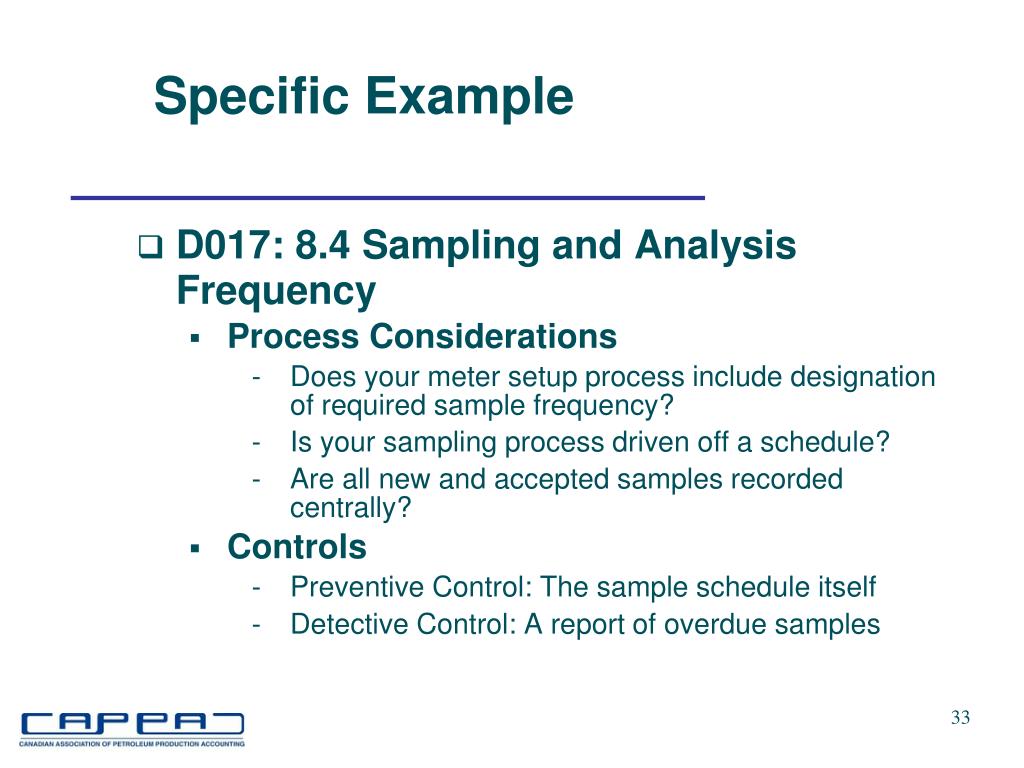

  33. Specific Example • D017: 8.4 Sampling and Analysis Frequency • Process Considerations • Does your meter setup process include designation of required sample frequency? • Is your sampling process driven off a schedule? • Are all new and accepted samples recorded centrally? • Controls • Preventive Control: The sample schedule itself • Detective Control: A report of overdue samples 33

  34. Specific Example • D017: 4.3.3 Measurement Data Audit Trail • Process Considerations • Where are raw volumes first recorded? • Raw volumes: EFM, SCADA, Data Historian, Chart Integrator, 3rd Party • How do they propagate into • Field Data Capture / Measurement system? • Production Accounting system? • Registry? • Controls • Detective Controls: Reconcile… • Production Accounting inputs to Registry inputs • Field Data Capture inputs to Production Accounting inputs 34

  35. Enhanced Production Audit ProgramProject Summary CAPPA Conference Panel Presented by: Yogi Schulz 21 October 2009

  36. Presentation Outline EPAP development EPAP components Implementation schedule Operator role Please e-mail any questions you may have to: epap@ercb.ca EPAP is further described under Projects & Issues at: www.ercb.ca

  37. EPAP Development 37

  38. EPAP Components Operator evaluations of controls Declaration process Compliance assessment process Action item process D-019 Enforcement

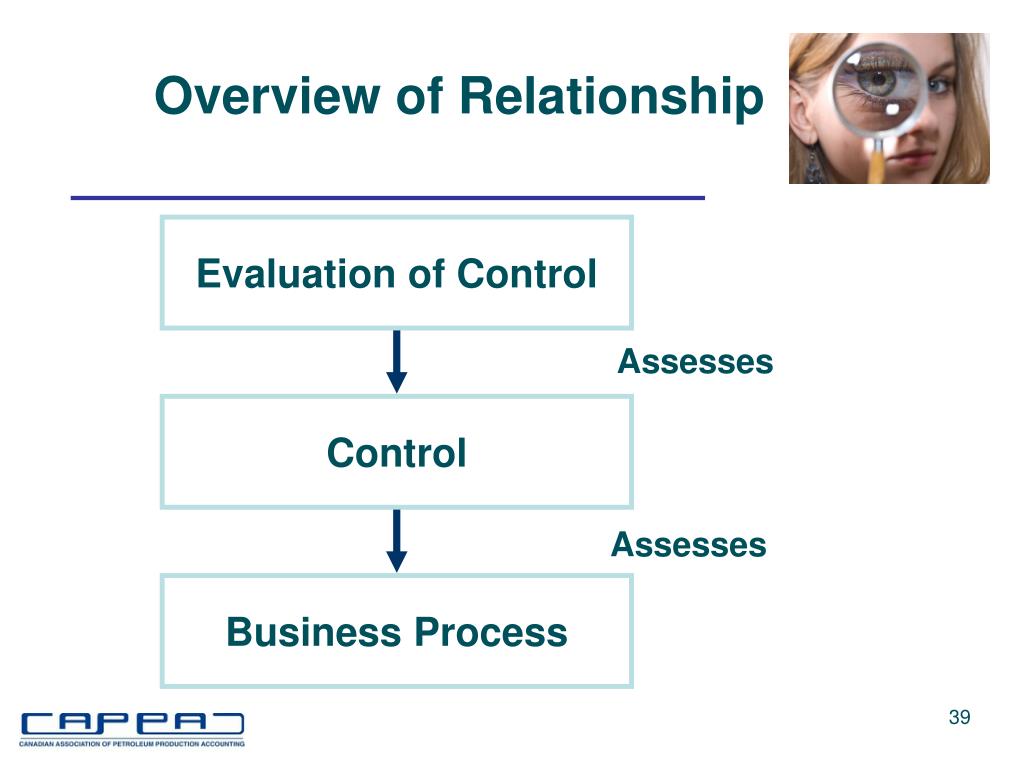

  39. Overview of Relationship Evaluation of Control Assesses Control Assesses Business Process 39

  40. Oil & Gas Example For sample of Well Tests, examine review of the log Assesses Review Well Test logs Assesses Conduct Well Tests 40

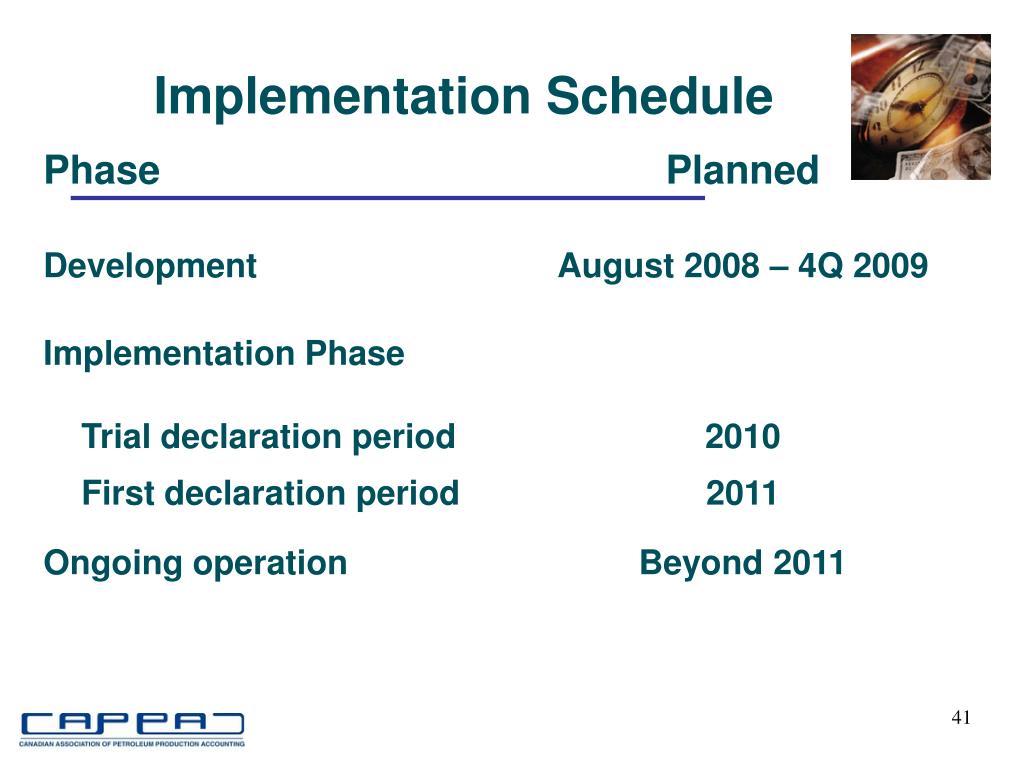

  41. Implementation Schedule 41

  42. Operator Role Operations & Production Accounting Execute business processes Execute controls Implement remediation plan Audit group Create the annual evaluation plan Evaluate & strengthen controls Develop remediation plan for findings Senior management Review / approve annual evaluation plan Review evaluation results Issue declaration 42

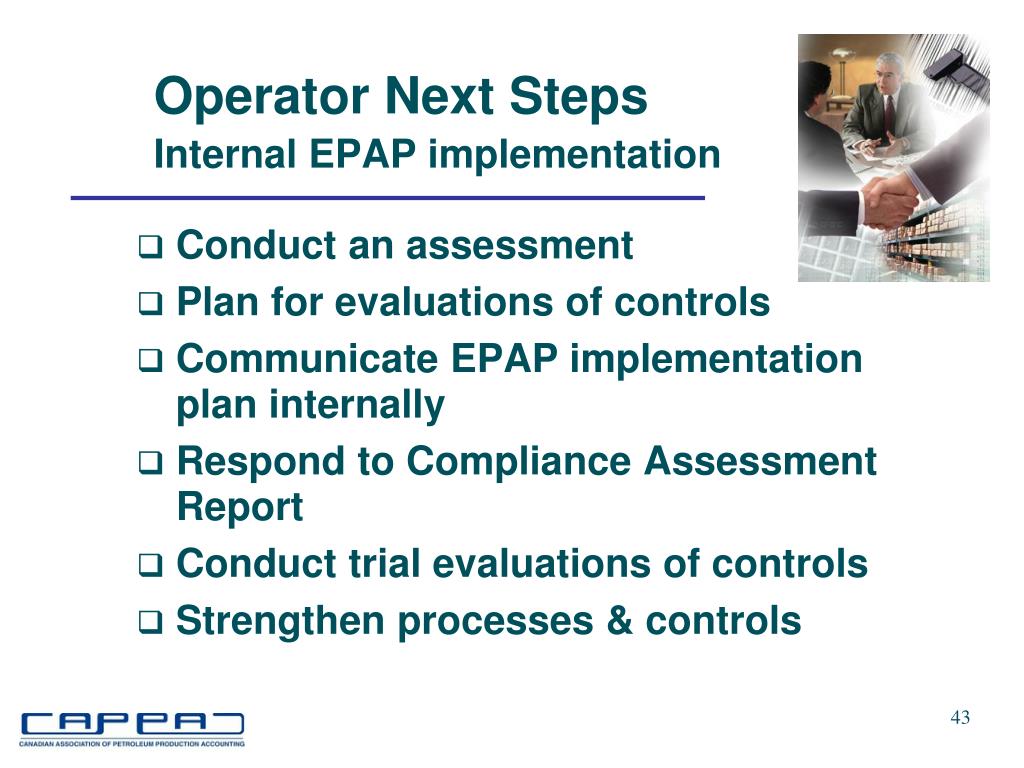

  43. Operator Next StepsInternal EPAP implementation • Conduct an assessment • Plan for evaluations of controls • Communicate EPAP implementation plan internally • Respond to Compliance Assessment Report • Conduct trial evaluations of controls • Strengthen processes & controls 43

  44. Enhanced Production Audit ProgramEPAP Actions for PA CAPPA Conference Panel Presented by: Earl Quantz 21 October 2009

  45. EPAP Actions forProduction Accountants • Embrace and build EPAP visibility • Action monthly compliance assessment report • Collaborate with field operations and measurement staff • Identify the controls on your desk and confirm are they working • Respond to evaluation of controls findings 45

  46. Annual Operator EPAP Work • Create annual evaluation plan • Conduct evaluations of controls • Remediate deficiencies • Collaborate in the compliance assessment process • Submit the annual declaration 46

  47. Discussion

  48. Extra Slides

  49. ERCB RoleProduction Audit Team • Review declarations • Perform compliance assessment process • Interact with operators on action items • Monitor execution of remediation work • Perform operator escalation process • Apply D-019 compliance enforcement 49
