Implementing a Faceted Search Framework Emily Lynema & Andrew K. Pace NC State University Libraries ASIS&T Seminar April 9, 2007
Agenda • The Context: • Problem & motivation • Local Implementation • What and How? • Challenges Encountered • Outcomes • Usage Statistics • Future Opportunities
Online Catalogs "Most integrated library systems, as they are currently configured and used, should be removed from public view." - Roy Tennant, CDL
What was the problem? • Existing catalogs are hard to use: • known item searching works pretty well, but … • users often do keyword searching on topics and get large result sets returned in system sort order • catalogs are unforgiving on spelling errors, stemming
Catalog value is buried • Subject headings are not leveraged in searching • they should be browsed or linked from, not searched • Data from the item record is not leveraged • should be able to filter by item type, location, circulation status, popularity

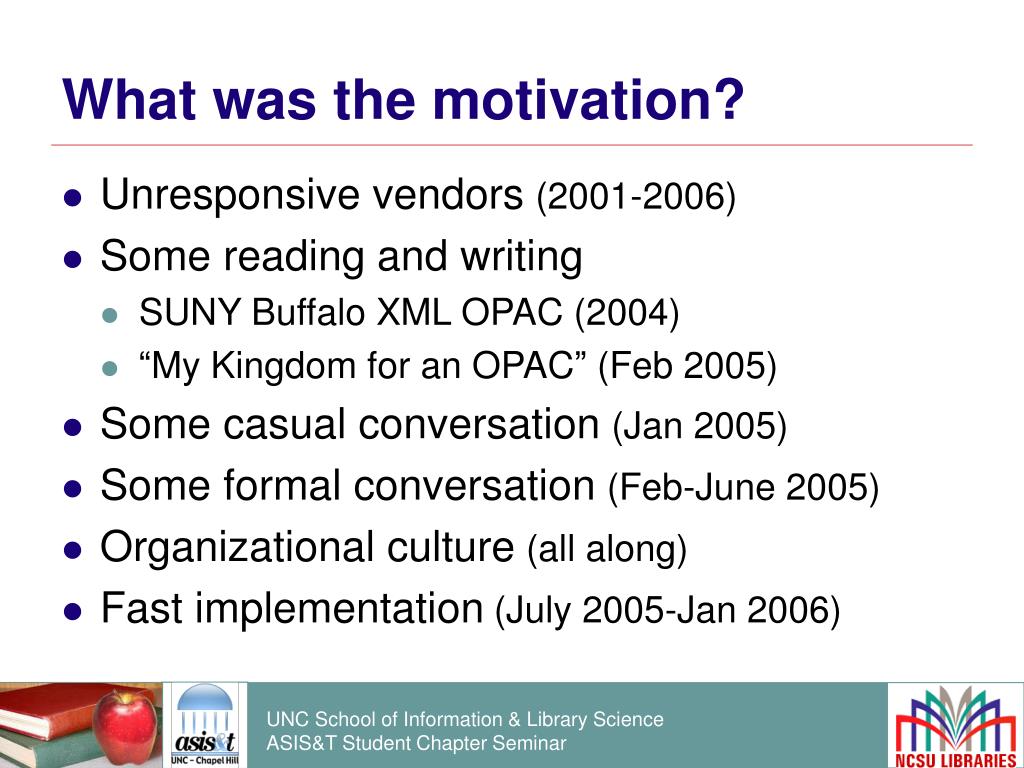

What was the motivation? • Unresponsive vendors (2001-2006) • Some reading and writing • SUNY Buffalo XML OPAC (2004) • “My Kingdom for an OPAC” (Feb 2005) • Some casual conversation (Jan 2005) • Some formal conversation (Feb-June 2005) • Organizational culture (all along) • Fast implementation (July 2005-Jan 2006)
What’s the big picture? • Improve the quality of the library catalog user experience • Exploit our existing authority infrastructure (aka make MARC data work harder) • Build a more flexible catalog tool that can be integrated with discovery tools of the future.
What is Endeca? • Software company based in Cambridge, MA • Search and information access technology provider for a number of major e-commerce websites • Developers of the Endeca Information Access Platform
Why Endeca? • Customized relevance ranking of results • Better subject access by leveraging available metadata (including item level data!) through facets • Improved response time • Enhanced natural language searching through spell correction, etc. • Browse
Relevance ranking Based on locally customizable algorithm: • Most relevant: query as entered • For multi-term searches: phrase match • Field match • title match more relevant than notes match • Other factors: • number of fields matched • weighted frequency (tf/idf) • static ordering (publication date, circulation stats)
Faceted navigation • Combine search and browse in single interface (Guided Navigation™) • Filter results across multiple facets • Remove facets in any order

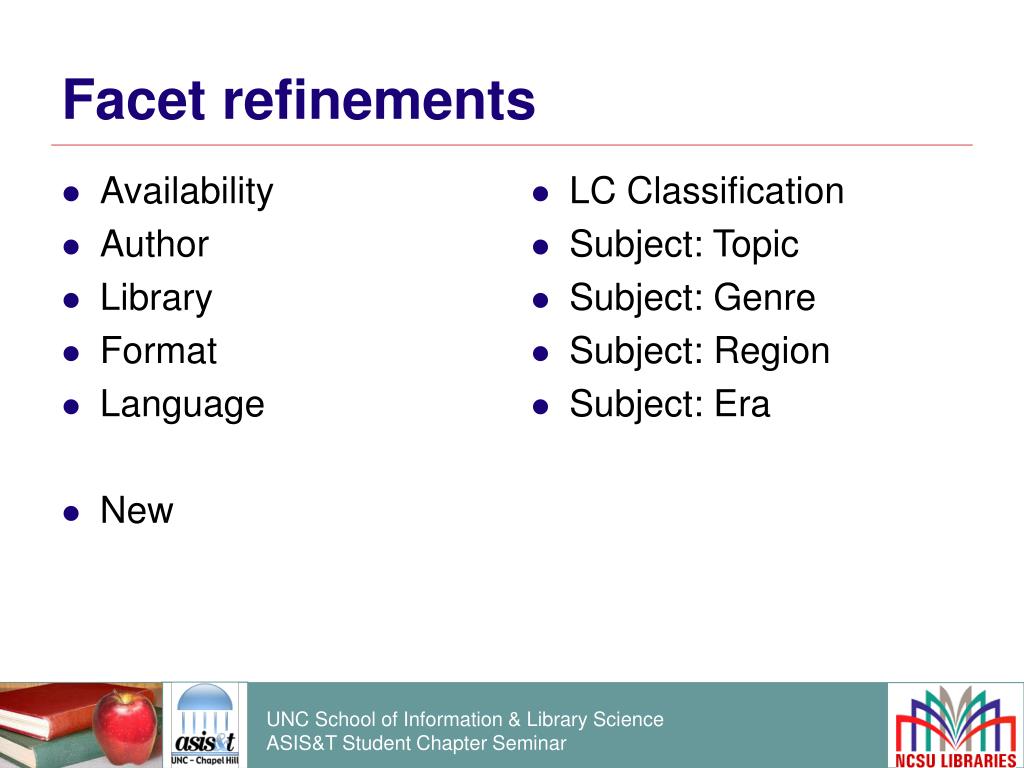

Availability Author Library Format Language New LC Classification Subject: Topic Subject: Genre Subject: Region Subject: Era Facet refinements

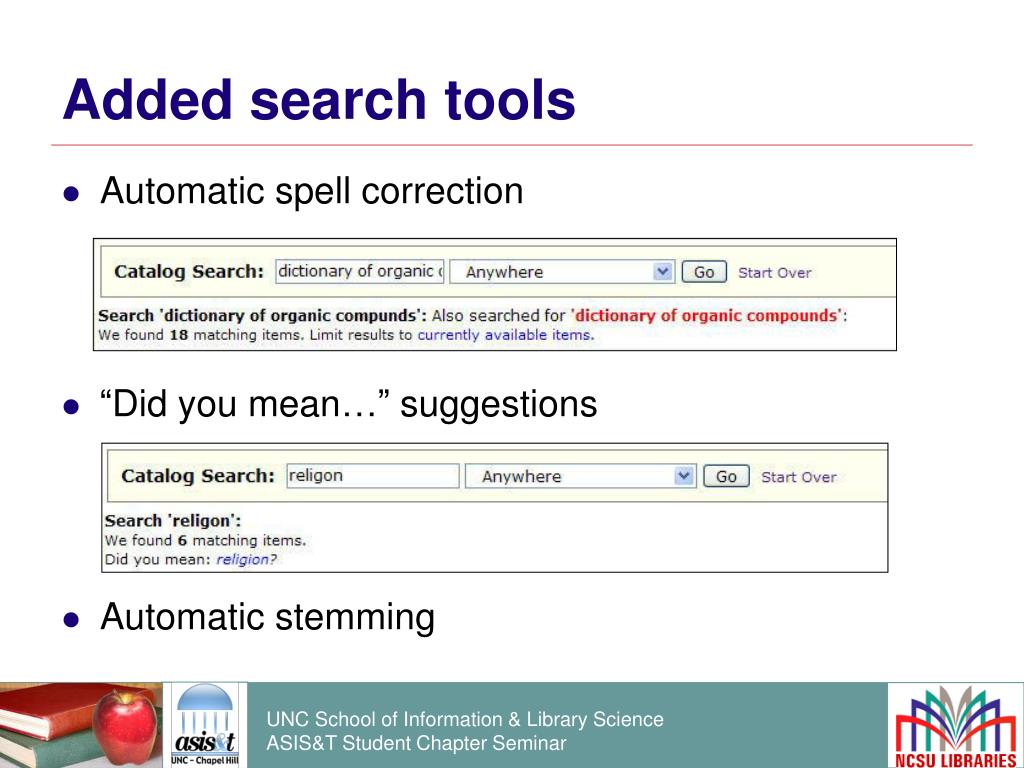

Added search tools • Automatic spell correction • “Did you mean…” suggestions • Automatic stemming
Implementation team • Information Technology • Team chair and project manager • Technical lead • ILS Librarian • Technical manager • Research and Information Services • Reference librarian • Metadata and Cataloging • Cataloging librarian • Digital Library Initiatives • Interface development

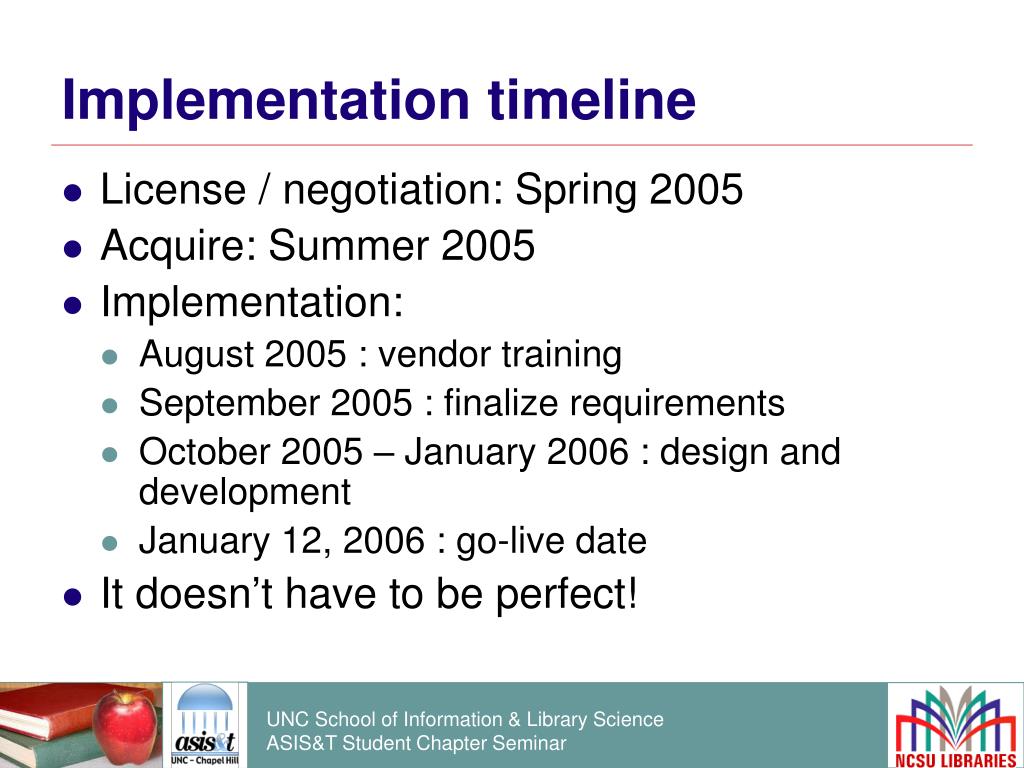

Implementation timeline • License / negotiation: Spring 2005 • Acquire: Summer 2005 • Implementation: • August 2005 : vendor training • September 2005 : finalize requirements • October 2005 – January 2006 : design and development • January 12, 2006 : go-live date • It doesn’t have to be perfect!

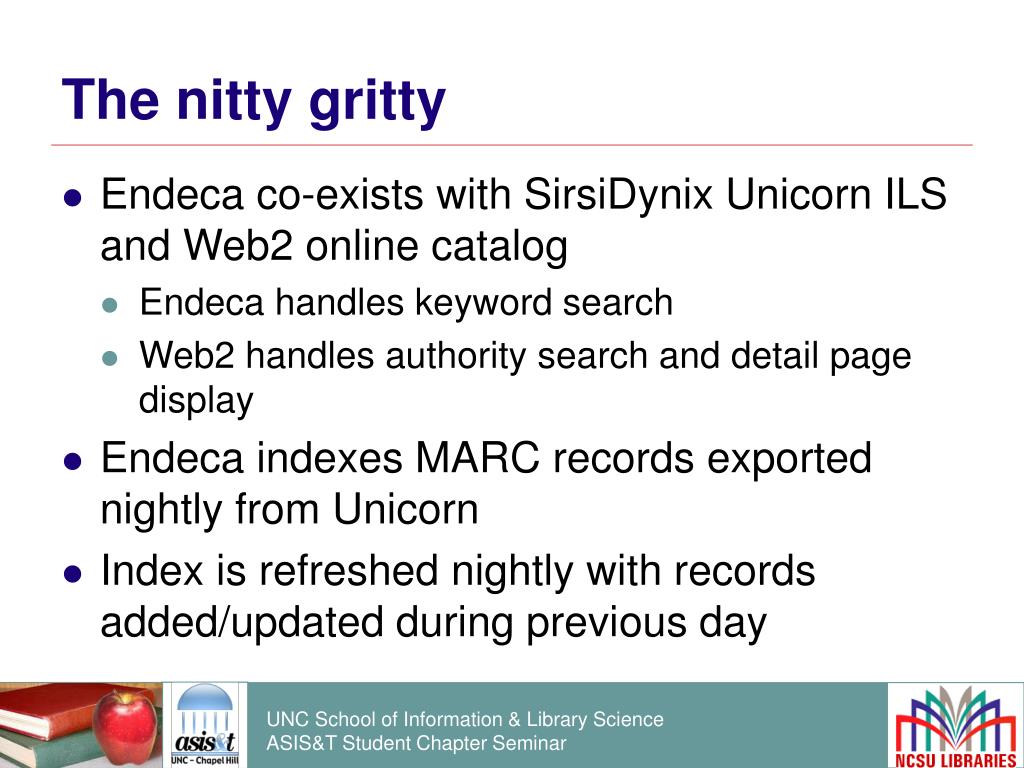

The nitty gritty • Endeca co-exists with SirsiDynix Unicorn ILS and Web2 online catalog • Endeca handles keyword search • Web2 handles authority search and detail page display • Endeca indexes MARC records exported nightly from Unicorn • Index is refreshed nightly with records added/updated during previous day

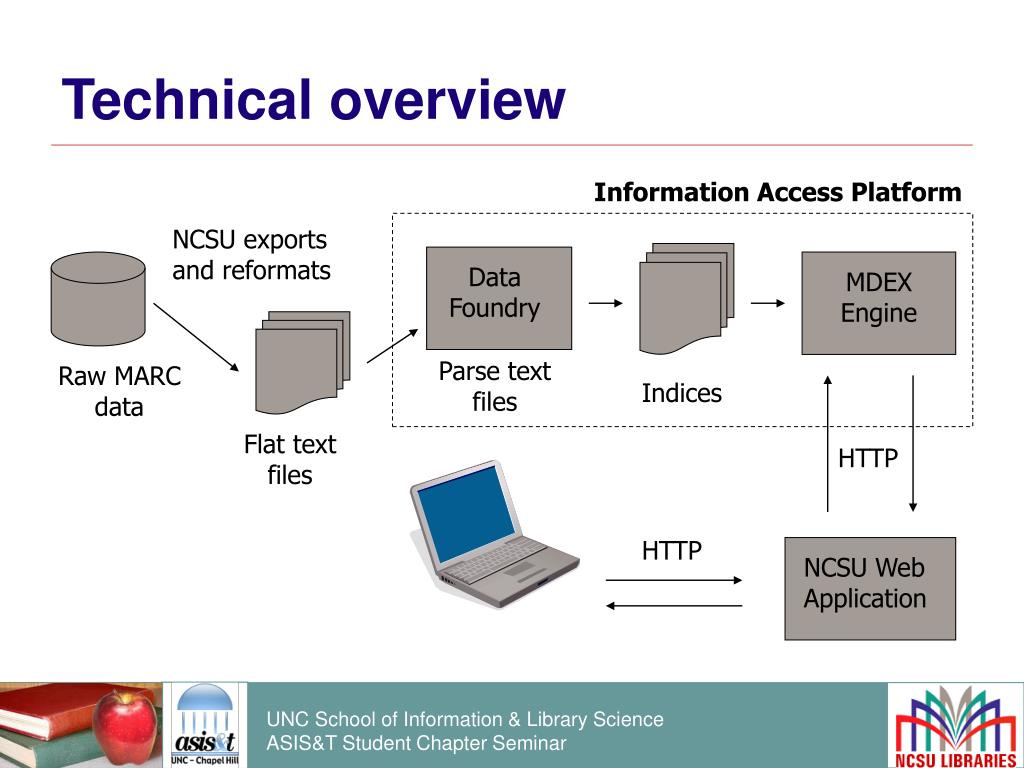

Technical overview Information Access Platform NCSU exports and reformats Data Foundry MDEX Engine Parse text files Raw MARC data Indices Flat text files HTTP HTTP NCSU Web Application
Technical overview Offline - Nightly NCSU exports and reformats Data Foundry MDEX Engine Parse text files Raw MARC data Indices Flat text files HTTP HTTP NCSU Web Application
Technical overview Always Online NCSU exports and reformats Data Foundry MDEX Engine Parse text files Raw MARC data Indices Flat text files HTTP HTTP NCSU Web Application
Challenges – System design • Identifying appropriate facets • Integrating 2 independent data systems • Unique identifiers are important! • Designing the user interface • Search page • Results page

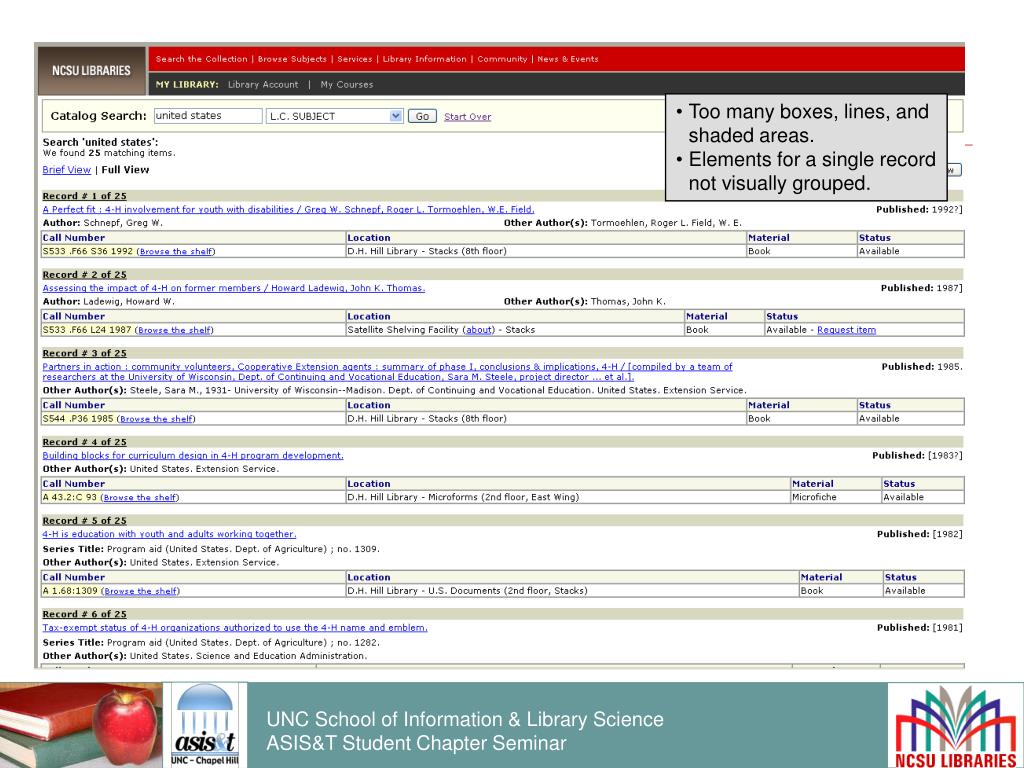

Too many boxes, lines, and shaded areas. • Elements for a single record not visually grouped.

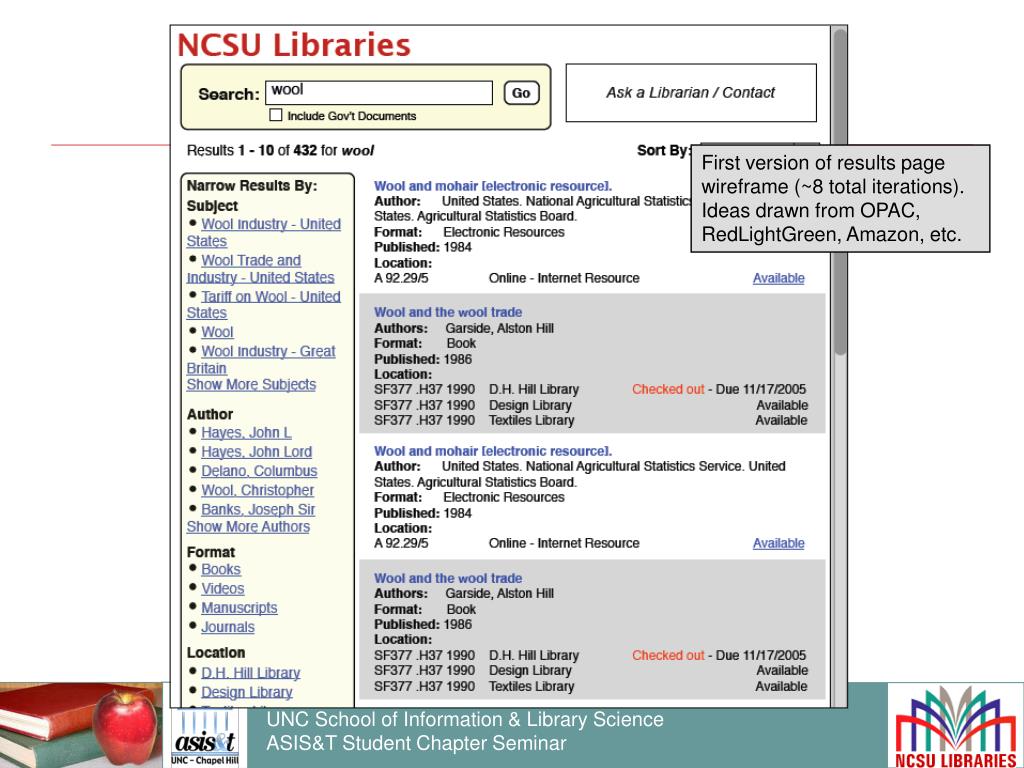

First version of results page wireframe (~8 total iterations). Ideas drawn from OPAC, RedLightGreen, Amazon, etc.

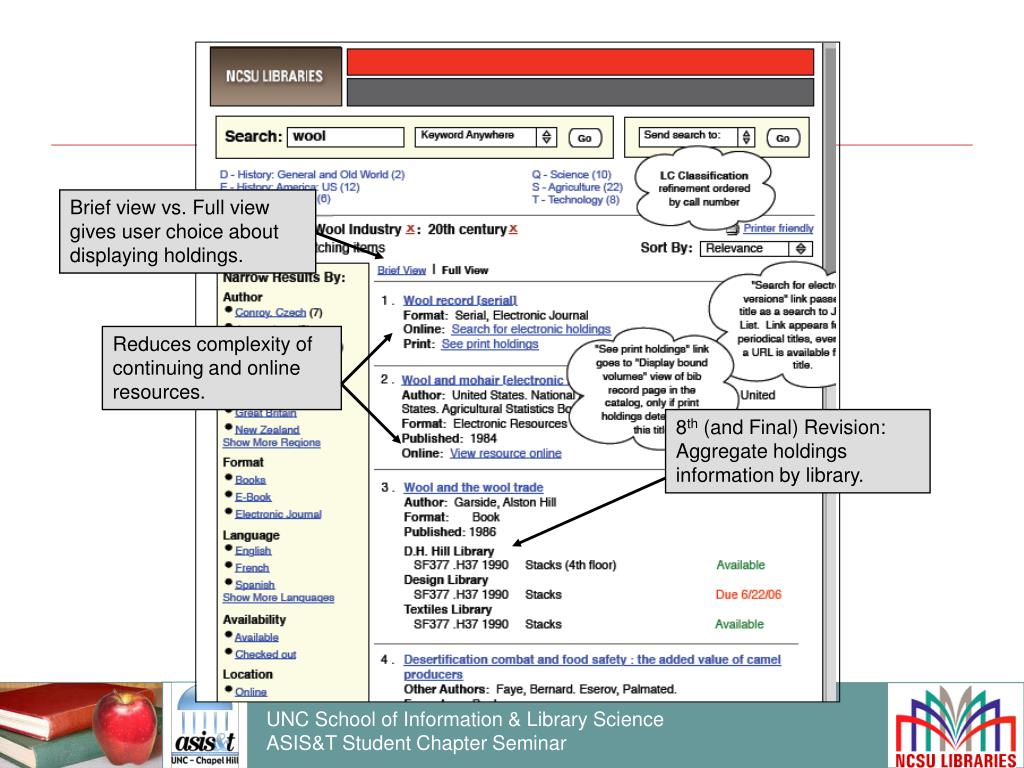

Brief view vs. Full view gives user choice about displaying holdings. Reduces complexity of continuing and online resources. 8th (and Final) Revision: Aggregate holdings information by library.
Challenges - Data • MARC data with MARC-8 encoding => Text data with UTF-8 encoding
Fun with MARC • MARC flat text file(s) for ingest by Endeca. • Transformation accomplished with MARC4J. • Opportunity to manipulate data on the back-end.
Challenges - Data • MARC data with MARC-8 encoding => Text data with UTF-8 encoding • Data issues revealed by exposing metadata in facets • Relevance ranking for bibliographic data

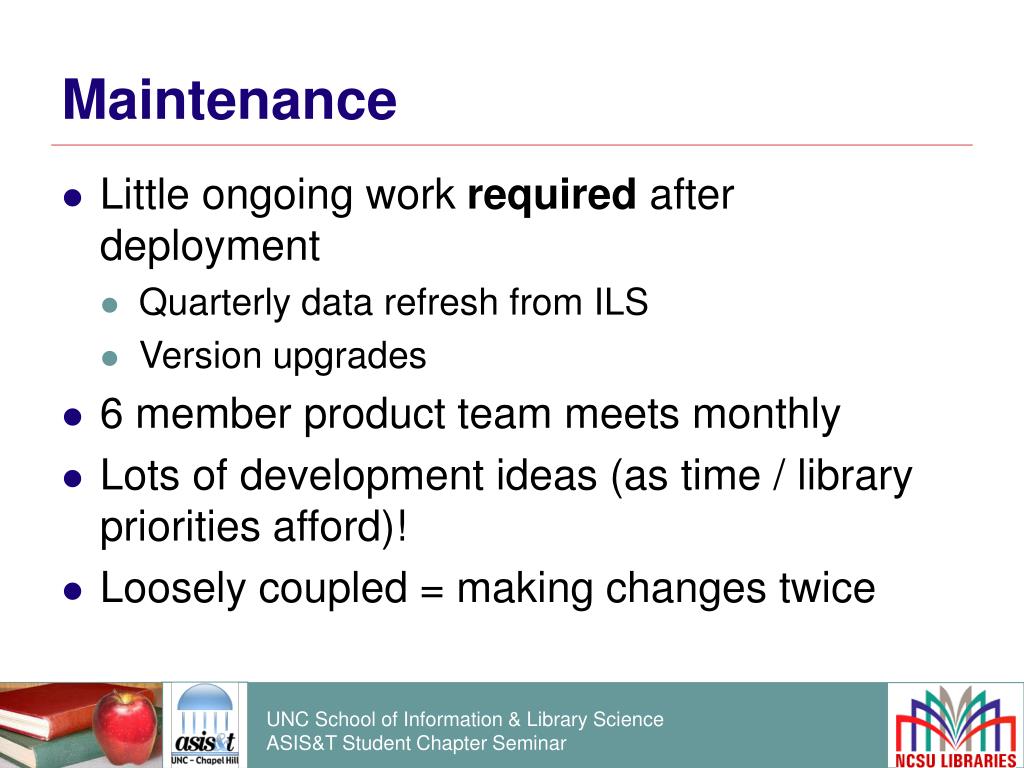

Maintenance • Little ongoing work required after deployment • Quarterly data refresh from ILS • Version upgrades • 6 member product team meets monthly • Lots of development ideas (as time / library priorities afford)! • Loosely coupled = making changes twice

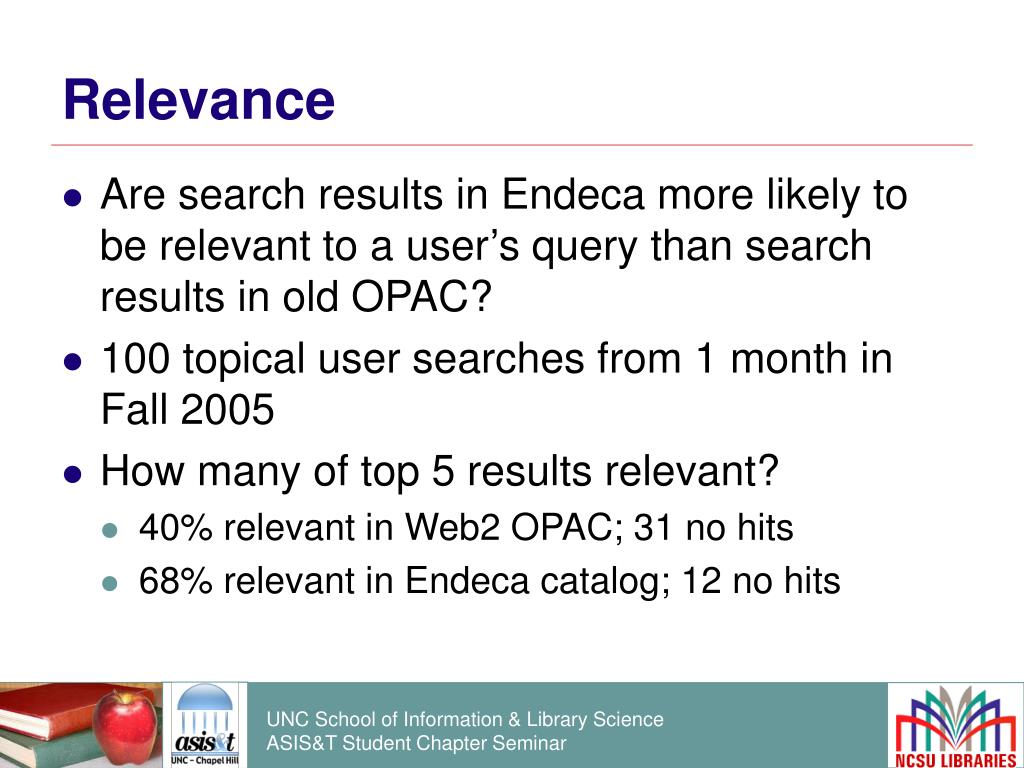

Relevance • Are search results in Endeca more likely to be relevant to a user’s query than search results in old OPAC? • 100 topical user searches from 1 month in Fall 2005 • How many of top 5 results relevant? • 40% relevant in Web2 OPAC; 31 no hits • 68% relevant in Endeca catalog; 12 no hits

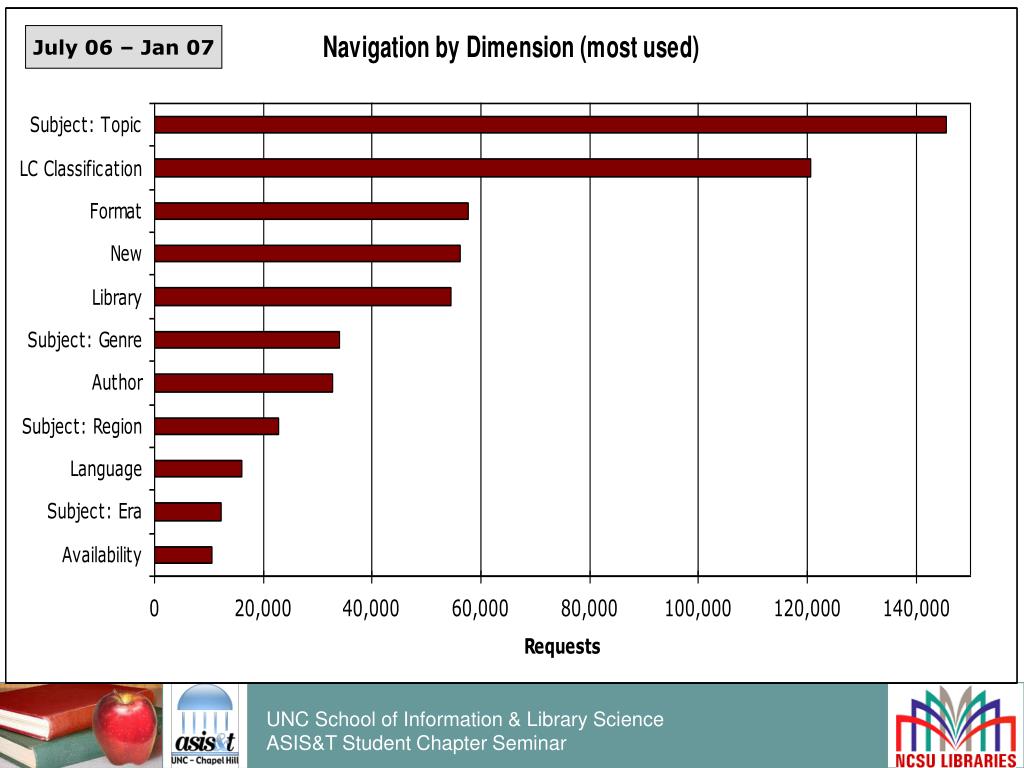

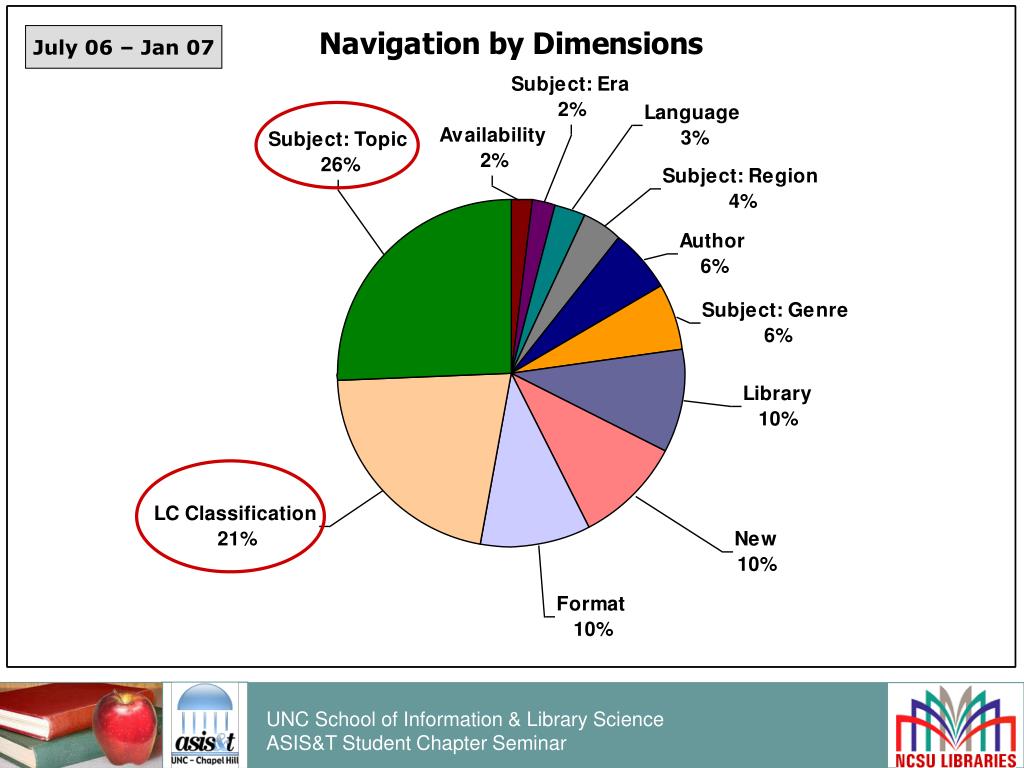

July 06 – Jan 07 19.4% Subj./Class
Future opportunities • Integrate catalog w/other tools through web services • Enrich catalog through external web services: • book jackets, reviews, etc. – Amazon/OCLC • Build cross-application shopping cart functionality

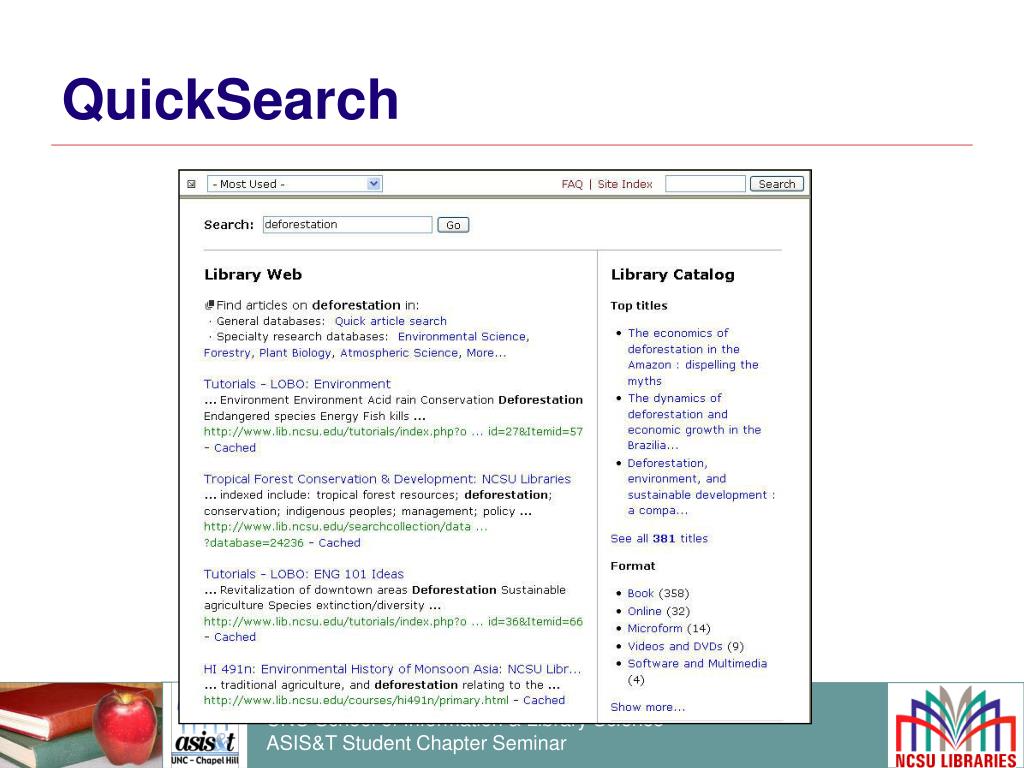

The catalog & web services • Initial impetus – 2 requests • Can we have RSS feeds for the catalog? • Can we integrate catalog results into library website QuickSearch? • Initial plan • Build RSS feeds and extend with OpenSearch for integration. • Where did we end up?
Introducing CatalogWS • “A Web API for dynamically querying information from the NCSU Libraries Catalog” • http://www.lib.ncsu.edu/catalog/ws/ • Generic XML layer provides same functionality as HTML interface • REST web API: define HTTP GET requests via URL parameters • Enables server-side user-defined XSL transformations
Why go there? • More open access to the data available in our library catalog • Core XML schema can be re-used and modified via stylesheets • Enable other developers in the library to build applications using catalog data • Reduce bottleneck (I don’t have to do everything)
Thanks • NCSU project site: • http://www.lib.ncsu.edu/endeca • Andrew K. Pace • Head, Information Technology • andrew_pace@ncsu.edu • Emily Lynema • Systems Librarian for Digital Projects • emily_lynema@ncsu.edu
