800 likes | 971 Vues
Speed and Power Trade-offs : Applied to Adder Design:. Vojin G. Oklobdzija, Ram Krishnamurthy Intel AMR / ACSEL Laboratory Intel Corp/ University of California Davis www.ece.ucdavis.edu/acsel. From: Tutorial Presentation 16 th International Symposium on Computer Arithmetic
E N D
Speed and Power Trade-offs: Applied to Adder Design: Vojin G. Oklobdzija, Ram Krishnamurthy Intel AMR / ACSEL Laboratory Intel Corp/ University of California Davis www.ece.ucdavis.edu/acsel From: Tutorial Presentation 16th International Symposium on Computer Arithmetic Santiago de Compostela, SPAIN June 18, 2003
Issues to be addressed • How do we compare different topologies for their efficiency ? • How do we estimate speed and efficiency of our algorithm ? • What criteria's should we use when developing a new algorithm ? • How does power enter into this equation ? 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Additional Issues • Determine which topology is the best for given Power or Delay budget • Determine which topology can stretch the furthest in terms of speed or power 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Previously used estimates Counting the number of gates (logic levels): not accurate 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

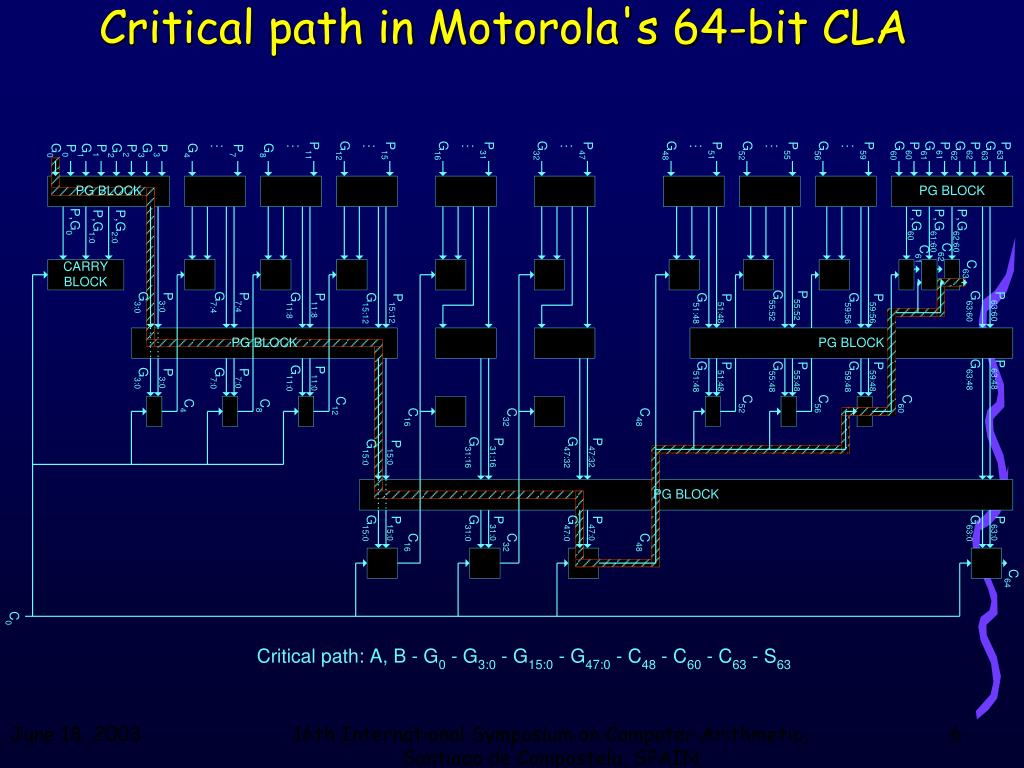

Critical path in Motorola's 64-bit CLA 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Motorola's 64-bit CLAModified PG Block Intermediate propagate signals Pi:0 are generated to speed-up C3 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Fan-In and Fan-Out Dependency(Oklobdzija, Barnes: IBM 1985) 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Delay Comparison: Variable Block Adder(Oklobdzija, Barnes: IBM 1985) Delay Complexity 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Design Objective • Design takes time: • finding results afterward is not of much value • There is a disconnect between measures used by computer arithmetic when developing an algorithm and what is obtained after implementation • we want to estimate as close to the measured results • A simple tool that can evaluate different design trade-off for a given technology is needed • Power trade-off is the most important • speed and power are tradable 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Logical Effort Theory • “Back of the Envelope” complexity: good for estimating speed • Gate delay = linear function of load • Slope: logical effort gate driving characteristics • Intersect: parasitic gate internal load • “Logical Effort” accuracy is not sufficient • We needed to extend and refine the method • However, that becomes more than “Back of the Envelope” • Logical Effort does not account for possible power-delay trade-offs 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Logical Effort Theory • Excel –a platform of choice (ARITH-16) • Simple enough • Can provide computation quickly • Easy to enter a given design • Technology characterization is needed: • This needs to be done only once: available for every design afterwards • Domino gate = 2 stages of dynamic and static • Different driving characteristics of these stages • Multi-output gate (carry-look-ahead, Ling/conditional sum) • Energy model needs to be included 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Energy Motivation *courtesy of Intel Corp. Cache Processor thermal map Temp (oC) Execution core AGU 120oC AGUs: performance and peak-current limiters High activity thermal hotspot Goal: high-performance energy-efficient design 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Critical Paths of Representative 64-bit Adders 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

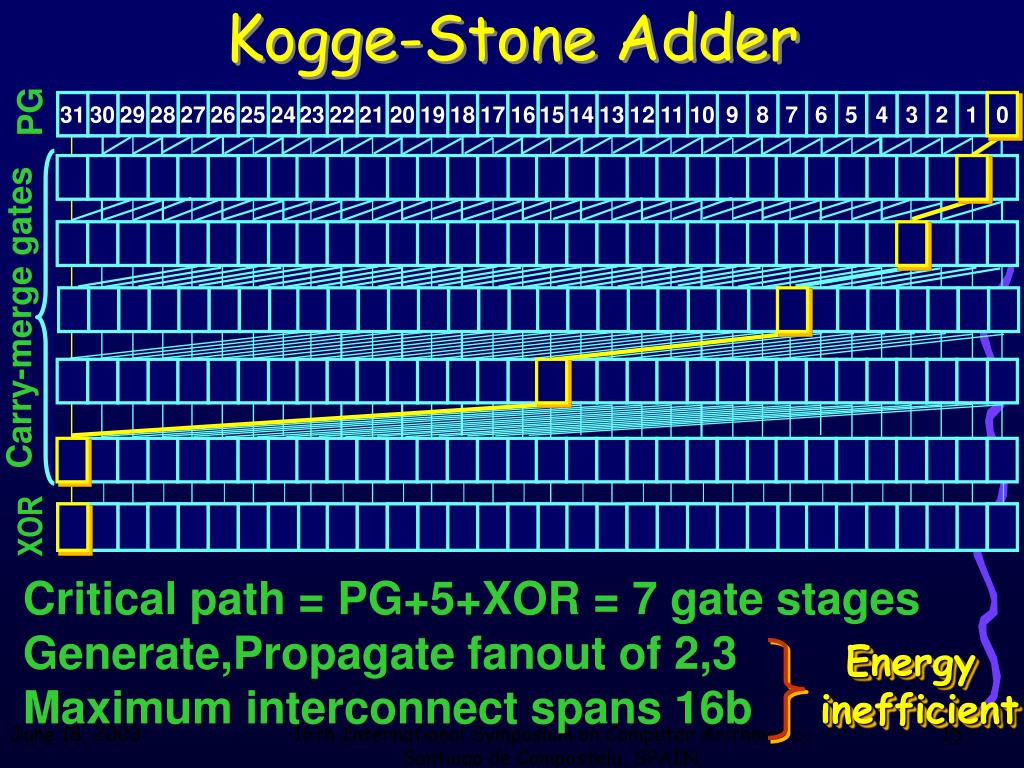

Kogge-Stone Adder PG 31 30 29 28 27 26 25 24 23 22 21 20 19 18 17 16 15 14 13 12 11 10 9 8 7 6 5 4 3 2 1 0 Carry-merge gates XOR Critical path = PG+5+XOR = 7 gate stages Generate,Propagate fanout of 2,3 Maximum interconnect spans 16b Energy inefficient 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Sparse-tree Adder Architecture Generate every 4th carry in parallel Side-path: 4-bit conditional sum generator 73% fewer carry-merge gatesenergy-efficient 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Kogge-Stone adder (8-stage) D = 8*(GBH)1/8*2.2 + 3.8*P 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

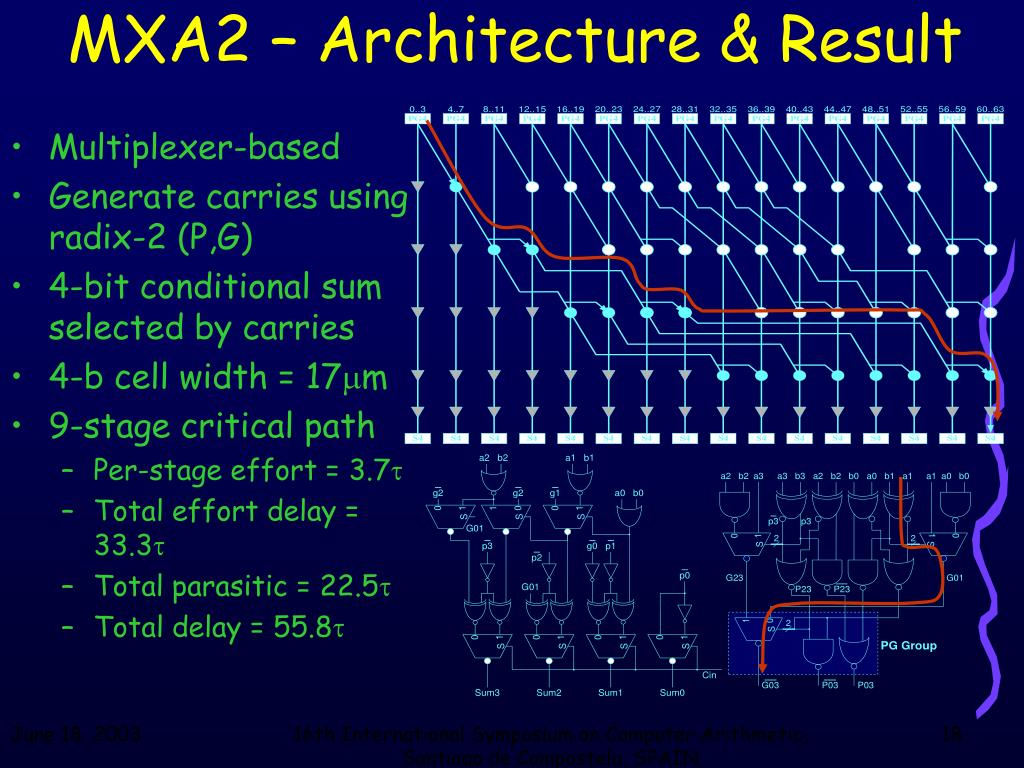

MXA2 – Architecture & Result • Multiplexer-based • Generate carries using radix-2 (P,G) • 4-bit conditional sum selected by carries • 4-b cell width = 17m • 9-stage critical path • Per-stage effort = 3.7 • Total effort delay = 33.3 • Total parasitic = 22.5 • Total delay = 55.8 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
HC2 – Architecture • Generate even carries using radix-2 (P,G) • Generate odd carries from even carries • CMOS adder for sum • 1-b cell width 4m • 10-stage critical path 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
HC2 – Circuits & Results 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

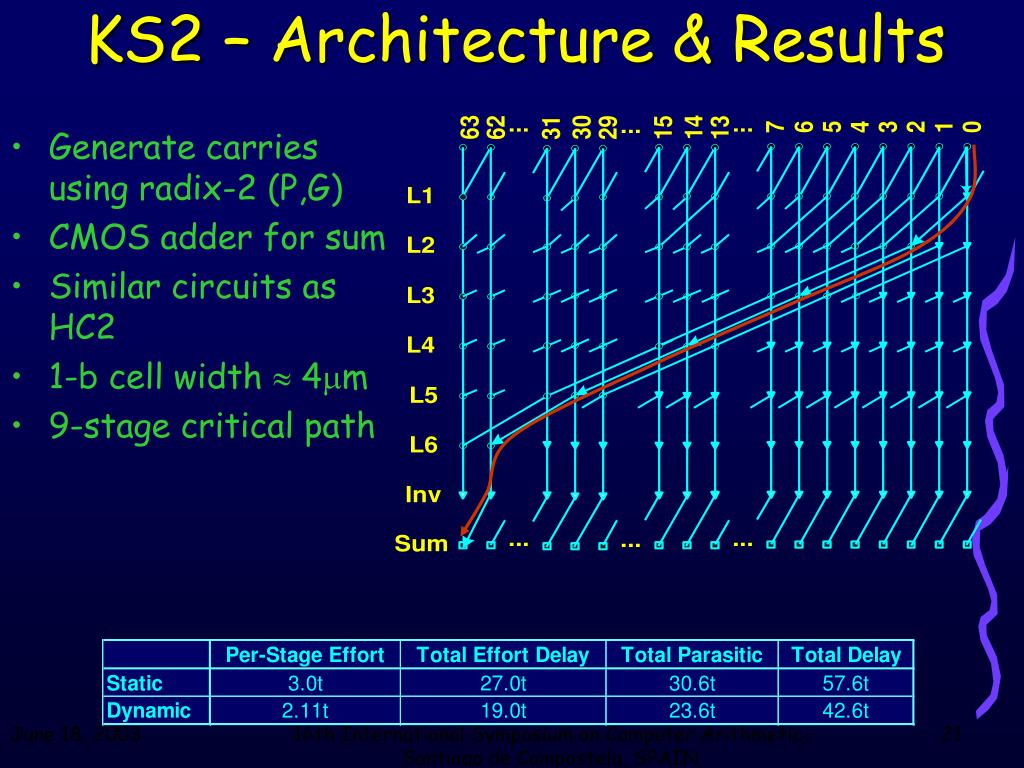

KS2 – Architecture & Results • Generate carries using radix-2 (P,G) • CMOS adder for sum • Similar circuits as HC2 • 1-b cell width 4m • 9-stage critical path 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
KS4 – Architecture • Generate carries using redundant radix-4 (P,G) • Dynamic circuit • 1-b cell width 4m • 6-stage critical path 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

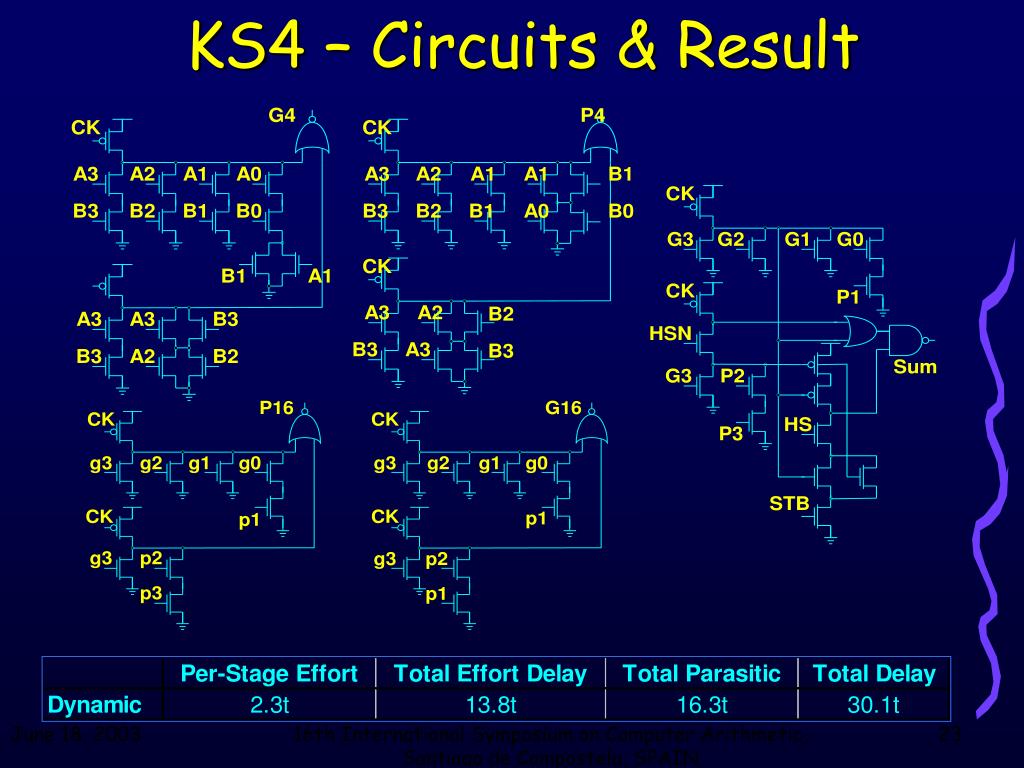

KS4 – Circuits & Result 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

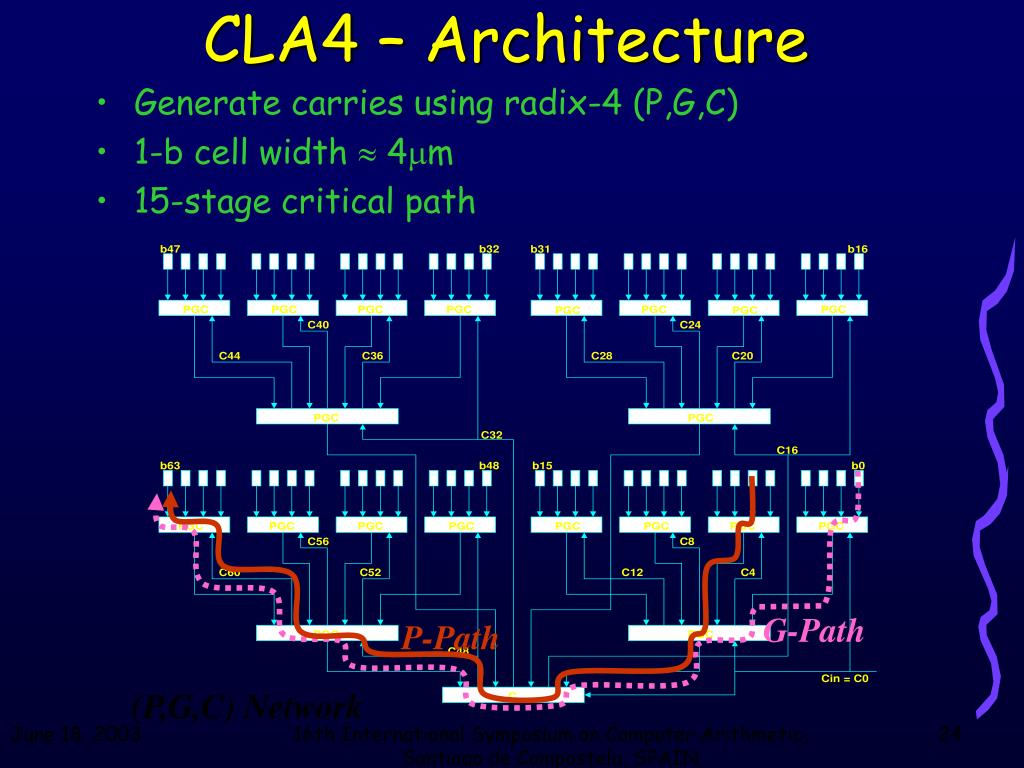

P-Path G-Path (P,G,C) Network CLA4 – Architecture • Generate carries using radix-4 (P,G,C) • 1-b cell width 4m • 15-stage critical path 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

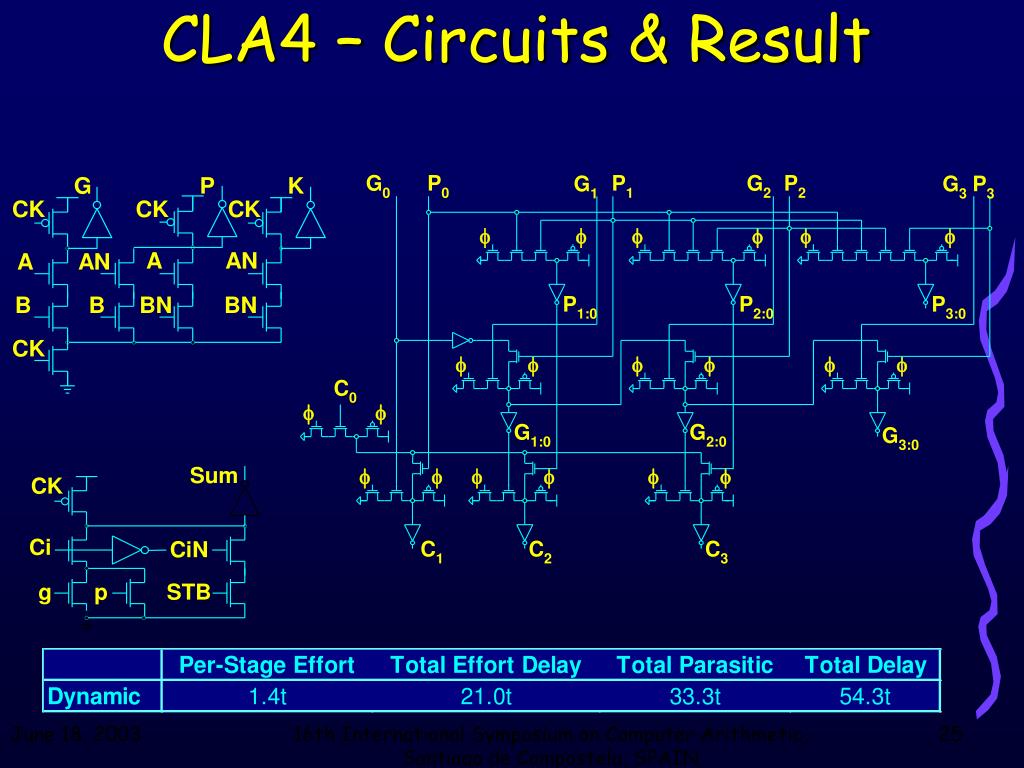

CLA4 – Circuits & Result 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
LNG4 – Architecture • Generate carries using Ling pseudo-carries • Conditional sums selected by local & long carries • 1-b cell width 5.1m; 9-stage critical path 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

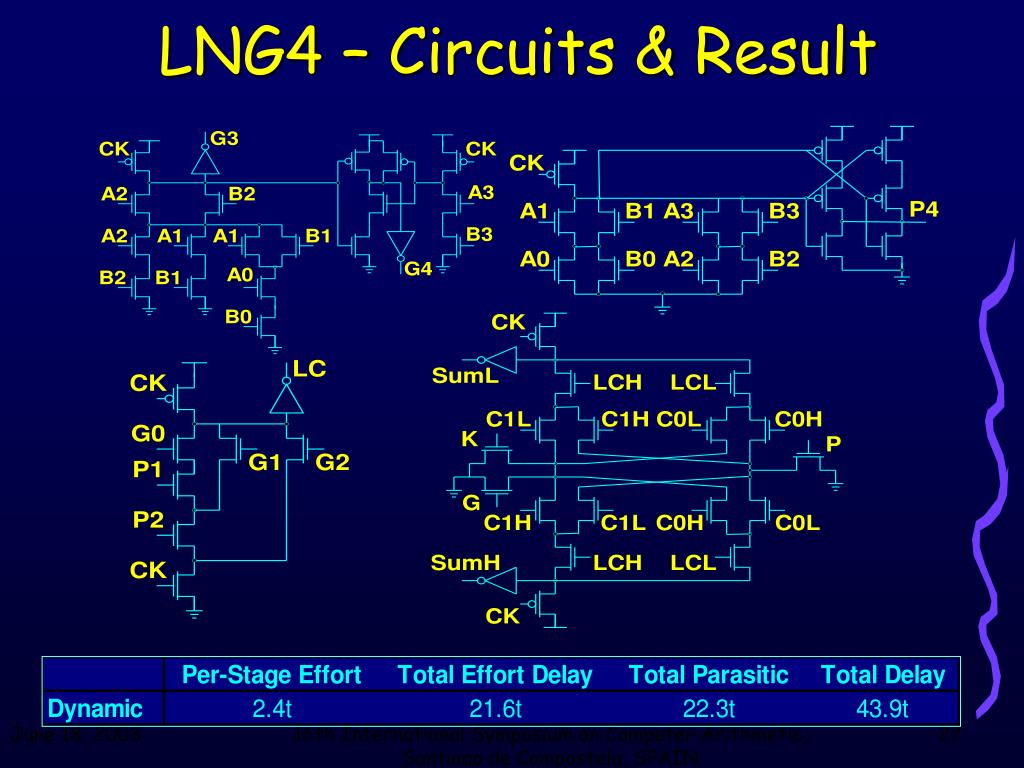

LNG4 – Circuits & Result 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Results from Simulation • Fairly consistent with logical effort analysis • Per-stage delay • 1.4 FO4 (static) • 0.8 FO4 (dynamic) 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Delay of Representative 64-b Adders 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

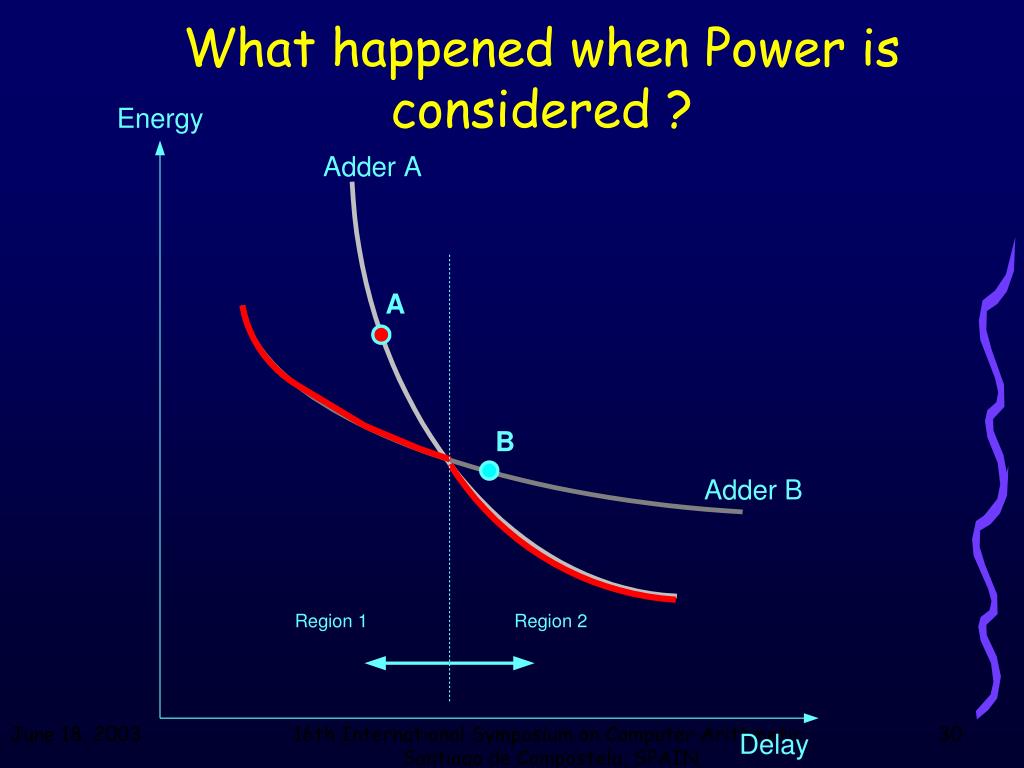

What happened when Power is considered ? 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
What happened when Power is considered ? • Must look at Energy-Delay Space of designs 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Energy-Delay Space Energy speed barrier Different Adders Emin power limit Dmin Delay 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Logical Effort in Energy-Delay Space Most design approaches focus here • It is possible to lower energy by trading delay? or … 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Logical Effort 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Delay in a Logic Gate • Delay of a logic gate has two components • d = f + p • Logical effort describes relative ability of gate topology to • deliver current (defined to be 1 for an inverter) • Electrical effort is the ratio of output to input capacitance parasitic delay effort delay, stage effort electrical effort is also called “fanout” f = gh electrical effort = Cout/Cin logical effort *from Mathew Sanu / D. Harris 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

Logical Effort Parameters: Inverter Delay g=2.2 (logic effort) d=gh+p p=3.8ps (parasitic delay) Fanout: h =Cin/Cout • d = gh + p • Delay increases linearly with fanout • More complex gates have greater g and p *from Mathew Sanu / D. Harris 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Normalized Logical Effort: Inverter *from Mathew Sanu / D. Harris 6 5 g = p = d = 1 4 inverter 1 Normalized delay: d 3 gh + p = h+1 effort delay 2 1 parasitic delay 1 2 3 4 5 Fanout: h = Cout/Cin • Define delay of unloaded inverter = 1 • Define logical effort ‘g’ of inverter = 1 • Delay of complex gates can be defined w.r.t d=1 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

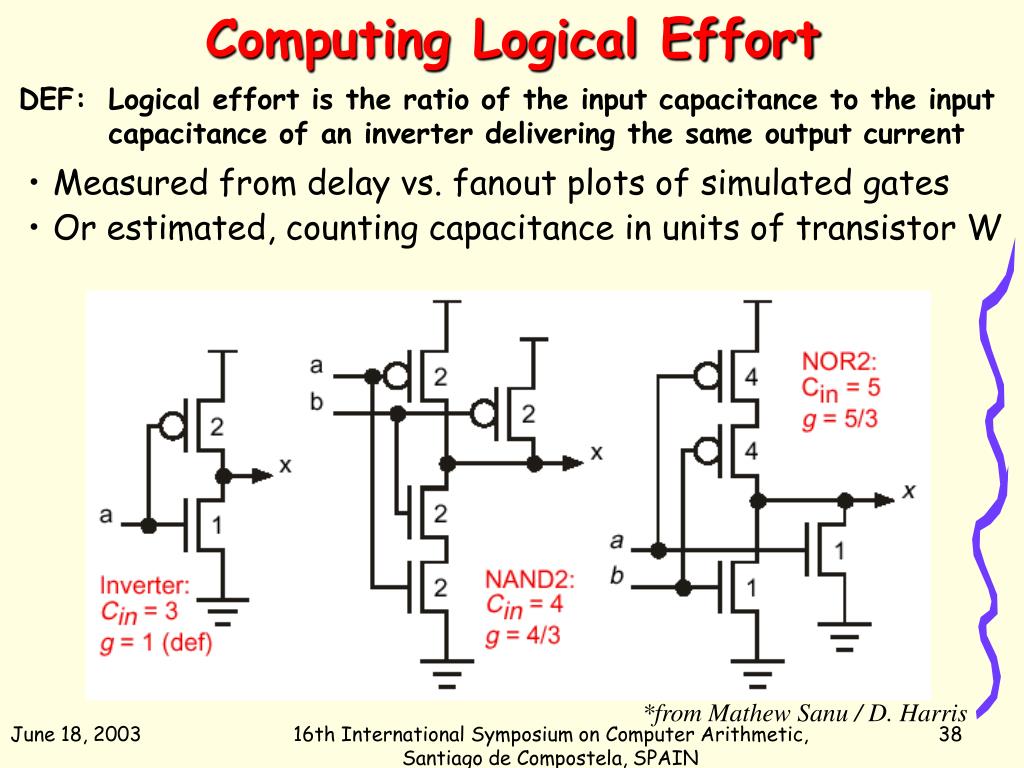

Computing Logical Effort DEF: Logical effort is the ratio of the input capacitance to the input capacitance of an inverter delivering the same output current • Measured from delay vs. fanout plots of simulated gates • Or estimated, counting capacitance in units of transistor W *from Mathew Sanu / D. Harris 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

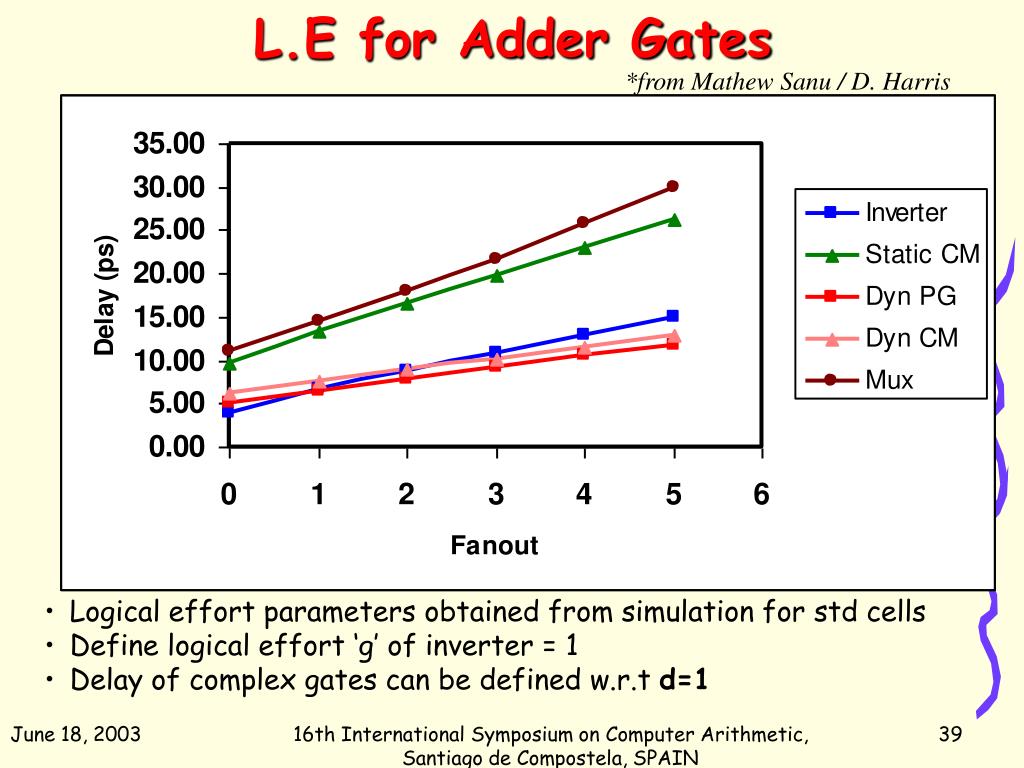

L.E for Adder Gates *from Mathew Sanu / D. Harris • Logical effort parameters obtained from simulation for std cells • Define logical effort ‘g’ of inverter = 1 • Delay of complex gates can be defined w.r.t d=1 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Normalized L.E • Logical effort & parasitic delay normalized to that of inverter *from Mathew Sanu 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

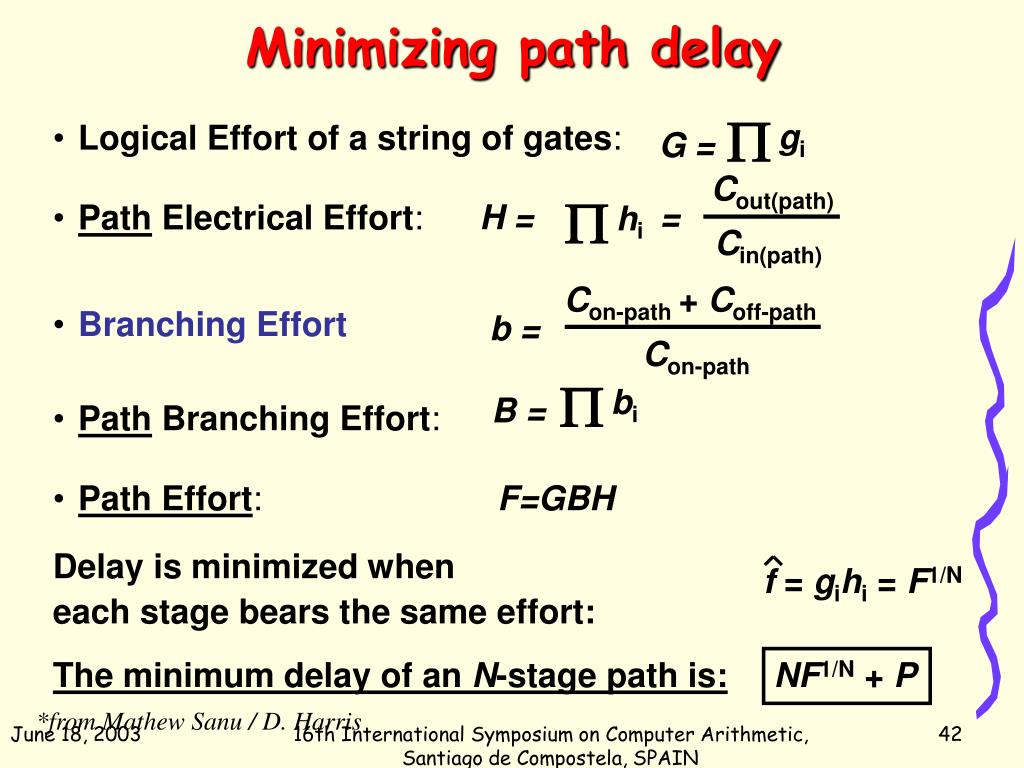

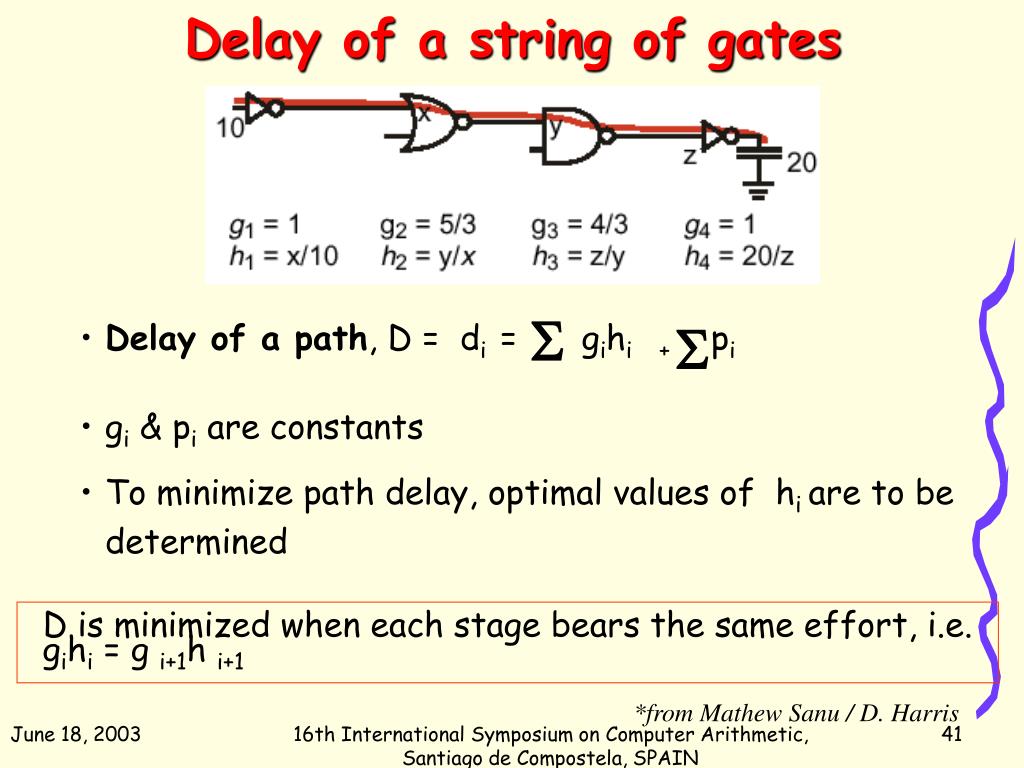

Delay of a string of gates S S • Delay of a path, D = di = gihi + pi • gi & pi are constants • To minimize path delay, optimal values of hi are to be determined D is minimized when each stage bears the same effort, i.e. gihi = g i+1h i+1 *from Mathew Sanu / D. Harris 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
bi B = f = gihi = F1/N Con-path + Coff-path b = Con-path Minimizing path delay gi G = • Logical Effort of a string of gates: • Path Electrical Effort: • Branching Effort • Path Branching Effort: • Path Effort: F=GBH Cout(path) = H = hi Cin(path) Delay is minimized when each stage bears the same effort: The minimum delay of an N-stage path is: NF1/N + P *from Mathew Sanu / D. Harris 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Inclusion of Wire Delayinto Logical Effort 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Wiring Load • Wiring in hand analysis • Only lumped capacitance included • Wiring in HSPICE • Short wire: 1-segment -model RC network • Long wire: 4-segment -model RC network • Using worst-case wire capacitance • Wire length • Estimated from most critical 1-bit pitch 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Modeling interconnect cap. • Include interconnect cap in branching factor Coff-path Coff-path PG CM0 PG CM0 Adder bitpitch Adder bitpitch Cint CM0 CM0 Con-path Con-path Con-path + Coff-path+Cint Con-path + Coff-path Cint = 2+ b = = 2 b = Con-path Con-path Con-path = 2 + I I : % int. cap to gate cap in 1 adder bitpitch 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Branching g0 g1 g2 g3 Logical Effort assumes the “branching” factor of this circuit to be 2. This is incorrect and can create inaccuracies 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

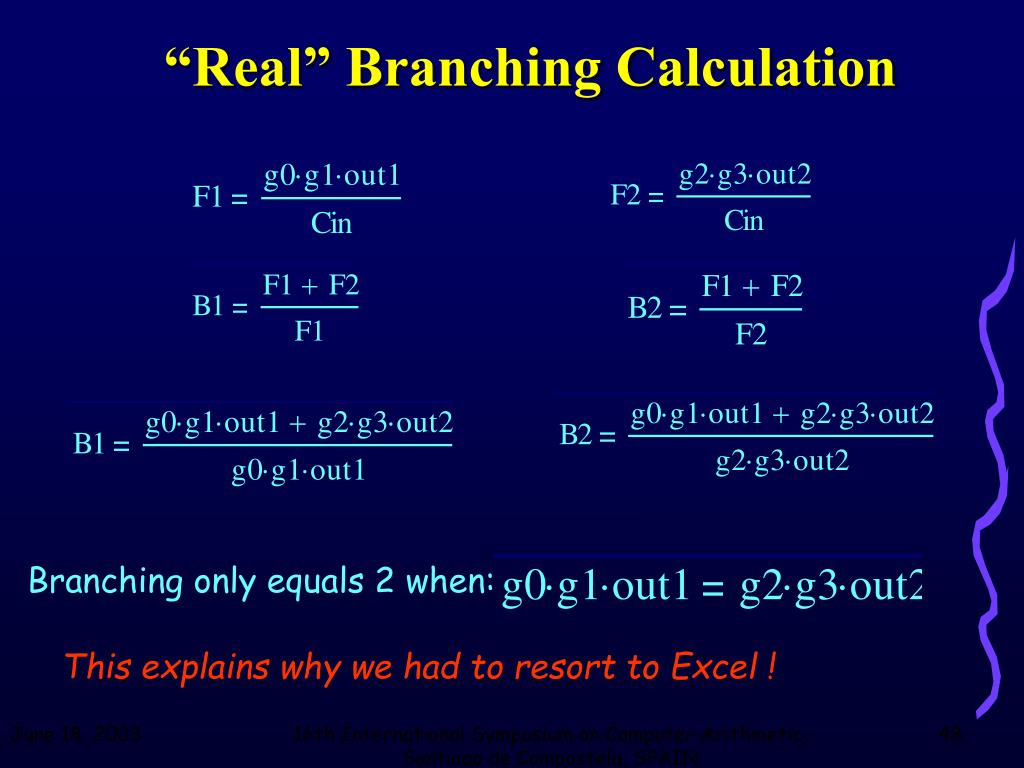

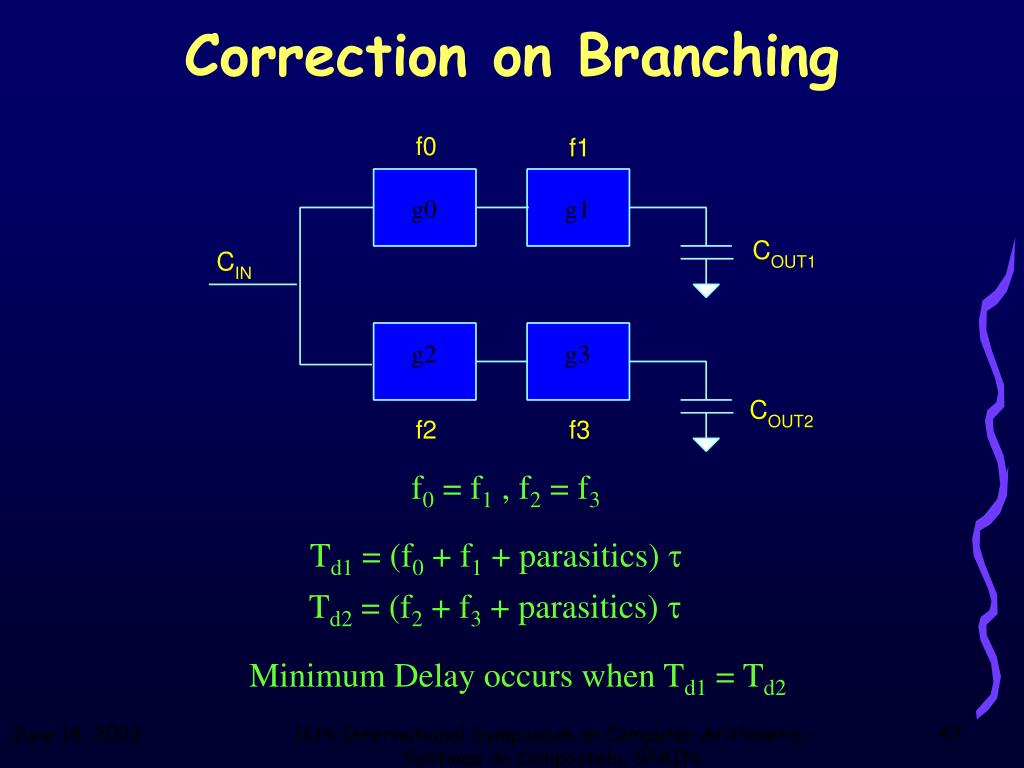

Correction on Branching g0 g1 g2 g3 f0 = f1 , f2 = f3 Td1 = (f0 + f1 + parasitics) Td2 = (f2 + f3 + parasitics) Minimum Delay occurs when Td1 = Td2 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
“Real” Branching Calculation Branching only equals 2 when: This explains why we had to resort to Excel ! 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN

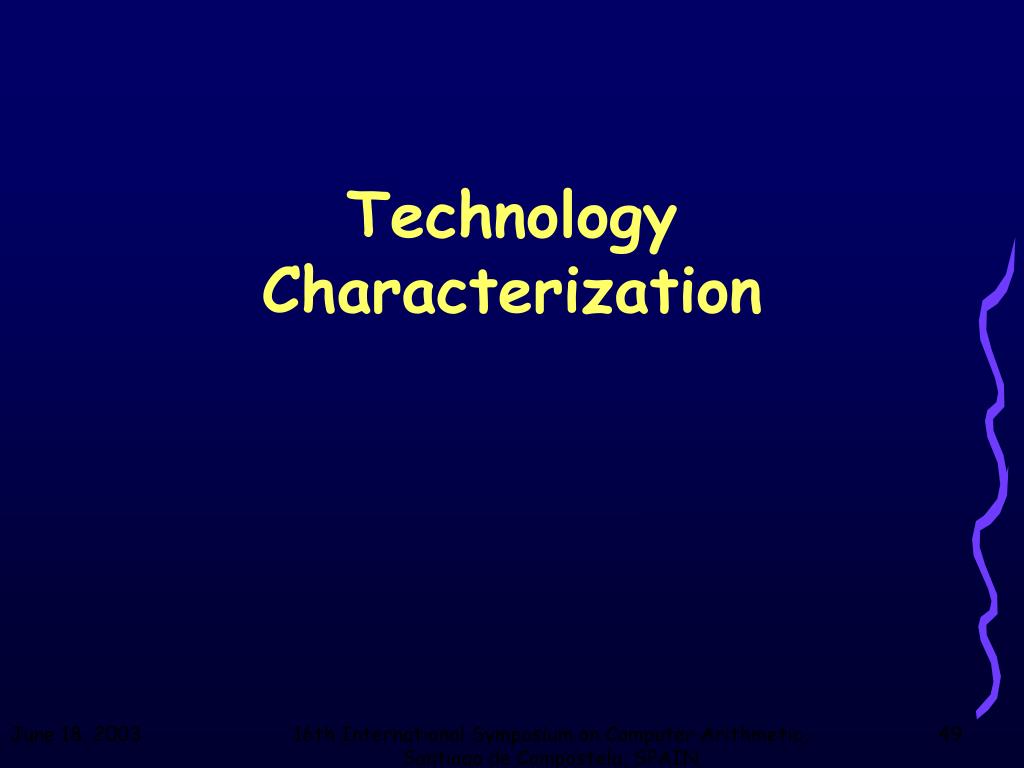

Technology Characterization 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
Characterization Setup • Logical Effort Requirements: • Equalize input and output transitions. • Logical Effort is characterized by varying the h (Cout/Cin) of a gate. By using a variable load of inverters each gate can be characterized over the same range of loads. • The Logical Effort of each gate is characterized for each input. • Energy is characterized for each output transition of the gate caused by each input transition. i.e. for an inverter: energy is measured for tLH and tHL 16th International Symposium on Computer Arithmetic, Santiago de Compostela, SPAIN
