1 / 6

ICE-T Project Schedule

ICE-T Project Schedule. 1 April 2011 – NSF Decision Deadline* 1 April 2011 – Documentation Due at RAF (rack layouts, power, data) 1 May 2011 – Start of Payload Upload 25 May 2011 – Seatainers depart for St Croix 13 – 17 June 2011 – Pre-project calibrations

Télécharger la présentation

ICE-T Project Schedule

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

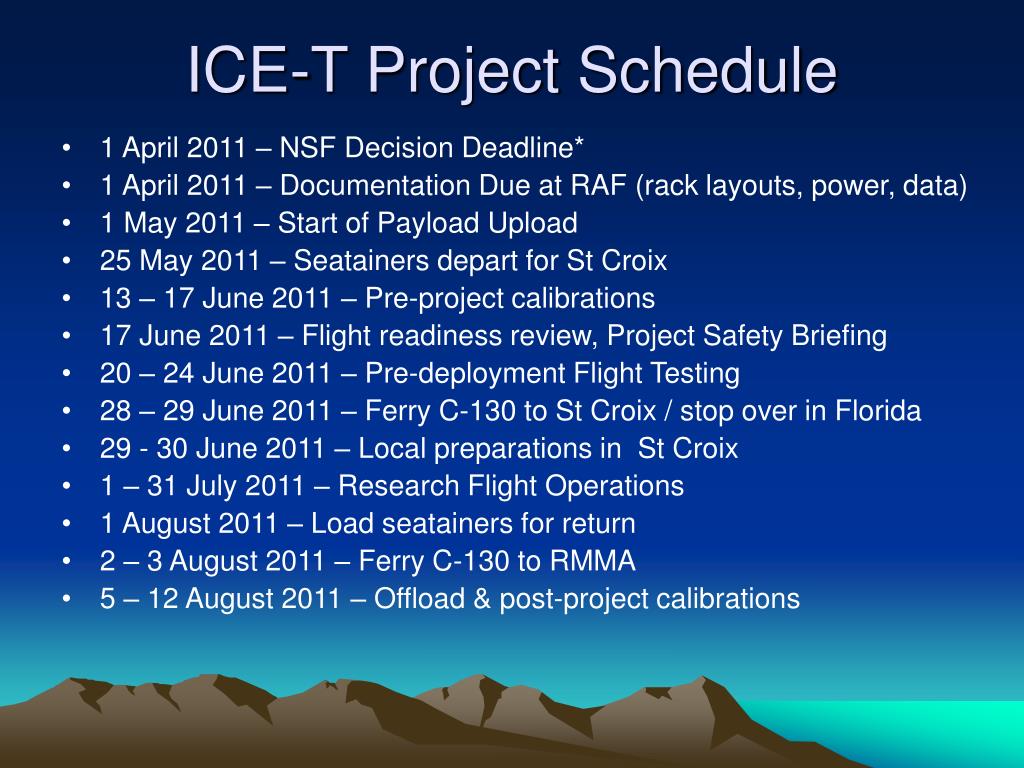

  1. ICE-T Project Schedule • 1 April 2011 – NSF Decision Deadline* • 1 April 2011 – Documentation Due at RAF (rack layouts, power, data) • 1 May 2011 – Start of Payload Upload • 25 May 2011 – Seatainers depart for St Croix • 13 – 17 June 2011 – Pre-project calibrations • 17 June 2011 – Flight readiness review, Project Safety Briefing • 20 – 24 June 2011 – Pre-deployment Flight Testing • 28 – 29 June 2011 – Ferry C-130 to St Croix / stop over in Florida • 29 - 30 June 2011 – Local preparations in St Croix • 1 – 31 July 2011 – Research Flight Operations • 1 August 2011 – Load seatainers for return • 2 – 3 August 2011 – Ferry C-130 to RMMA • 5 – 12 August 2011 – Offload & post-project calibrations

  2. Documentation – 1 April 2011 • Rack Layouts (position & weights) • Power Requirements • AEROS Display Needs • Data Channels for NIDAS • Data Feeds (ascii, ARINC, etc) • Cylinders

  3. Upload Schedule • Prather* - front position / full rack • CVI • deMott • Anderson • DMT- pending • WCR / WCL* - prior commitments • Clarkson* - inlet plumbing • Hudson* - new position issues • SPEC: 3V-CPI assistance

  4. RMMA Access • Supervised access to hangar & aircraft • After hours access by special arrangement • No weekend access planned • Access cards upon request

  5. Ferry Legs – 10 total • 2 Pilots • 1 Flight Engineer • 1 Mechanic • 1 Technician • 1 Software Engineer • 1 CVI – Darin Toohey • Who • Who • Who

  6. Crew Duty Limits • Any 24 hour period 10 flight hours • Any consecutive 7 days 40 flight hours • Any 30 day period (per crew member 110 flight hours • Consecutive working days 6 days • Max daily crew duty 14 hours • Max number of consecutive days with > 10 hr duty 2 days • Minimum crew rest between duty day cycles 12 hours • Day-to-night duty cycle swap interval 36 hours

More Related
