ICE-T Project Schedule

DESCRIPTION

ICE-T Project Schedule. 1 April 2011 – NSF Decision Deadline* 1 April 2011 – Documentation Due at RAF (rack layouts, power, data) 1 May 2011 – Start of Payload Upload 25 May 2011 – Seatainers depart for St Croix 13 – 17 June 2011 – Pre-project calibrations

1 / 2

Télécharger la présentation

ICE-T Project Schedule

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

Playing audio...

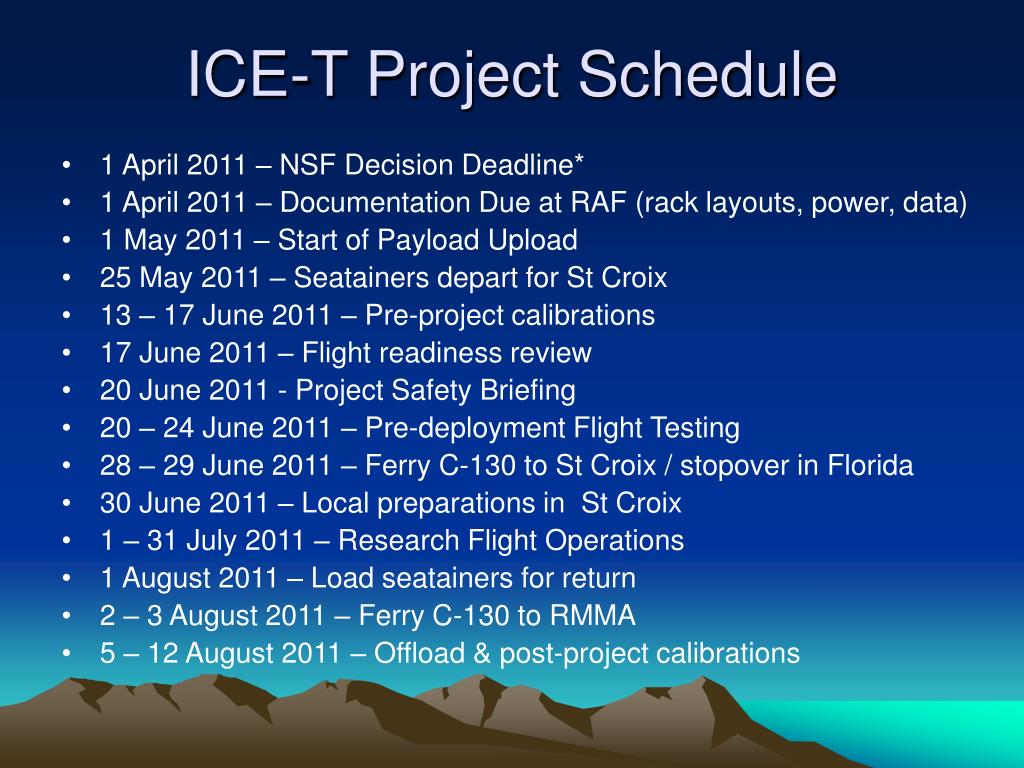

  1. ICE-T Project Schedule • 1 April 2011 – NSF Decision Deadline* • 1 April 2011 – Documentation Due at RAF (rack layouts, power, data) • 1 May 2011 – Start of Payload Upload • 25 May 2011 – Seatainers depart for St Croix • 13 – 17 June 2011 – Pre-project calibrations • 17 June 2011 – Flight readiness review • 20 June 2011 - Project Safety Briefing • 20 – 24 June 2011 – Pre-deployment Flight Testing • 28 – 29 June 2011 – Ferry C-130 to St Croix / stopover in Florida • 30 June 2011 – Local preparations in St Croix • 1 – 31 July 2011 – Research Flight Operations • 1 August 2011 – Load seatainers for return • 2 – 3 August 2011 – Ferry C-130 to RMMA • 5 – 12 August 2011 – Offload & post-project calibrations

  2. Upload Schedule • May 2 – 6: RAF Infrastructure & Heated Inlet • May 9 – 13: CVI & RAF Infrastructure - Maintenance Test Flight Required • May 16 – 20: Prather & Clarkson • May 23 – 27: Hudson, deMott, CARI Chemistry • May 31 – June 6: WCR, WCL, Toohey, Anderson & DMT • June 13 – 17: Pre-Cals & WCR Ramp Cal
