2009 Standardized Mortality Ratio Project: Summary Svetlana (Lana) Kacherova, QI Director Lisle Mukai, QI Coordinator ESRD Network 18 July 21, 2009
SMR Project: Inclusion Criteria for Participating Facilities • SMR rated “Worse than expected” (2008 DFR data) – 26 facilities • State Surveyors review DFRs before visiting facilities • SMR information is available on the Dialysis Facility Compare website at www.medicare.gov • 2009 DFRs just received: expect to receive your reports in August 2009

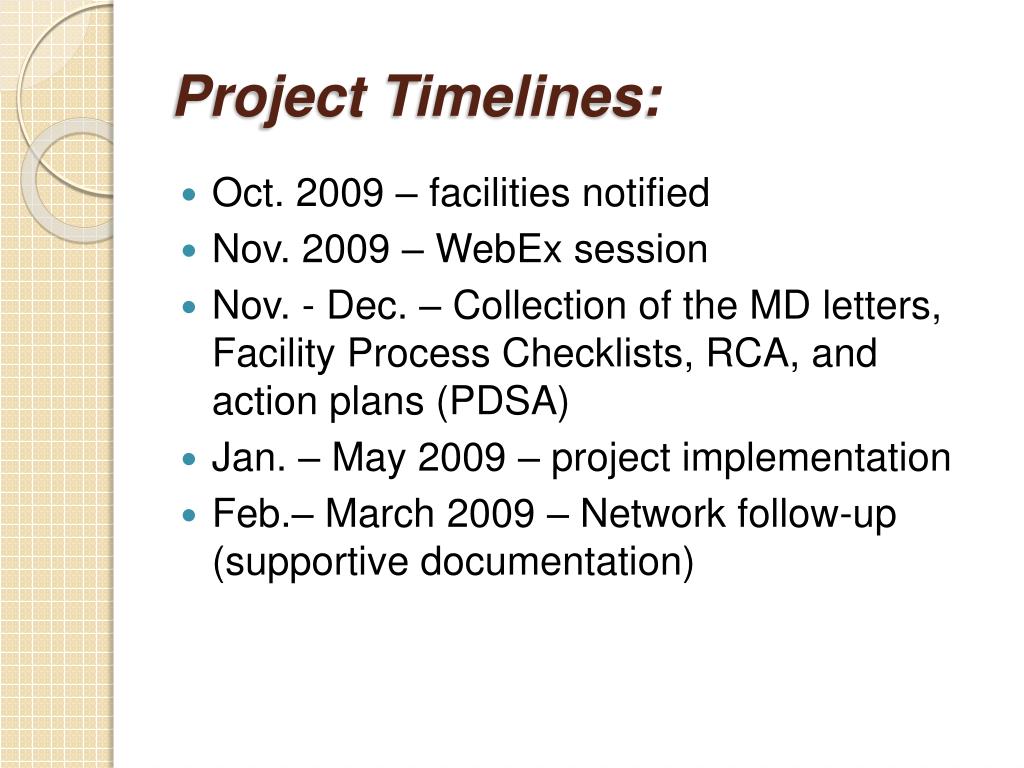

Project Timelines: • Oct. 2009 – facilities notified • Nov. 2009 – WebEx session • Nov. - Dec. – Collection of the MD letters, Facility Process Checklists, RCA, and action plans (PDSA) • Jan. – May 2009 – project implementation • Feb.– March 2009 – Network follow-up (supportive documentation)
Network Role During the Project: • Project Leader • Supplied the templates for RCA & PDSA • Supplied facilities with tools and knowledge • Periodically monitored and provided feedback • Conducted phone interviews to obtain facility-specific data • Chased you for data & documentation • Assisted your facility to stay in compliance with the QAPI program requirements

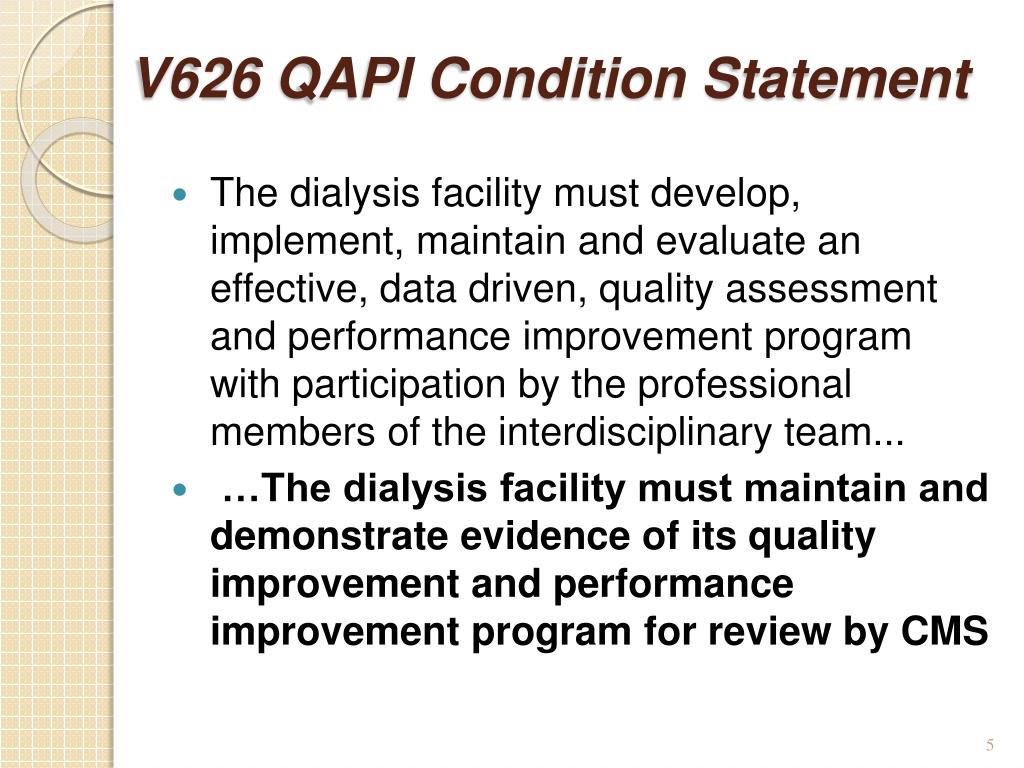

V626 QAPI Condition Statement • The dialysis facility must develop, implement, maintain and evaluate an effective, data driven, quality assessment and performance improvement program with participation by the professional members of the interdisciplinary team... • …The dialysis facility must maintain and demonstrate evidence of its quality improvement and performance improvement program for review by CMS

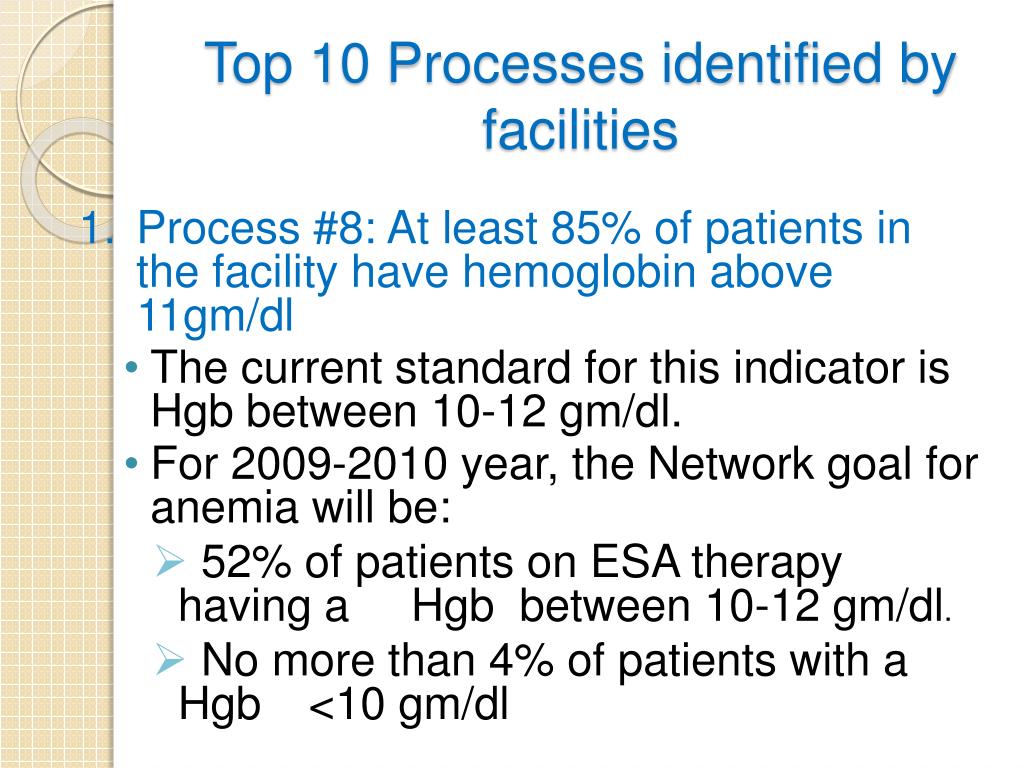

Top 10 Processes identified by facilities 1. Process #8: At least 85% of patients in the facility have hemoglobin above 11gm/dl • The current standard for this indicator is Hgb between 10-12 gm/dl. • For 2009-2010 year, the Network goal for anemia will be: • 52% of patients on ESA therapy having a Hgb between 10-12 gm/dl. • No more than 4% of patients with a Hgb <10 gm/dl

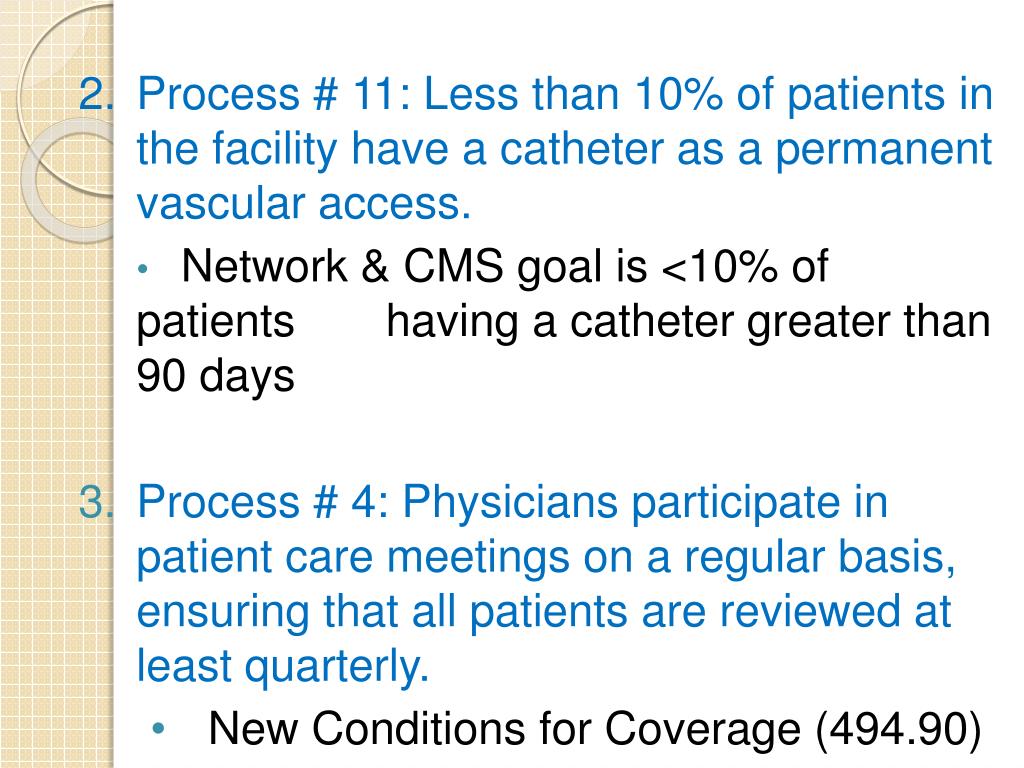

2. Process # 11: Less than 10% of patients in the facility have a catheter as a permanent vascular access. • Network & CMS goal is <10% of patients having a catheter greater than 90 days • Process # 4: Physicians participate in patient care meetings on a regular basis, ensuring that all patients are reviewed at least quarterly. • New Conditions for Coverage (494.90)
4. Process #16: Facility staff accurately indicates cause of death when completing 2746 Death Notification forms for deceased patients. • Process # 12: At least 50% of patients in the facility have an AVF as permanent vascular access. • NW prevalent AVF goal for 2009-2010 = 57.8%
6. Process # 15: Facility staff reports all co-morbidities when completing 2728 CMS Medical Evidence Forms for new ESRD patients. 7. Process # 9: At least 88% of patients in the facility have URR > 0.65 (65%) or Kt/V > 1.2. • This is the Network goal for the 2008-2009 year • PD goal = 88% of patients with Kt/V > 1.7

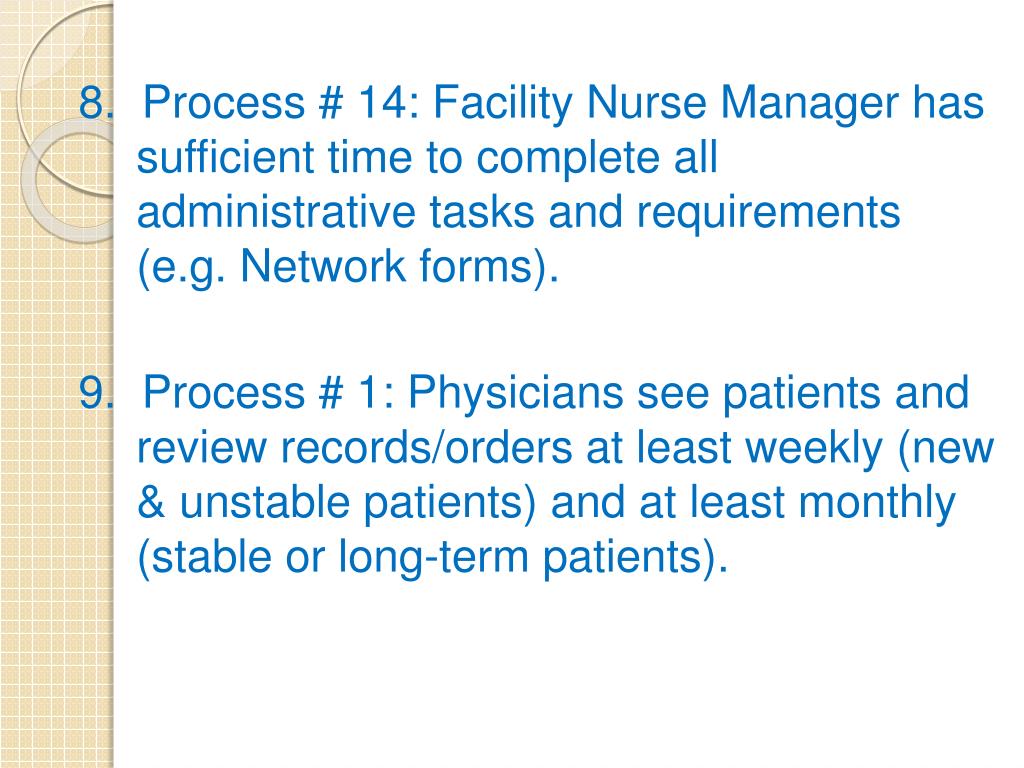

8. Process # 14: Facility Nurse Manager has sufficient time to complete all administrative tasks and requirements (e.g. Network forms). 9. Process # 1: Physicians see patients and review records/orders at least weekly (new & unstable patients) and at least monthly (stable or long-term patients).

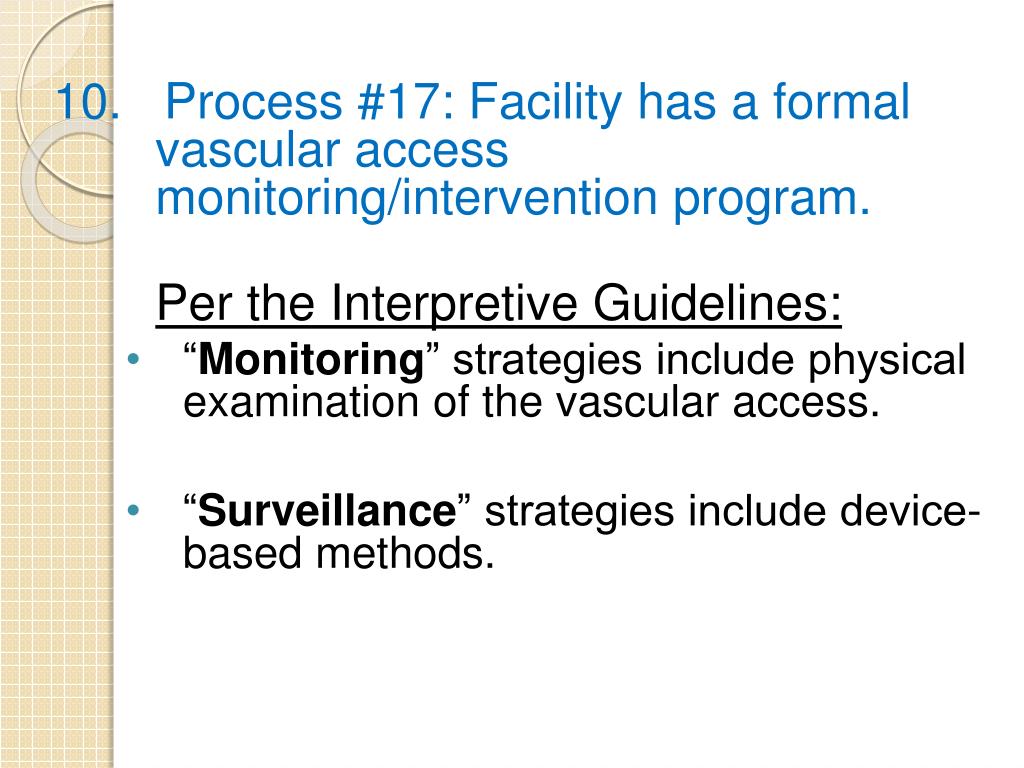

10. Process #17: Facility has a formal vascular access monitoring/intervention program. Per the Interpretive Guidelines: • “Monitoring” strategies include physical examination of the vascular access. • “Surveillance” strategies include device-based methods.
Summary of Strategies for the top 10 focus areas: Vascular Access Care: • Review of vascular accesses to ensure that the correct vascular access is recorded in the patient’s electronic records and facility tracking logs. • Staff education on vascular access care • Patient & family education on vascular access care
Develop communication with physician regarding access placement prior to hospital discharge. • Engage nephrologists & surgeons into the Fistula First program • Find a good vascular access surgeon • Use the Vascular Access Centers for vessel mapping, follow-up, and interventions. • Develop & implement a catheter reduction program – addressing both prevalent & incident patients.

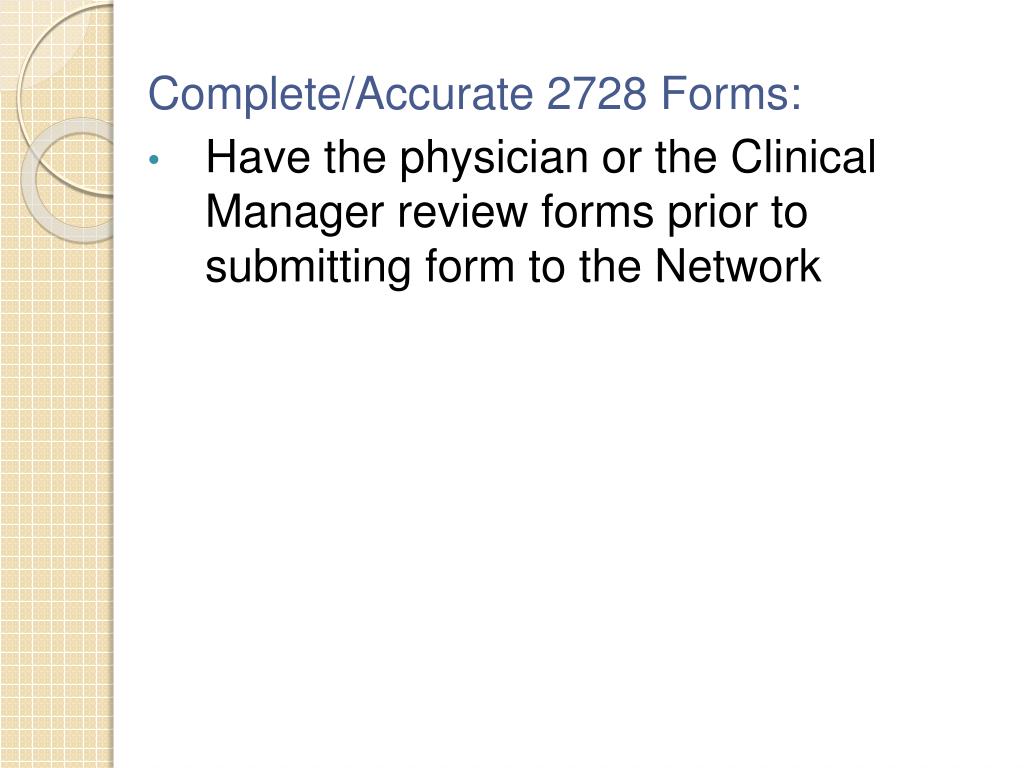

Complete/Accurate 2728 Forms: • Have the physician or the Clinical Manager review forms prior to submitting form to the Network
Complete/Accurate 2746 Forms: • Have the physician or Clinical Manager review forms prior to submitting form to the Network • AA will keep a binder of all 2746 forms and keep a log for all causes of death • Develop & implement a mortality tracking report

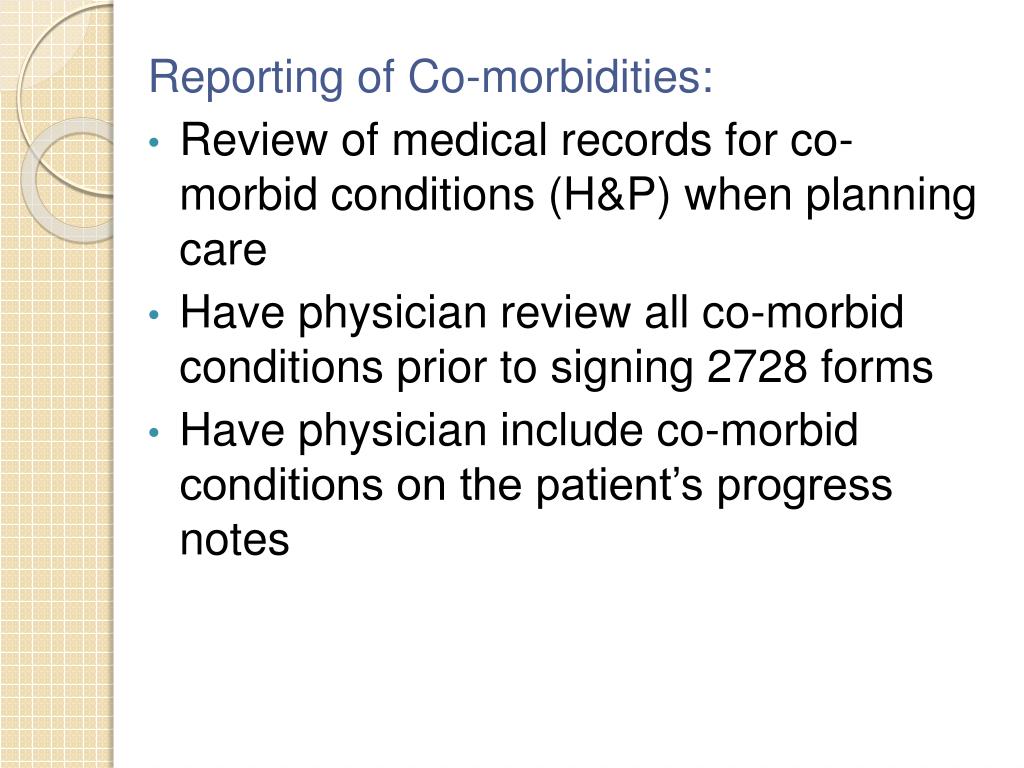

Reporting of Co-morbidities: • Review of medical records for co-morbid conditions (H&P) when planning care • Have physician review all co-morbid conditions prior to signing 2728 forms • Have physician include co-morbid conditions on the patient’s progress notes

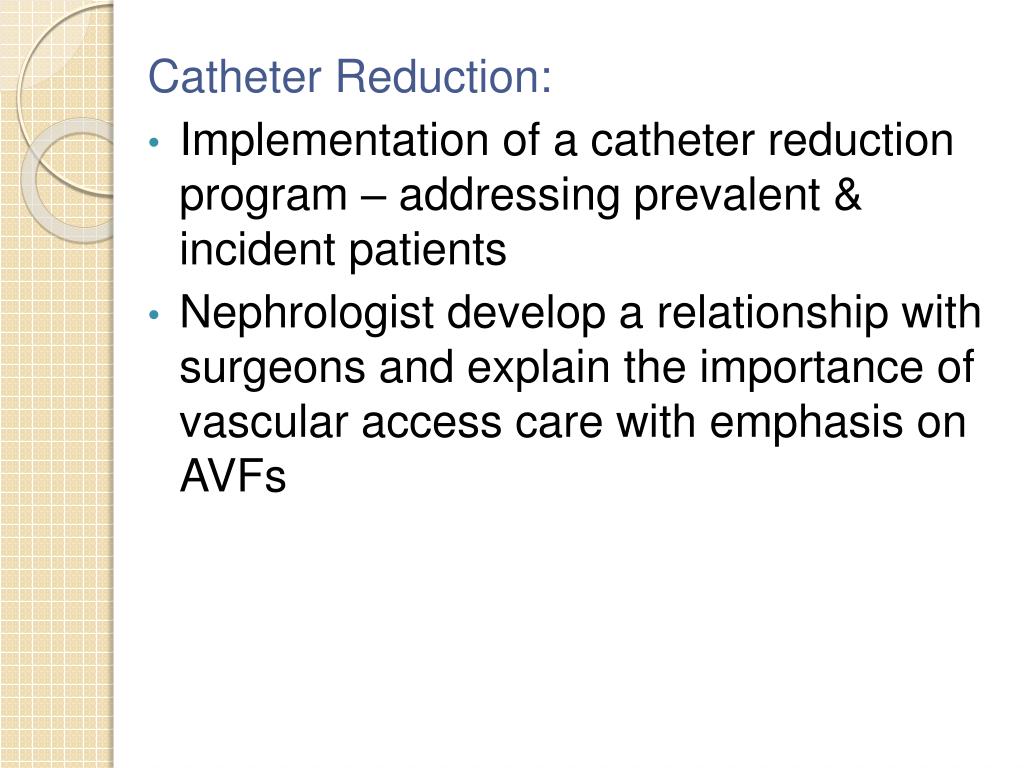

Catheter Reduction: • Implementation of a catheter reduction program – addressing prevalent & incident patients • Nephrologist develop a relationship with surgeons and explain the importance of vascular access care with emphasis on AVFs
Review of Clinical Indicators: • Review of monthly lab results by the interdisciplinary team • Trend facility data for each indicator – assess need for improvement • Monitor outcomes by physician group and have the Medical Director maintain communication with the group regarding their statistics • Distribute physician or physician group QA reports of those patients that fall below the goal(s)
Anemia Management: • Identify patients with Hgb < 10 and develop Plan of Care • Protocol changes to reflect the new Conditions for Coverage • Designate hours for the Anemia Manager to perform duties
Monitoring of Infections: • Decrease catheter rate - Educating patients & families about benefits/disadvantages of catheters • Develop & implement an infection control log to track the types of infection, actions/interventions taken, date of resolution, and trending of types of infection and frequency of events • Monitor staff adherence to infection control policies • Encourage and remind patients to wash access prior to treatment
Staff Education: • Hold in-services Patient Education: • Staff to educate patients on compliance with dialysis prescription, diet, and vascular access care – focused education for specific issues • Social worker to check/assess all diabetic patients to see if they need more diabetes education and refer them to a diabetic center

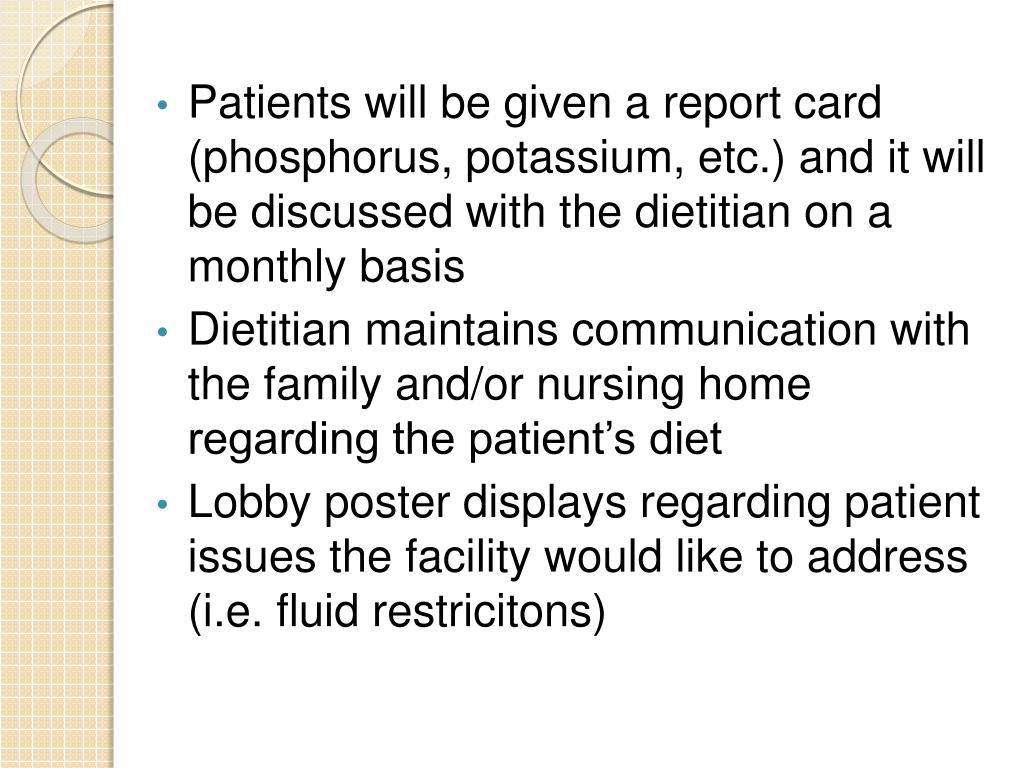

Patients will be given a report card (phosphorus, potassium, etc.) and it will be discussed with the dietitian on a monthly basis • Dietitian maintains communication with the family and/or nursing home regarding the patient’s diet • Lobby poster displays regarding patient issues the facility would like to address (i.e. fluid restricitons)

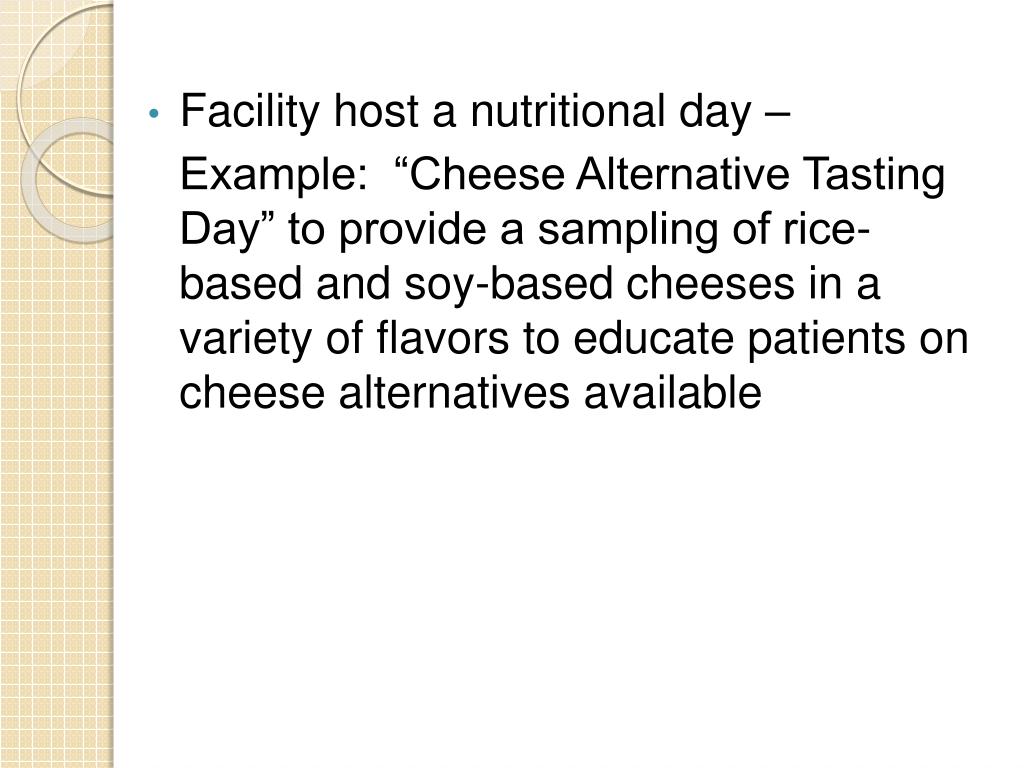

Facility host a nutritional day – Example: “Cheese Alternative Tasting Day” to provide a sampling of rice-based and soy-based cheeses in a variety of flavors to educate patients on cheese alternatives available

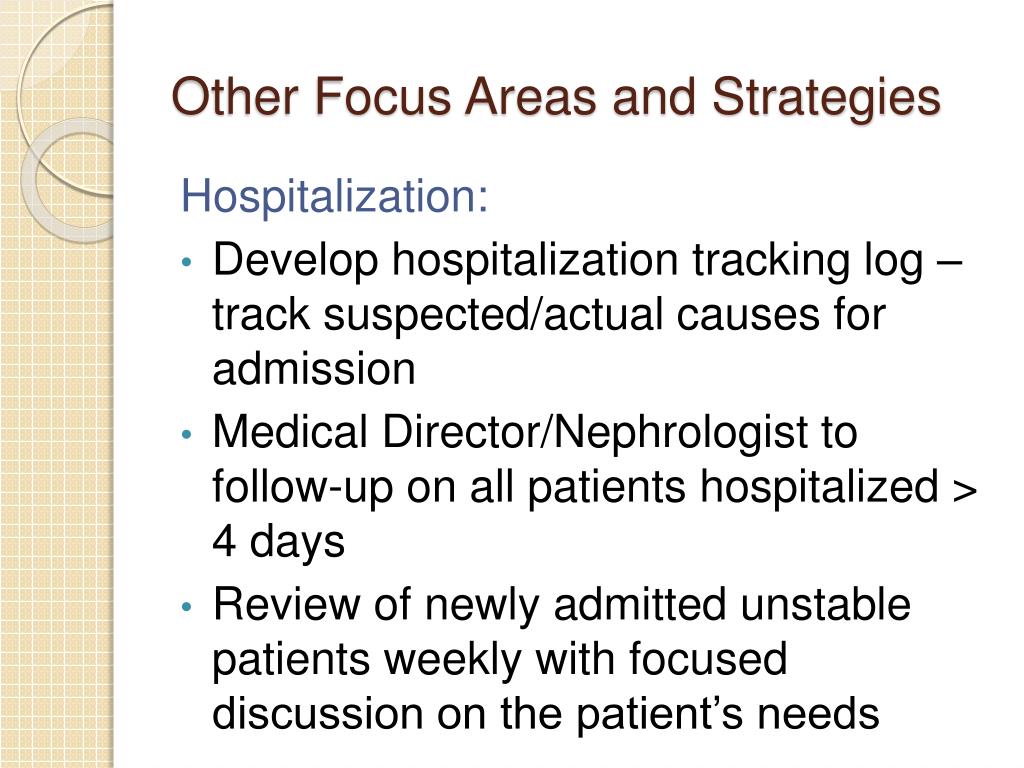

Other Focus Areas and Strategies Hospitalization: • Develop hospitalization tracking log – track suspected/actual causes for admission • Medical Director/Nephrologist to follow-up on all patients hospitalized > 4 days • Review of newly admitted unstable patients weekly with focused discussion on the patient’s needs

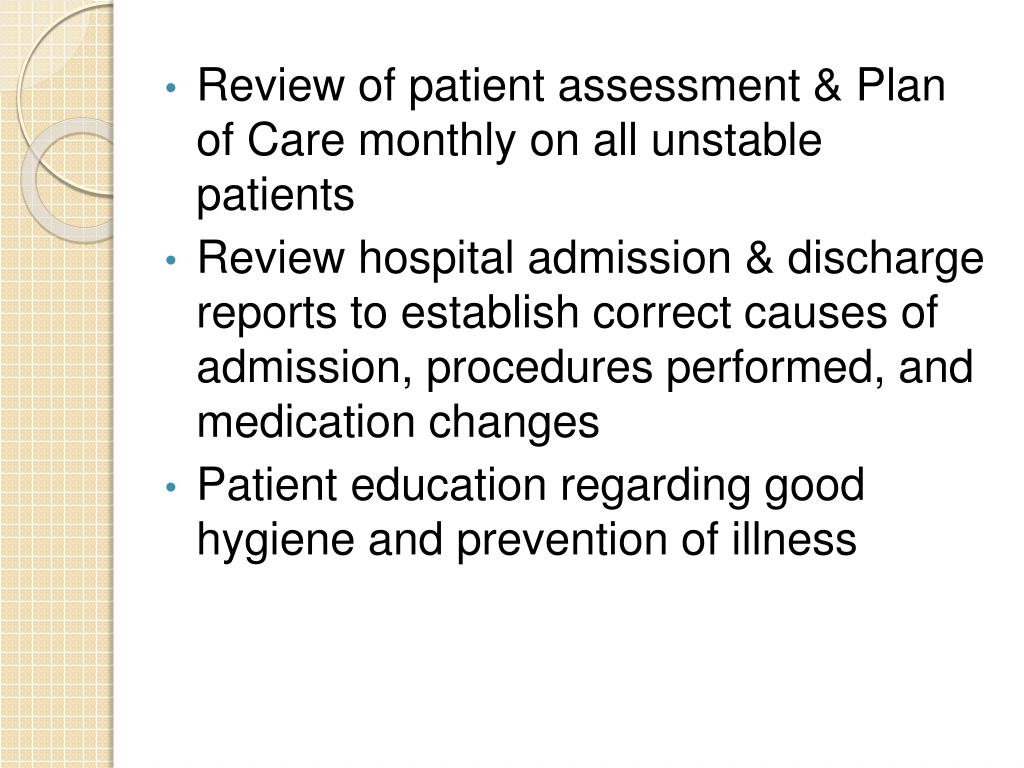

Review of patient assessment & Plan of Care monthly on all unstable patients • Review hospital admission & discharge reports to establish correct causes of admission, procedures performed, and medication changes • Patient education regarding good hygiene and prevention of illness

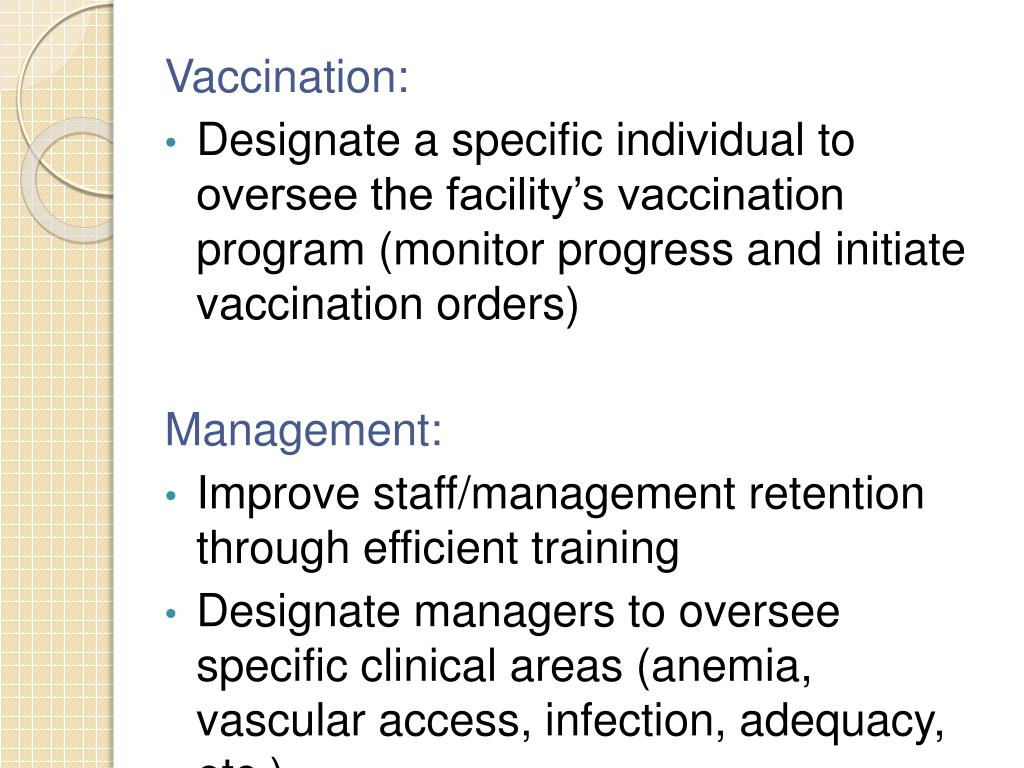

Vaccination: • Designate a specific individual to oversee the facility’s vaccination program (monitor progress and initiate vaccination orders) Management: • Improve staff/management retention through efficient training • Designate managers to oversee specific clinical areas (anemia, vascular access, infection, adequacy, etc.)
Hold QAPI meetings at least monthly to discuss patient issues and concerns and facility issues and concerns • Improve documentation, tracking and timely/accurate data submission
Next steps of the project: • Review and update your QAPI as necessary • The Network will continue monitoring your facility’s SMR for the next 3 years • Review your facility’s DFR to ensure the data reported is correct
Svetlana (Lana) Kacherova, QI Director skacherova@nw18.esrd.net Lisle Mukai, QI Coordinator lmukai@nw18.esrd.net 6255 Sunset Boulevard Suite 2211 Los Angeles CA 90028 (323) 962-2020 (323) 962-2891/Fax www.esrdnetwork18.org
