Multi-TDL Management System. Elliot Brinkworth TDL17 Tactical Data Links IPT. Contents. Introduction Progress to date Pre Main Gate Activities Requirements capture Risk Reduction Post Main Gate Activities Lines of Development JCIET 04 JICO Support System Project Plan Summary.
E N D
Multi-TDL Management System Elliot Brinkworth TDL17 Tactical Data Links IPT
Contents • Introduction • Progress to date • Pre Main Gate Activities • Requirements capture • Risk Reduction • Post Main Gate Activities • Lines of Development • JCIET 04 • JICO Support System • Project Plan • Summary
Introduction • Requirement for Multi TDL Management • Out of Area • Currently Link 11 & Link 16 • Growth potential for new links • Category D project - £7M budget • Initial Operating Capability in service by December 2004

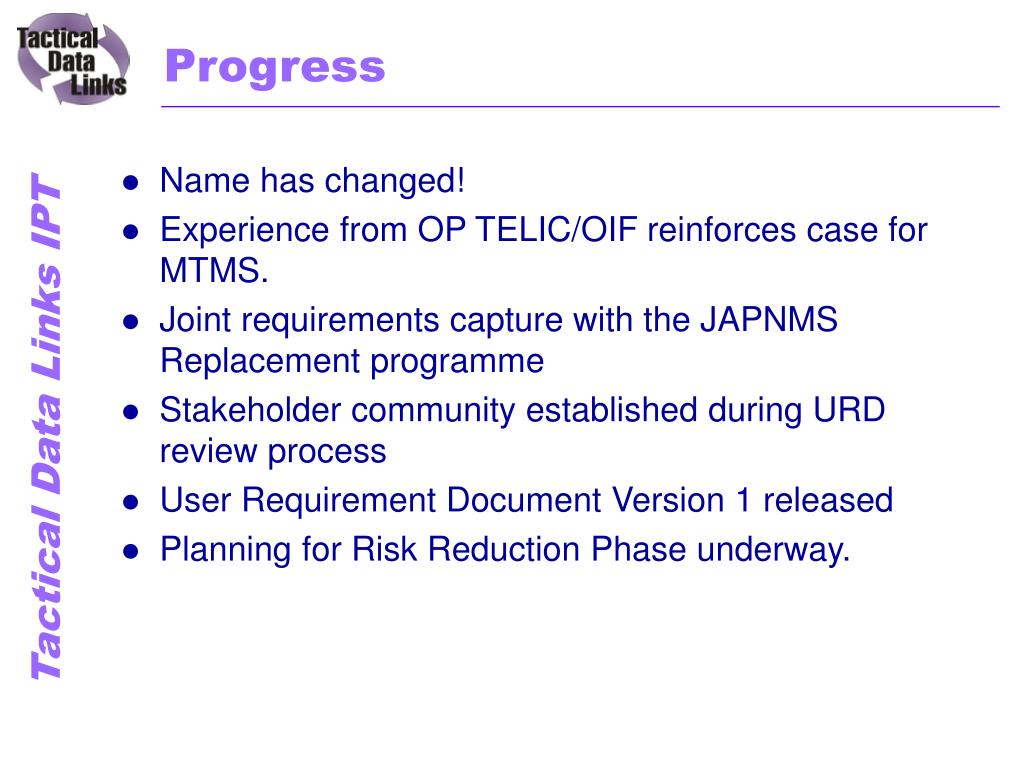

Progress • Name has changed! • Experience from OP TELIC/OIF reinforces case for MTMS. • Joint requirements capture with the JAPNMS Replacement programme • Stakeholder community established during URD review process • User Requirement Document Version 1 released • Planning for Risk Reduction Phase underway.
TDL 17 TDL 13 Multi-TDL Management System JTIDS Air Platform Network Management System (Replacement) UK Static Out of Area Link 16 Only Multi-TDL MTMS & JAPNMS(R) Multi-TDL Management Capability

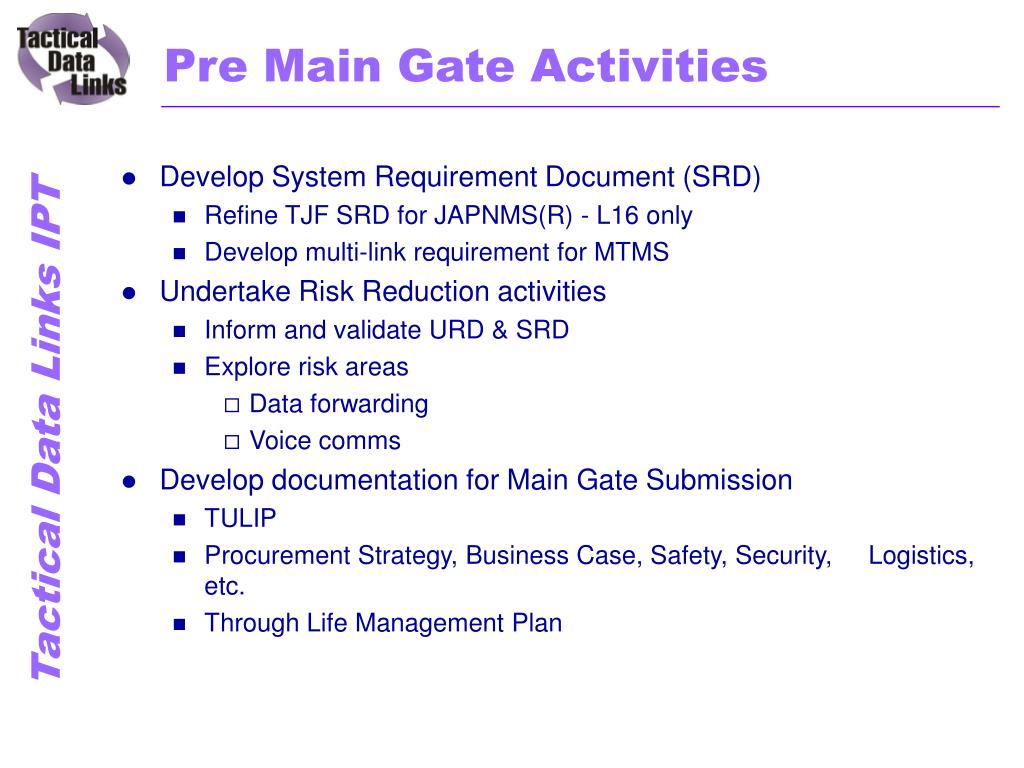

Pre Main Gate Activities • Develop System Requirement Document (SRD) • Refine TJF SRD for JAPNMS(R) - L16 only • Develop multi-link requirement for MTMS • Undertake Risk Reduction activities • Inform and validate URD & SRD • Explore risk areas • Data forwarding • Voice comms • Develop documentation for Main Gate Submission • TULIP • Procurement Strategy, Business Case, Safety, Security, Logistics, etc. • Through Life Management Plan
URD SRD Joint Requirements Capture DOORS Database MTIENMS OOA SRD JAPNMS UK Static SRD DOORS Database
Risk Reduction Activities • Air C2 Operational Evaluation Unit providing lead • Equipment • In-service equipment & test tools • IJSS - benchmark current US capability • Use equipment post MG (e.g. JCIET) • Lessons learned will be applicable to the MTMS solution. • Basis for interim capability if required.

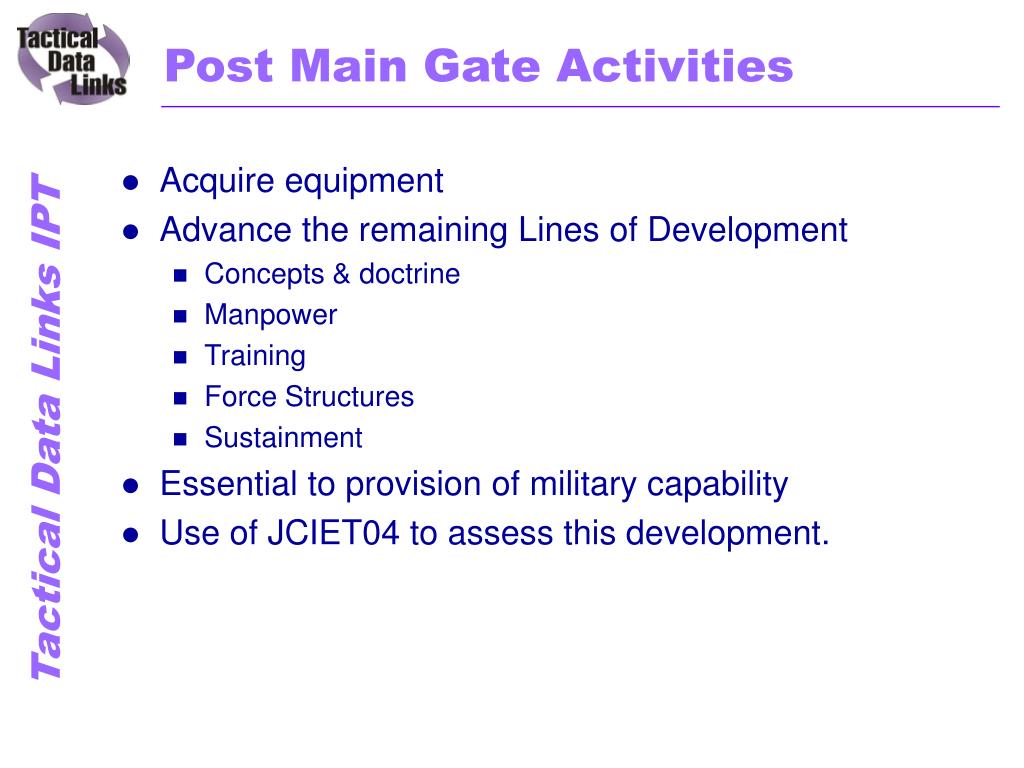

Post Main Gate Activities • Acquire equipment • Advance the remaining Lines of Development • Concepts & doctrine • Manpower • Training • Force Structures • Sustainment • Essential to provision of military capability • Use of JCIET04 to assess this development.
JICO Support System • Case for UK collaboration in JSS • Requirement for US interoperability • Economies of scale • Requirements • Releasability of JSS ORD • UK has the JSS TRD • Map requirements from the JSS TRD to the MTMS URD • Information Exchange • Information Exchange Agreement being staffed • JSS MOA is the next step.

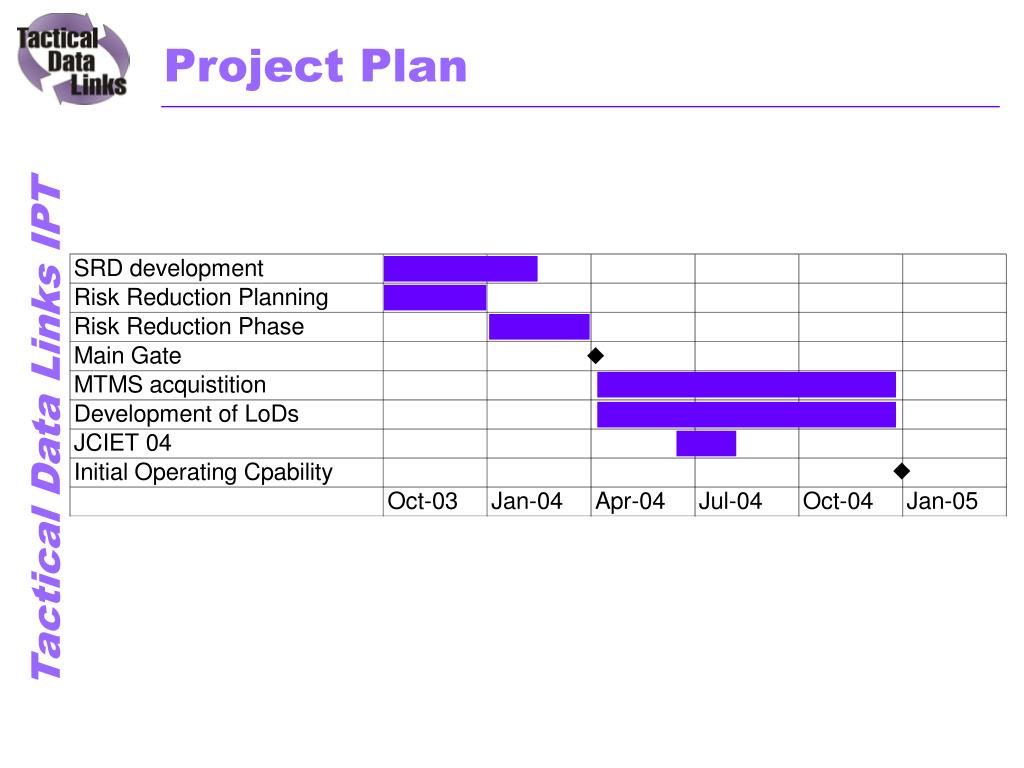

Summary • User Requirement defined • Developing System Requirement • Risk Reduction phase due to commence January 2003 • Non-equipment Lines of Development are key to delivering capability • JSS collaboration being studied.
