Agile Project Delivery Using Scrum

Agile Project Delivery Using Scrum. Training Goals. Understand Scrum at a high level Understand the basic principles and practices of Scrum Appreciate how scrum processes can help teams practice self-directed leadership Understand that our learning will be iterative.

sugar
Télécharger la présentation

Agile Project Delivery Using Scrum

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Agile Project Delivery Using Scrum

  2. Training Goals • Understand Scrum at a high level • Understand the basic principles and practices of Scrum • Appreciate how scrum processes can help teams practice self-directed leadership • Understand that our learning will be iterative

  3. Think “out-of-the-box” • Scrum is founded on sound industry accepted project management practices • Open our mind to new concepts.

  4. Agile & Scrum Overview

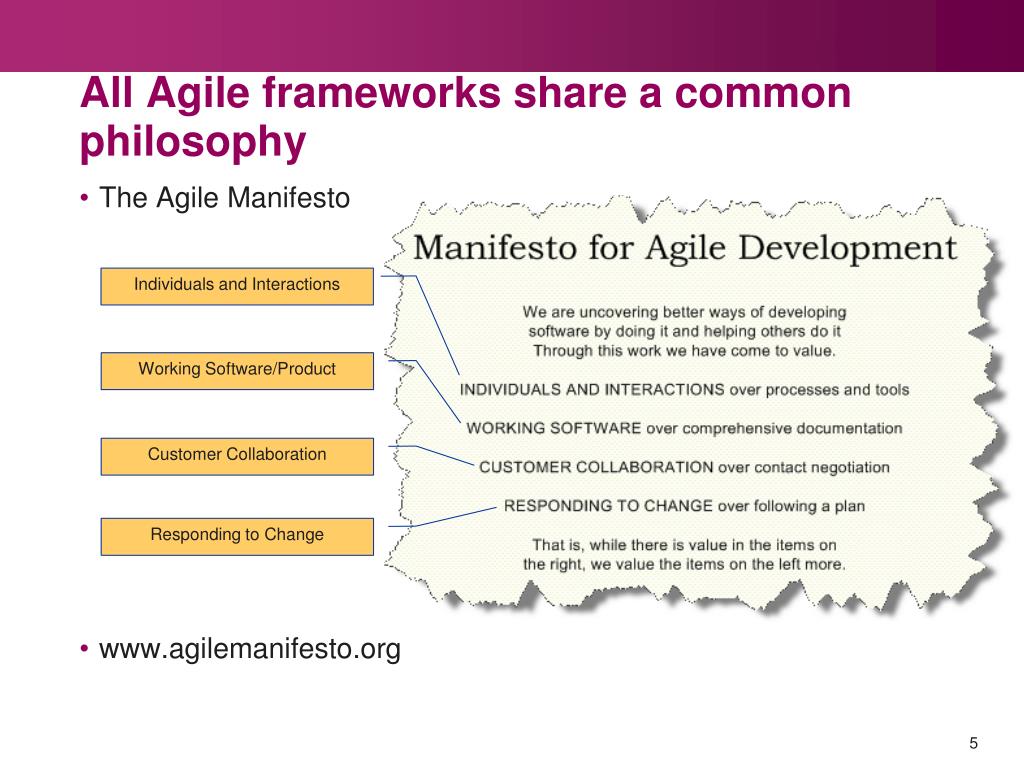

  5. All Agile frameworks share a common philosophy • The Agile Manifesto • www.agilemanifesto.org Individuals and Interactions Working Software/Product Customer Collaboration Responding to Change

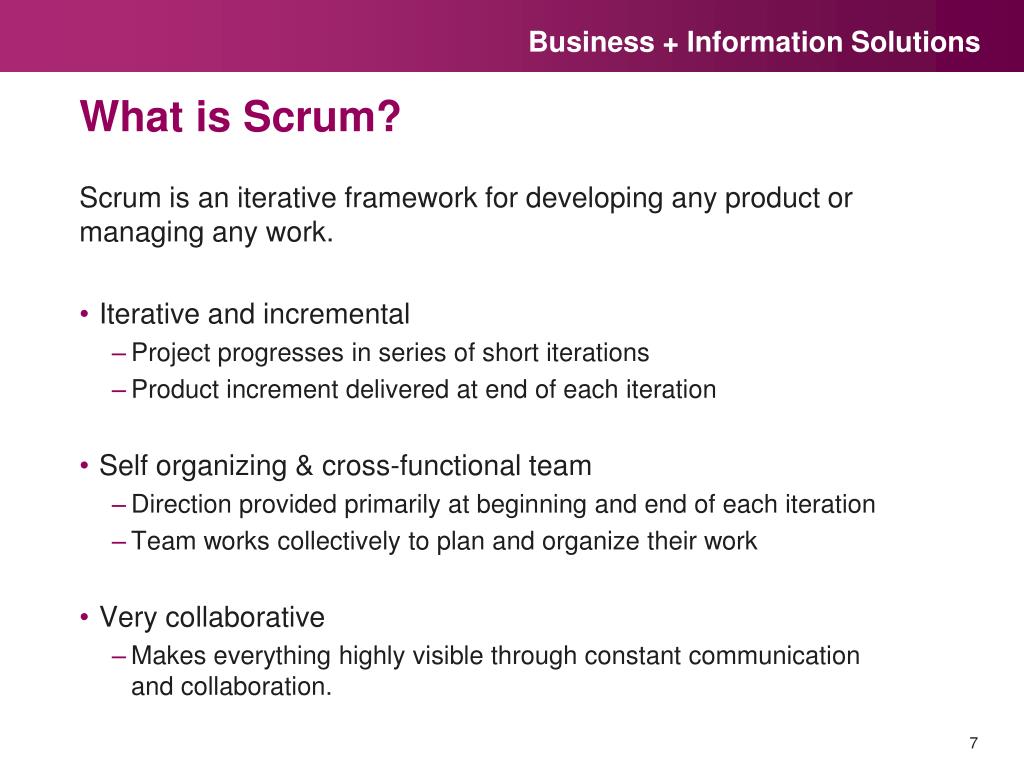

  6. What is Scrum? Scrum is an iterative framework for developing any product or managing any work. • Iterative and incremental • Project progresses in series of short iterations • Product increment delivered at end of each iteration • Self organizing & cross-functional team • Direction provided primarily at beginning and end of each iteration • Team works collectively to plan and organize their work • Very collaborative • Makes everything highly visible through constant communication and collaboration.

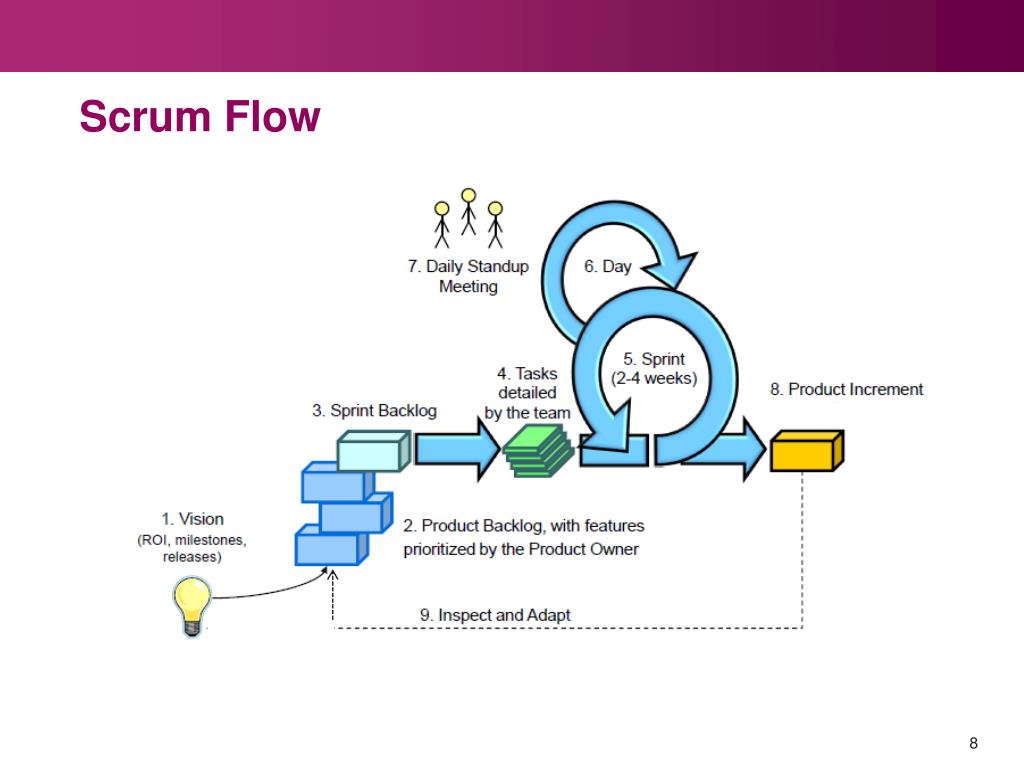

  7. Scrum Flow

  8. Scrum Components • Major components of Scrum • Release • Completion of a major component of work. • Consists of multiple iterations • Release Preparation occurs at the beginning of a release • Iteration • Time box (10-20 days) • Completion of a small increment of work • Multiple iterations in a release

  9. Project Team Iteration Master End Users Scrum Team Dr. Quicksall & “Sampling Team” Product Advisor (Faculty/TA Coach)

  10. Roles – Product Advisor (aka Product Owner) • Coaching Responsibilities • Trains and Mentors the Scrum team • Guides the Iteration Master to follow and maintain the process • Defines the features of the product • What Stakeholders want • What goes into the product • Decides on the release dates and content • Responsibilities • Prioritizes the user stories in the Product Backlog • Ultimate decision maker on requirements issues • Negotiates Acceptance Criteria for work results (Faculty/TA Coach)

  11. Roles – Iteration Master (aka Scrum Master) • Member of the Scrum team • Facilitator, not manager • Keeps the process moving • “Enforces” the Scrum framework(w/help of coaches) • Ensures full-team involvement in all meetings • Keeps everything visible • Advocate for improved practices • Communicate impediments and successes • Tracks and communicates progress of team

  12. Roles – Scrum Team • Cross functional, self organizing and self managing • Self motivated to help the team succeed • Works to solve problems & produce product increments • Follows Scrum practices and organizational policies • Innovative • Looks for ways to design, build, document with less effort • Looks for ways to create a better product • Adds new ideas or issues discovered to the Product Backlog • Stays focused on the iteration goals and commitments

  13. Self-Directed Teams • Responsible for planning, managing and executing work • Team plans work together • Team determines approach for completing work • Each person volunteers for tasks. Tasks are not assigned. • Works together to meet goals • Step up to help team members succeed • No “not my job” • Provide solutions and feedback • Abide by team decisions • Responsible for team success or failure

  14. Scrum Release Preparation

  15. Release Preparation • Visioning – Team collaborates to establish the detailed project vision and understand the expected outcomes of the project. • Roadmapping- Map out the long term plan for how the product will evolve over time and establish optimal release windows • User Story Workshop – Create, estimate, and prioritize user stories for the project • Release Planning – Review the Product Backlog to plan the release timeline and iteration planning activities

  16. Visioning • Overview • Initial meeting with the Scrum team to review from a business perspective, collaborate, and agree on the… • … goals, value, vision for completing the project • … scope, stakeholders, architecture impacts, and tool requirements. • Opportunity to agree on the team working agreement • Outcomes • Team alignment on project scope and expectations • Team Working agreement • Initial Issues and Risks

  17. Vision Statement Team collaborates to establish the project vision and understand the expected outcomes of the project. Some team choose to create a vision statement: For research scientists who would like to remotely access a well, sample the water, and test it on site, the Quicksall.org initiative will provide researchers a robot that can self-navigate a variety of terrains, sample from various well types, and perform on-site testing and remediation

  18. Roadmapping • Overview • Opportunity to create a Product Roadmap • Shows how the product and architecture may evolve to deliver desired features and benefits to specific user or customer groups. • Determine high level milestones that could affect the project. • Can include product release dates, infrastructure upgrades, important customer milestones or any other significant date that could impact the project. • Determine any dependencies between milestones, architecture, and features to be developed for customers • Outcomes • A long term view of the Product Roadmap with any dependencies associated with customers, features, events, rhythms, and the architecture.

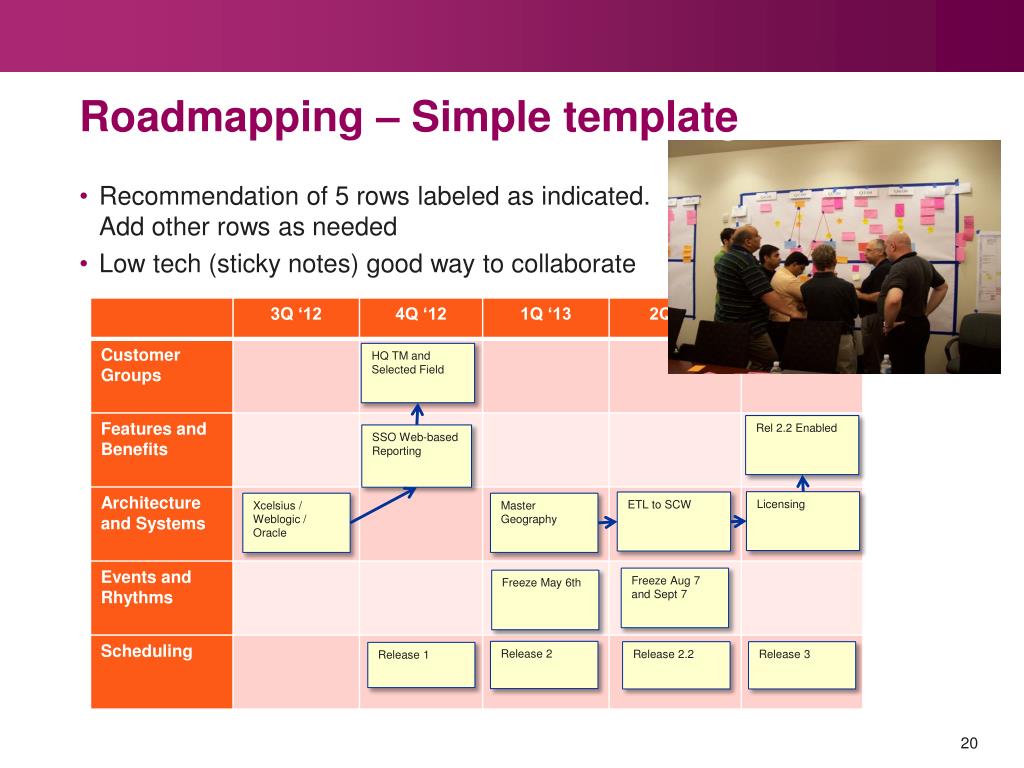

  19. Roadmapping – Simple template • Recommendation of 5 rows labeled as indicated. Add other rows as needed • Low tech (sticky notes) good way to collaborate HQ TM and Selected Field Rel 2.2 Enabled SSO Web-based Reporting Licensing ETL to SCW Xcelsius / Weblogic / Oracle Master Geography Freeze Aug 7 and Sept 7 Freeze May 6th Release 2 Release 2.2 Release 3 Release 1

  20. Scrum Release Preparation User Story Workshop

  21. User Story Workshop • The User Story Workshop consists of 3 sections • User Story Creation • Project team creates user stories • User Story Estimation • Project team estimates the story points for each user story • User Story Prioritization • Product Advisor with input from the Scrum team places the user stories in priority based on customer need and business value

  22. User Story Creation • Overview • Initial opportunity for the team to review, discuss, and document requirements for the project as user stories. • In Scrum a requirement is documented as a user storywhich is placed in the product backlog. It is the responsibility of the Product Advisor to review, prioritize and approve all user stories placed in the product backlog. • Outcomes • An initial set of user stories for the project

  23. User Stories – Backlog • Product Backlog • List of all requirements in the form of user stories • Prioritized by the Product Advisor • Items can only be added or removed by the Product Advisor • Iteration Backlog • User stories chosen to be worked in this iteration • Created by the team from the product backlog • Highest priority product backlog items Iteration Backlog Product Backlog

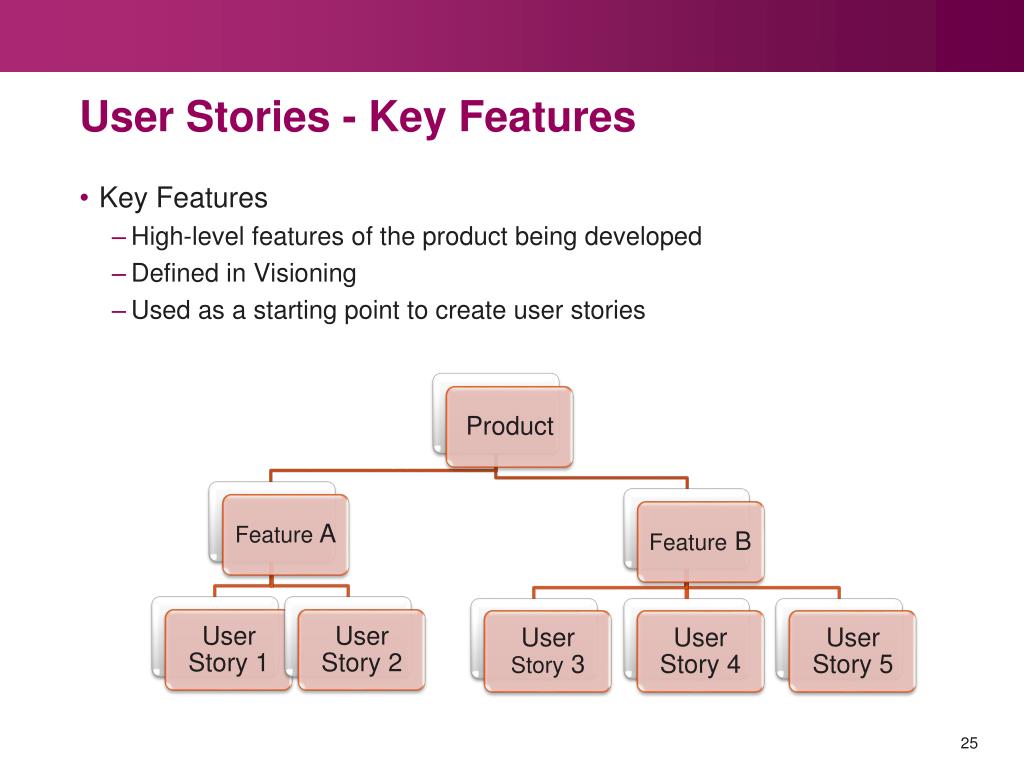

  24. User Stories - Key Features • Key Features • High-level features of the product being developed • Defined in Visioning • Used as a starting point to create user stories

  25. User Stories – Quicksall.org Examples

  26. User Stories – What are they? • Easy to use and manage approach to writing requirements • A short, plain-language description in terms of customer value • Created during story-writing workshops at the beginning of the project, and then augmented during the project • Augmented by screen mock-ups, design diagrams or any other artifact that enhances understanding of the story. • Anyone can write a user story

  27. User Stories – Why User Stories? • Stories are easy to understand • Developers and customers understand them • People are better able to remember events if they are organized into stories • Stories are the right size for planning • Support and encourage iterative development • Can easily start with very large stories and epics then break down close to development time • Stories support flexible and efficient development

  28. User Stories – Should follow INVEST Avoid dependencies on other stories Leave or imply some flexibility Identify value to the customers, not developers Enough detail to estimate. Must get done in a single iteration Acceptance criteria should be identified Independent Negotiable Valuable Estimable Small Testable INVEST coined by Bill Wake

  29. User Stories - Personas • Personas • A role identified that will use or interact with the developed product • Can be the product itself or components of the product • Can be real people or roles in an organization

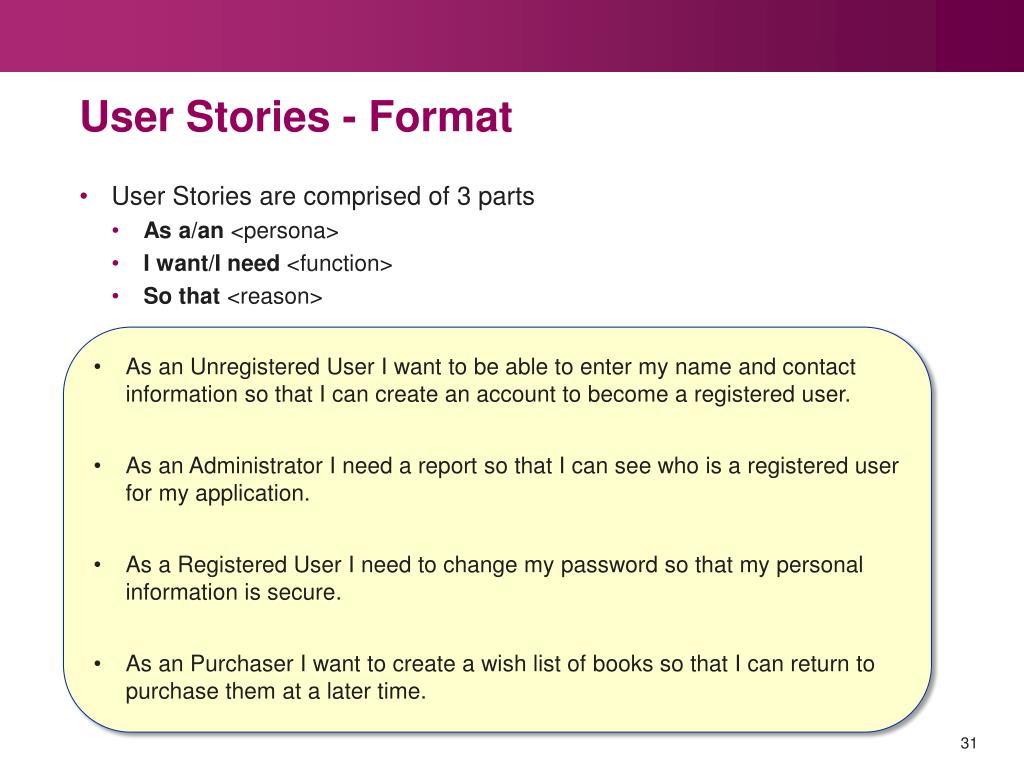

  30. User Stories - Format • User Stories are comprised of 3 parts • As a/an <persona> • I want/I need <function> • So that <reason> • As an Unregistered User I want to be able to enter my name and contact information so that I can create an account to become a registered user. • As an Administrator I need a report so that I can see who is a registered user for my application. • As a Registered User I need to change my password so that my personal information is secure. • As an Purchaser I want to create a wish list of books so that I can return to purchase them at a later time.

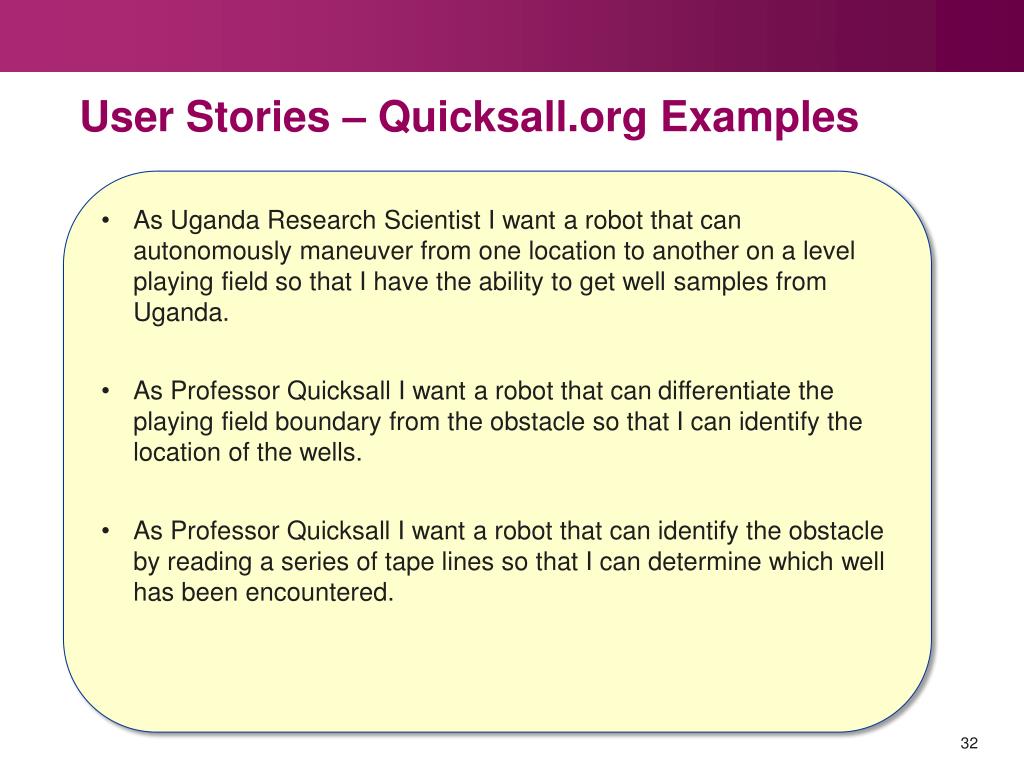

  31. User Stories – Quicksall.org Examples • As Uganda Research Scientist I want a robot that can autonomously maneuver from one location to another on a level playing field so that I have the ability to get well samples from Uganda. • As Professor Quicksall I want a robot that can differentiate the playing field boundary from the obstacle so that I can identify the location of the wells. • As Professor Quicksall I want a robot that can identify the obstacle by reading a series of tape lines so that I can determine which well has been encountered.

  32. User Stories – Card Layout

  33. User Stories - Confirmation • Confirmation methods are written on the back of the card • Include conditions of satisfaction or acceptance criteria • Essentially test cases that address various scenarios and questions

  34. User Stories – Spur Conversation • The card only covers the most basic information • The next level of detail comes in conversations between the Product Advisor and the Scrum team • The conversations take place • At Project inception, during story writing sessions • During the Iteration Planning Meeting • During the iteration

  35. Quicksall.orgUser Story Creation • Take 30 minutesto create user stories For research scientists who would like to remotely access a well, sample the water, and test it on site, the Quicksall.org initiative will provide researchers a robot that can self-navigate a variety of terrains, sample from various well types, and perform on-site testing and remediation Value Statement • Personas • Quicksall.org reps • Research Scientists • Create others if needed

  36. Scrum Release PreparationUser Story Estimation

  37. User Story Estimation • Overview • User Story Estimation is the initial opportunity for the Product Advisor and Scrum team to review and estimate the relative user story points for each user story. • Outcomes • An initial set of estimated user stories

  38. User Stories – Using Story Points • User stories are estimated in user story points not time. • Advantages to story points versus time estimates • Estimating is very quick because it is an intuitive estimate • The estimate indicates an item’s size relative to another, and does not give the illusion of being precise. • Estimating time can be hard, but we are all good at comparison.

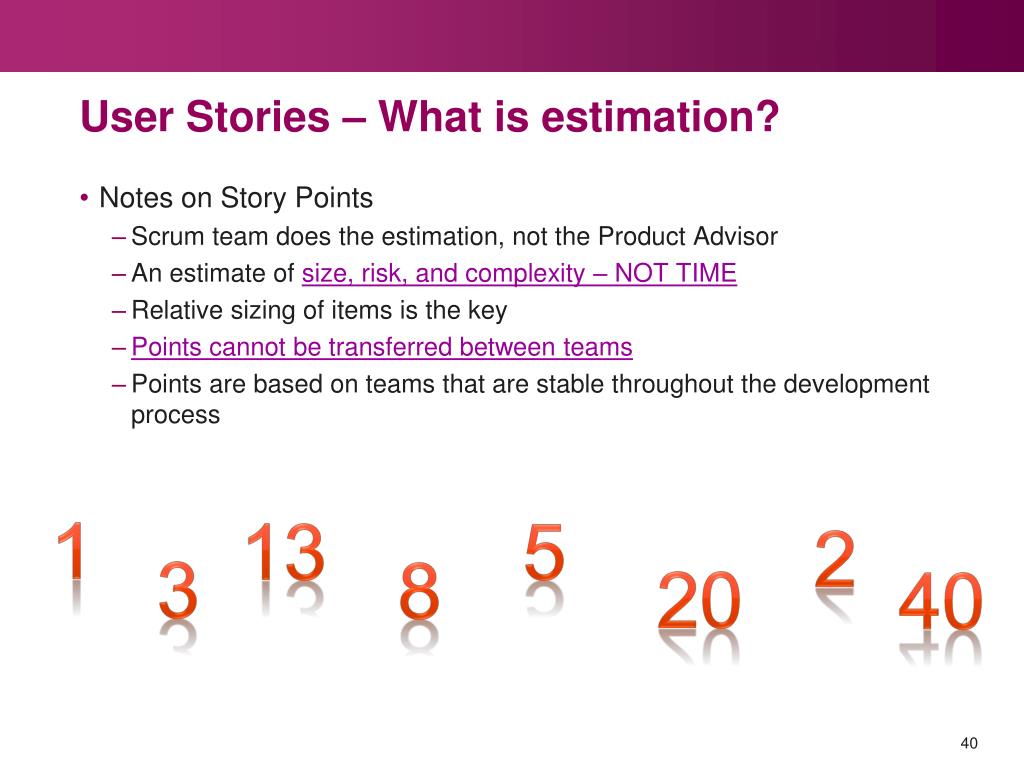

  39. User Stories – What is estimation? • Notes on Story Points • Scrum team does the estimation, not the Product Advisor • An estimate of size, risk, and complexity – NOT TIME • Relative sizing of items is the key • Points cannot be transferred between teams • Points are based on teams that are stable throughout the development process 1 13 5 2 3 8 20 40

  40. User Stories – Estimation “Planning Poker” • Planning Poker • Collaborative estimation method to help the team align on the relative size and complexity of each user story • uses multiple card decks each consisting of 8 cards numbered 1, 2, 3, 5, 8, 13, 20, and 40.

  41. User Stories – “Planning Poker” Rules • Iteration Master selects and reads the highest priority user story that has not already been estimated • Team briefly discusses the user story • Scrum team members SIMULTANEOUSLY show their selected card representing the story point estimate • The high and low team members in turn discuss why they selected the value they did (try to keep to less than 5 minutes for the total discussion) • The Scrum team then re-votes based on the views presented • The Iteration Master writes the value on the card and this becomes the story point value • Repeat the process for the next highest priority user story

  42. Scrum Release PreparationUser Story Prioritization

  43. User Story Prioritization • Overview • Opportunity for the Product Advisor, with input from the Scrum team to review and place the user stories into a prioritized order based on business value and customer need. • Outcomes • A set of prioritized project user stories

  44. User Stories - Prioritization • User stories are prioritized by the Product Advisor with input from the Scrum team. • Highest priority user stories should be delivered during the earlier iterations • Prioritization methods • Business Value • Product Advisor opinion • Technical Feasibility • Internal voting • Survey customers

  45. Quicksall.orgEstimation & Prioritization • Use the Antique Dealer ecommerce user stories already created • Take 20 minutesto estimate the story points for each • Review the user stories created previously with the group • Estimate the user stories using “Planning Poker” cards • Take 10 minutesto prioritize the created user stories • Review the user stories previously estimated • Product Advisor and Scrum team prioritize the user stories based on what needs to be completed first or has the most business value. • Place the user stories on the table in priority order

  46. Scrum Release PreparationRelease Planning

  47. Release Planning • Overview • Establish a plan and goals that the team can understand and communicate relative to the release of the project • The release plan establishes the goal of the release, the major risks, the features and functionality that the release will contain. It also establishes a probable delivery date • Outcomes • A determination of the user stories required for a release • The timing required for a release and functionality available • Documented activities required to perform a release

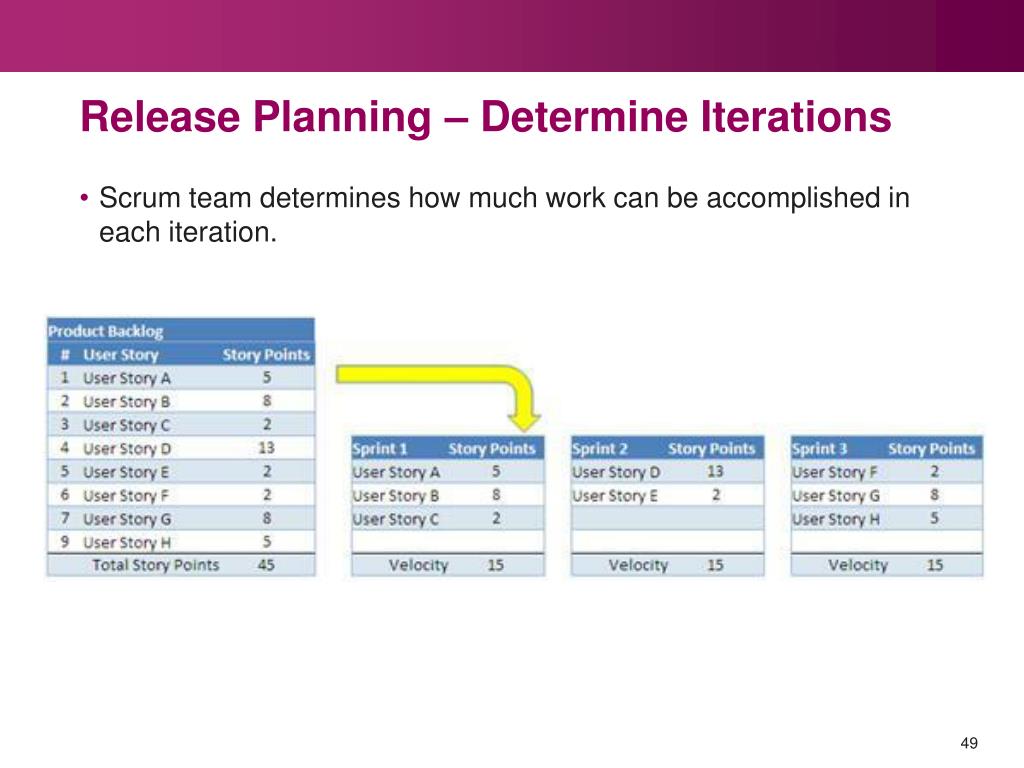

  48. Release Planning – Determine Iterations • Scrum team determines how much work can be accomplished in each iteration.

  49. Scrum Iteration ExecutionIteration Planning

  50. Iteration Execution • Overview • Where the majority of work for the project gets completed • Each task created for the iteration is selected by a team member as a work function • During this time that team member is responsible for working toward completing that task • Outcomes • Working product, reviewed, and accepted by the Product Advisor • Team has reflected on the work and has a plan to improve
