Integrating Environmental Management Plans into Project Operational Manuals

Integrating Environmental Management Plans into Project Operational Manuals. Agi Kiss Safeguards Training Workshop, Chisinau, Oct 28-31, 2008. Project Operational (Implementation) Manual. Reference for all aspects of project implementation: who does what, when and how

taliesin
Télécharger la présentation

Integrating Environmental Management Plans into Project Operational Manuals

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

  1. Integrating Environmental Management Plans into Project Operational Manuals Agi Kiss Safeguards Training Workshop, Chisinau, Oct 28-31, 2008

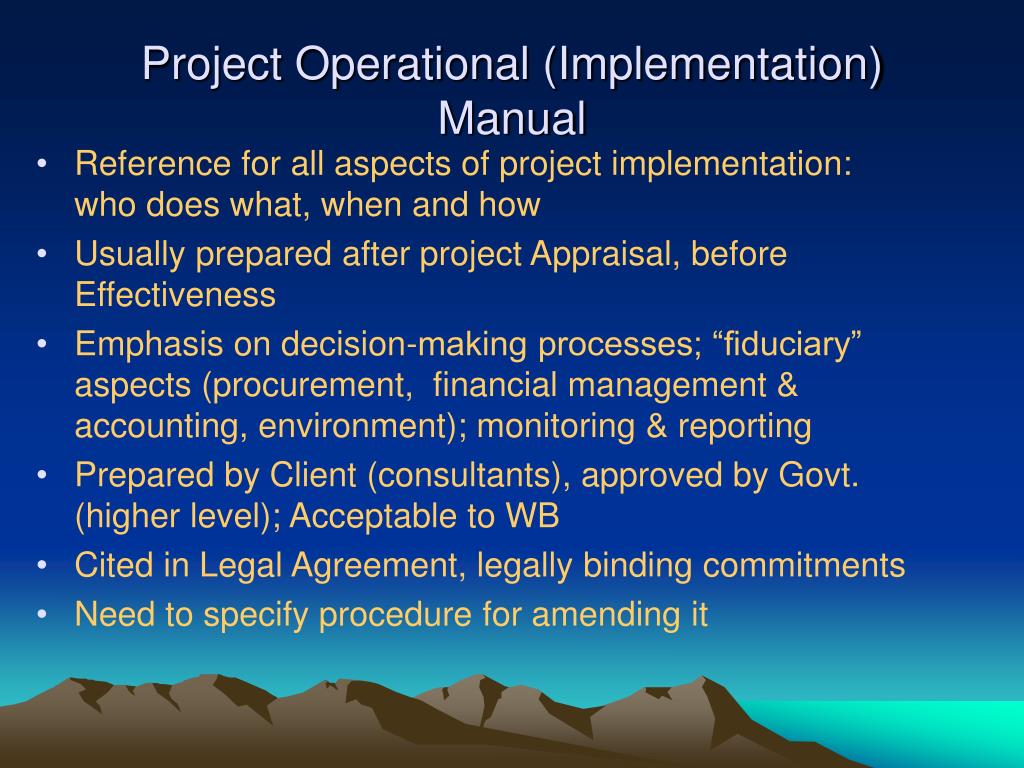

  2. Project Operational (Implementation) Manual • Reference for all aspects of project implementation: who does what, when and how • Usually prepared after project Appraisal, before Effectiveness • Emphasis on decision-making processes; “fiduciary” aspects (procurement, financial management & accounting, environment); monitoring & reporting • Prepared by Client (consultants), approved by Govt. (higher level); Acceptable to WB • Cited in Legal Agreement, legally binding commitments • Need to specify procedure for amending it

  3. Typical Contents of POM • Project objectives, description, components • Applicable laws, regulations, rules • Sub-project eligibility criteria (beneficiaries, locations, activities), or “Menu” of eligible projects • Sub-project application, evaluation, selection process • Institutional structures/responsibilities • Disbursement procedures (including for Sub-grants) • Procurement procedures • Financial management & accounting • Monitoring & Reporting (Table of Progress & Impact Indicators) • Annexes: • Work Plan (updated annually), • EMP or Environmental Guidelines • Application & Reporting formats, • Terms of Reference (PIU, major consultancies)

  4. Why Have a POM (PIM)? • Provides clear, detailed, definitive guidance and procedures for implementing the project – follow the rules & all will be well • Facilitates efficient project monitoring and supervision • Simplifies Legal Agreement (only one reference needed to cover all Client/WB agreements) • Provides continuity in case of staff changes

  5. Alternative Approaches for Integrating EMP into POM • EMP as a chapter of POM • EMP as an annex to POM • Elements of EMP inserted throughout POM where relevant • 1 & 3 or 2 & 3 Separate Chapter/Annex = easy reference “Pros” of each: Integrated = environment is fundamental, not an add-on; Not only Environmental Staff

  6. Example: Small Grants Programs

  7. General Description Provides small grants to individuals or groups for enterprise development (sub-projects) Typically based on applications, sometimes competitive Grants typically finance small works (rehabilitation, small-scale construction), equipment, inputs, TA Usually Category B (i.e., Category A sub-projects specifically excluded) Framework EA/EMP covering the whole project sets out procedures for site-specific EA/EMP for sub-projects

  8. Guidance from Project-level Environmental Framework • Eligibility criteria for sub-projects (positive and/or negative list) • Environmental Assessment screening criteria & procedures (e.g. A, B, C) and associated EA requirements • Procedures and responsibilities for preparation and approval of sub-project EAs and EMPs • Environmental issues and mitigation measures for different types of sub-project activities • including procurement and contract provisions • Monitoring & reporting requirements (EMP implementation) • Environmental impact indicators and monitoring

  9. Example: Croatia Conservation and Rural Revitalization Program • Program objective: demonstrate linkages between Protected Areas/biodiversity conservation and rural development (economic opportunities from sustainable use; awareness-raising and education) • Grant size:Euro 2,000 – 25,000

  10. (Written notification/explanation) Eligibility Screening of proposals Evaluation/selection of proposals Submission of proposals (3 rounds) Revisions (Assisted) preparation of applications Project approval Workshops for Applicants CCRRP sub-project cycle Agreement on work plan, contract signing Advertisement of program First tranche disbursement Final report & accounting Second tranche disbursement Progress report, accounting & verification

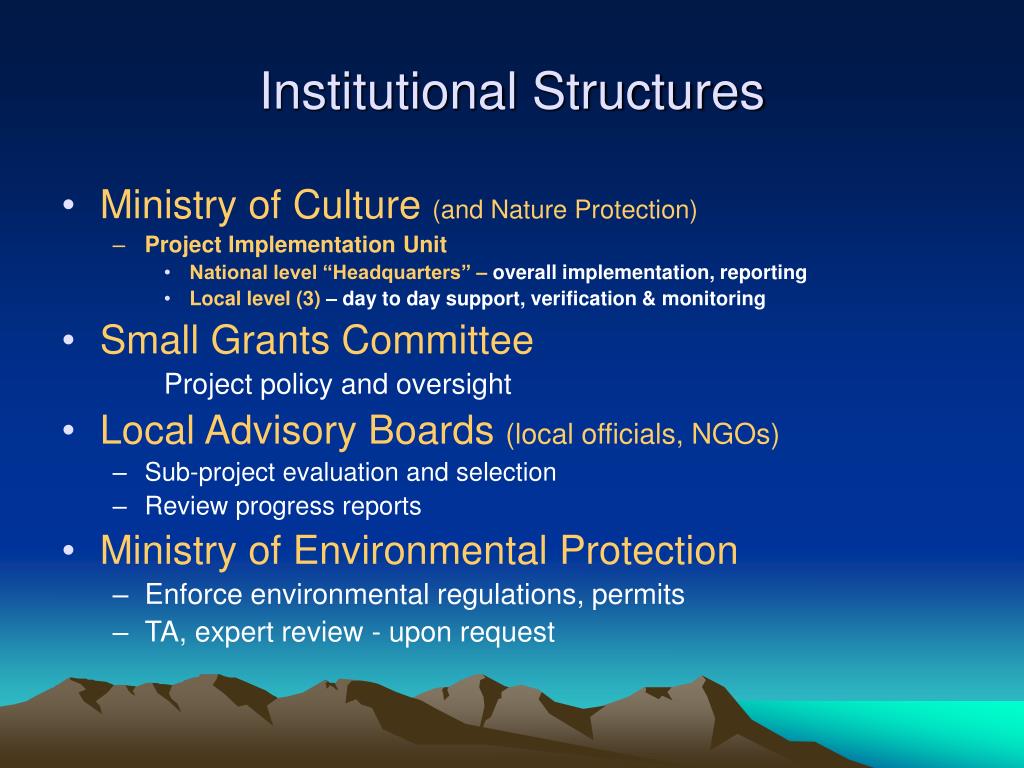

  11. Institutional Structures • Ministry of Culture(and Nature Protection) • Project Implementation Unit • National level “Headquarters” – overall implementation, reporting • Local level (3) – day to day support, verification & monitoring • Small Grants Committee Project policy and oversight • Local Advisory Boards (local officials, NGOs) • Sub-project evaluation and selection • Review progress reports • Ministry of Environmental Protection • Enforce environmental regulations, permits • TA, expert review - upon request

  12. CRRG Project Operational Manual Structure

  13. Incorporation of EMF in Procedures • Applicant training workshops: • environmental objectives; potential impacts and mitigation measures for different types of sub-projects • Preparation of applications: • - Environmental issues and mitigations identified in application form • Screening of proposals: • - LAB/MEP reviews eligibility of proposal, excluding any with high environmental risk • Proposal evaluation/selection…revisions, approval: • Environmental mitigations refined as required (Local Env. Authorities on LAB advise) and included in Implementation Plan • Agreement on Work Plan/ Signing of Sub-Project Contract with Recipient • Environmental mitigation measures included in Sub-project contract • Includes specific environmental provisions for procurement, contracting • Progress reporting/verification for second (and further tranche of funding • Environmental measures may be among triggers for disbursement; PIU verifies environmental measures implemented and are effective • Final report & accounting • includes EMP compliance, environmental indicators

  14. Common Problems in Implementing EMP in Small Grants Programs • Insufficient understanding or appreciation of issues on part of applicants; inadequate up-front education and advice • Insufficient use of environmental consultants for screening, EA, monitoring • Inadequate coverage of environmental responsibilities in beneficiary contracts • Inadequate coordination between environmental and procurement specialists in PIU • Monitoring only process and inputs rather than impacts; vague or unclear indicators and targets
