LEADER WP3 Conceptual Design Status. KIT Town Office Ostendorfhaus Weberstraße 5, Karlsruhe, 20-11 2012. Luigi Mansani Luigi.mansani@ann.ansaldo.it. WP3 Tasks. Task 3.1 - Reference plant configuration of a LFR ( ANSALDO , CIRTEN, EA, JRC-IE, SRS)
E N D
LEADER WP3 Conceptual Design Status KIT Town Office Ostendorfhaus Weberstraße 5, Karlsruhe, 20-11 2012 Luigi Mansani Luigi.mansani@ann.ansaldo.it
WP3 Tasks Task 3.1 - Reference plant configuration of a LFR (ANSALDO, CIRTEN, EA, JRC-IE, SRS) Task 3.2 - SG damping pressure waves system design (MERIVUS, CIRTEN, ENEA) Task 3.3 - Primary system conceptual design of the ETDR (SCK•CEN, ANSALDO, EA, SRS) Task 3.4 - Secondary system conceptual design of the ETDR (EA, ANSALDO) Task 3.5 - DHR system conceptual design of the ETDR (ANSALDO, SCK•CEN) Task 3.6 - Plant layout of the ETDR (EA, ANSALDO) Task 3.7 - Feasibility study of the flat-spiral-tube bundle steam generator with integrated primary pump (MERIVUS)
Task 3.1 Status Design changes of the ELSY configuration identified ELFR configuration defined and used as a reference for ALFRED Contractual deliverable D03 “Review and justification of the main design options of the LFR reference plant” issued The following Mechanical Drawings have been issued: LEADER 31 DMBX 024 Rev. 0 Reactor Block General Assembly LEADER 31 DMBX 025 Rev. 0 Fuel assembly outline LEADER 31 DMBX 026 Rev. 0 Inner vessel outline LEADER 31 DMBX 008 Rev. 0 Core lower grid outline LEADER 31 DMBX 009 Rev. 0 Core upper grid outline LEADER 31 DMBX 027 Rev. 0 Reactor vessel outline LEADER 31 DMBX 028 Rev. 0 Reactor cover outline LEADER 31 DMBX 029 Rev. 0 Steam generator outline LEADER 31 DMBX 030Rev. 0 Vessel support outline LEADER 31 DMBX 023 Rev. 0 DHR deep cooler outline Technical DOC T51 has been included and merged in D03 Contractual deliverable D31 ELFR Summary Report to be issued at M36
Task3.2: Status of the activity • Task Accomplished • T52 - Conceptual design of the SG damping pressure wave system and test mock-up has been issued
Task 3.3: Status Design changes of the ELSY configuration identified ALFRED configuration (300 MWth) defined The following Mechanical Drawings have been issued: LEADER 33 DMBX 013 Rev 0 Reactor Block General Assembly LEADER 33 DMMX 014 Rev 0 Fuel assembly outline LEADER 33 DMMX 015 Rev 0 Inner vessel outline LEADER 33 DMMX 016 Rev 0 Core lower grid outline LEADER 33 DMMX 017 Rev 0 Core upper grid outline LEADER 33 DMMX 018 Rev 0 Reactor vessel outline LEADER 33 DMMX 019 Rev 0 Reactor cover outline LEADER 33 DMMX 020_001 Rev 0 Steam generator outline LEADER 33 DMMX 020_002 Rev 0 Steam generator outline LEADER 33 DMMX 021 Rev 0 Vessel support outline LEADER 35 DMBX 036 Rev 0 Isolation Condenser outline Technical document T57 drafted Contractual deliverable D32 (Summary Report) and Technical document T66 /Main components thermo-mechanical sizing) to be issued at M36

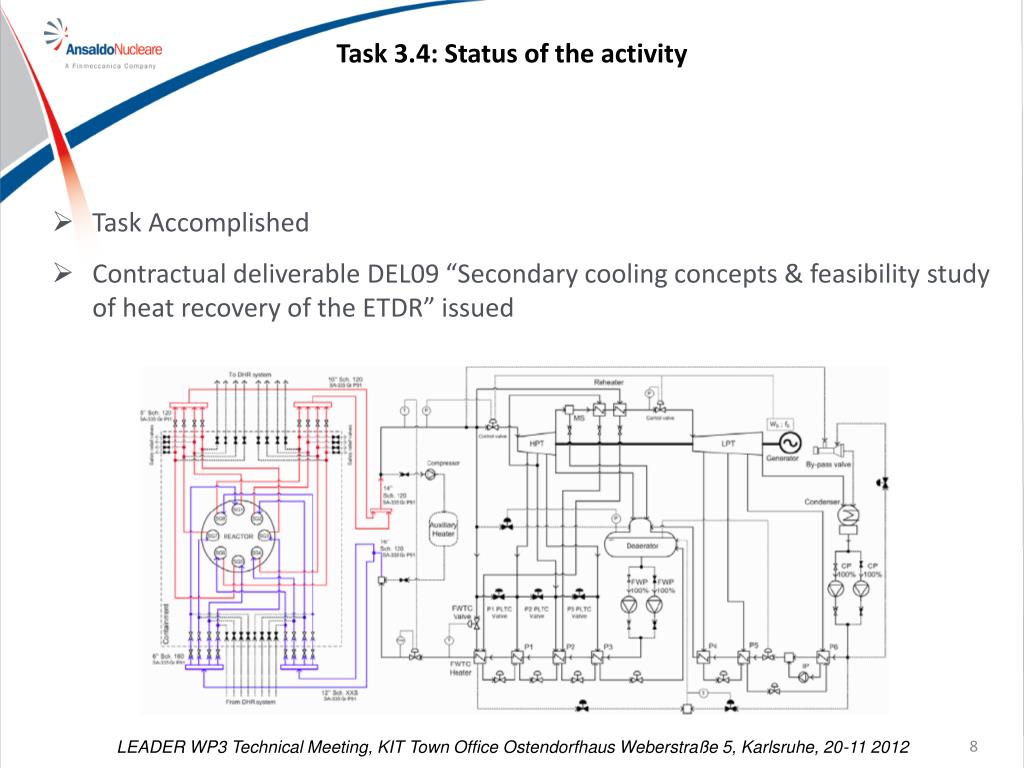

Task 3.4: Status of the activity • Task Accomplished • Contractual deliverable DEL09 “Secondary cooling concepts & feasibility study of heat recovery of the ETDR” issued
Task Accomplished Contractual deliverable DEL10 “Conceptual design of the DHR system of the ETDR (ALFRED)” issued Task 3.5: Status of the activity
Technical document T53 “Seismic Response Spectra of the Reactor building of the ETDR (ALFRED) to be issued at M18 Contractual deliverable D13 “Plant layout and description of the containment system of the ETDR (ALFRED)” to be issued M30 Task 3.6: Status of the activity
The new partner M.E.Rivus is now officially in the project New task “Feasibility study of the flat-spiral-tube bundle steam generator with integrated primary pump” in-kind to MERivus has been added to the project Contractual deliverable D39 “Feasibility study of the flat-spiral-tube bundle steam generator with integrated primary pump” to be issued at M36 Task 3.7: Status of the activity

WP3 Milestone & Planning Completed Completed Completed November 2012
