1 / 4

CUSTOMER BILLING CYCLE

High-Level Overview of SCE Data Validation Process. RQMD available for previous billing cycle. Day-after Green Button data retrieved during the billing cycle is not RQMD. 2. 3. 4. 5. 6. 7. 8. 9. 10. 11. 12. 13. 14. 15. 16. 17. 18. 19. 20. 21. 22. 23. 24. 25. 26. 27.

thy
Télécharger la présentation

CUSTOMER BILLING CYCLE

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

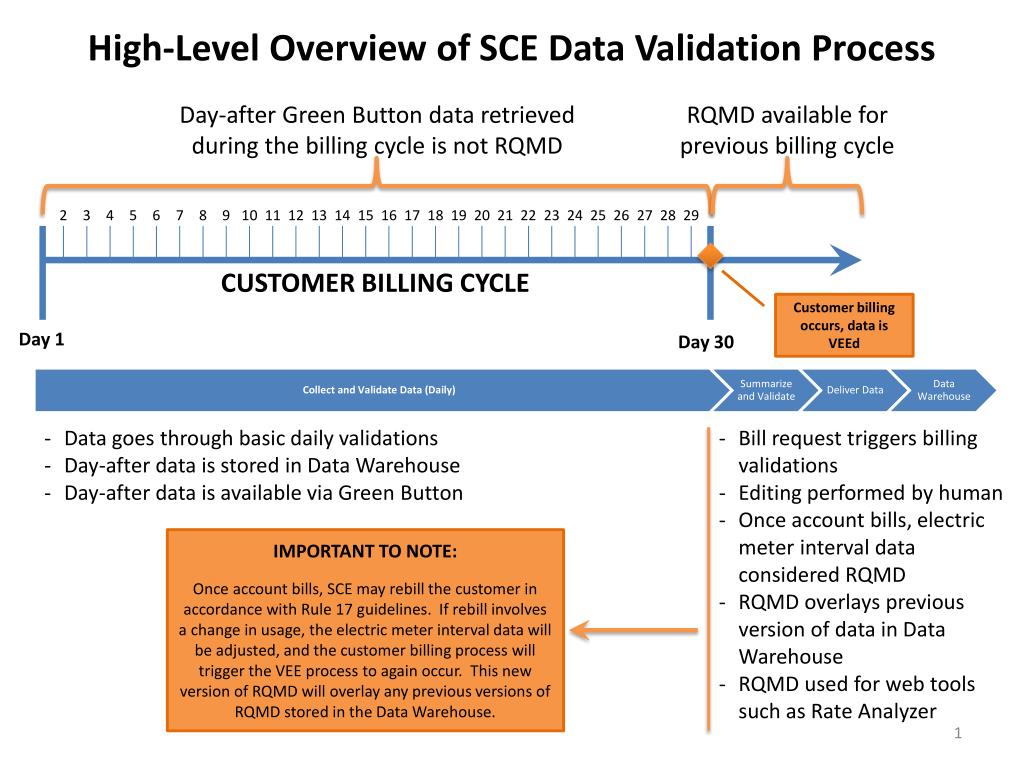

  1. High-Level Overview of SCE Data Validation Process RQMD available for previous billing cycle Day-after Green Button data retrieved during the billing cycle is not RQMD 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 CUSTOMER BILLING CYCLE Customer billing occurs, data is VEEd Day 1 Day 30 • Data goes through basic daily validations • Day-after data is stored in Data Warehouse • Day-after data is available via Green Button • Bill request triggers billing validations • Editing performed by human • Once account bills, electric meter interval data considered RQMD • RQMD overlays previous version of data in Data Warehouse • RQMD used for web tools such as Rate Analyzer IMPORTANT TO NOTE: Once account bills, SCE may rebill the customer in accordance with Rule 17 guidelines. If rebill involves a change in usage, the electric meter interval data will be adjusted, and the customer billing process will trigger the VEE process to again occur. This new version of RQMD will overlay any previous versions of RQMD stored in the Data Warehouse.

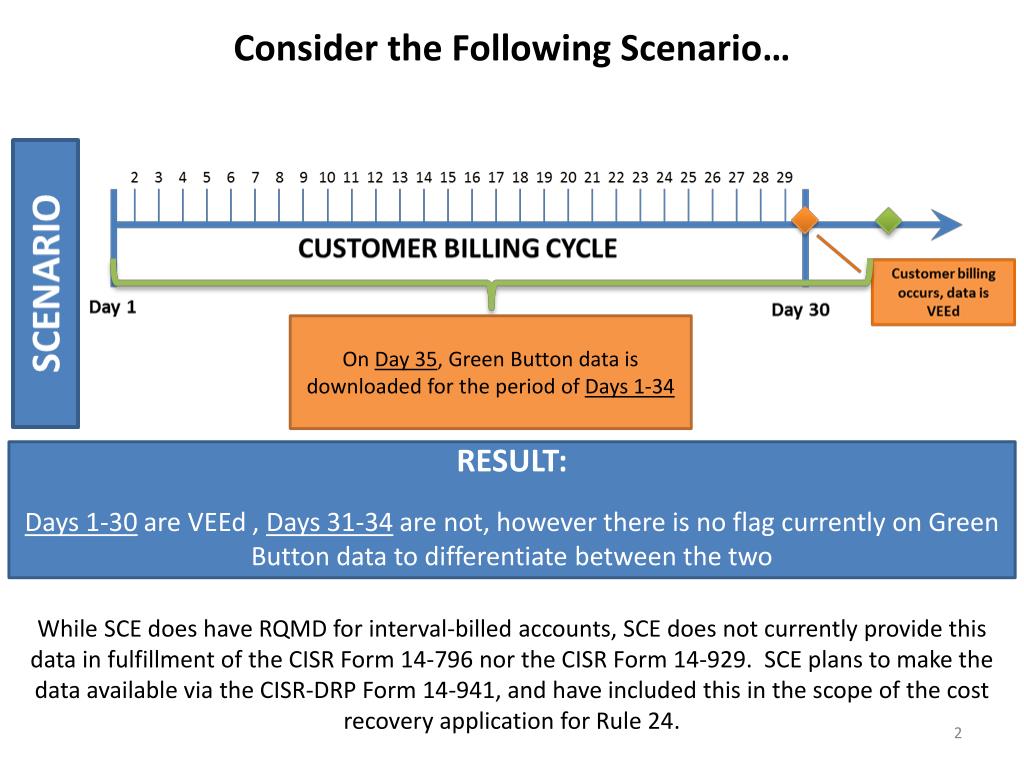

  2. Consider the Following Scenario… On Day 35, Green Button data is downloaded for the period of Days 1-34 RESULT: Days 1-30 are VEEd , Days 31-34 are not, however there is no flag currently on Green Button data to differentiate between the two While SCE does have RQMD for interval-billed accounts, SCE does not currently provide this data in fulfillment of the CISR Form 14-796 nor the CISR Form 14-929. SCE plans to make the data available via the CISR-DRP Form 14-941, and have included this in the scope of the cost recovery application for Rule 24.

  3. CISR-DRP Fulfillment Options SCENARIO: CISR-DRP is submitted after Rule 24 application approval and prior to implementation of system automation • SCE can fulfill the data points which are currently offered under the existing CISR Forms, including: • A.1.1: Up to 1 year of historical electric meter interval data (equivalent to Option 5 of the CISR Form 14-796 or to CISR Form 14-929) • B.2: Billing history and all electric meter usage data for bill calculation for all my account(s), as specified herein, regarding electric utility services furnished by the Utility (equivalent to Option 1 of the CISR Form 14-796) • C.2: Access to next day electric meter interval data (equivalent to CISR Form 14-929)

  4. CISR-DRP Fulfillment Options – CONT’D SCENARIO: CISR-DRP is submitted after Rule 24 application approval and after implementation of system automation • SCE can fulfill all data points listed on the CISR-DRP Form 14-941 via ESPI or other electronic means, including: • Service account number and address, rate schedule, read cycle • Service voltage, meter number and type, subLAP, pNode • Identity of MDMA, MSP, LSE • 12 months of historical Revenue Quality Meter Data (RQMD) (15-minute intervals for non-residential customers and hourly intervals for residential customers) • SCE Demand Response programs currently enrolled and termination date • 12 months of billed usage data • DEPENDENCIES • CPUC approval of Rule 24 application orCPUC directive to commence efforts in support of Rule 24 project, per approach outlined in SCE’s cost recovery application • SCE implementation of ESPI (slated for November 2014), if deemed to be the method of transmitting data to 3rd Party DRP
