Understanding the performance of the Post Office is crucial. This document analyzes key metrics, including the significant minus balance of over 500 crores and its resolution. As of May 18, 2012, 15% of the minus balance remains unsettled, with over 1.8 lakh SBCO objections pending. The report highlights progress on settlements, percentages of unresolved issues, and circles with improvement in reducing objections. Using the provided data migration parameters, we can monitor, communicate, and expedite resolution in a systematic manner.
E N D
It’s always better to measure But what to measure?
How to resolve issues? Please see the document – Data Migration parameters in the link provided below: Data Migration – Parameters – Version – I https://docs.google.com/open?id=0B3Q6alJgyHknWjdESGJ5aFczdWs
It’s always better to measure But how to understand whether the Post Office is performing well or not in all parameters?

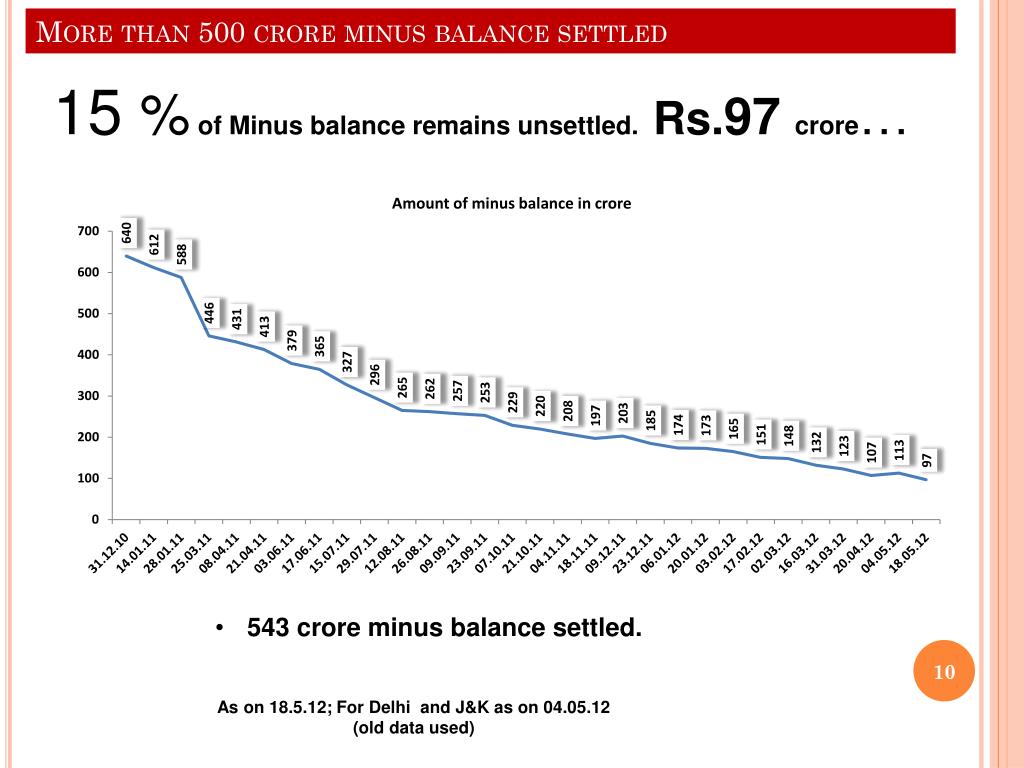

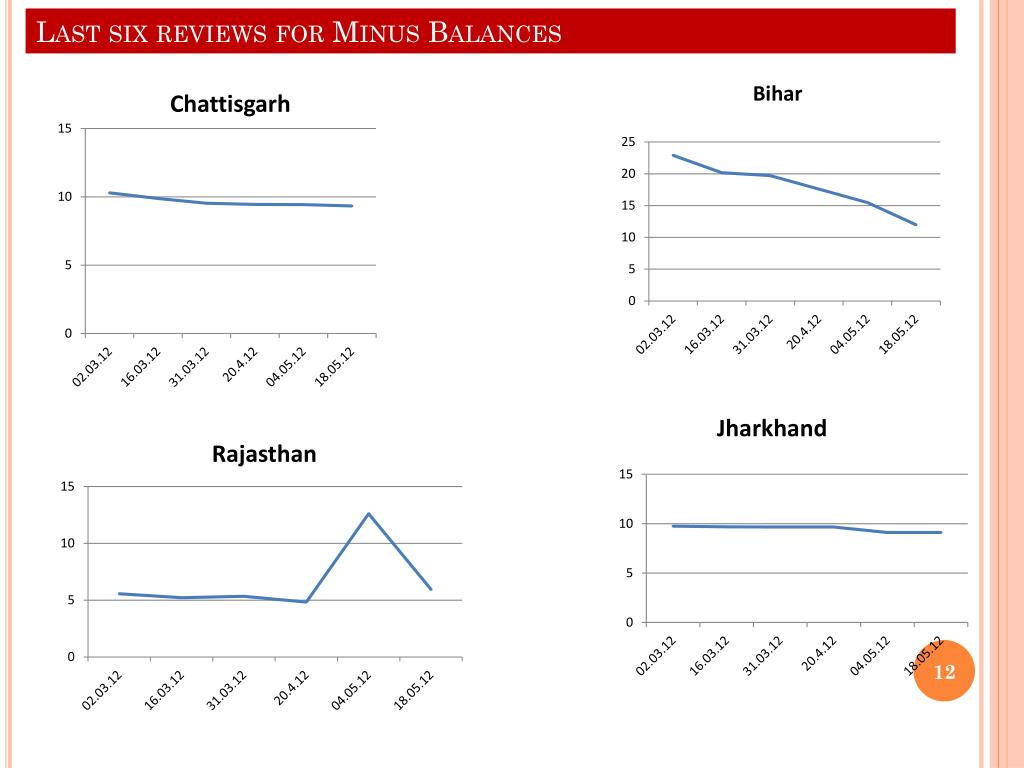

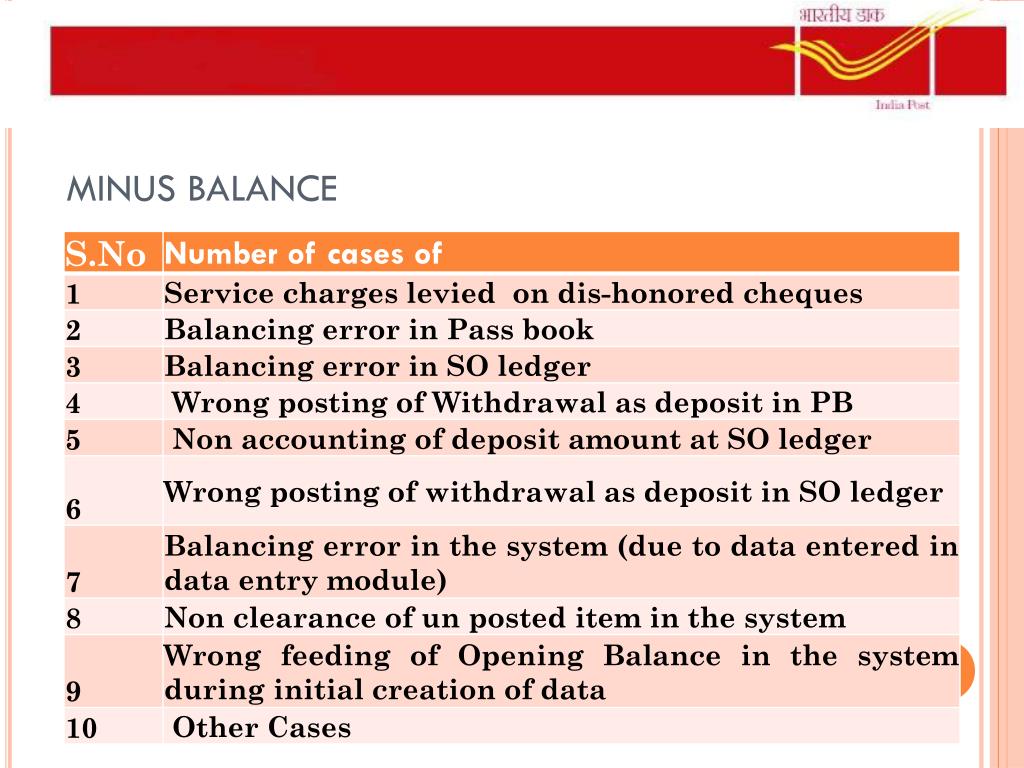

More than 500 crore minus balance settled 15 %of Minus balance remains unsettled. Rs.97crore… • 543 crore minus balance settled. As on 18.5.12; For Delhi and J&K as on 04.05.12 (old data used)

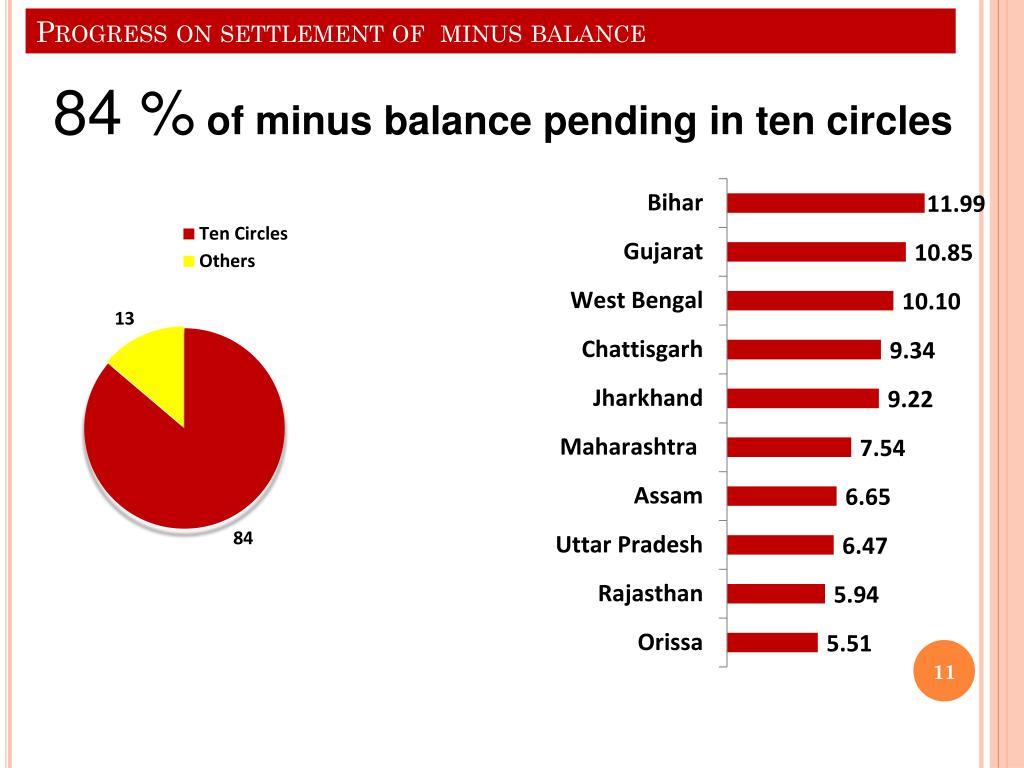

Progress on settlement of minus balance 84 %of minus balance pending in ten circles

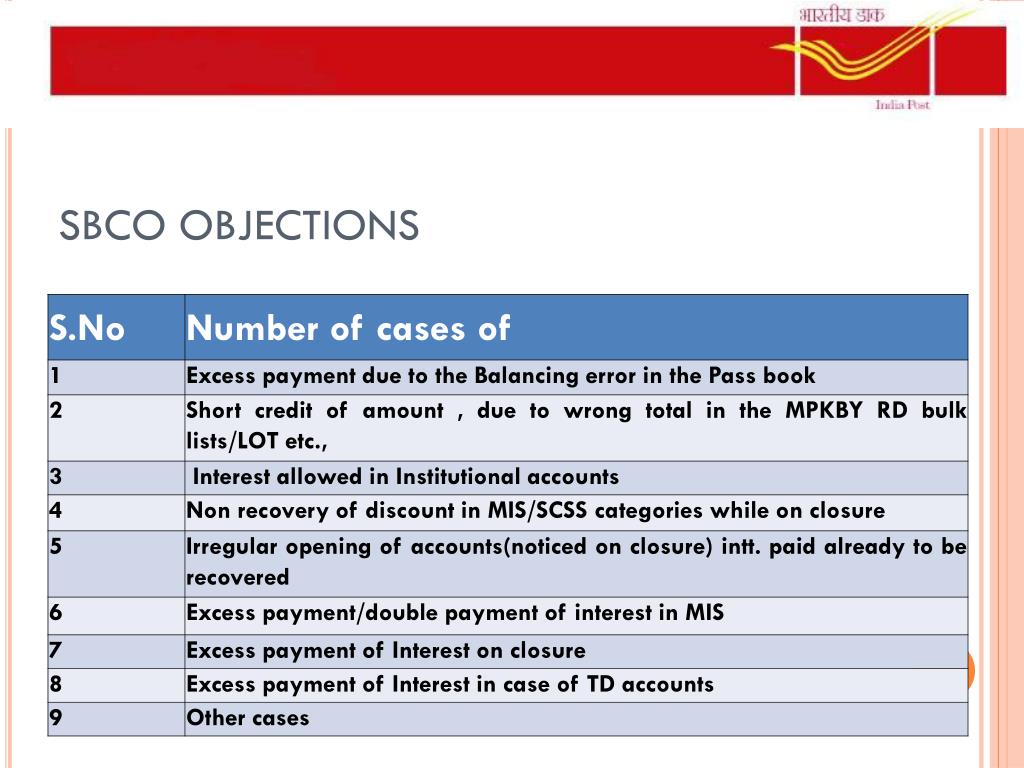

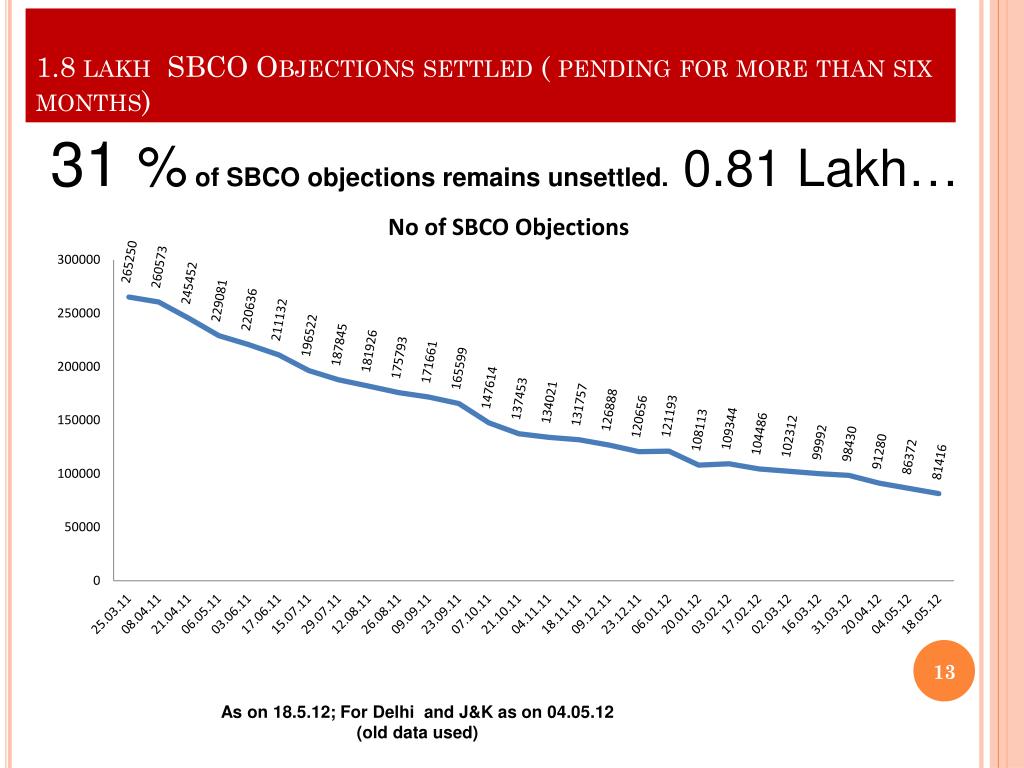

1.8 lakh SBCO Objections settled ( pending for more than six months) 31 %of SBCO objections remains unsettled. 0.81 Lakh… As on 18.5.12; For Delhi and J&K as on 04.05.12 (old data used)
Status of SBCO objections Circles with more than 50 % reduction in SBCO objections from 25.03.11
Status of SBCO objections Circles with less than 50 % reduction in SBCO Objections from 25.03.11

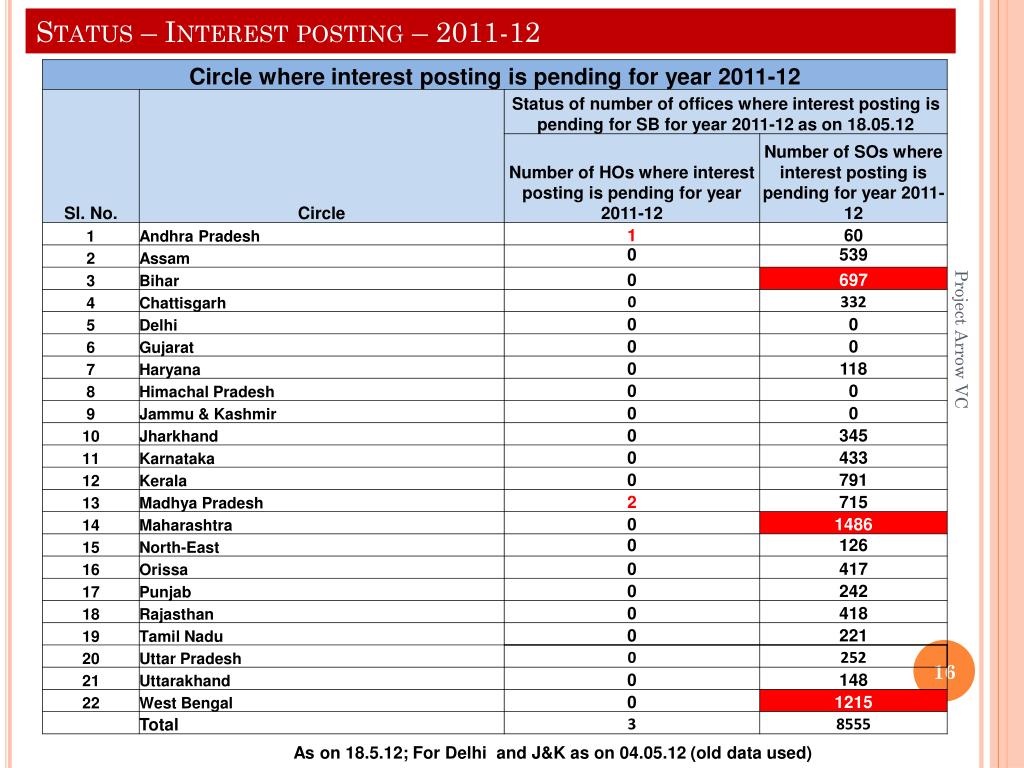

Status – Interest posting – 2011-12 Project Arrow VC As on 18.5.12; For Delhi and J&K as on 04.05.12 (old data used)
Offices not reported everyday for the period 14.05.12 to 19.05.12

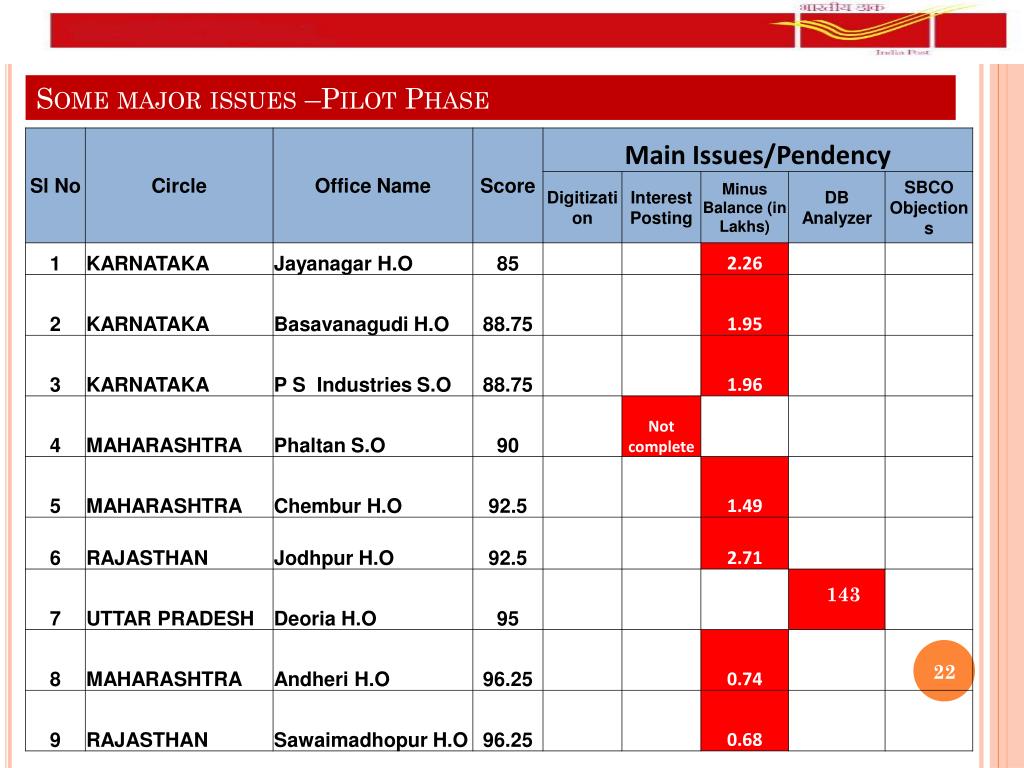

Score wise classification – Pilot Phase • 9 offices having less than 100 score.

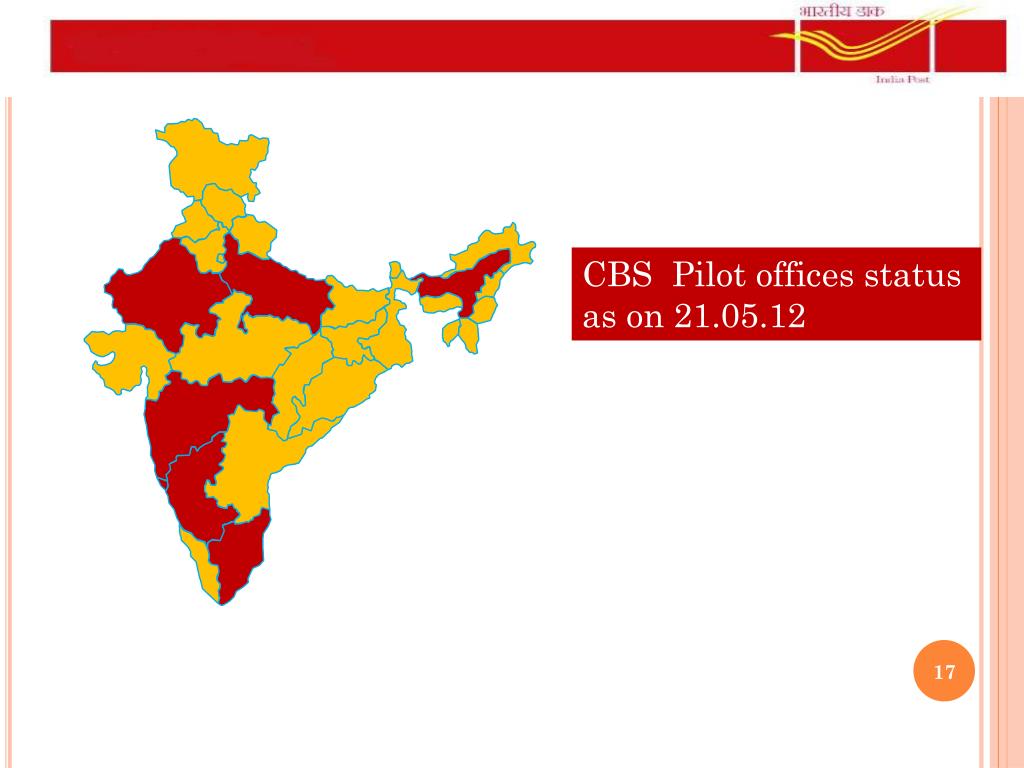

Monitoring of Phase I A Offices CBS Phase 1 A offices status as on 21.05.12
Phase 1A Offices not reported everyday for the period 14.05.12 to 19.05.12

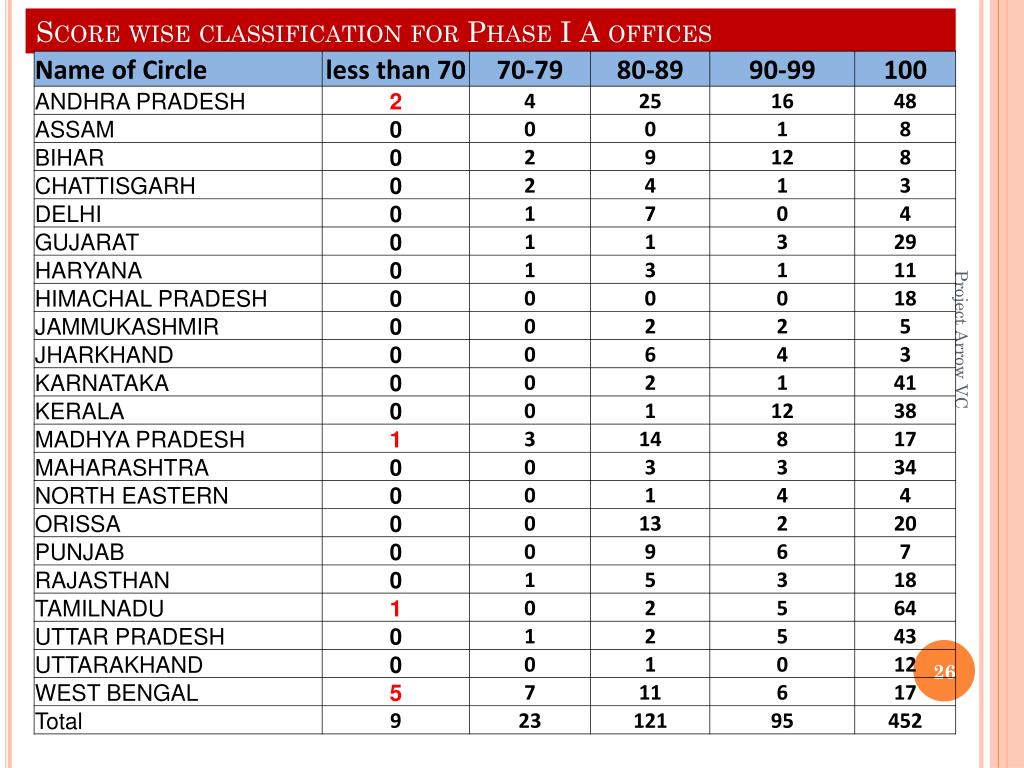

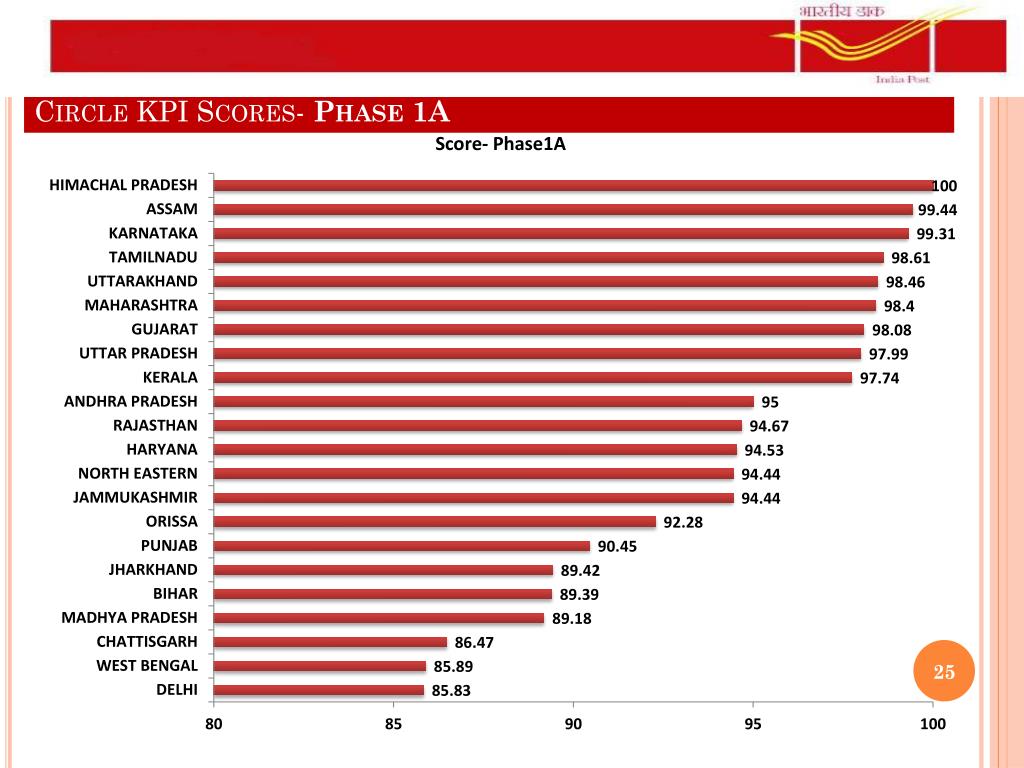

Score wise classification for Phase I A offices Project Arrow VC
Phase I A Offices having less than 70 scores- Details of pending issues

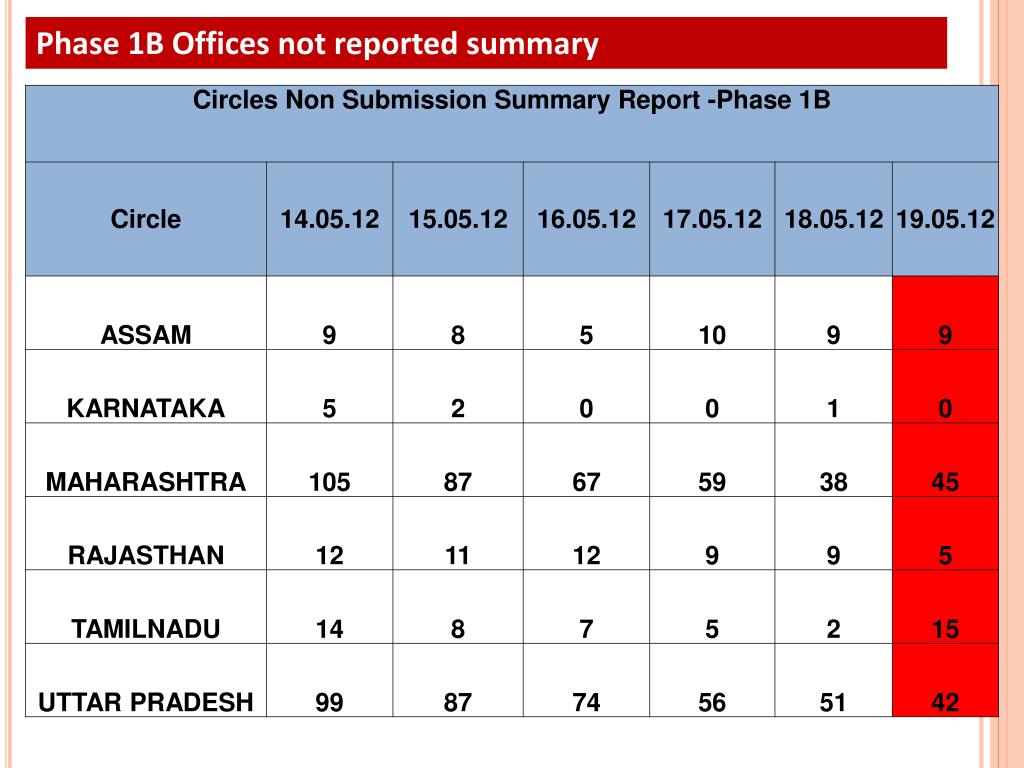

Phase 1B Offices not reported summary Project Arrow VC

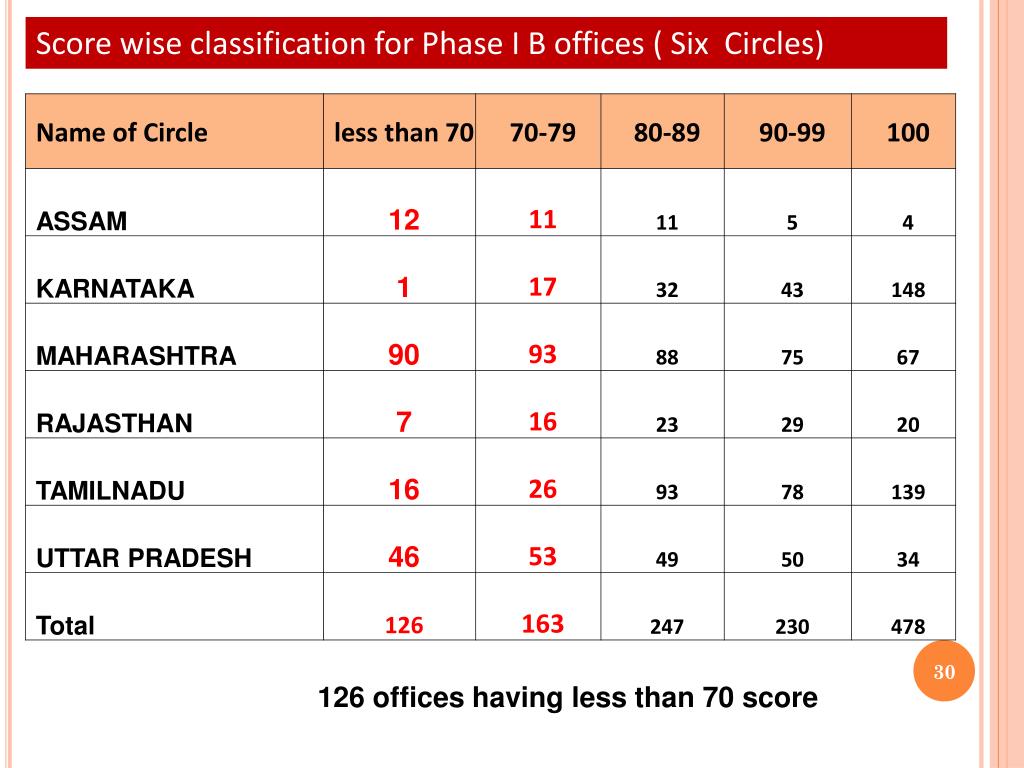

Score wise classification for Phase I B offices ( Six Circles) 126 offices having less than 70 score
135 offices visited by NISG Project Managers/Project Executives Deviations noticed in 65 offices
Role of ASPs/IPs • Create a sense of urgency • Communicate • Coordinate • Guide and train
