EMR Construction Status. Jean-Sebastien Graulich, Geneva. General Design Electronics Cosmics test. EMR General Design. EMR: Electron Muon Ranger EMR is needed to supplement KL for Downstream PID ( m /e separation) EMR is a ~1 tone Fully Active Scintillator Detector: 0.8x1x1 m 3
E N D
EMR Construction Status Jean-Sebastien Graulich, Geneva • General Design • Electronics • Cosmics test
EMR General Design • EMR: Electron Muon Ranger • EMR is needed to supplement KL for Downstream PID (m/e separation) • EMR is a ~1 tone Fully Active Scintillator Detector: • 0.8x1x1 m3 • highly segmented in x, y and z • In addition to PID, it’s able to measure the muon momentum with a resolution of 2.5 MeV/c • much better than the spectrometer at low pT • For detailed description, refer to Frank’s talk at last VC
http://indico.cern.ch/getFile.py/access?contribId=28&sessionId=3&resId=0&materialId=slides&confId=69027http://indico.cern.ch/getFile.py/access?contribId=28&sessionId=3&resId=0&materialId=slides&confId=69027 Daniela Lietti CM25

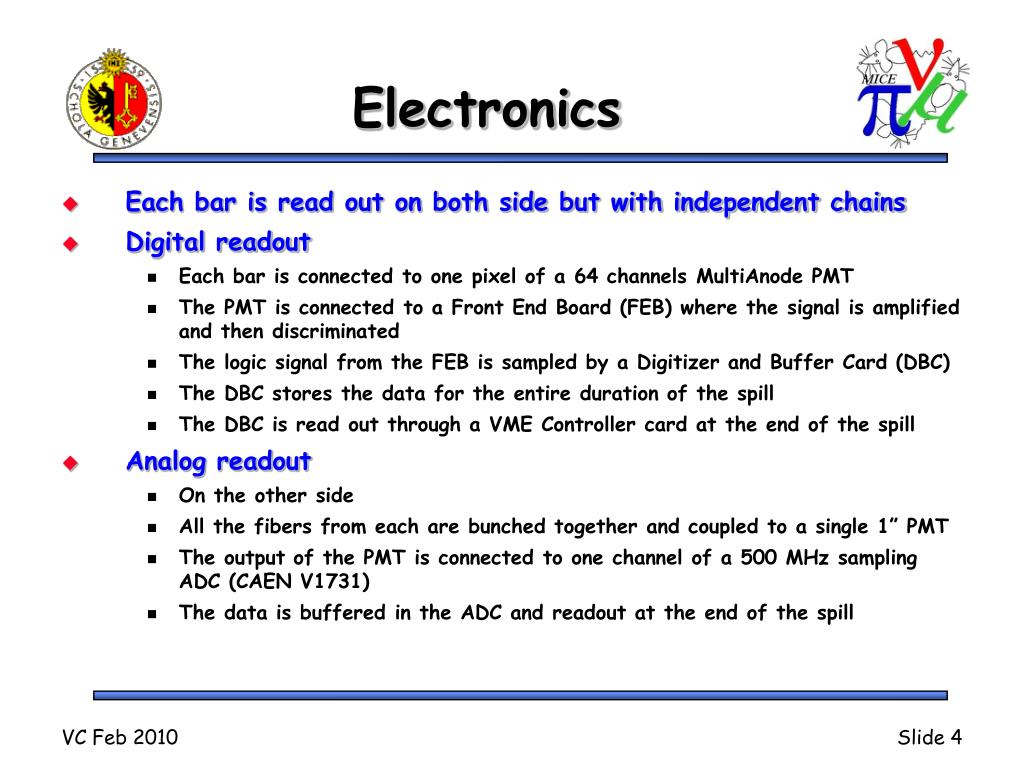

Electronics • Each bar is read out on both side but with independent chains • Digital readout • Each bar is connected to one pixel of a 64 channels MultiAnode PMT • The PMT is connected to a Front End Board (FEB) where the signal is amplified and then discriminated • The logic signal from the FEB is sampled by a Digitizer and Buffer Card (DBC) • The DBC stores the data for the entire duration of the spill • The DBC is read out through a VME Controller card at the end of the spill • Analog readout • On the other side • All the fibers from each are bunched together and coupled to a single 1” PMT • The output of the PMT is connected to one channel of a 500 MHz sampling ADC (CAEN V1731) • The data is buffered in the ADC and readout at the end of the spill
Electronics Status • FEB • Designed and produced by Trieste/Como • Based on existing FEB for another experiment (ASACUSA@CERN AD) • Recently modified and tested to use the MAROC amplifier/discriminator chip (instead of Gamma Medica/Ideas VA64TAP) • Digitizer and Buffer Card • Design in progress in Geneva • VME Controller • Based on general purpose VME board provided by Trieste/Como • Clock and Trigger distribution • Under discussion • Sampling ADCs • In hand in Geneva
Cosmics Test • One full module (2 layers) operational in Geneva • DAQ provided by Como/Trieste • Many Thanks to Daniela Lietti and Davide Bolognini 2 EMR Layers Trigger Scintillator 10x10 cm2 2 X-Y Silicon stripdetectors 10x10 cm2
The first EMR Module FEB (old design) FEB X Single anode PMT All fibers bunched Y
Analysis – Prerequisite • Using the prototype Front-End Board based on the VA64TAP chip • Need to scan the sampling time to determine our working point
Tracking • Selecting single events in the Si-Array, the track are extrapolated to the EMR position • -> Residuals look OK • Strong evidence for cross talk (for this prototype we use of 2 x 0.8 mm fibers instead of a single 1.2 mm fiber) Neighbor channels on the fiber mask

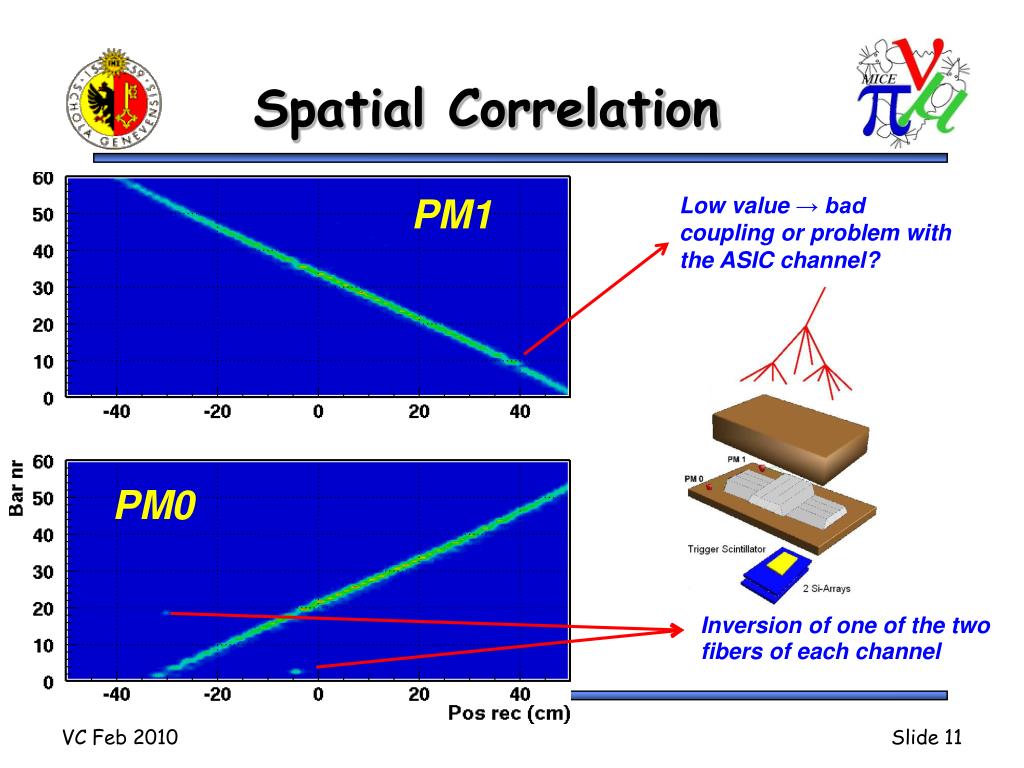

Spatial Correlation PM1 Low value → bad coupling or problem with the ASIC channel? PM0 Inversion of one of the two fibers of each channel

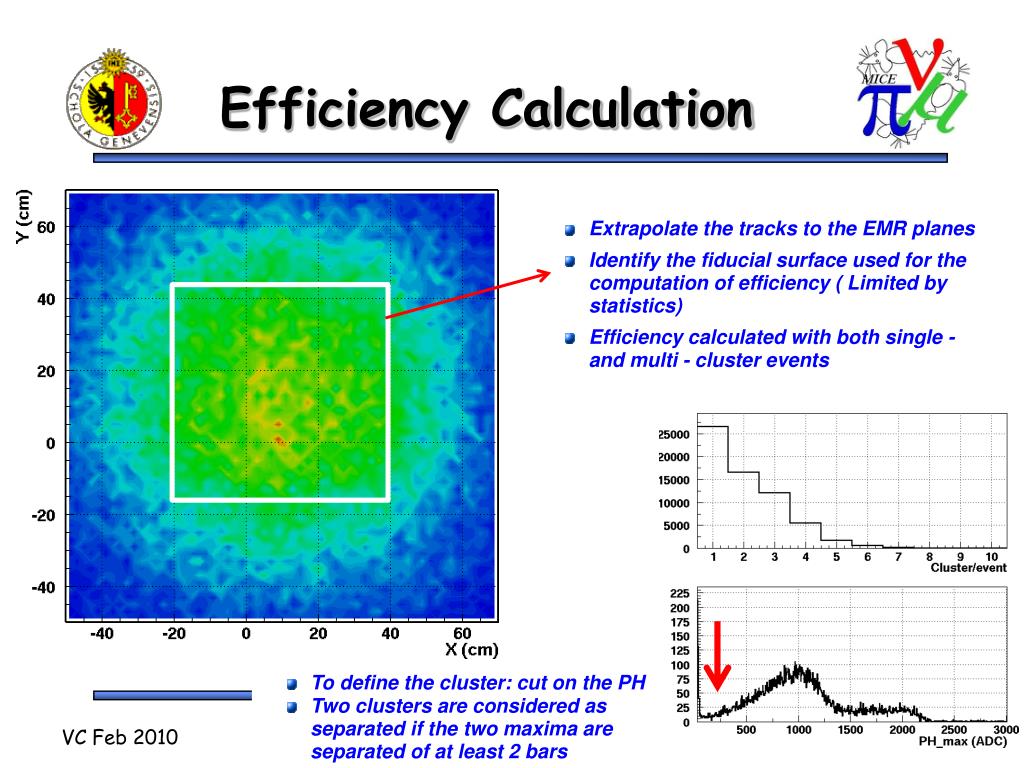

Efficiency Calculation • Extrapolate the tracks to the EMR planes • Identify the fiducial surface used for the computation of efficiency ( Limited by statistics) • Efficiency calculated with both single -and multi - cluster events • To define the cluster: cut on the PH • Two clusters are considered as separated if the two maxima are separated of at least 2 bars
Measured Efficiency PM0 PM1 ACROSS THE BARS AVERAGE ALONG THE BAR

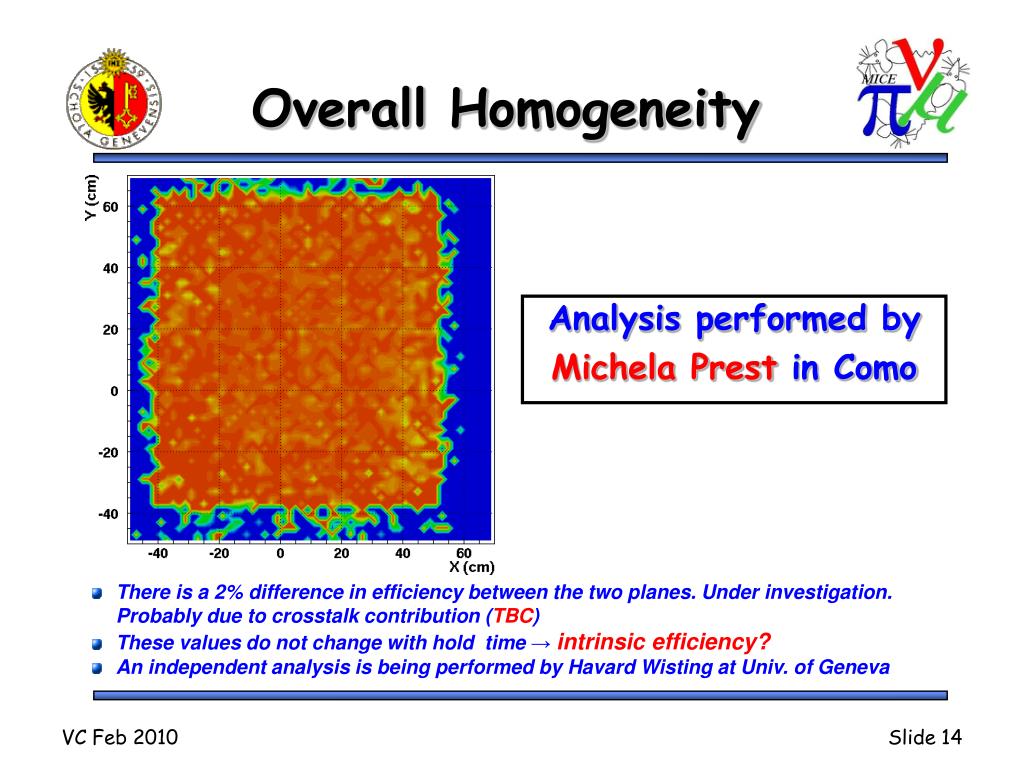

Overall Homogeneity Analysis performed by Michela Prest in Como • There is a 2% difference in efficiency between the two planes. Under investigation. Probably due to crosstalk contribution (TBC) • These values do not change with hold time → intrinsic efficiency? • An independent analysis is being performed by Havard Wisting at Univ. of Geneva
Cosmics test Summary • Currently taking data at about 3 Hz • Preliminary average efficiency is 93.5 % • Next Steps • Integrate the single PMT readout in the DAQ • Need to migrate from SBS Bit3 to CAEN VME-PCi interface first • Refine Efficiency Measurement • Optical grease for better optical connection • Green Enhanced MA-PMTs • Test flex connectors needed for final assembly • Define test procedure for QA during production

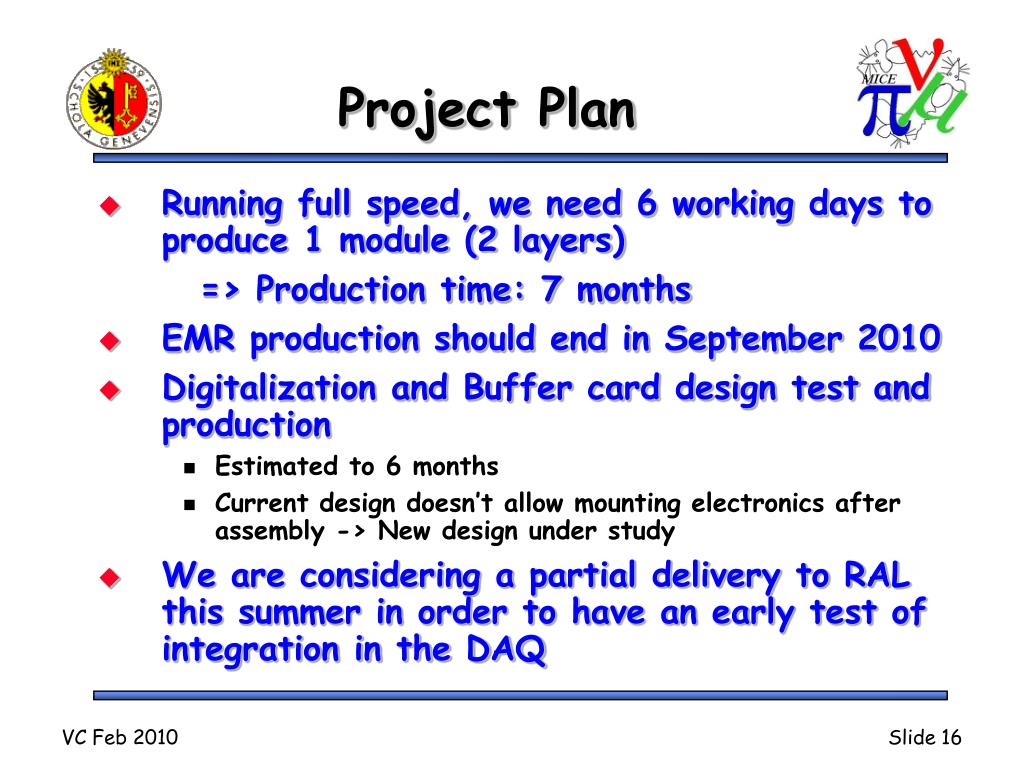

Project Plan • Running full speed, we need 6 working days to produce 1 module (2 layers) => Production time: 7 months • EMR production should end in September 2010 • Digitalization and Buffer card design test and production • Estimated to 6 months • Current design doesn’t allow mounting electronics after assembly -> New design under study • We are considering a partial delivery to RAL this summer in order to have an early test of integration in the DAQ
