Cement waste matrix evaluation and modelling of the long-term stability of cementitious waste matrices. Project Concrete and Clay. Lisa Almkvist and Börje Torstenfelt Swedish Nuclear Fuel and Waste Management Co (SKB) Peter Cronstrand Vattenfall Power Consultant (VPC). Background Aim
E N D
Cement waste matrix evaluation and modelling of the long-term stability of cementitious waste matrices
Project Concrete and Clay Lisa Almkvist and Börje Torstenfelt Swedish Nuclear Fuel and Waste Management Co (SKB) Peter Cronstrand Vattenfall Power Consultant (VPC)
Background • Aim • Modelling • Long term experiments • Laboratory experiments
Background • KBS-3 cement during the construction phase • Degradation affects the ground water – affects the buffer material (bentonite)
Background • SFR, SFL cement is used as a barrier • Degradation rate and factors that affects
Aim • Cement’s properties - time • Cement – bentonite • pH information… • Describing the barriers • Development low-pH cement KBS-3 • Safety analysis – KBS-3, SFR, SFL

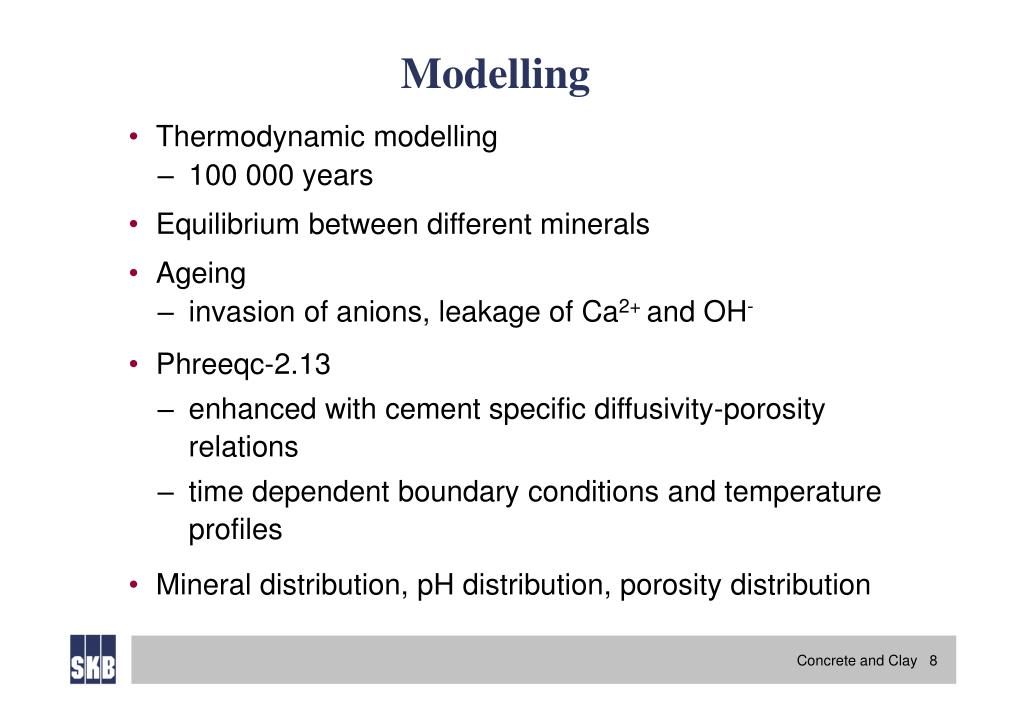

Modelling • Thermodynamic modelling • 100 000 years • Equilibrium between different minerals • Ageing • invasion of anions, leakage of Ca2+ and OH- • Phreeqc-2.13 • enhanced with cement specific diffusivity-porosity relations • time dependent boundary conditions and temperature profiles • Mineral distribution, pH distribution, porosity distribution
Long term experiment • Long time perspective • Boundary conditions – realistic conditions • Set recipe for the cement • OPC, sulphate resistant, low-pH cement • Phase I: Installation • Holes in the rock with cement pillars • Phase II: Operation & Maintenance • Phase III: Analysis • ~ 2012 … 2045
Labscale tests Ringhals Temperature changing cabinet Compressive and bending strength Curing time Fluidity Shrinkage

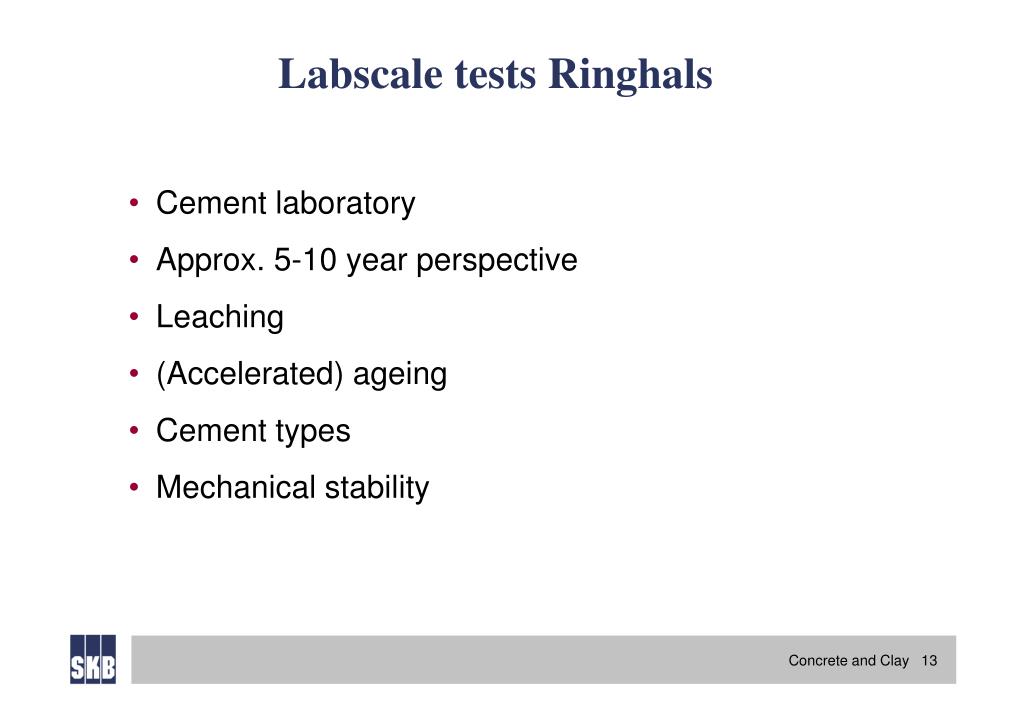

Labscale tests Ringhals • Cement laboratory • Approx. 5-10 year perspective • Leaching • (Accelerated) ageing • Cement types • Mechanical stability

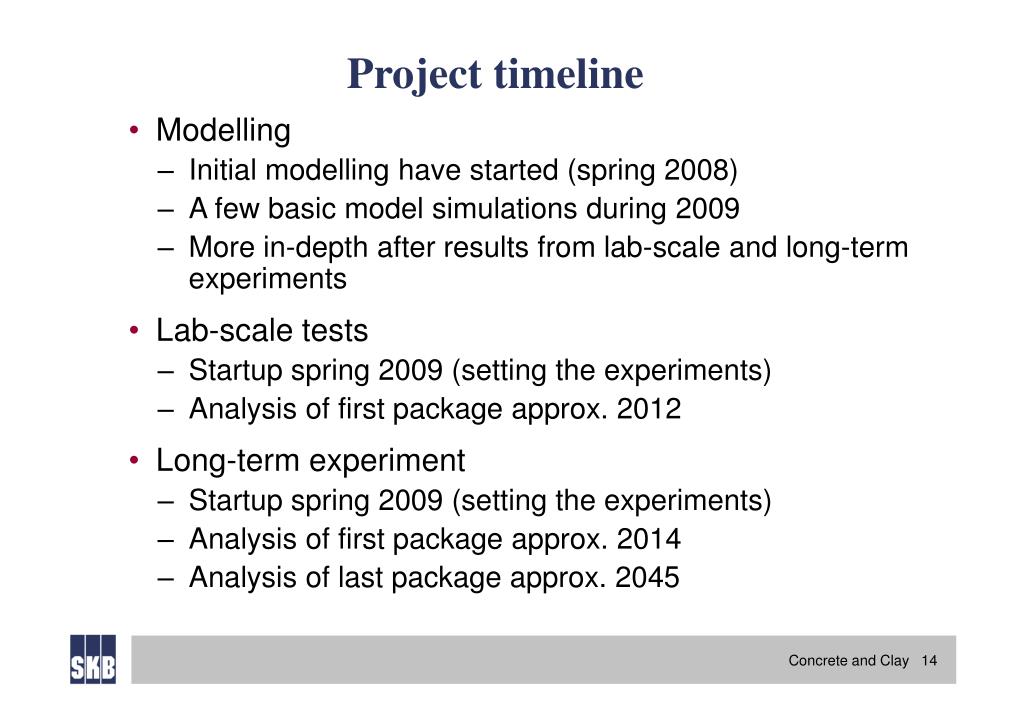

Project timeline • Modelling • Initial modelling have started (spring 2008) • A few basic model simulations during 2009 • More in-depth after results from lab-scale and long-term experiments • Lab-scale tests • Startup spring 2009 (setting the experiments) • Analysis of first package approx. 2012 • Long-term experiment • Startup spring 2009 (setting the experiments) • Analysis of first package approx. 2014 • Analysis of last package approx. 2045
