130 likes | 344 Vues
CIP Tracking System. Jim Broome, PE Chief Engineer. Existing CIP Database. Existing Capital Improvement Program (CIP) Database. Developed in-house in the late 1990’s to replace spreadsheet budgeting Project information manually input by project managers
E N D
CIP Tracking System Jim Broome, PE Chief Engineer

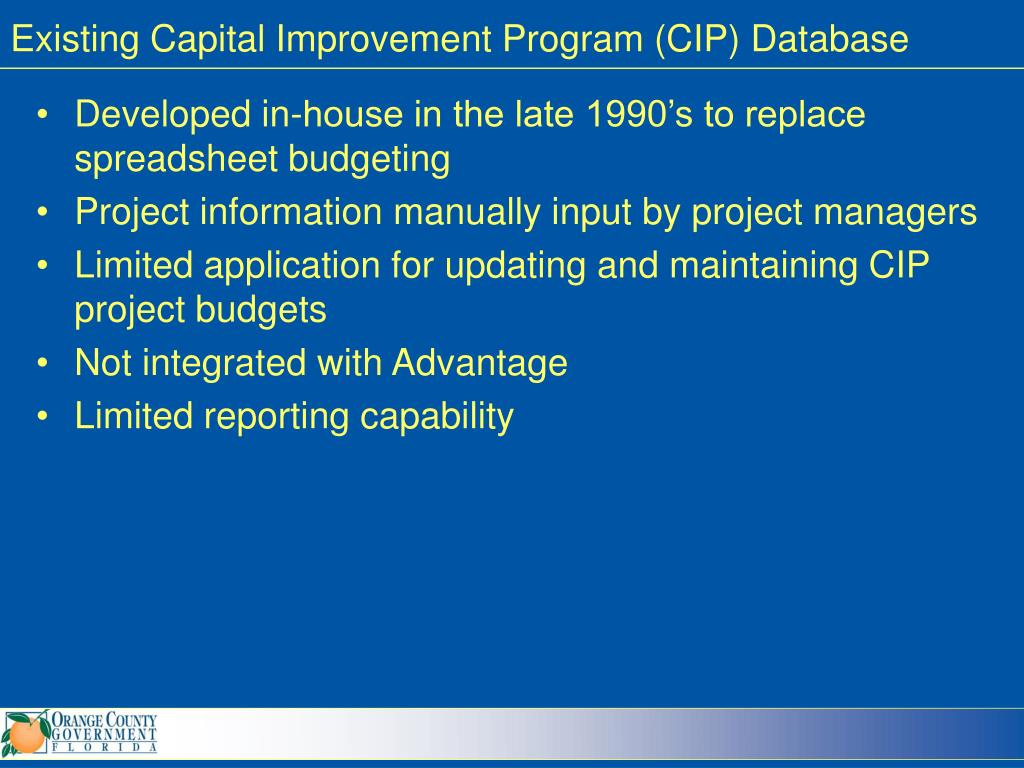

Existing Capital Improvement Program (CIP) Database • Developed in-house in the late 1990’s to replace spreadsheet budgeting • Project information manually input by project managers • Limited application for updating and maintaining CIP project budgets • Not integrated with Advantage • Limited reporting capability
Key Drivers for System Replacement • CIP and performance reporting • Project prioritization and tracking • Managing program at portfolio level • Integrate with County enterprise systems • Manage/justify budgets and more accurately track performance of the CIP • Provide easy access to project related information
Benefits • View multiple data sources on one screen • Make information easily available to County staff • Track individual project manager performance • Standard reports to monitor the CIP • Monitoring the CIP at portfolio level • Real time integration with Advantage • Supports the potential CapStat initiative
Benefits and Potential Savings • Areas of potential savings • Reduced contingencies in projects • Reduced project duration with more effective project management and visibility of status • More efficient budgeting process • Real time access to data and information estimated at over $100k/year
Primavera Scheduling • Primavera has been used in our Construction Division for a number of years. • This scheduling software is to assist with the new Tracking software • Actual –vs.- planned performance • Full implementation of this software September 2011

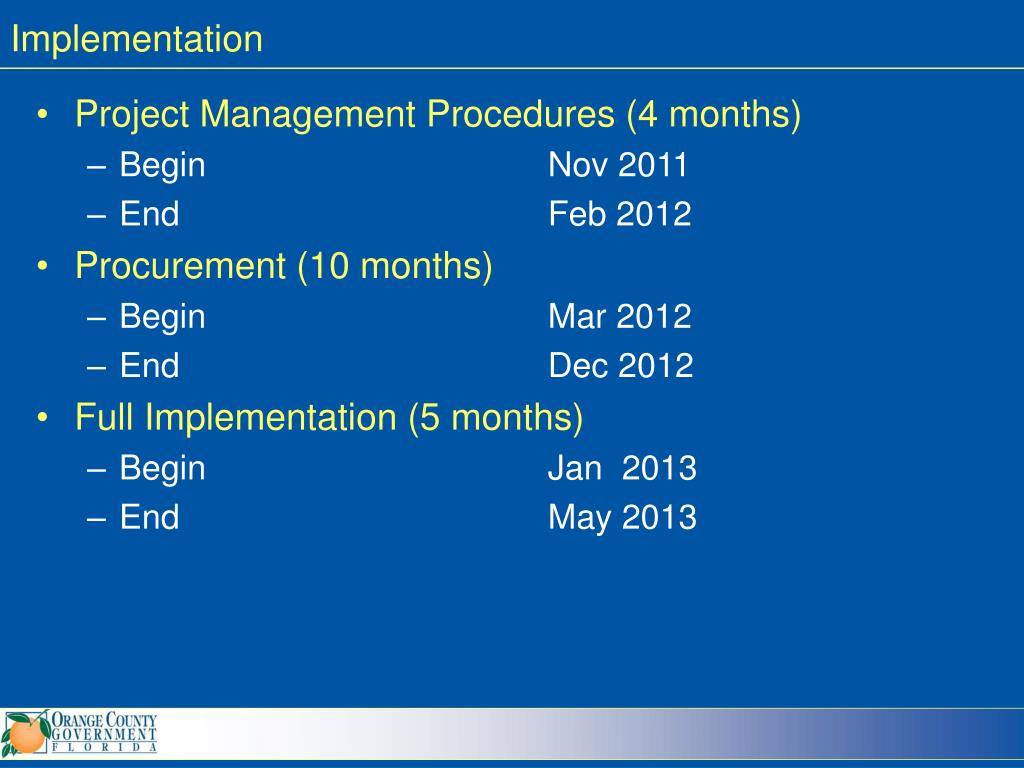

Implementation • Project Management Procedures (4 months) • Begin Nov 2011 • End Feb 2012 • Procurement (10 months) • Begin Mar 2012 • End Dec 2012 • Full Implementation (5 months) • Begin Jan 2013 • End May 2013
