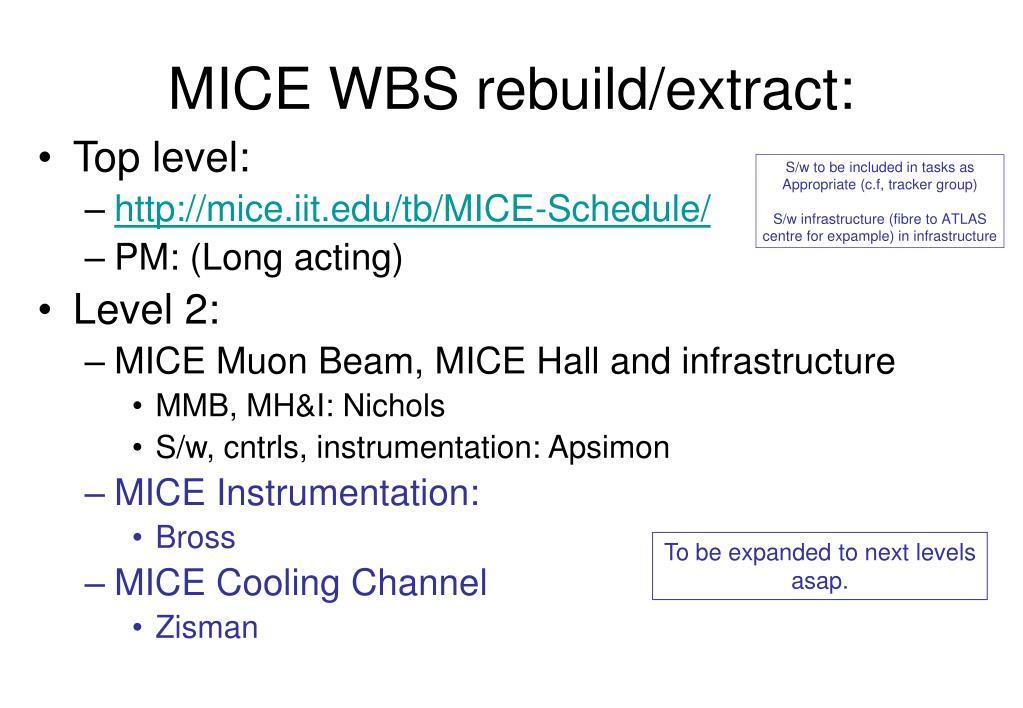

MICE WBS rebuild/extract:

geona avatar
11 diapositives · 300 Views · Jan 05, 2013

MICE WBS rebuild/extract:. Top level: http://mice.iit.edu/tb/MICE-Schedule/ PM: (Long acting) Level 2: MICE Muon Beam, MICE Hall and infrastructure MMB, MH&I: Nichols S/w, cntrls, instrumentation: Apsimon MICE Instrumentation: Bross MICE Cooling Channel Zisman.

MICE WBS rebuild/extract: - slide 1
01 / 11MICE WBS rebuild/extract:
1 / 17

Télécharger la présentation

MICE WBS rebuild/extract:
Une image / un lien ci-dessous est fourni (tel quel) pour télécharger la présentation

Politique de téléchargement : le contenu du site vous est fourni TEL QUEL pour votre information et votre usage personnel ; il ne peut être vendu, concédé sous licence ni partagé sur d’autres sites sans l’accord de son auteur.Le contenu vous est fourni TEL QUEL, pour votre information et votre usage personnel uniquement. Téléchargez la présentation en cliquant sur ce lien. Lors du téléchargement, si vous ne parvenez pas à télécharger une présentation, l’éditeur a peut-être supprimé le fichier de son serveur.Pendant le téléchargement, si vous ne parvenez pas à obtenir une présentation, le fichier a peut-être été supprimé par l’éditeur.

F I N

Plus de contenu associé

Transcription de la présentation
  1. MICE WBS rebuild/extract: • Top level: • http://mice.iit.edu/tb/MICE-Schedule/ • PM: (Long acting) • Level 2: • MICE Muon Beam, MICE Hall and infrastructure • MMB, MH&I: Nichols • S/w, cntrls, instrumentation: Apsimon • MICE Instrumentation: • Bross • MICE Cooling Channel • Zisman To be expanded to next levelsasap.

  2. 2.0 MICE Muon Beam, MICE Hall, infrastructure • MICE Muon Beam, MICE Hall, infrastructure: • Nichols • Software, controls, instrumentation: • Apsimon 2.0.1 MICE Muon Beam: Long 2.0 MMB, MH&I 2.0.2 MICE Hall and infrastructure: Nelson 2.0.3 Christmas 2007 shutdown: Hayler

  3. 2.0.1 MICE Muon Beam • Long

  4. 2.0.1.1 Target • Booth • 37: Installation of the PSU: • Location defined, working with A.Nobbs • 40: Installation of target controls: • Location defined, working DL on controls, S.Britnell on cabling in Hall and MLCR • Revision of schedule promised for 13Sep07 • Removal of old target: • Discussion with RPA: • Require revised method statement quantifying doses, isotopes etc. • Suggestion using MMPX to evaluate activation • Revision goal: 13Sep07 • 18: Jacking motor controls: • Working with G.Charnley, to be updated, goal 13Sep07. • 23: Cable installation: working with A.Nobbs, to be updated, goal 13Sep07 • 33: Development of bearings: working S.Payne • Require to prepare document for CM19. Document to: • Propose operation scheme to be presented to ISIS (Findlay) for running from January ’08; • Propose development plan for final target bearing scheme

  5. 2.0.1.2 Q35 refurbishment • Long • Refurbishment scheme needs to be reviewed in light of experience • Review to be carried out as soon as E.Cappozi and C.Locket are both avaulable. • Testing scheme to be developed in consultation with M.Hughes and K.Tilley

  6. 2.0.1.3 Linde refridgerator • Courthold • Noted pressure on schedule: • First priority: must not be allowed to slip: • Implies potential call on additional resources • Require to ensure adequate number of people trained for working at height: • MC has organisation of training course in hand • ~8 places available. • Agreed: first call on places for: • Spensley (if not already trained), Jamdagni (+second Hall Foreman), Capozzi, Lockett, Courthold, Nelson, Jones

  7. 2.0.1.4 PSI solenoid • Courthold • To be reviewed for next week (13Sep07) • Noted from discussion: • Require to add electrical testing schedule • Swagelock adaptor, which is on order, is required before vac test can begin. • Question added ‘in proof’: • Does this need to be chased with Swagelock?

  8. 2.0.1.5 Q4—9 installation • Nelson • To be reviewed for next week (13Sep07) • Noted from discussion: • Presently only delivery schedule • Installation schedule needs to be developed

  9. 2.0.2 MICE Hall • Nelson • Tasks identified (with person responsible) below. [Caution, may not be complete list:] • Magnetic shield walls Nelson • MICE Hall Floor: Nelson • Plinth (concrete infill in ‘pit’) • False floor (levelling sloping floor) • Rolling platforms Nelson • Water Govens • Air conditioning Govens • Power Griffiths • Liquid-hydrogen system Ivanyushenkov • MLCR Kyberd • Networking Brandwood • Cabling: Griffiths • Linde • Test positions Courthold • Final positions Courthold • Cable trays/cable layout etc.

  10. 2.0.2.1 MICE Local Control Room • Kyberd • P.Kyberd not at meeting so noted: • Revision requested for 13Sep07 • Personnel responsible for sub-systems: • Civil work: Houseman in absence of Pyke • PPS Alexander • Networking Brandwood • Racks ‘DL’ • Rack installation PK • Cabling Britnell

  11. 2.0.3 XMas2007-shutdown • Hayler • Discussion of resources (availability, etc.) starts 06Sep07 • Priority 1: • Implies planning of tasks Sep—Dec done to preserve/advance Christmas schedule
