Parkland School District

Parkland School District. 2014-2015 Capital Improvements. Kratzer Elementary School. Capital Improvements. Kratzer as of 9/11/2013. Existing Site Plan. Proposed Site Plan. Floor Plan. Schematic Budget Kratzer Improvements 2014-2015. Phasing Plan.

hagen
Télécharger la présentation

Parkland School District

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Parkland School District 2014-2015 Capital Improvements

  2. Kratzer Elementary School Capital Improvements

  3. Kratzer as of 9/11/2013

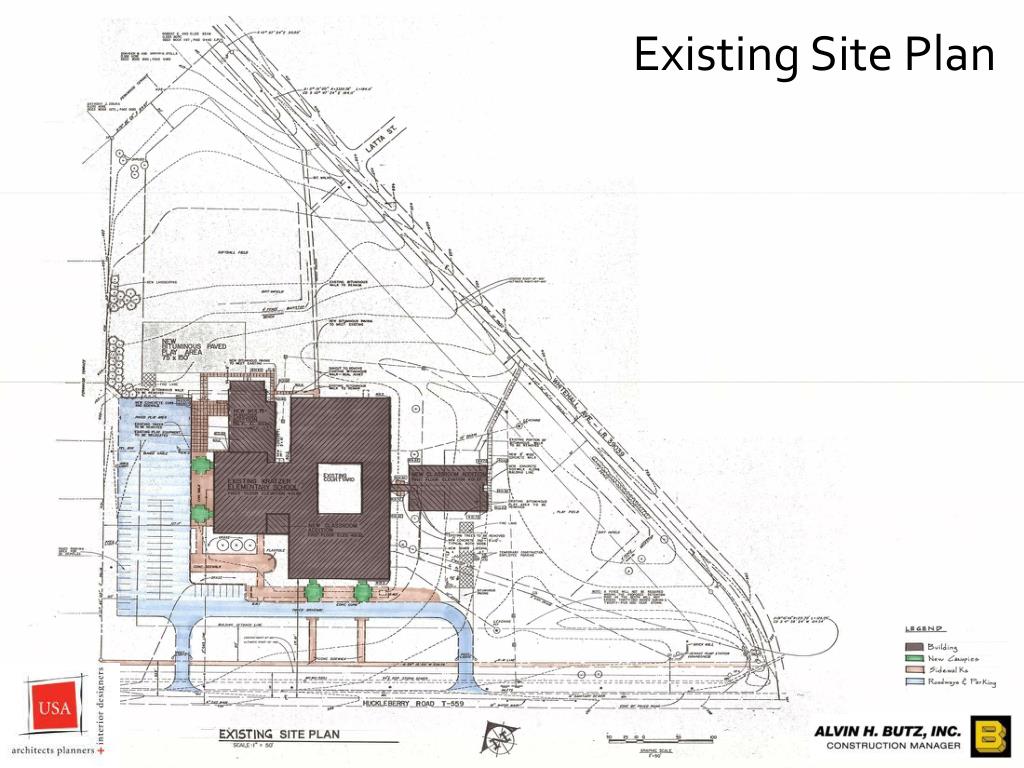

  4. Existing Site Plan

  5. Proposed Site Plan

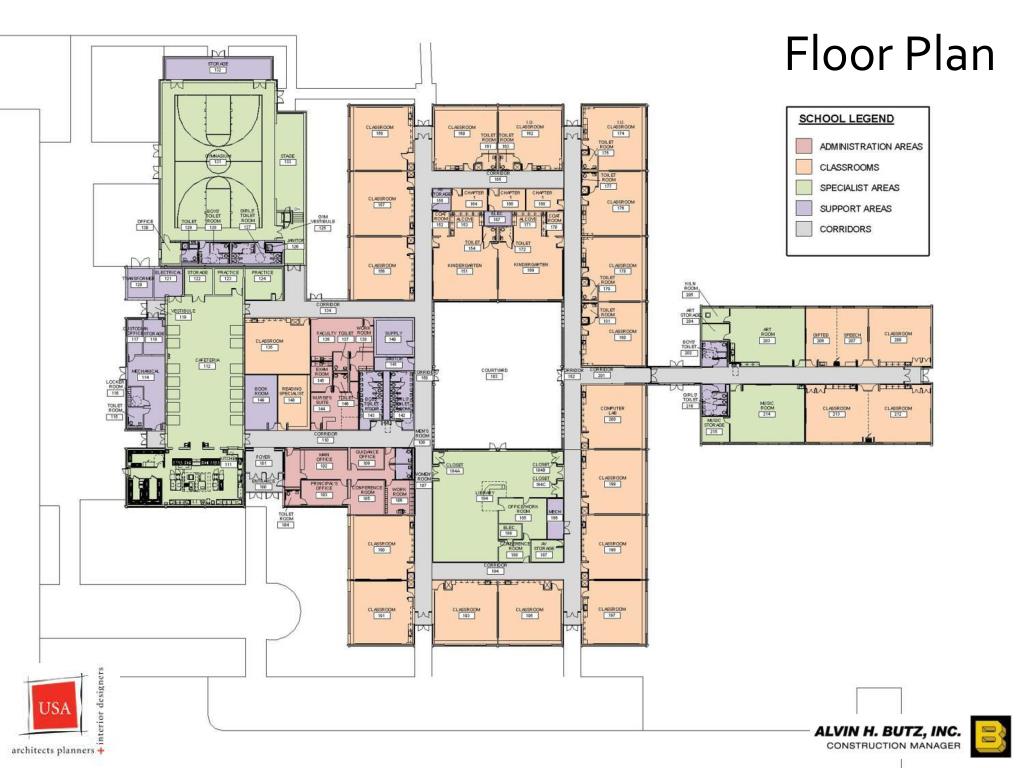

  6. Floor Plan

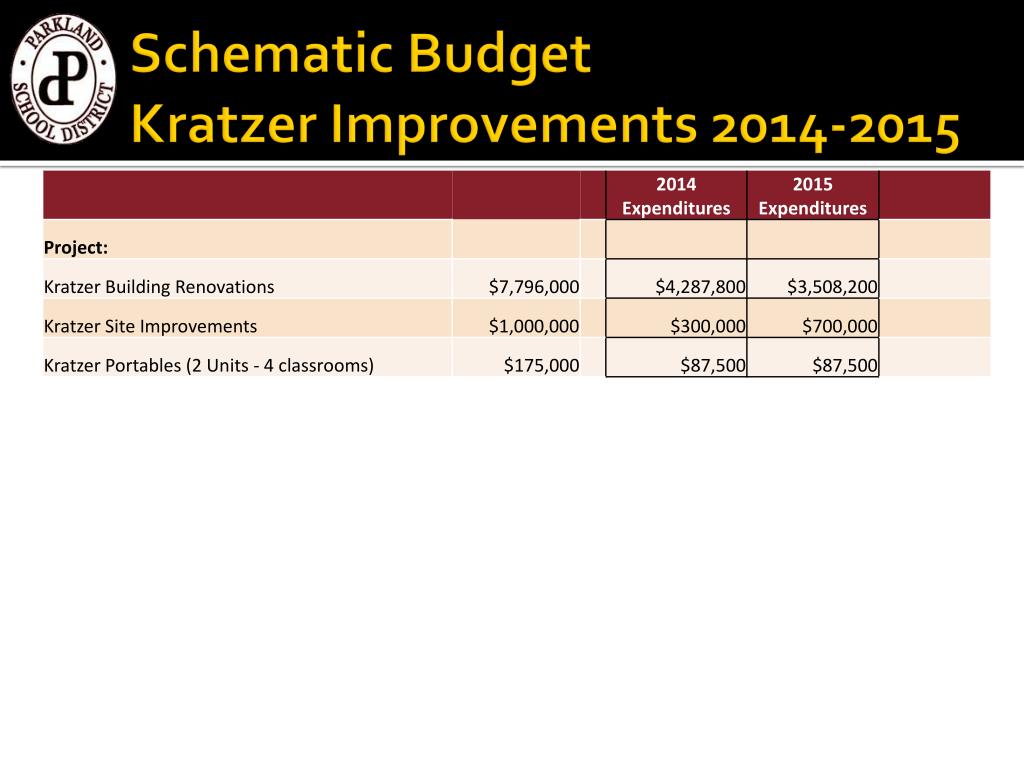

  7. Schematic BudgetKratzer Improvements 2014-2015

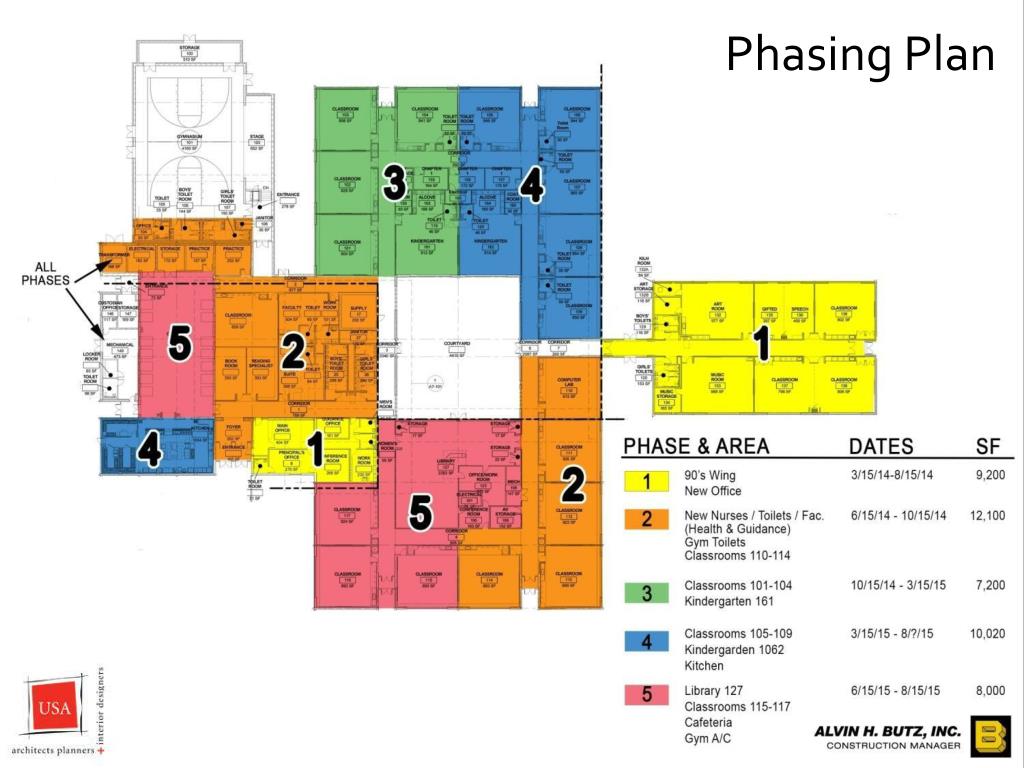

  8. Phasing Plan

  9. Schematic BudgetProposed Capital Improvements 2014-2015

  10. Capital Improvements 2015 & Beyond By extending our 3rd year borrowing in 2015 to $10m, some of the following additional projects may be accommodated: • Energy audit work/additional OMS and PHS HVAC controls ($700K) • Roofing projects at Cetronia, Fogelsville & SMS ($1M) • Turf at the soccer/track stadium at PHS ($1M from capital reserves) Total - $2.7M • Then we will turn our attention to Troxell and other capital improvement project needs.
