Project X: Project Status & Progress Steve Holmes Project X Working Group Meeting June 30, 2011

Project X: Project Status & Progress Steve Holmes Project X Working Group Meeting June 30, 2011. Outline. Agenda Project Status (Steve) Level 2 Appointments (Steve) FY12 Budget Preparations (Steve) Project Timeline (Dean) Next Meeting Action Items.

hallie
Télécharger la présentation

Project X: Project Status & Progress Steve Holmes Project X Working Group Meeting June 30, 2011

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

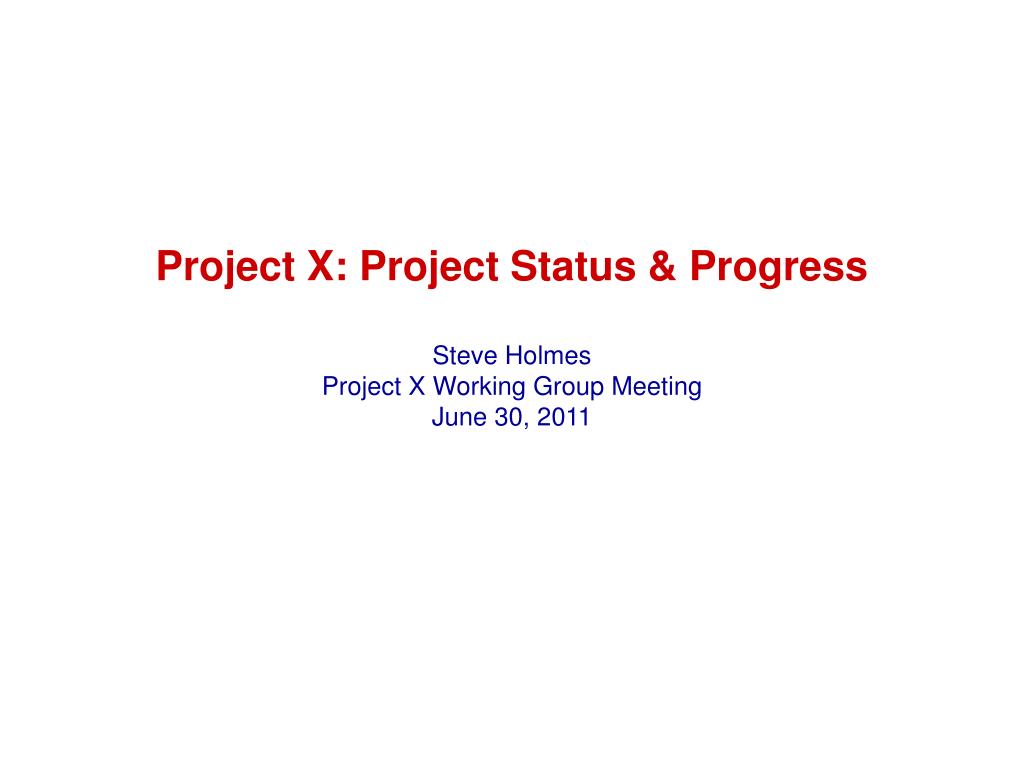

  1. Project X: Project Status & ProgressSteve HolmesProject X Working Group MeetingJune 30, 2011

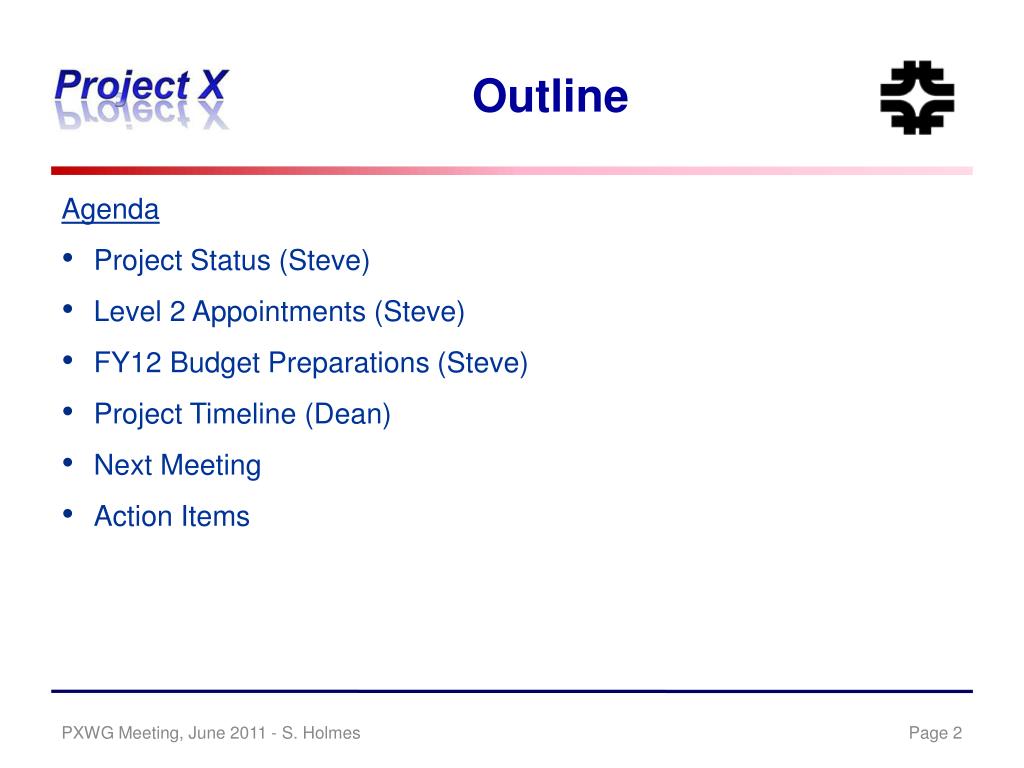

  2. Outline Agenda • Project Status (Steve) • Level 2 Appointments (Steve) • FY12 Budget Preparations (Steve) • Project Timeline (Dean) • Next Meeting • Action Items PXWG Meeting, June 2011 - S. Holmes

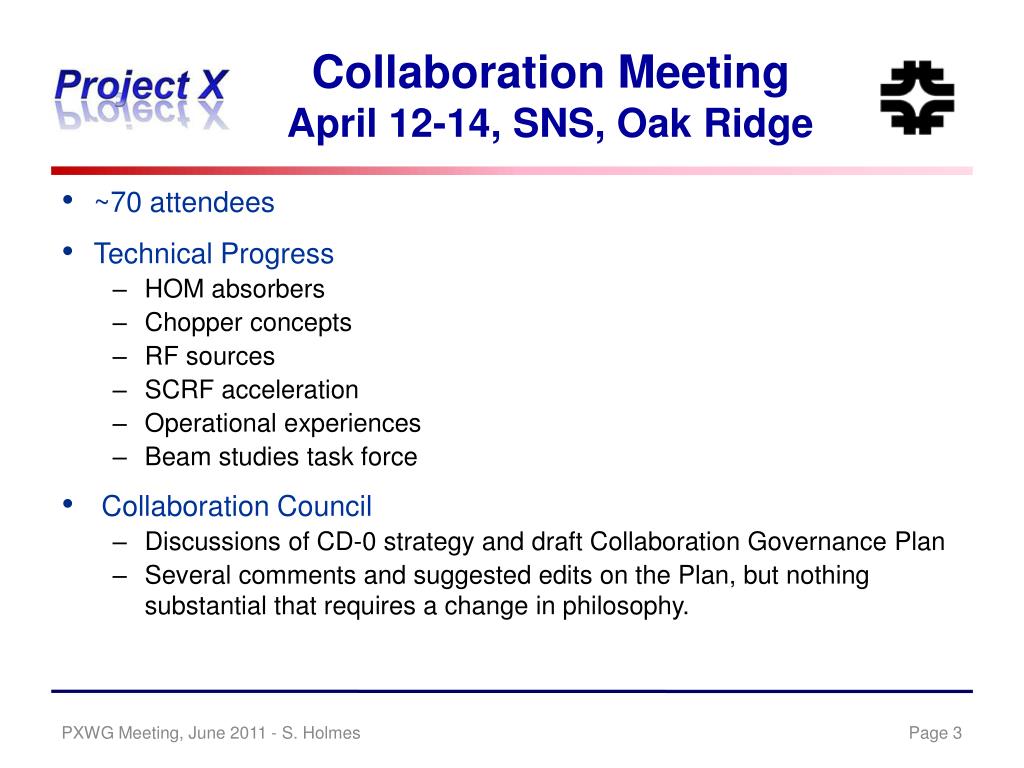

  3. Collaboration MeetingApril 12-14, SNS, Oak Ridge • ~70 attendees • Technical Progress • HOM absorbers • Chopper concepts • RF sources • SCRF acceleration • Operational experiences • Beam studies task force • Collaboration Council • Discussions of CD-0 strategy and draft Collaboration Governance Plan • Several comments and suggested edits on the Plan, but nothing substantial that requires a change in philosophy. PXWG Meeting, June 2011 - S. Holmes

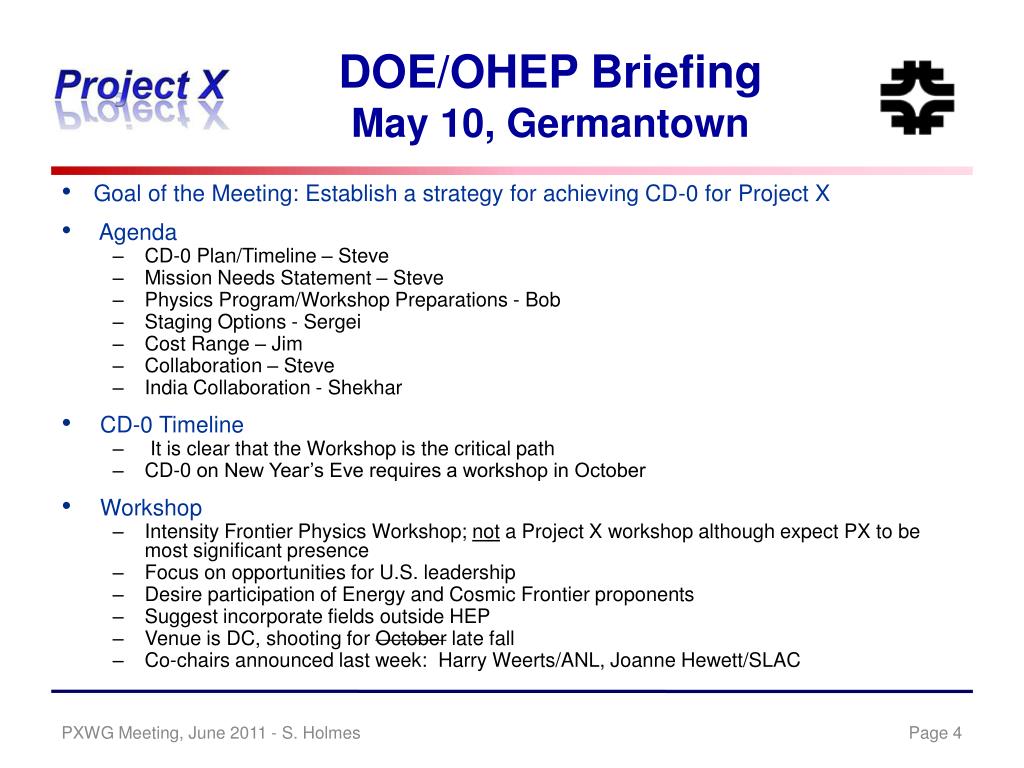

  4. DOE/OHEP BriefingMay 10, Germantown • Goal of the Meeting: Establish a strategy for achieving CD-0 for Project X • Agenda • CD-0 Plan/Timeline – Steve • Mission Needs Statement – Steve • Physics Program/Workshop Preparations - Bob • Staging Options - Sergei • Cost Range – Jim • Collaboration – Steve • India Collaboration - Shekhar • CD-0 Timeline • It is clear that the Workshop is the critical path • CD-0 on New Year’s Eve requires a workshop in October • Workshop • Intensity Frontier Physics Workshop; not a Project X workshop although expect PX to be most significant presence • Focus on opportunities for U.S. leadership • Desire participation of Energy and Cosmic Frontier proponents • Suggest incorporate fields outside HEP • Venue is DC, shooting for October late fall • Co-chairs announced last week: Harry Weerts/ANL, Joanne Hewett/SLAC PXWG Meeting, June 2011 - S. Holmes

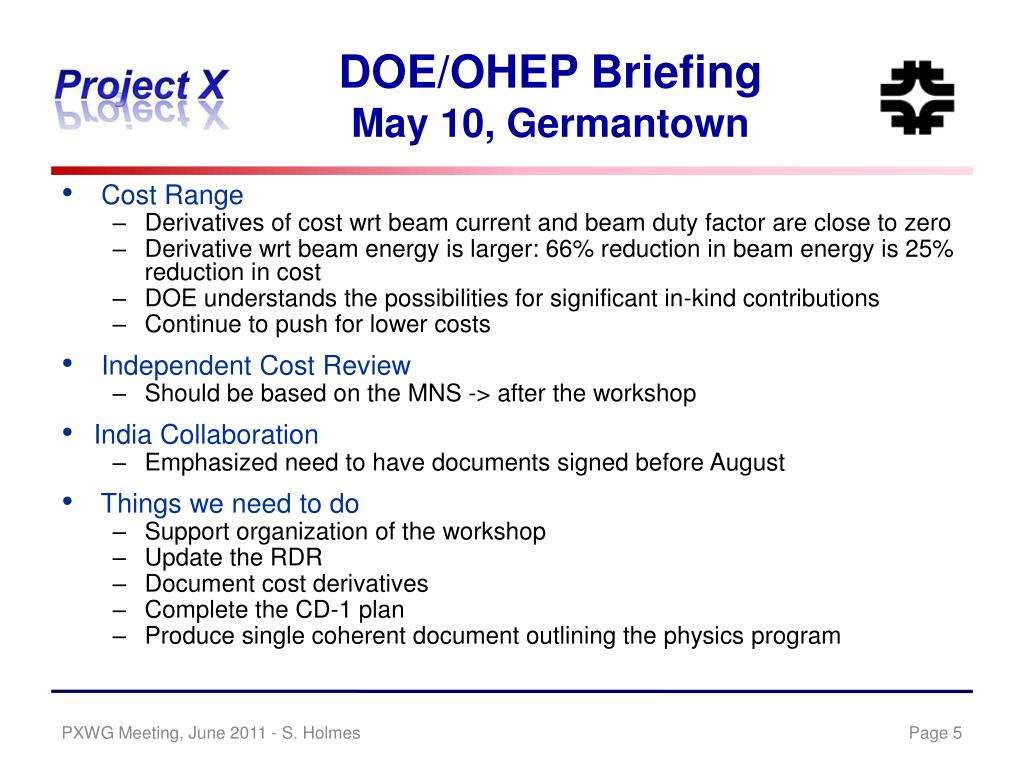

  5. DOE/OHEP BriefingMay 10, Germantown • Cost Range • Derivatives of cost wrt beam current and beam duty factor are close to zero • Derivative wrt beam energy is larger: 66% reduction in beam energy is 25% reduction in cost • DOE understands the possibilities for significant in-kind contributions • Continue to push for lower costs • Independent Cost Review • Should be based on the MNS -> after the workshop • India Collaboration • Emphasized need to have documents signed before August • Things we need to do • Support organization of the workshop • Update the RDR • Document cost derivatives • Complete the CD-1 plan • Produce single coherent document outlining the physics program PXWG Meeting, June 2011 - S. Holmes

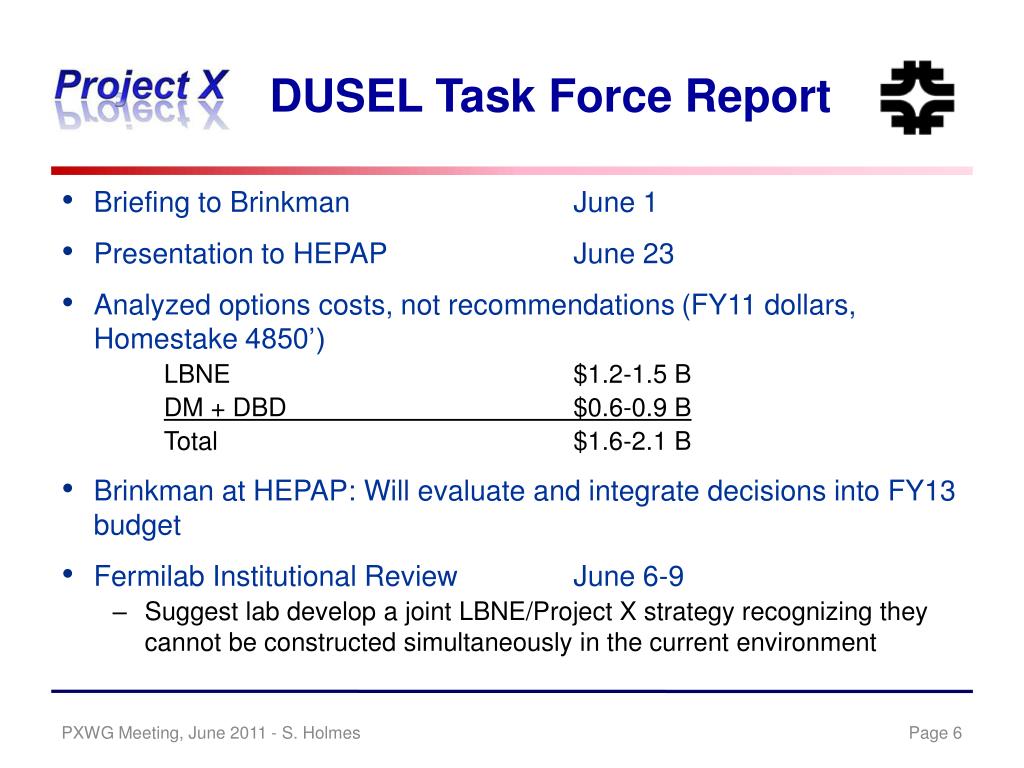

  6. DUSEL Task Force Report • Briefing to Brinkman June 1 • Presentation to HEPAP June 23 • Analyzed options costs, not recommendations (FY11 dollars, Homestake 4850’) LBNE $1.2-1.5 B DM + DBD $0.6-0.9 B Total $1.6-2.1 B • Brinkman at HEPAP: Will evaluate and integrate decisions into FY13 budget • Fermilab Institutional Review June 6-9 • Suggest lab develop a joint LBNE/Project X strategy recognizing they cannot be constructed simultaneously in the current environment PXWG Meeting, June 2011 - S. Holmes

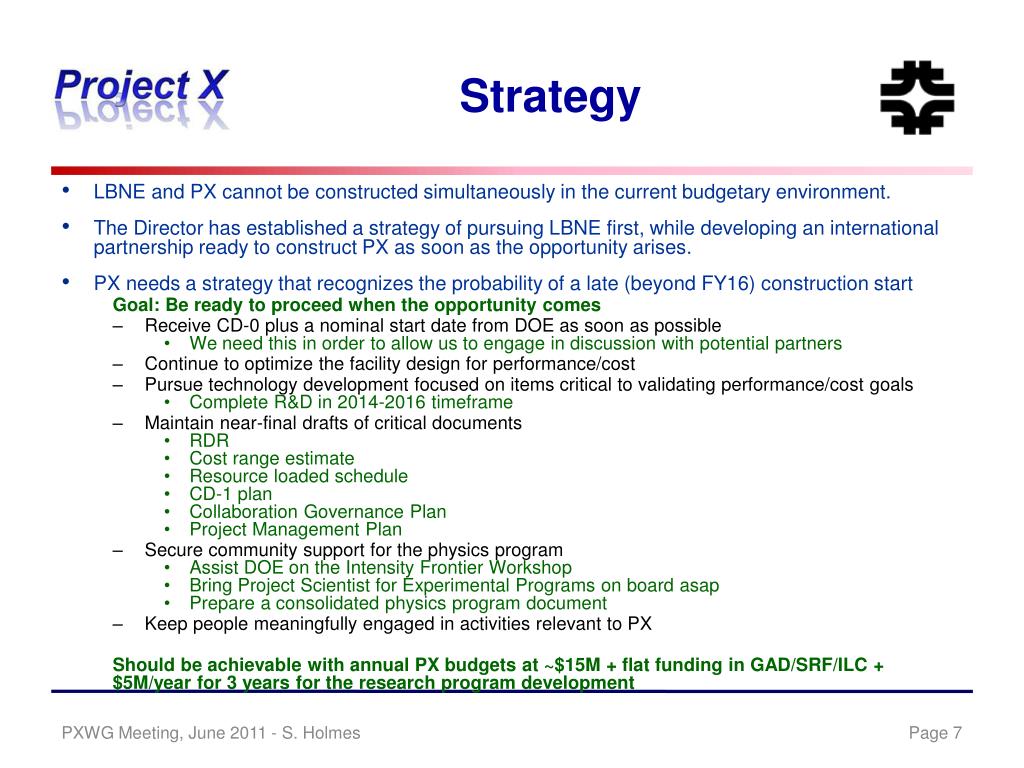

  7. Strategy • LBNE and PX cannot be constructed simultaneously in the current budgetary environment. • The Director has established a strategy of pursuing LBNE first, while developing an international partnership ready to construct PX as soon as the opportunity arises. • PX needs a strategy that recognizes the probability of a late (beyond FY16) construction start Goal: Be ready to proceed when the opportunity comes • Receive CD-0 plus a nominal start date from DOE as soon as possible • We need this in order to allow us to engage in discussion with potential partners • Continue to optimize the facility design for performance/cost • Pursue technology development focused on items critical to validating performance/cost goals • Complete R&D in 2014-2016 timeframe • Maintain near-final drafts of critical documents • RDR • Cost range estimate • Resource loaded schedule • CD-1 plan • Collaboration Governance Plan • Project Management Plan • Secure community support for the physics program • Assist DOE on the Intensity Frontier Workshop • Bring Project Scientist for Experimental Programs on board asap • Prepare a consolidated physics program document • Keep people meaningfully engaged in activities relevant to PX Should be achievable with annual PX budgets at ~$15M + flat funding in GAD/SRF/ILC + $5M/year for 3 years for the research program development PXWG Meeting, June 2011 - S. Holmes

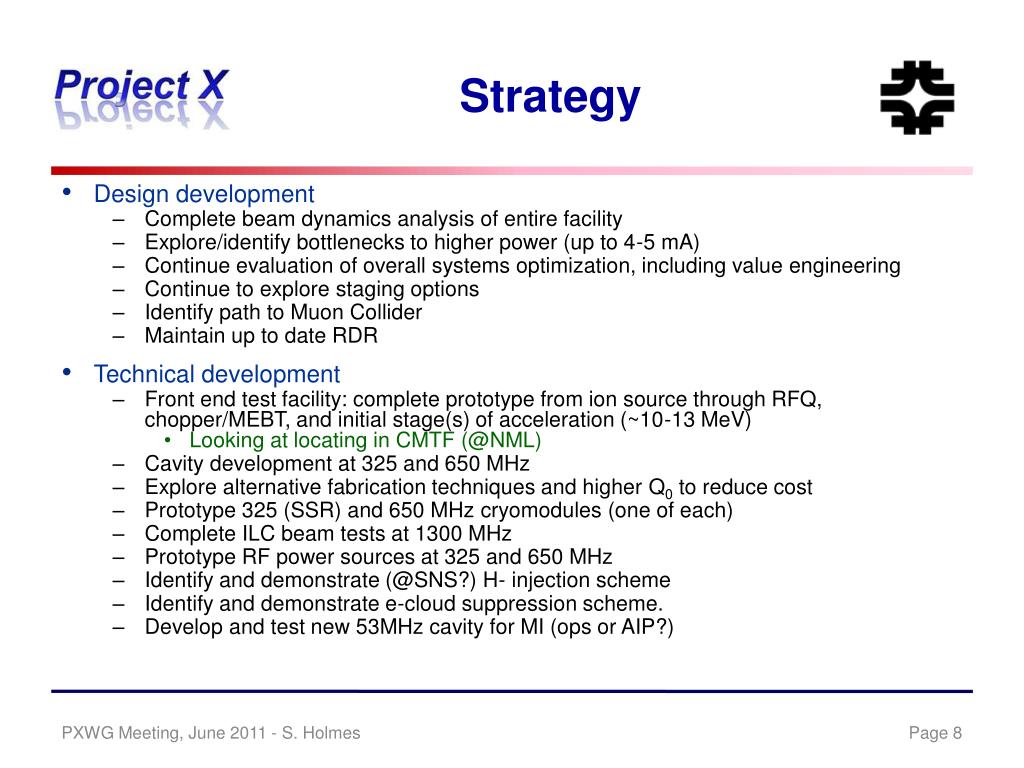

  8. Strategy • Design development • Complete beam dynamics analysis of entire facility • Explore/identify bottlenecks to higher power (up to 4-5 mA) • Continue evaluation of overall systems optimization, including value engineering • Continue to explore staging options • Identify path to Muon Collider • Maintain up to date RDR • Technical development • Front end test facility: complete prototype from ion source through RFQ, chopper/MEBT, and initial stage(s) of acceleration (~10-13 MeV) • Looking at locating in CMTF (@NML) • Cavity development at 325 and 650 MHz • Explore alternative fabrication techniques and higher Q0 to reduce cost • Prototype 325 (SSR) and 650 MHz cryomodules (one of each) • Complete ILC beam tests at 1300 MHz • Prototype RF power sources at 325 and 650 MHz • Identify and demonstrate (@SNS?) H- injection scheme • Identify and demonstrate e-cloud suppression scheme. • Develop and test new 53MHz cavity for MI (ops or AIP?) PXWG Meeting, June 2011 - S. Holmes

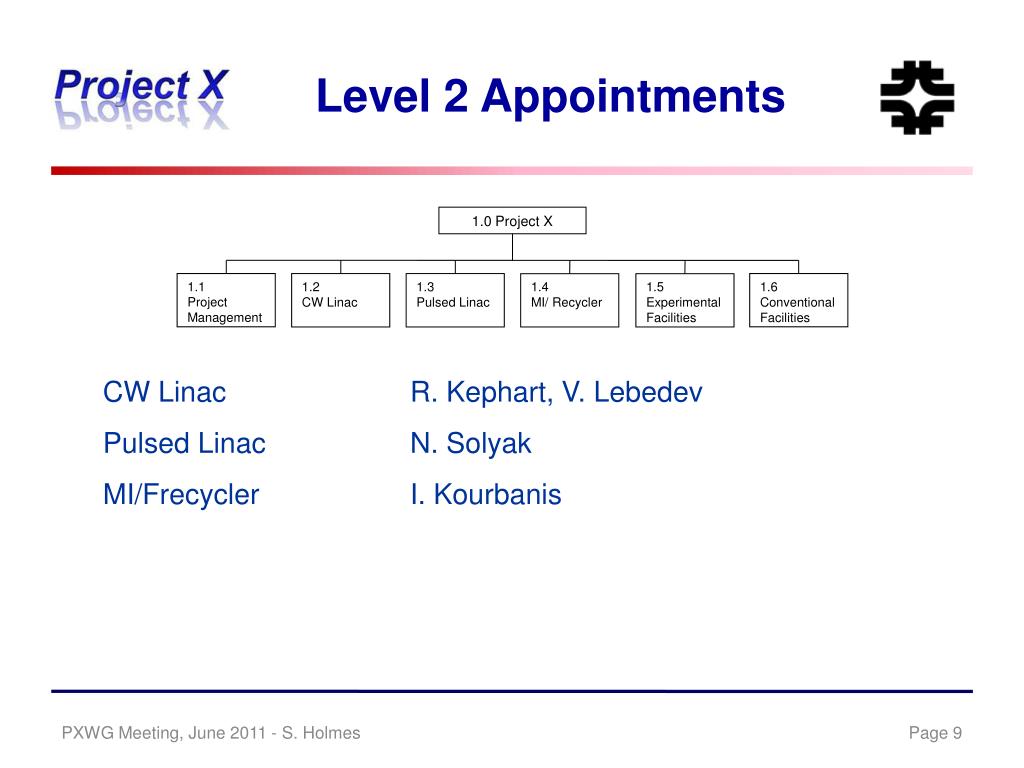

  9. 1.0 Project X 1.1 Project Management 1.2 CW Linac 1.3 Pulsed Linac 1.6 Conventional Facilities 1.4 MI/ Recycler 1.5 Experimental Facilities Level 2 Appointments CW LinacR. Kephart, V. Lebedev Pulsed Linac N. Solyak MI/Frecycler I. Kourbanis PXWG Meeting, June 2011 - S. Holmes

  10. FY12 Budget Preparations • FY11 Budget $10.5M • FY12 Plan $13.0M • We are developing the plan through the newly appointed L2’s in consultation with the Project Manager, Project Scientist, Project Engineer • Utilizes Project WBS • Utilizes OHAP resources categories • Will require change in task codes for FY12 PXWG Meeting, June 2011 - S. Holmes

  11. PXWG Meeting, June 2011 - S. Holmes
