An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. SPS 200 MHz RF Upgrade Eric Montesinos LIU-SPS coordination meeting 06 June 2013

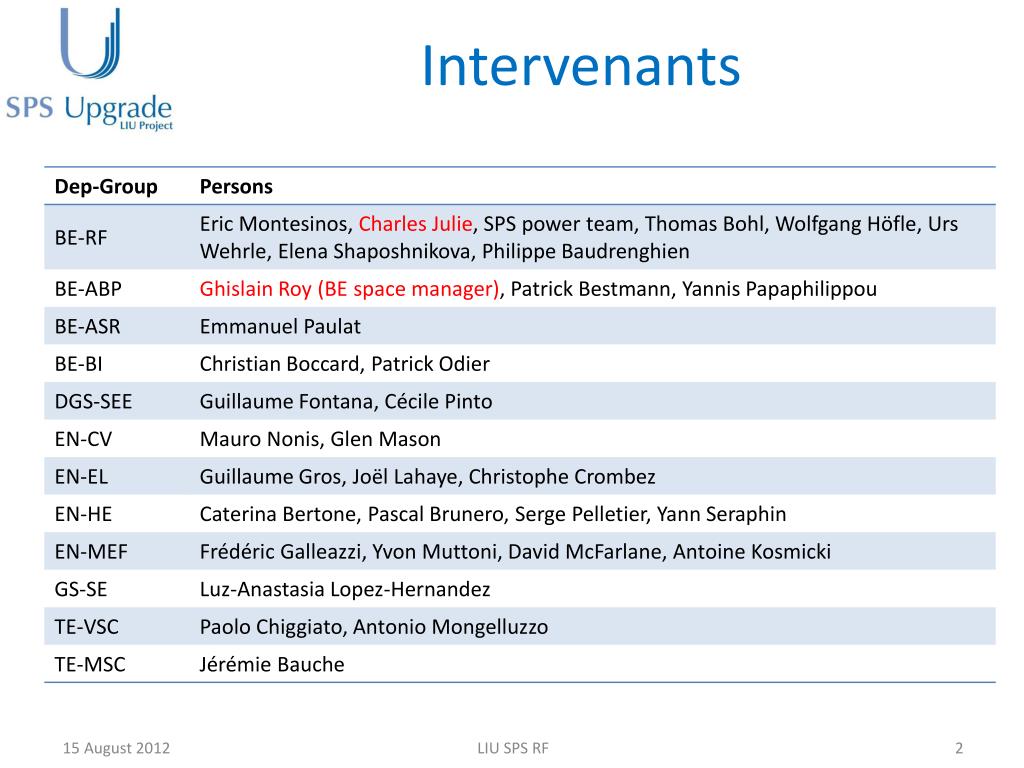

  2. Intervenants LIU SPS RF

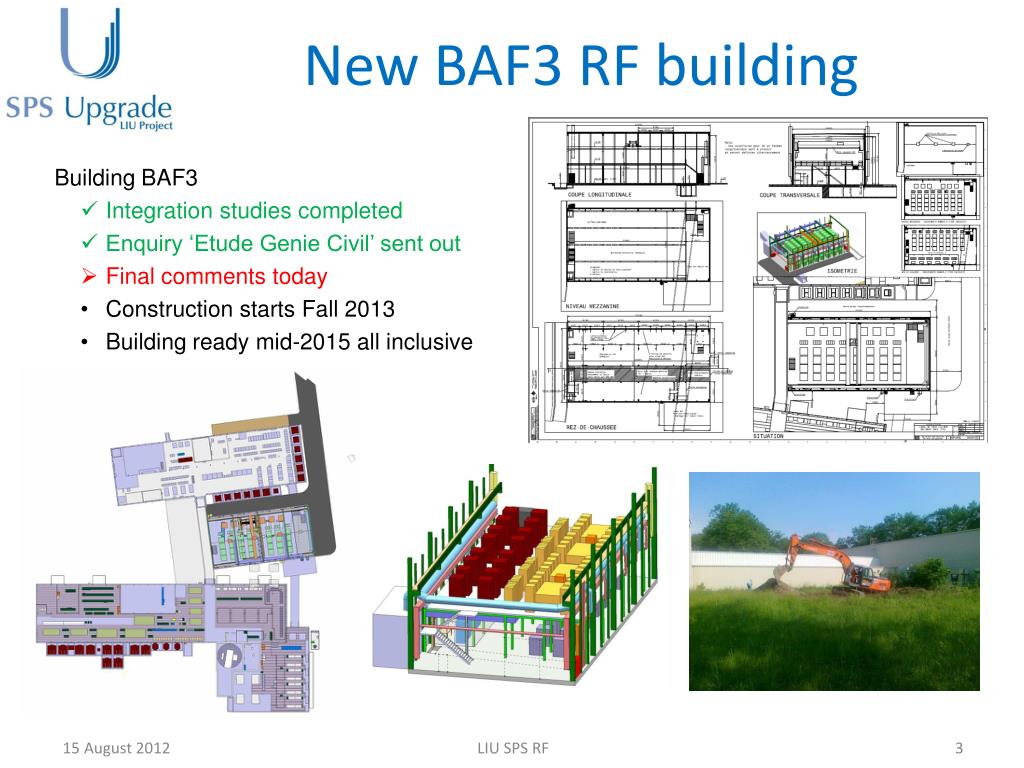

  3. New BAF3 RF building • Building BAF3 • Integration studies completed • Enquiry ‘Etude Genie Civil’ sent out • Final comments today • Construction starts Fall 2013 • Building ready mid-2015 all inclusive LIU SPS RF

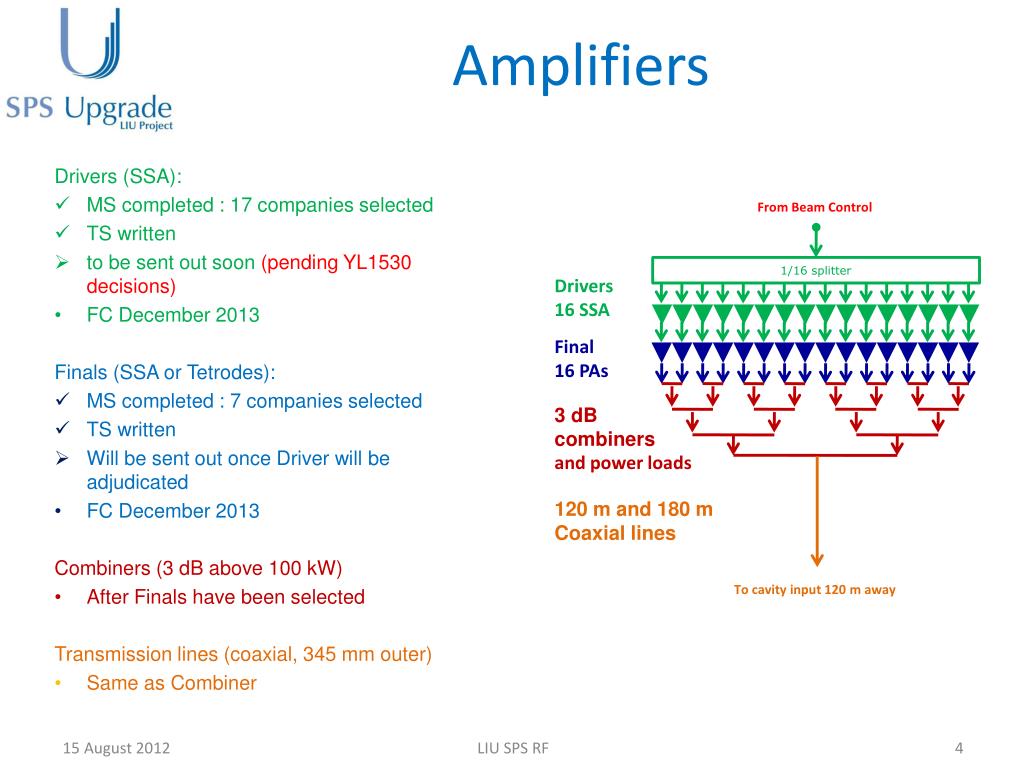

  4. Amplifiers Drivers (SSA): • MS completed : 17 companies selected • TS written • to be sent out soon (pending YL1530 decisions) • FC December 2013 Finals (SSA or Tetrodes): • MS completed : 7 companies selected • TS written • Will be sent out once Driver will be adjudicated • FC December 2013 Combiners (3 dB above 100 kW) • After Finals have been selected Transmission lines (coaxial, 345 mm outer) • Same as Combiner From Beam Control 1/16 splitter Drivers 16 SSA Final 16 PAs 3 dB combiners and power loads 120 m and 180 m Coaxial lines To cavity input 120 m away LIU SPS RF

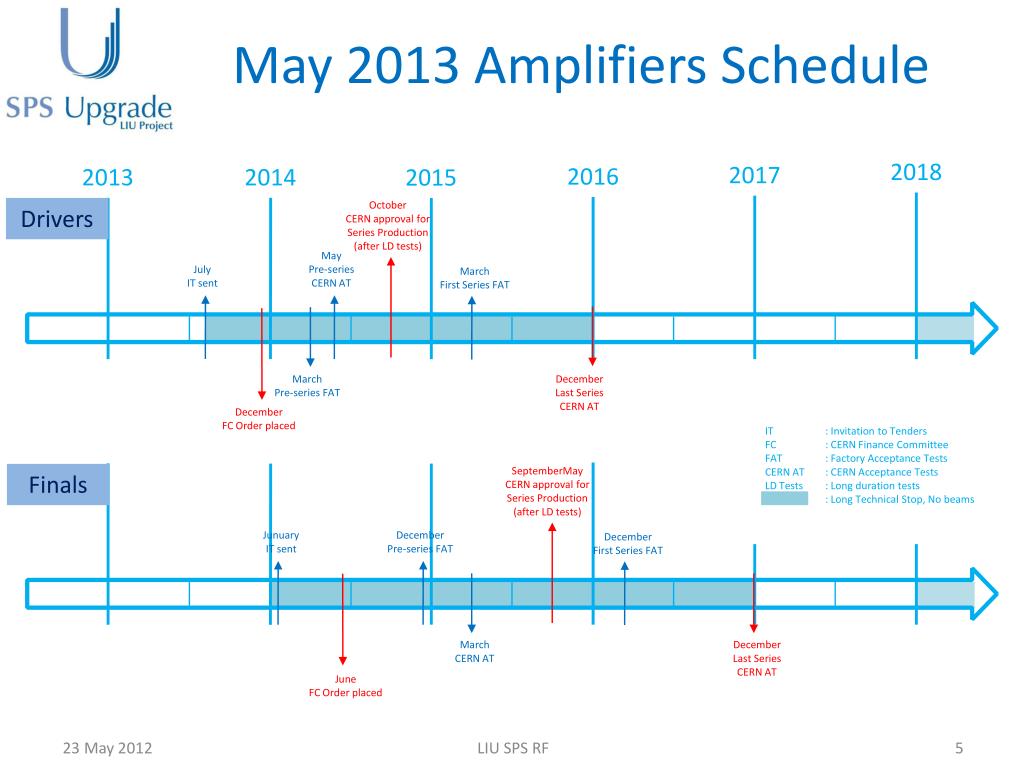

  5. May 2013 Amplifiers Schedule 2018 2017 2016 2013 2014 2015 October CERN approval for Series Production (after LD tests) Drivers May Pre-series CERN AT July IT sent March First Series FAT March Pre-series FAT December Last Series CERN AT December FC Order placed IT : Invitation to Tenders FC : CERN Finance Committee FAT : Factory Acceptance Tests CERN AT : CERN Acceptance Tests LD Tests : Long duration tests : Long Technical Stop, No beams SeptemberMay CERN approval for Series Production (after LD tests) Finals December Pre-series FAT Junuary IT sent December First Series FAT March CERN AT December Last Series CERN AT June FC Order placed LIU SPS RF

  6. LSS3 rearrangement LS1 BPWA: 319 to 31101 AEWB: 319 To 31510 • HBW Damper will be prepared • BPWA and AEWB new locations have been validated • ECR validated • Schedule : Summer 2013 HBW kicker LIU SPS RF

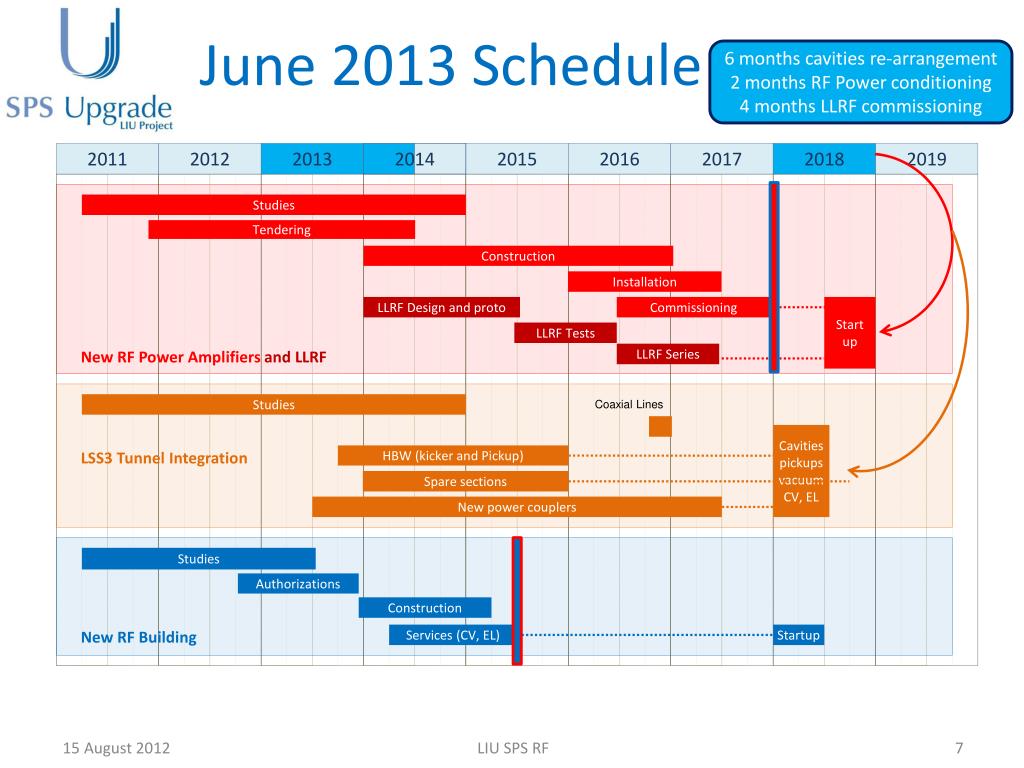

  7. June 2013 Schedule 6 months cavities re-arrangement 2 months RF Power conditioning 4 months LLRF commissioning 2011 2012 2013 2014 2015 2016 2017 2018 2019 Studies Tendering Construction Installation LLRF Design and proto Commissioning Start up LLRF Tests LLRF Series New RF Power Amplifiers and LLRF Coaxial Lines Studies Cavities pickups vacuumCV, EL LSS3 Tunnel Integration HBW (kicker and Pickup) Spare sections New power couplers Studies Authorizations Construction New RF Building Services (CV, EL) Startup LIU SPS RF

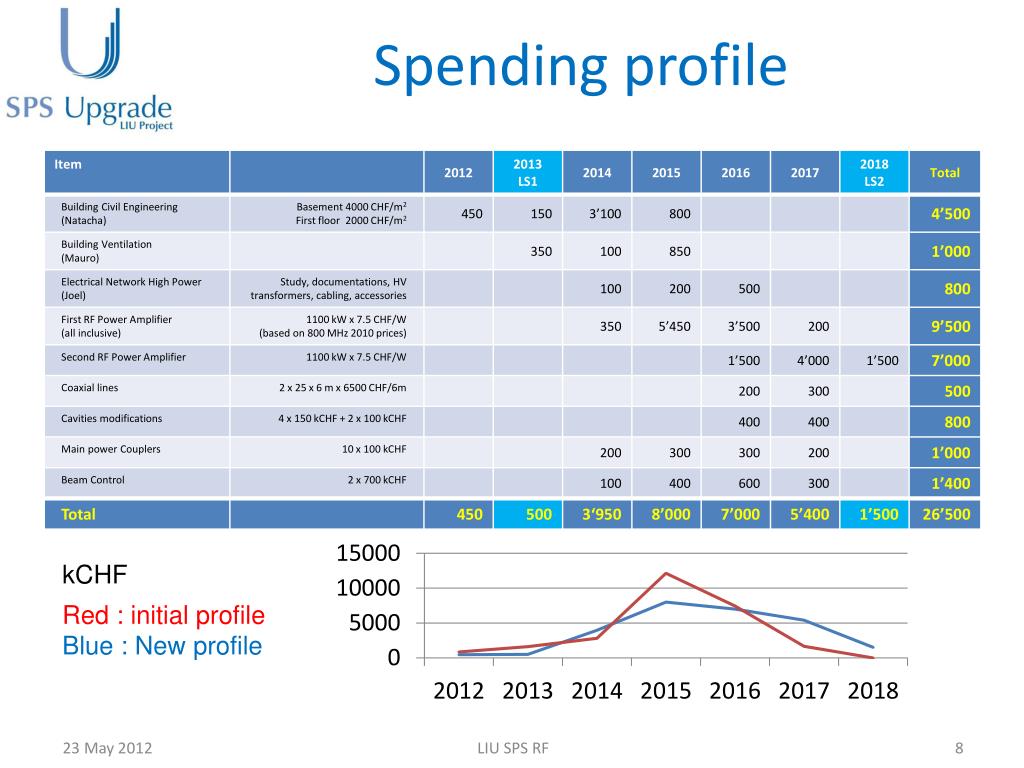

  8. Spending profile kCHF Red : initial profile Blue : New profile LIU SPS RF
