PDT Low Voltage P.S.

PDT Low Voltage P.S. 94 LVPS Packages mounted 4’-25’ from the front-end electronics. 4 modules per package. +5V& -5V “Digital”, +5V & -5V “Analog” 18 A 1A 18A 18Amps. LVPS Connections. LVPS Testing.

ismet
Télécharger la présentation

PDT Low Voltage P.S.

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

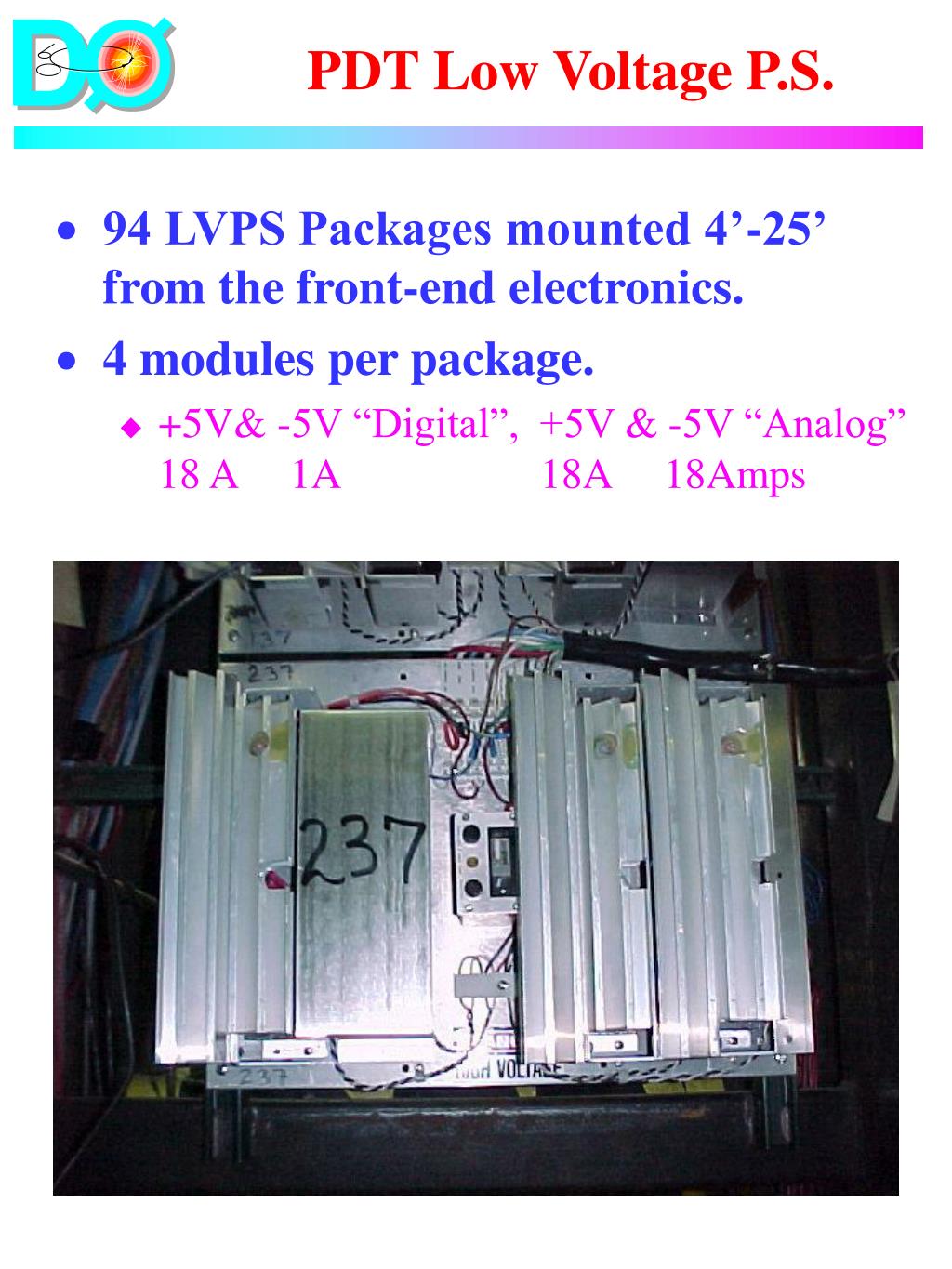

  1. PDT Low Voltage P.S. • 94 LVPS Packages mounted 4’-25’ from the front-end electronics. • 4 modules per package. • +5V& -5V “Digital”, +5V & -5V “Analog” 18 A 1A 18A 18Amps

  2. LVPS Connections

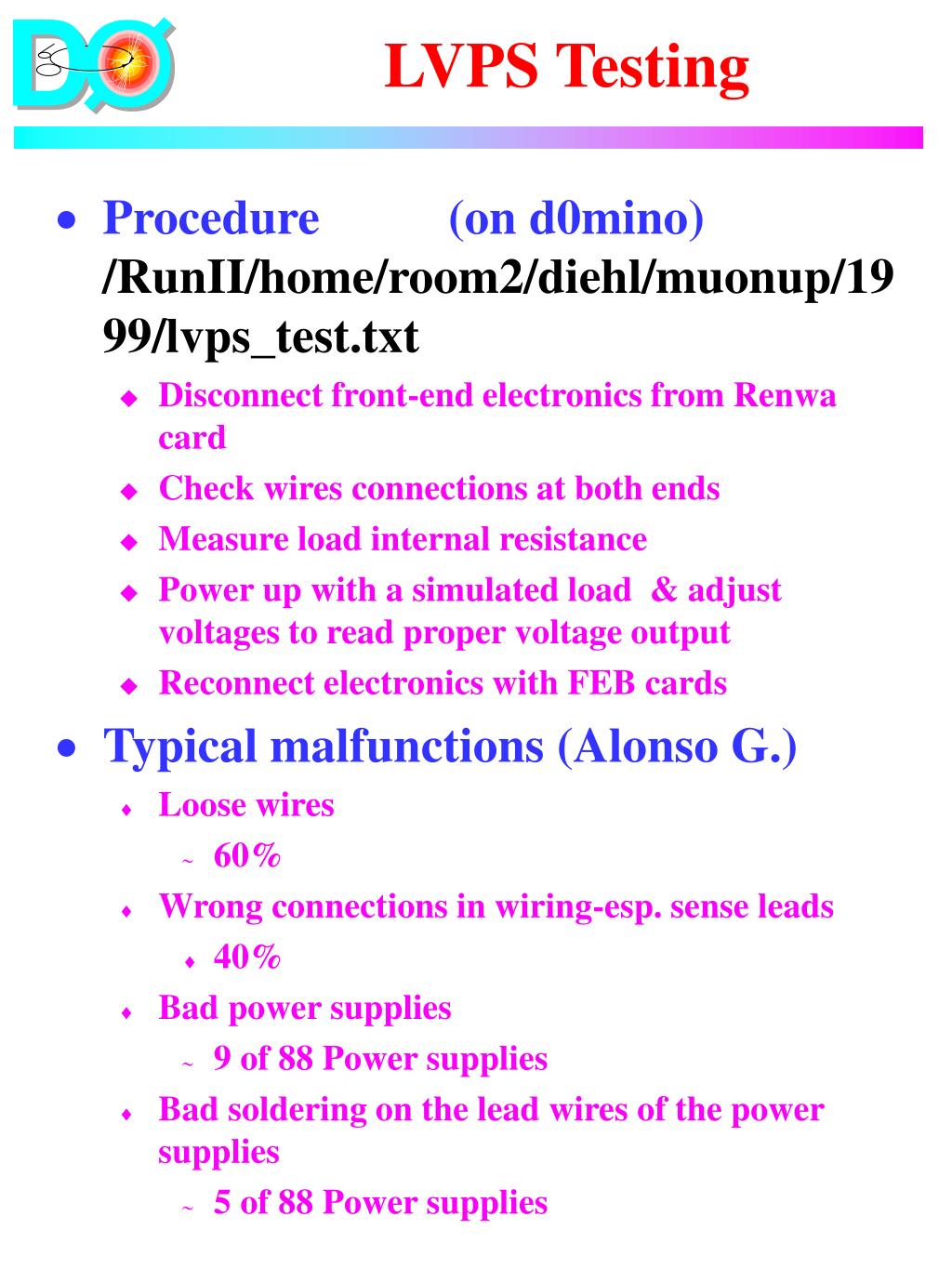

  3. LVPS Testing • Procedure(on d0mino)/RunII/home/room2/diehl/muonup/1999/lvps_test.txt • Disconnect front-end electronics from Renwa card • Check wires connections at both ends • Measure load internal resistance • Power up with a simulated load & adjust voltages to read proper voltage output • Reconnect electronics with FEB cards • Typical malfunctions (Alonso G.) • Loose wires • 60% • Wrong connections in wiring-esp. sense leads • 40% • Bad power supplies • 9 of 88 Power supplies • Bad soldering on the lead wires of the power supplies • 5 of 88 Power supplies

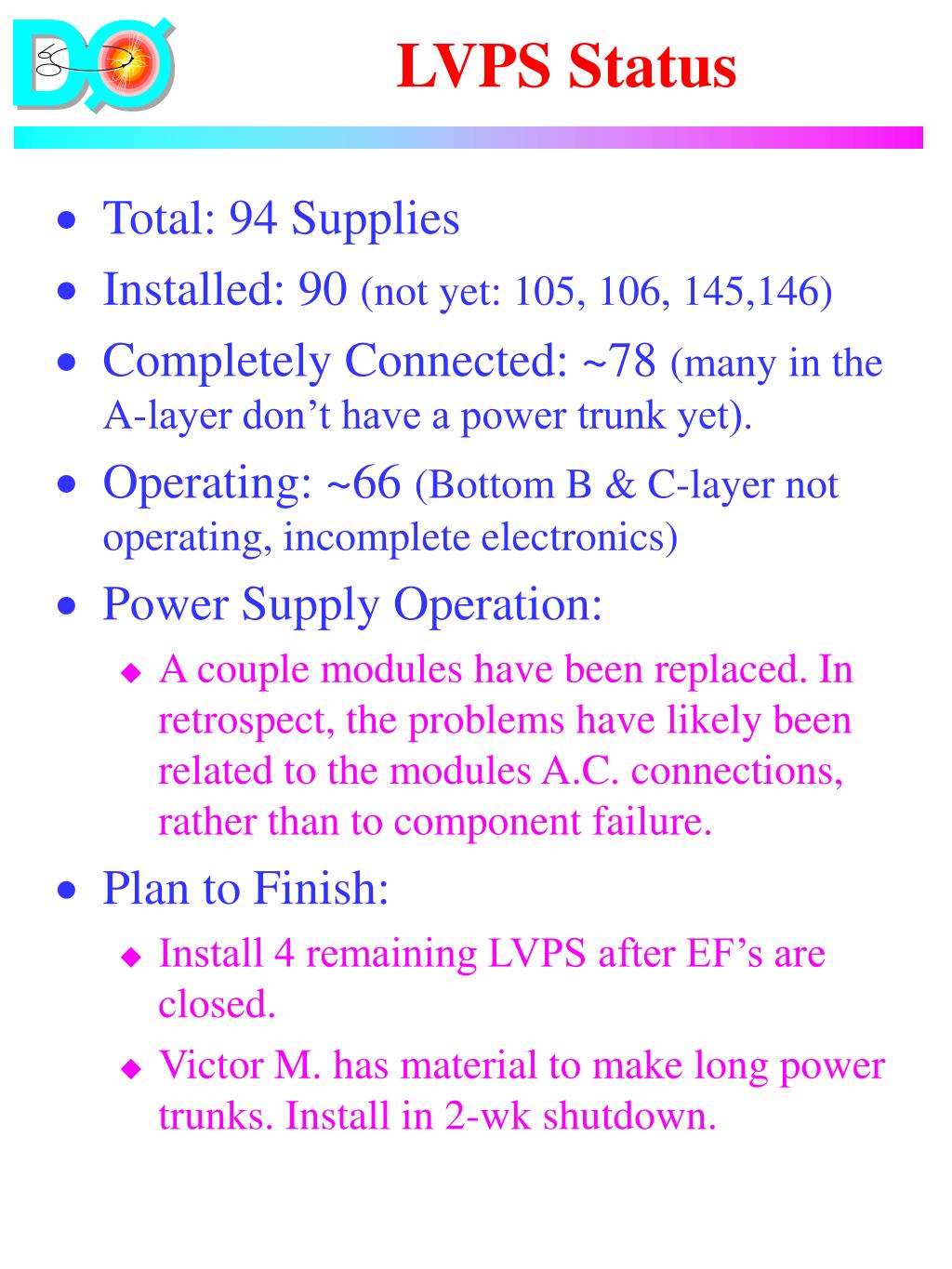

  4. LVPS Status • Total: 94 Supplies • Installed: 90 (not yet: 105, 106, 145,146) • Completely Connected: ~78 (many in the A-layer don’t have a power trunk yet). • Operating: ~66 (Bottom B & C-layer not operating, incomplete electronics) • Power Supply Operation: • A couple modules have been replaced. In retrospect, the problems have likely been related to the modules A.C. connections, rather than to component failure. • Plan to Finish: • Install 4 remaining LVPS after EF’s are closed. • Victor M. has material to make long power trunks. Install in 2-wk shutdown.

  5. PDT High Voltage • 94 PDT’s each have two H.V. inputs. • Operating Voltage • On mini-pdt (small length) • Wire: 4.65 kv Pad: 2.3 kv • On the real thing (not finalized?) • Wire: 4.7 kv Pad: 2.3 kv • Status of MCH2: • 2 Crates, 47 pods • All pods installed • All pods have been operated • Pods not tested for extended periods

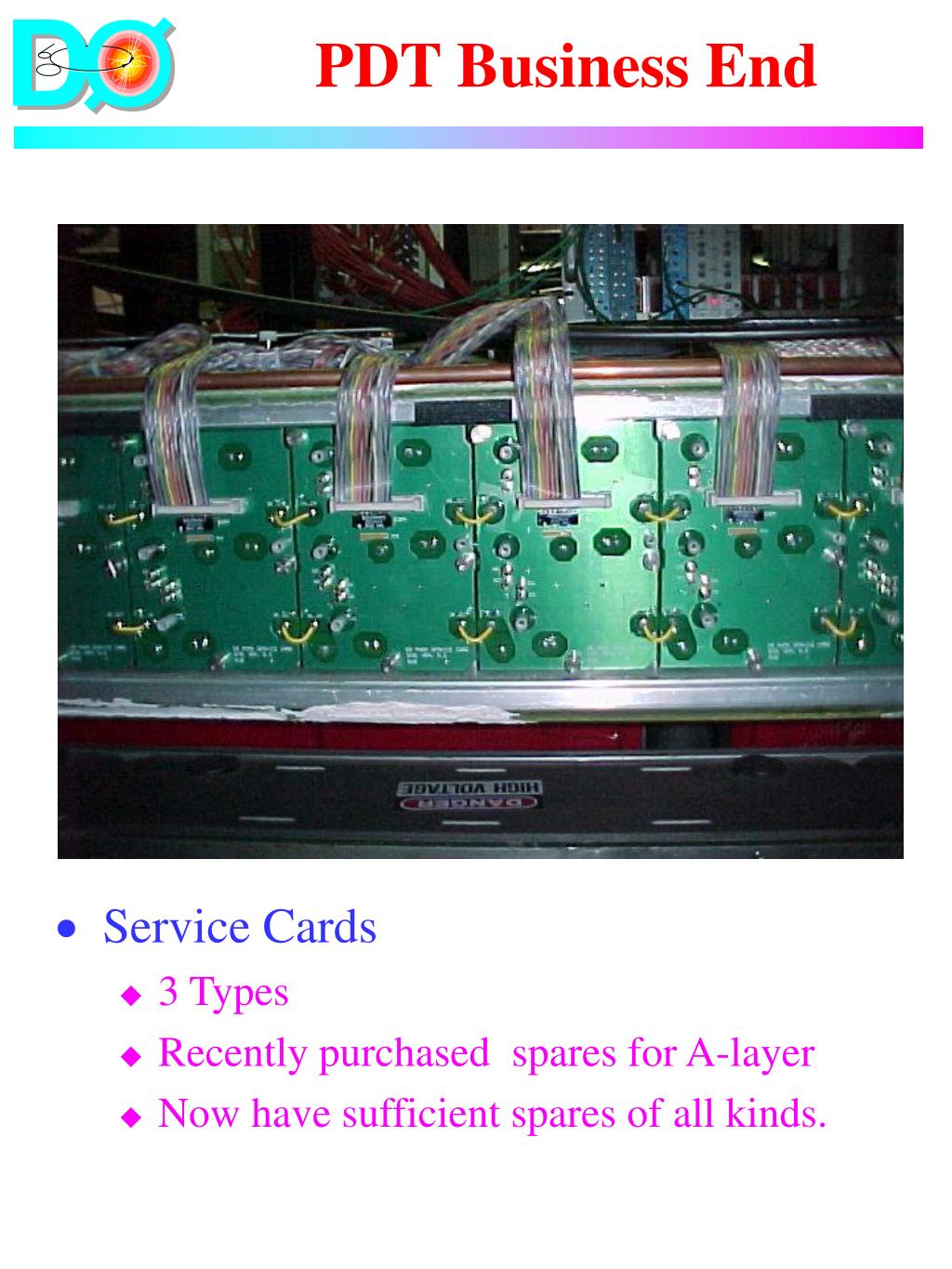

  6. PDT Business End • Service Cards • 3 Types • Recently purchased spares for A-layer • Now have sufficient spares of all kinds.

  7. HV On Detector • POD to PDT Map • Sensible division of PDT’s to Pods • Averages 2 PDT’s per pod • Large A-layer PDT’s each have own pods • Bottom A-layer PDT’s ganged 3/pod • Quiet Bottom C-layer PDT’s ganged 4/pod • See file http://wwwd0.fnal.gov/hardware/upgrade/muon_upgrade/Image3.gif • Tested recently to make sure pod # matched the appropriate Reynolds output. • 6 PDT’s (B&C-layer top east, octant 1) have been operated on a couple of gasses since last summer.

  8. HV Pod Map

  9. HV On Detector • 70 (-3) PDT’s are connected to HV pods. • 3 PDT’s (243, 135, 141) are disconnected because of broken wires. • 67 PDT’s OK at 200V on wire and pad • 36 PDT’s have been brought up to full voltage. • Plan: • Upon gas flow: bring the PDT’s to full voltage. Measure/track beam-off currents. • Finish cable installation in the 2 week shutdown • Repair/jumper cells with broken wires on access

  10. Summary • LVPS • 90/94ths installed • 66/94ths operating • No evidence of LVPS pod failure • Finish during the 2 wk shutdown. • High Voltage System • Infrastructure MCH2 complete • 67/94ths ready to be brought up to full voltage once gas is flowing. • Finish during the 2 wk shutdown.
