A TRUE CAPACITY PLAN IS A PROCESS NOT AN EVENT

A TRUE CAPACITY PLAN IS A PROCESS NOT AN EVENT. Joe Bell Senior Staff Regional Systems Engineer Fujitsu Technology Solutions Inc. joe_bell@ftsi.fujitsu.com 816-509-4084. 04/29/03. Agenda. A brief history of Capacity Planning Processes Mainframe days “Open Systems” beginnings

kalli
Télécharger la présentation

A TRUE CAPACITY PLAN IS A PROCESS NOT AN EVENT

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. A TRUE CAPACITY PLAN IS A PROCESSNOT AN EVENT Joe Bell Senior Staff Regional Systems Engineer Fujitsu Technology Solutions Inc. joe_bell@ftsi.fujitsu.com 816-509-4084 04/29/03

  2. Agenda • A brief history of Capacity Planning Processes • Mainframe days • “Open Systems” beginnings • What’s changed? • Why do we need Capacity Planning? • Basic Capacity Plan Process Components • Workload Analysis • Forecasting • Construct base plan and options • Revision and Technology Inputs • Procurement Analysis • Reporting • Refinement

  3. Agenda -continued • Erector Set Theory • Planning • Production • Verification • Implementation • Maintenance • Continuous Process Improvement • A Complete Process -top down • A Shortcut Process -bottom up • Summary • References

  4. A brief history of Capacity Planning Processes • Mainframe days • The Five Stages of Capacity Planning - Pat Artis • Stage 1 - Vendor control • Reporting Level -> Corporate Decision Makers (CIOs, Directors) • Written Documentation/Plans -> Marketing Proposals • Relation to Corporate Budget -> Synchronized to budget cycle for hardware line items • End User Considerations -> Little to none • Continuity -> Long Term Vendor Marketing Plan • Tools -> Rules of Thumb and Vendor Aids/Tools (proprietary) • Stage 2 - Special Studies • Written Documentation/Plans -> Three to Five year Plans • End User Considerations -> Initial Discussions, business overviews • Continuity -> None - One Time Study • Tools -> Rules of Thumb, Vendor Aids/Tools, Ad Hoc (build your own)

  5. A brief history of Capacity Planning Processes -continued • Mainframe days -continued • The Five Stages of Capacity Planning - Pat Artis • Stage 3 - Technician • Reporting Level -> First Level Technical Supervisors • Written Documentation/Plans -> Reams of detailed technical information, graphics, .. • Relation to Corporate Budget -> Typically none • End User Considerations -> Ineffective surveys or none • Continuity -> Ongoing effort • Tools -> Extensive tool development and acquisition • Stage 4 - Organizational Development • Reporting Level -> Technical Services / Operations • Written Documentation/Plans -> One/ two year plans distributed to management levels • Relation to Corporate Budget -> Timed to serve the budget cycle • End User Considerations -> Basic business requirements understanding • Continuity -> SLRs created & maintained, long range strategies developed • Tools -> Continued refinement • Stage 5 - Mature • Reporting Level -> CIO • Relation to Corporate Budget -> Current and future budget inputs • End User Considerations -> Detailed business requirements understanding

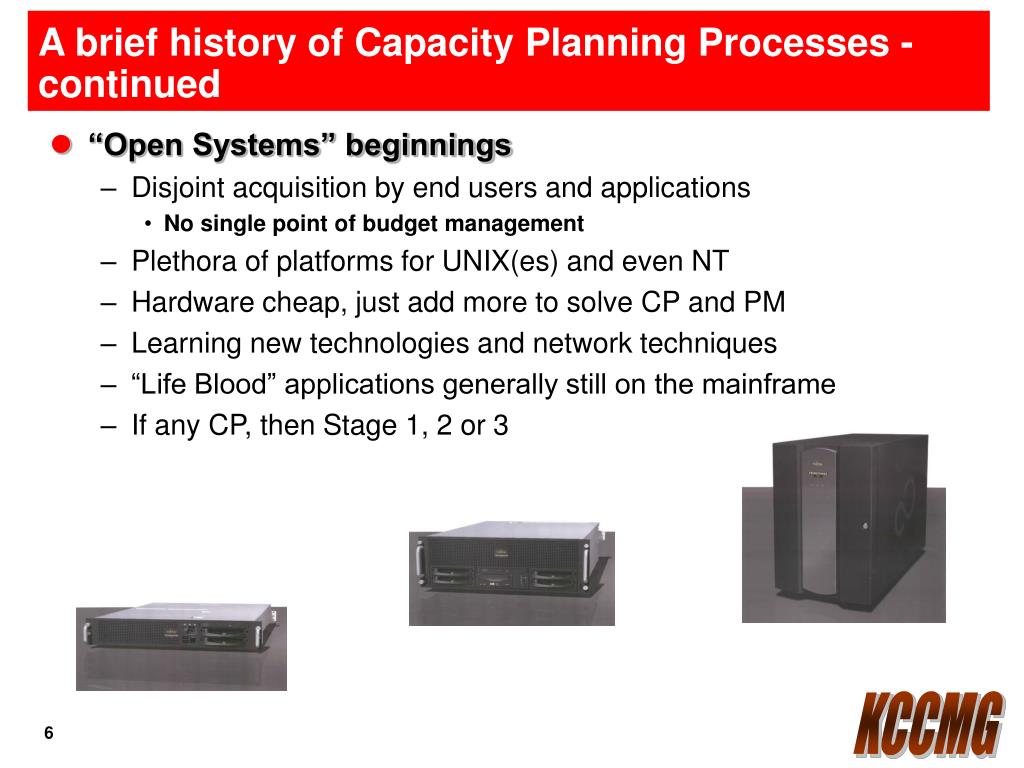

  6. A brief history of Capacity Planning Processes -continued • “Open Systems” beginnings • Disjoint acquisition by end users and applications • No single point of budget management • Plethora of platforms for UNIX(es) and even NT • Hardware cheap, just add more to solve CP and PM • Learning new technologies and network techniques • “Life Blood” applications generally still on the mainframe • If any CP, then Stage 1, 2 or 3

  7. A brief history of Capacity Planning Processes -continued • What’s changed? • Movement of disjoint departmental systems to the Glass House • Server Consolidations for platform and management efficiencies • Systems becoming more reliable and dependable • A handful of sophisticated high reliability, high performance Unix platforms (HPUX, AIX, Solaris,..) • Win 2000 and XP handling larger sophisticated applications • LINUX !! • Not safe to just throw resources at capacity shortages • Application, network and storage subsystem complexities • Many examples of failures, just ask SPEs • Just ask some .bombs and surviving .coms

  8. A brief history of Capacity Planning Processes -continued • What’s changed? • Application workloads growing at higher rates on “open” platforms • Movement of “Life Blood” applications to “open platforms” • Mainframes still do an excellent job, but at what cost? • Most vendor R&D directed to “open platforms” and supporting software • Hey, that hardware isn’t so cheap anymore! • Same for the software • LINUX current exception

  9. A brief history of Capacity Planning Processes -continued • Why do we need Capacity Planning? • You can’t control what you can’t measure • You can’t manage what you can’t control • Technology directions • Can Contribute to Planned strategy versus chaos • Budget expenditures • It’s easier to see where you’re going if you know where you’ve been • Instrumentation for critical management decisions • Couple IT resources with Business Requirements • Better support of the corporate business environment • Just in time resource control for reduced expenditures • It’s Addressed in META Group’s “Best Practices for Monitoring Web Applications” • Improve the Total Cost of Ownership (TCO) • Competitive Pricing • Well configured and balanced systems for top Performance • Fewer systems/Processors for simplified operations and Maintenance

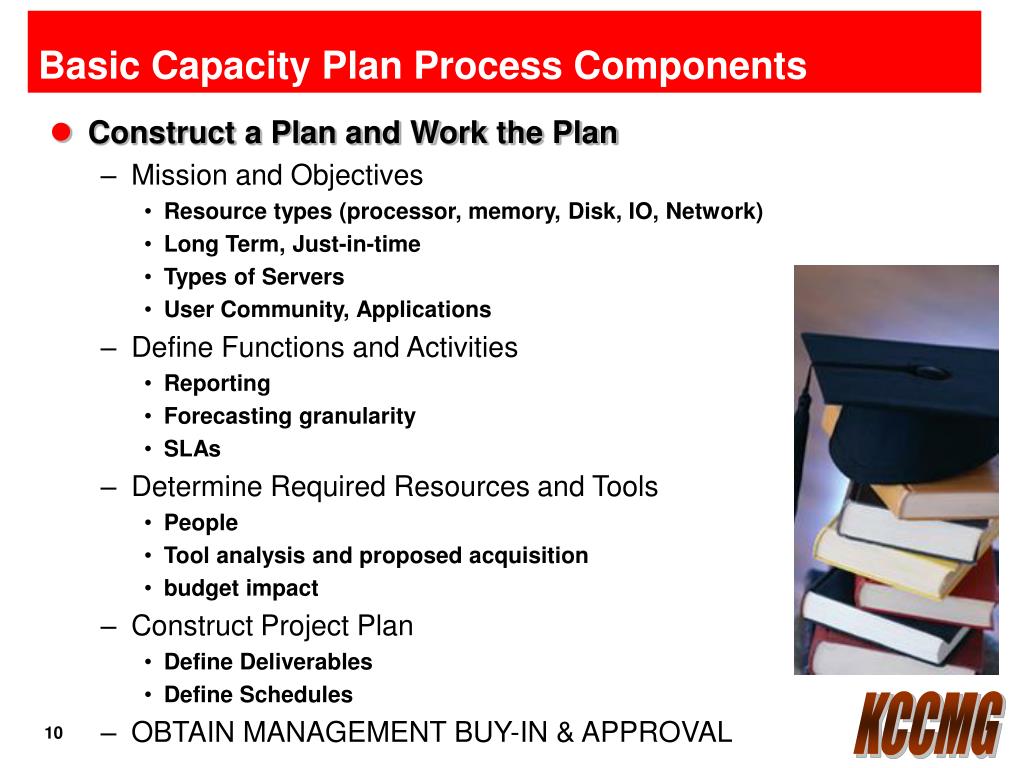

  10. Basic Capacity Plan Process Components • Construct a Plan and Work the Plan • Mission and Objectives • Resource types (processor, memory, Disk, IO, Network) • Long Term, Just-in-time • Types of Servers • User Community, Applications • Define Functions and Activities • Reporting • Forecasting granularity • SLAs • Determine Required Resources and Tools • People • Tool analysis and proposed acquisition • budget impact • Construct Project Plan • Define Deliverables • Define Schedules • OBTAIN MANAGEMENT BUY-IN & APPROVAL

  11. Basic Capacity Plan Process Components-continued • Workload Analysis • Define & Analyze current environment resource requirements • Processors, memory, Disk storage, Network bandwidth • System OS, Database(s), subsystems • Major application(s) (80/20 usually works) • Types (OLTP, Background/batch, web enabled) • SLAs • Concurrent users • Business drivers if available • Performance Profile Requirements • Peak versus Average utilization and ratios • response time requirements for servers, storage, network and users • Construct basic models • Statistical correlation and prediction • Analytical, simulation • Can Workload Types be Balanced (CPU, memory , IO , network) • Identify what’s important to the customer/user • Availability • Response Time • Cost • Scalability

  12. Basic Capacity Plan Process Components-continued • Conduct Forecasting Activities • Historical analysis where appropriate • Required for time series regressions • Good to do anyway for information on historical activity • Gather inputs from application development activities • New applications • New application functionality • They probably won’t have a feel for sizing, try similar and box car • Get with Business Units that depend upon IT resources • A well run business activity will have it’s own forecasts • There may be units that will correlate to application resources • Interview Upper Level Management for other information • Utilize statistical or/and Analytical models • Use Statistics for future based on history • Use analytic for future based on current plus new event approximation

  13. Basic Capacity Plan Process Components-continued • Construct a basic Capacity Plan • The Way Things Are • History and current • Annotated Graphs for events • The Way Things Will Be • Forecasts by application/server • Annotated Graphs with events • Requirements on resources due to business and application changes • Options Analysis • By resource you’re covering (server, memory, IO, Disk, Network) • By vendor/architecture within resource • Use those that satisfy all business requirements, stds. • Create an Executive Summary with all important issues • Include a pricing section if you have any cost data • Some organizations will keep this separate • Some will require option pricing in the Capacity Plan

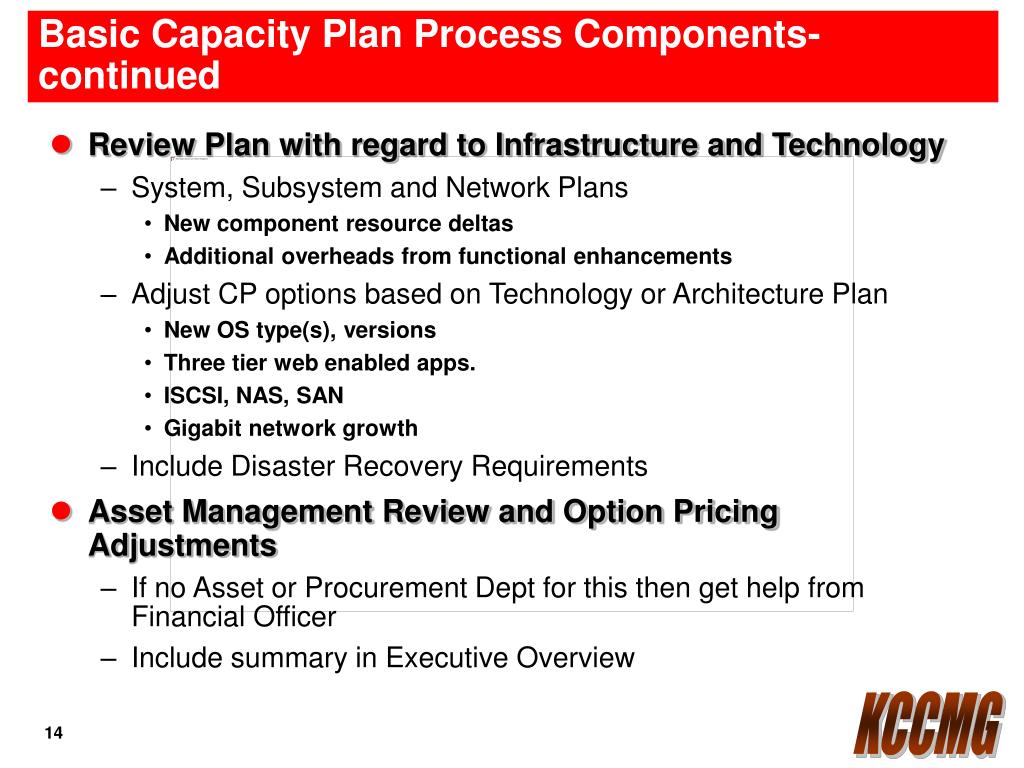

  14. Basic Capacity Plan Process Components-continued • Review Plan with regard to Infrastructure and Technology • System, Subsystem and Network Plans • New component resource deltas • Additional overheads from functional enhancements • Adjust CP options based on Technology or Architecture Plan • New OS type(s), versions • Three tier web enabled apps. • ISCSI, NAS, SAN • Gigabit network growth • Include Disaster Recovery Requirements • Asset Management Review and Option Pricing Adjustments • If no Asset or Procurement Dept for this then get help from Financial Officer • Include summary in Executive Overview

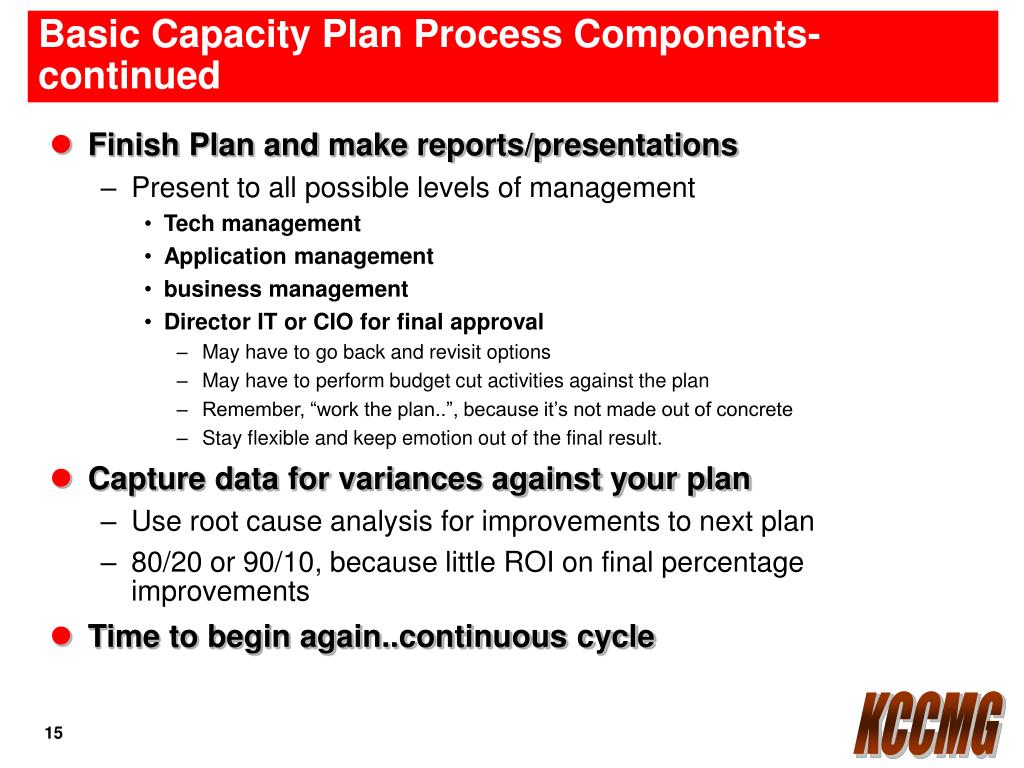

  15. Basic Capacity Plan Process Components-continued • Finish Plan and make reports/presentations • Present to all possible levels of management • Tech management • Application management • business management • Director IT or CIO for final approval • May have to go back and revisit options • May have to perform budget cut activities against the plan • Remember, “work the plan..”, because it’s not made out of concrete • Stay flexible and keep emotion out of the final result. • Capture data for variances against your plan • Use root cause analysis for improvements to next plan • 80/20 or 90/10, because little ROI on final percentage improvements • Time to begin again..continuous cycle

  16. Erector Set Theory • A Manufacturing Approach to CP • Planning • customer requirements, scope and content, schedules, critical success factors, planning aids • Construction • Gather raw materials, create components, test individual components, distribute analysis to concerned parties, combine components • Verification • Component testability, discrete and measurable assumptions, coherency test, rework time • Implementation • Marketing and distribution for customer acceptance • Maintenance • Expect it, planned enhancements, monthly reporting (forecast to actual), periodic revisions • Continuous Process Improvement -zero defect goal- process verification

  17. Erector Set Theory -continued • Underlying Tools and Methodologies • Benchmarking • Customer Interviews • Basic Regression Analysis • Advanced Regression Analysis • Queueing Theory and Analytic Models • Financial Analysis

  18. A Complete Process -top down • Capacity Plan Process • Develop Master Schedule • Construct Base Plan • Collect Historical CPU Usage • Collect Historical Memory Usage • Collect Historical DASD Usage • Build Baseline Models, Best/I • Itemize Application Events • Collect Business Indicators • Itemize Other Events • Size Application Events • Develop Business Units or NFU Forecasts • Size Other Events • Build Consolidated Forecast • Define Current Configurations • Input the Technology Plan • Determine Workload Placement • Recommend Hardware Platforms • Build Growth Models

  19. A Complete Process -top down -continued • Capacity Plan Process -continued • Construct Consolidated Plan • Distribute Base Plan to all CP and Tech personnel • Input Disaster Recovery Plan • Input Financial Analysis • Input Facilities Plan • Input Performance Management Plan • Develop Plan Text • Inputs from Project Implementation Groups • Input Software Support & Maintenance Plans • Input Operations Plan • Input Network Plan • Input Hardware and Software Financial Analysis • Consolidate Financial Impacts • Consolidate Plan Document • Obtain Executive Approval • Distribute the Plan • Conduct process measures and variance analysis

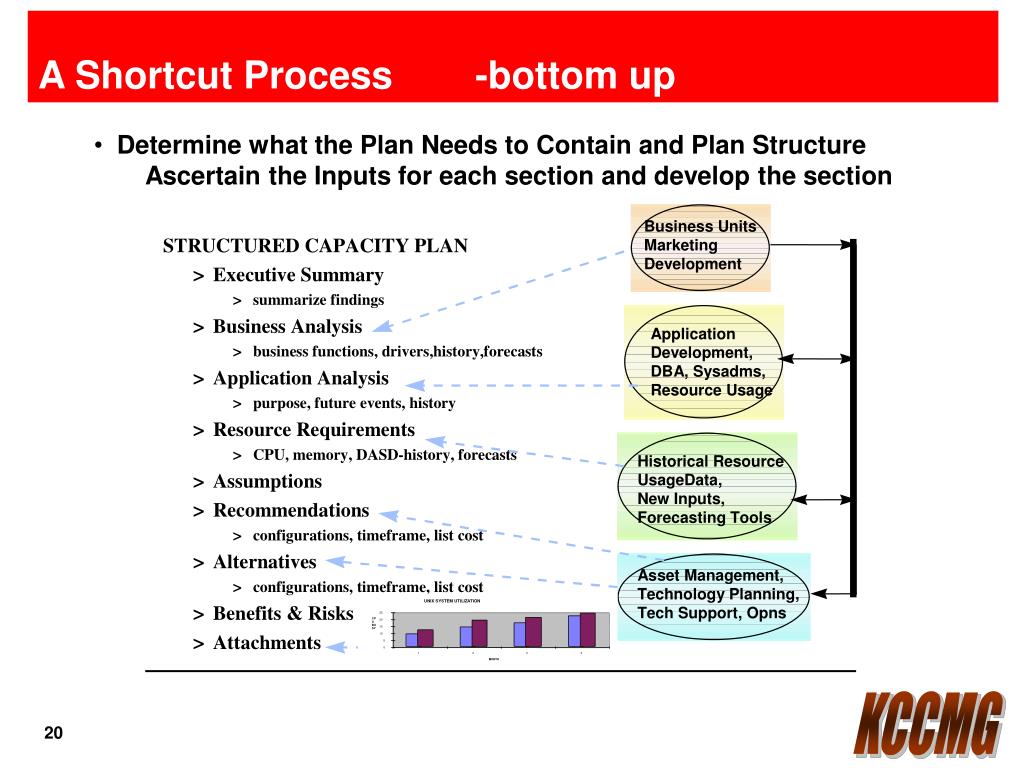

  20. A Shortcut Process -bottom up • Determine what the Plan Needs to Contain and Plan Structure • Ascertain the Inputs for each section and develop the section

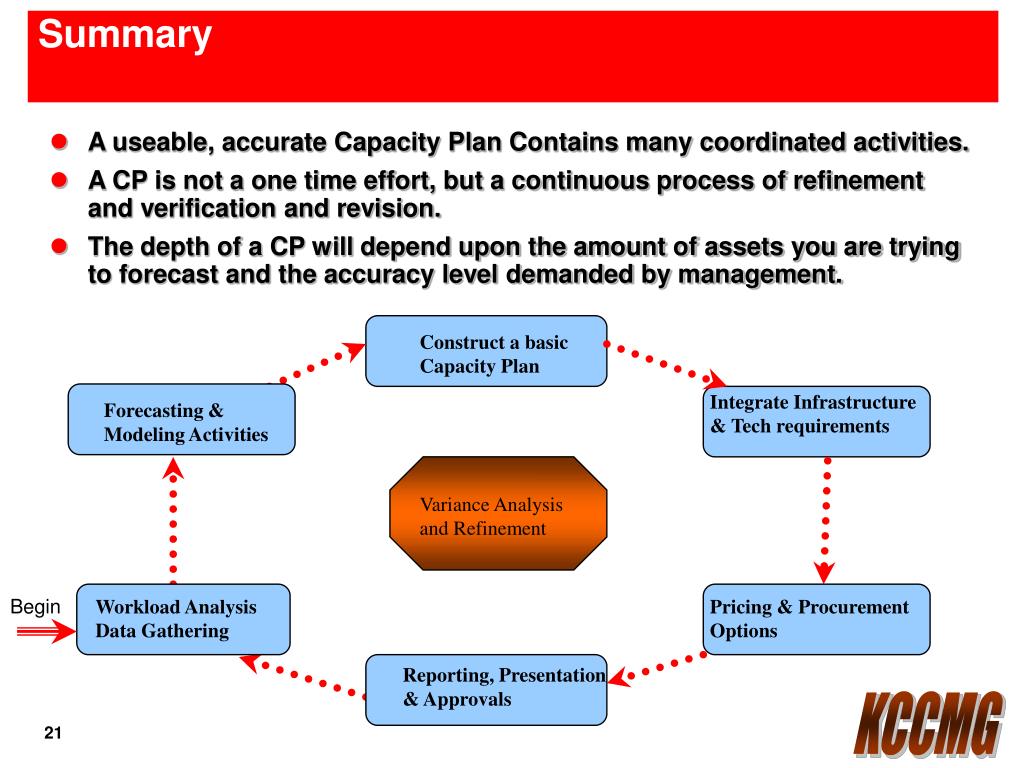

  21. Summary • A useable, accurate Capacity Plan Contains many coordinated activities. • A CP is not a one time effort, but a continuous process of refinement and verification and revision. • The depth of a CP will depend upon the amount of assets you are trying to forecast and the accuracy level demanded by management. Construct a basic Capacity Plan Integrate Infrastructure & Tech requirements Forecasting & Modeling Activities Variance Analysis and Refinement Begin Workload Analysis Data Gathering Pricing & Procurement Options Reporting, Presentation & Approvals

  22. References • Carroll, J. R. & Cool, W. S., “Surviving My First Client/Server, Distributed Systems Capacity Study”, CMG94 Proceedings, 1994. • Bell, J.E. & McCord, D.W., “ESTABLISHING A UNIX MID-RANGE CAPACITY AND PERFORMANCE MANAGEMENT ENVIRONMENT”, CMG95 Proceedings, 1995. • Olsen, L., “Erector Set Theory, A Capacity Planning Approach”, KCCMG, 1993. • Howell, J., “Workload Analysis”, Fujitsu Technology Solutions RSE Training, 2003. • Bell, J.E., “The Origination, Evolution and Future of CRM”, CMG89 Proceedings, 1989. • Artis, P., “The Five Stages of Capacity Planning”, CMG85 Proceedings, 1985. • Thompson, G.I., “Six Levels of Sophistication for Capacity Management”, CMG2000 Proceedings, 2000.
