An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Beam Intrumentation in the PS BOOSTER injection region J. Tan On behalf of BE-BI group Follow-up review on PSB 160 MeV H- Injection CERN 20 March 2012

  2. Outline • Dump current monitor • Screens at Stripping foil location • Beam trajectories • Beam Loss Monitors • Summary

  3. Status of DUMP current monitors • From initial specs: 2 independent channels (plates) → Signal H0/H- ~ 1000 → 2 differents electronics? • 1 pair of polarization plate for both channels • ACTION 12 all mechanical aspects prepared by BI will be transmitted to EN/STI for integration with their DUMP (support, insulated spacer dimension, feed through, etc…) → 2012 quarter 2 ? • BI-PM will provide the electronics based on the integrator module under development for PS SEM • → 2012 quarter 3 or 4 • - ACTION 19 : From review follow-up: determining injected beam angle at foil • Request not included in initial specs • Need more details about requirements (resolution, threshold) • Not trivial development: segmented plates?

  4. Stripping foil : Status of BTV • Work on these monitors restarts only after the winter technical stop • The mechanism will be designed around the solution proposed for: • easier maintenance (only 1 movement) • visualisation of the stripping foil from beam side • visualisation of the beam screen from beam side as well • ACTION 14 From April 1st, Axel Ravni (mechanical engineer) joins the ML team and will be in charge of the mechanical design under the supervision of BI colleagues: • Preparation of a ‘model’ (not motorized) to be inserted in the stripping foil prototype → validate space/mechanical obstruction to avoid April/May • Design screen insertion device (electrical rotary movement) May/June/July • Order parts / machining for a prototype August/September/October • Mounting prototype October • Test in stripping foil prototype October/November • → Green light to launch 4 monitors + 1 spare (~ 6 months) • Interlock design to be discussed with TE/ABT (hardware or/and software) • Integration of entire monitor to be done (camera, support, RAD BOX, etc…) when the system will be precisely defined • Electronics/Detector • - use ‘standard’ BTV hardware • - use Vidicon tube based camera

  5. Screen mechanism idea Injected beam Circulating beam • H- beam observed • Image of front of screen and front of foil • Fixed mirror inside the chamber -> single movement (screen) • Tricky design of supports (tilted)

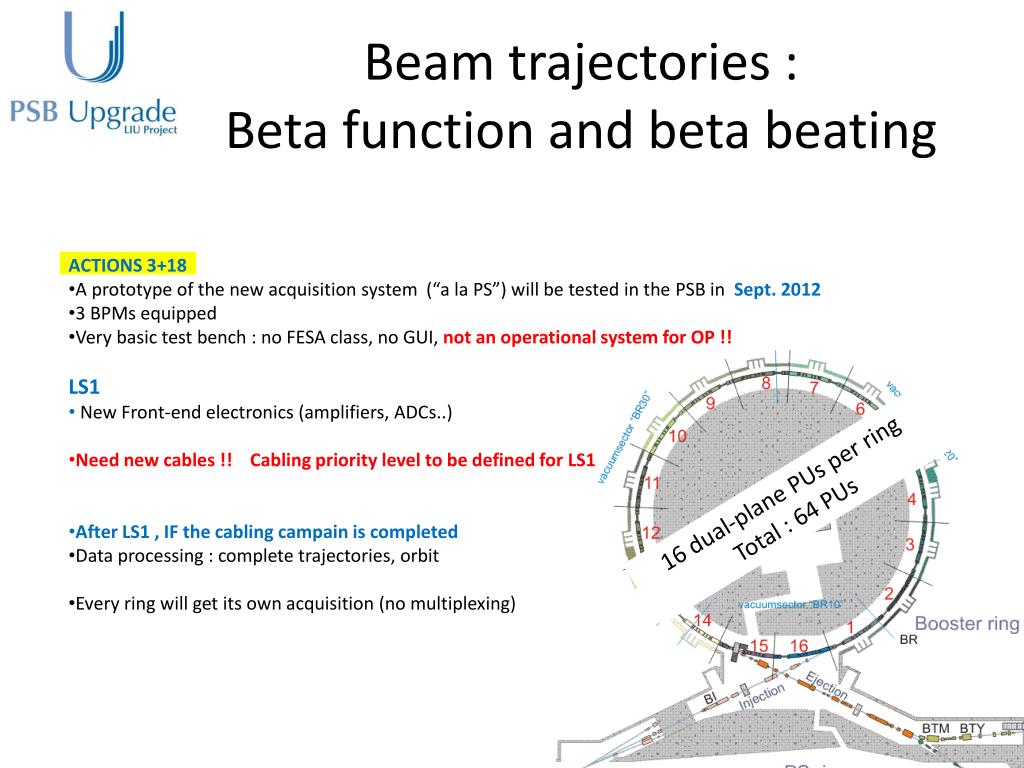

  6. Beam trajectories :Beta function and beta beating • ACTIONS 3+18 • A prototype of the new acquisition system (“a la PS”) will be tested in the PSB in Sept. 2012 • 3 BPMs equipped • Very basic test bench : no FESA class, no GUI, not an operational system for OP !! • LS1 • New Front-end electronics (amplifiers, ADCs..) • Need new cables !! Cabling priority level to be defined for LS1 • After LS1 , IF the cabling campain is completed • Data processing : complete trajectories, orbit • Every ring will get its own acquisition (no multiplexing) 16 dual-plane PUs per ring Total : 64 PUs

  7. BLMs • Loss monitor coverage • Present status : one pair of ACEMs per period • BI agrees to implement : • 32 LHC type BLMs (IC) • 32 BLMsadditional pairs of LICs upstream QDs • But we need new cables !! Cabling priority level to be defined for LS1 • Injection zone • ACTION 20 • BI agrees to implement : • 12 LICs around the BSW magnets • 8 diamond detectors connected to OASIS to perform turn by turn injection loss studies • Interlock design to be discussed with TE/ABT (hardware or/and software) • But we need new cables !! Cabling priority level to be defined for LS 1.5

  8. Summary Actions have been addressed by the Beam Instrumentation Group and are being followed-up Close collaboration with stripping foil and dump specialists Concerns about the feasibility of BLMs and BPMs changes due to cabling priorities in the PSB
