LS1 plan

LS1 plan. LS1 will start towards end November 2012 (week 48) and will last for approximately 1 ½ years (i.e. till July 2014), this corresponds to approximately 80 weeks. Baseline sequence: Add 5 TRD modules Add 6 DCal supermodules and 2 1/3 supermodules Add 1 PHOS module

lew
Télécharger la présentation

LS1 plan

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript

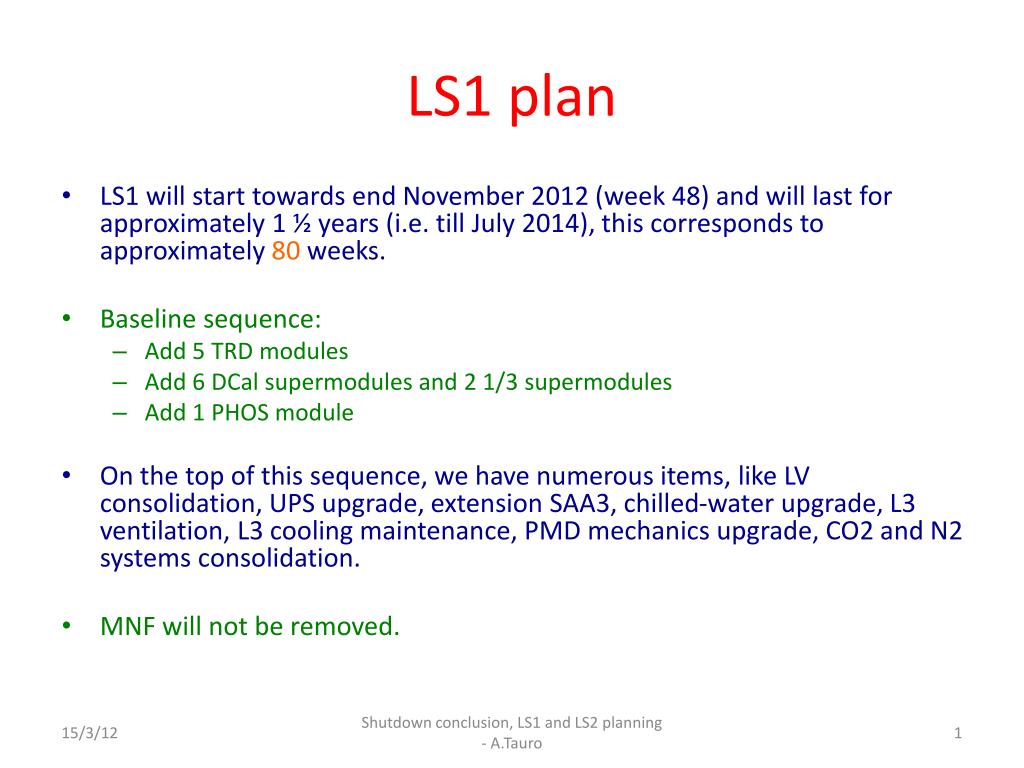

  1. LS1 plan • LS1 will start towards end November 2012 (week 48) and will last for approximately 1 ½ years (i.e. till July 2014), this corresponds to approximately 80 weeks. • Baseline sequence: • Add 5 TRD modules • Add 6 DCal supermodules and 2 1/3 supermodules • Add 1 PHOS module • On the top of this sequence, we have numerous items, like LV consolidation, UPS upgrade, extension SAA3, chilled-water upgrade, L3 ventilation, L3 cooling maintenance, PMD mechanics upgrade, CO2 and N2 systems consolidation. • MNF will not be removed. Shutdown conclusion, LS1 and LS2 planning - A.Tauro

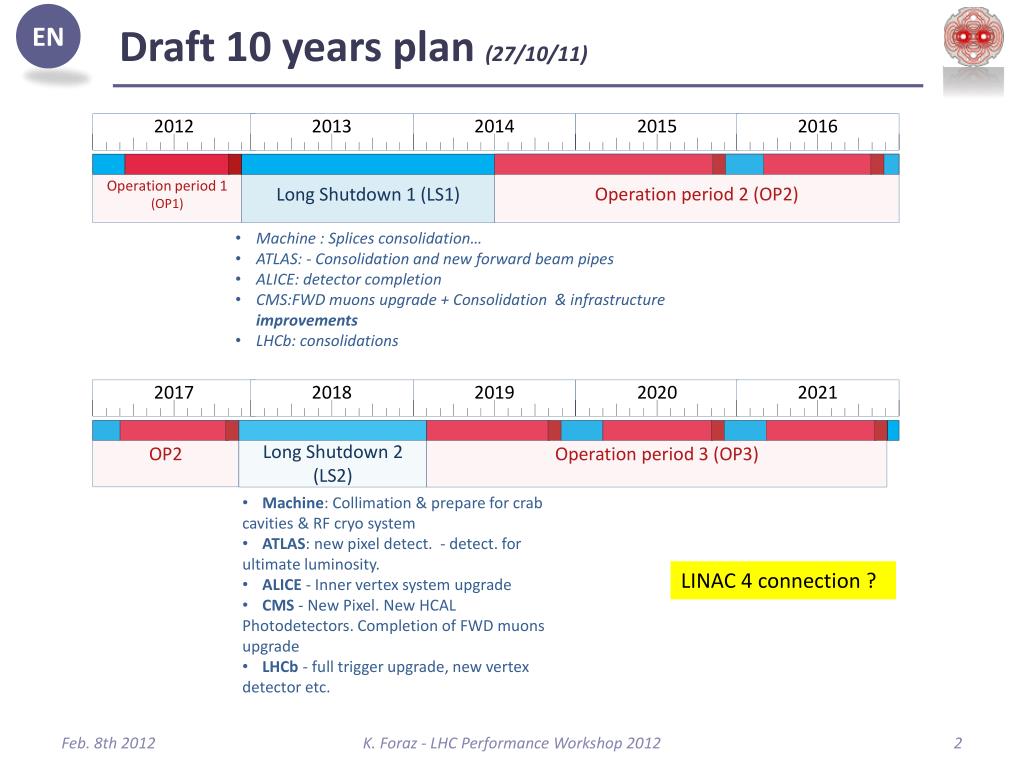

  2. Draft 10 years plan (27/10/11) 2012 2013 2014 2020 2015 2017 2018 2019 2021 2016 Operation period 2 (OP2) Operation period 1 (OP1) Long Shutdown 1 (LS1) • Machine : Splices consolidation… • ATLAS: - Consolidation and new forward beam pipes • ALICE: detector completion • CMS:FWD muons upgrade + Consolidation & infrastructure improvements • LHCb: consolidations Operation period 3 (OP3) Long Shutdown 2 (LS2) OP2 • Machine: Collimation & prepare for crab cavities & RF cryo system • ATLAS: new pixel detect. - detect. for ultimate luminosity. • ALICE - Inner vertex system upgrade • CMS - New Pixel. New HCAL Photodetectors. Completion of FWD muons upgrade • LHCb - full trigger upgrade, new vertex detector etc. LINAC 4 connection ? K. Foraz - LHC Performance Workshop 2012

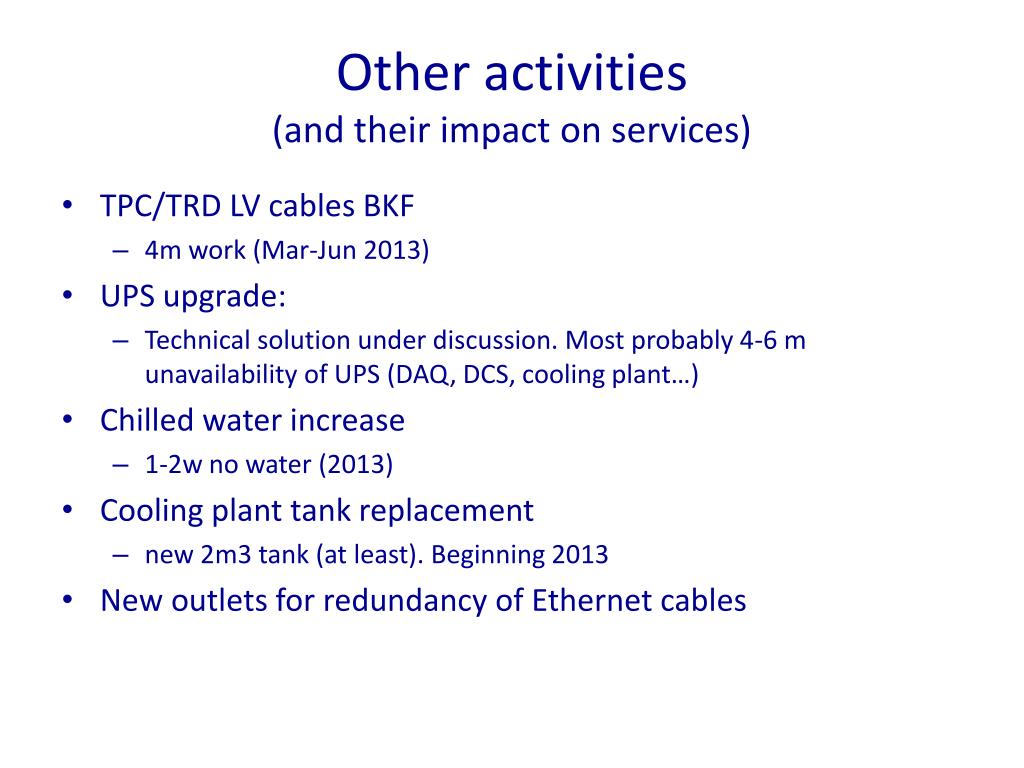

  3. Other activities(and their impact on services) • TPC/TRD LV cables BKF • 4m work (Mar-Jun 2013) • UPS upgrade: • Technical solution under discussion. Most probably 4-6 m unavailability of UPS (DAQ, DCS, cooling plant…) • Chilled water increase • 1-2w no water (2013) • Cooling plant tank replacement • new 2m3 tank (at least). Beginning 2013 • New outlets for redundancy of Ethernet cables

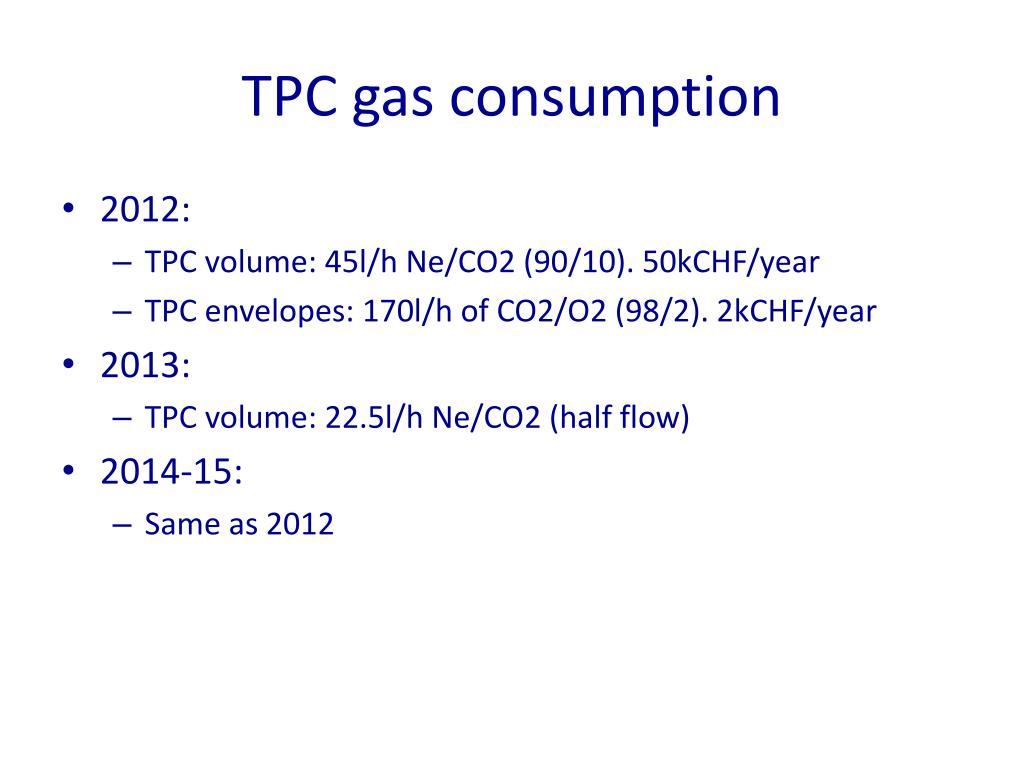

  4. TPC gas consumption • 2012: • TPC volume: 45l/h Ne/CO2 (90/10). 50kCHF/year • TPC envelopes: 170l/h of CO2/O2 (98/2). 2kCHF/year • 2013: • TPC volume: 22.5l/h Ne/CO2 (half flow) • 2014-15: • Same as 2012

  5. backup

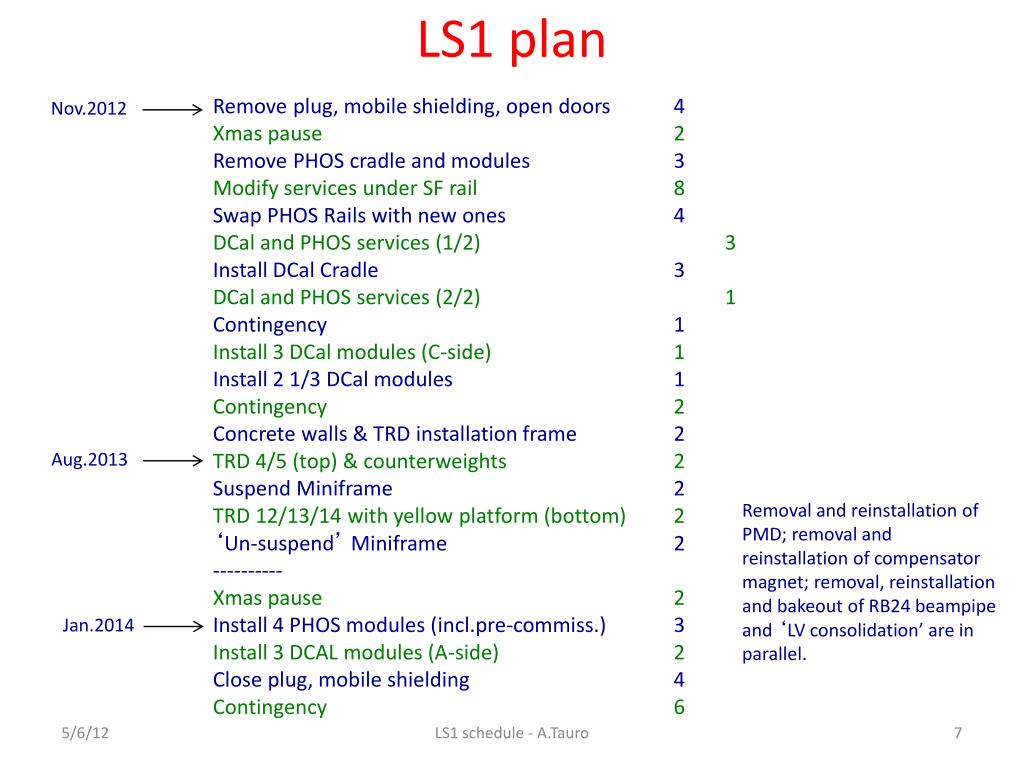

  6. LS1 plan Remove plug, mobile shielding, open doors 4 Xmas pause 2 Remove PHOS cradle and modules 3 Modify services under SF rail 8 Swap PHOS Rails with new ones 4 DCal and PHOS services (1/2) 3 Install DCal Cradle 3 DCal and PHOS services (2/2) 1 Contingency 1 Install 3 DCal modules (C-side) 1 Install 2 1/3 DCal modules 1 Contingency 2 Concrete walls & TRD installation frame 2 TRD 4/5 (top) & counterweights 2 Suspend Miniframe 2 TRD 12/13/14 with yellow platform (bottom) 2 ‘Un-suspend’ Miniframe 2 ---------- Xmas pause 2 Install 4 PHOS modules (incl.pre-commiss.) 3 Install 3 DCAL modules (A-side) 2 Close plug, mobile shielding 4 Contingency 6 Nov.2012 Aug.2013 Removal and reinstallation of PMD; removal and reinstallation of compensator magnet; removal, reinstallation and bakeout of RB24 beampipe and ‘LV consolidation’ are in parallel. Jan.2014 LS1 schedule - A.Tauro
