CTS Advisory Council

CTS Advisory Council. State Data Center Projects February 6, 2013. SDC Projects Underway. *. * Includes CTS hosted and managed systems moving from OB2 to SDC Data Hall 1. A la Carte systems will remain in OB2 for foreseeable future. SDC Projects Updates. SDC Facilities Readiness

manning
Télécharger la présentation

CTS Advisory Council

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. CTS Advisory Council State Data Center Projects February 6, 2013

  2. SDC Projects Underway * * Includes CTS hosted and managed systems moving from OB2 to SDC Data Hall 1. A la Carte systems will remain in OB2 for foreseeable future.

  3. SDC Projects Updates • SDC Facilities Readiness • Completed operational readiness activities in January, including physical security infrastructure, power installation, fiber terminations, and enclosure installations. • Using interim data center space management and physical security policies and procedures. Working on final versions. • Network Core Project • Final network components migrated from OB2 to the SDC on 1/12 • Project team is now focused on project clean up, close out, and celebration

  4. SDC Projects Updates con’t • Security • Installation and configuration of Fortinet gear completed. • Will turn focus to preparing for pilots in February. • Storage • VMAX delivered and installed in December. • Cisco Network Ready For Use (NRFU) tests completed in January. • Working with EMC & Presidio to test and accept system. • Will turn focus to preparing for pilots in March.

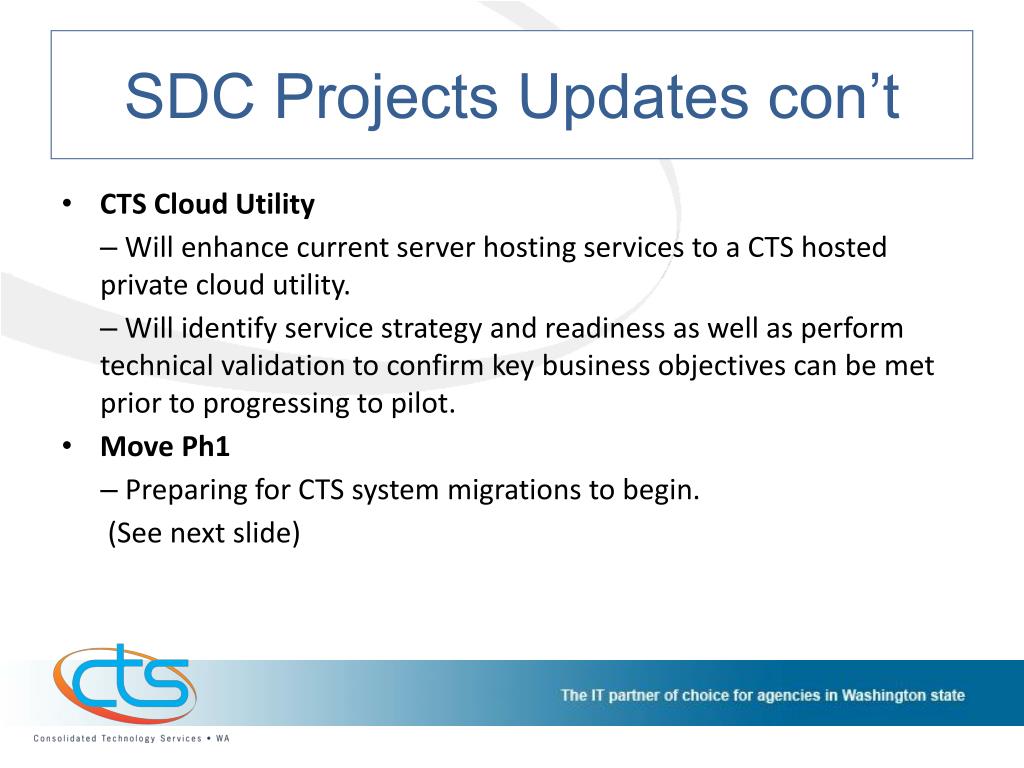

  5. SDC Projects Updates con’t • CTS Cloud Utility • Will enhance current server hosting services to a CTS hosted private cloud utility. • Will identify service strategy and readiness as well as perform technical validation to confirm key business objectives can be met prior to progressing to pilot. • Move Ph1 • Preparing for CTS system migrations to begin. (See next slide)

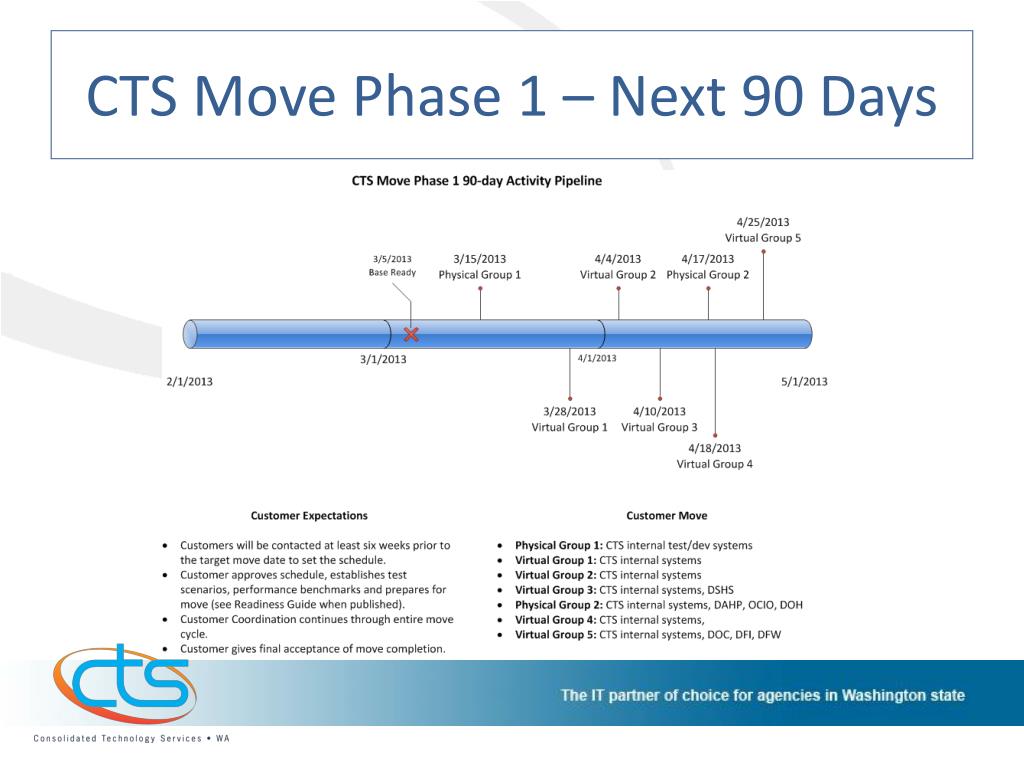

  6. CTS Move Phase 1 – Next 90 Days

  7. Customer Engagement • Monthly Agency Implementation Coordinator (AIC) meetings share information & promote a collaborative dialogue • December meeting reviewed SDC strategy, overall project organization, and three categories of migrations (Move Ph1, Storage, and Firewall) • January meeting reviewed project status and new documentation (Engagement Plan and FAQ) and website (Migration Calendar) • Regular project meetings with customer(s) as we move closer to specific implementations. • Email and periodic newsletters. • Customer action item log to track readiness progress and activities. • Customer issue log to track questions, inquiries, and issues.

  8. Project Status on the Internet

  9. Customer Readiness Page

  10. SDC Migration Calendar Note: this page can be viewed by users within the SGN. We will distribute the calendar to external coordinators via the newsletter.

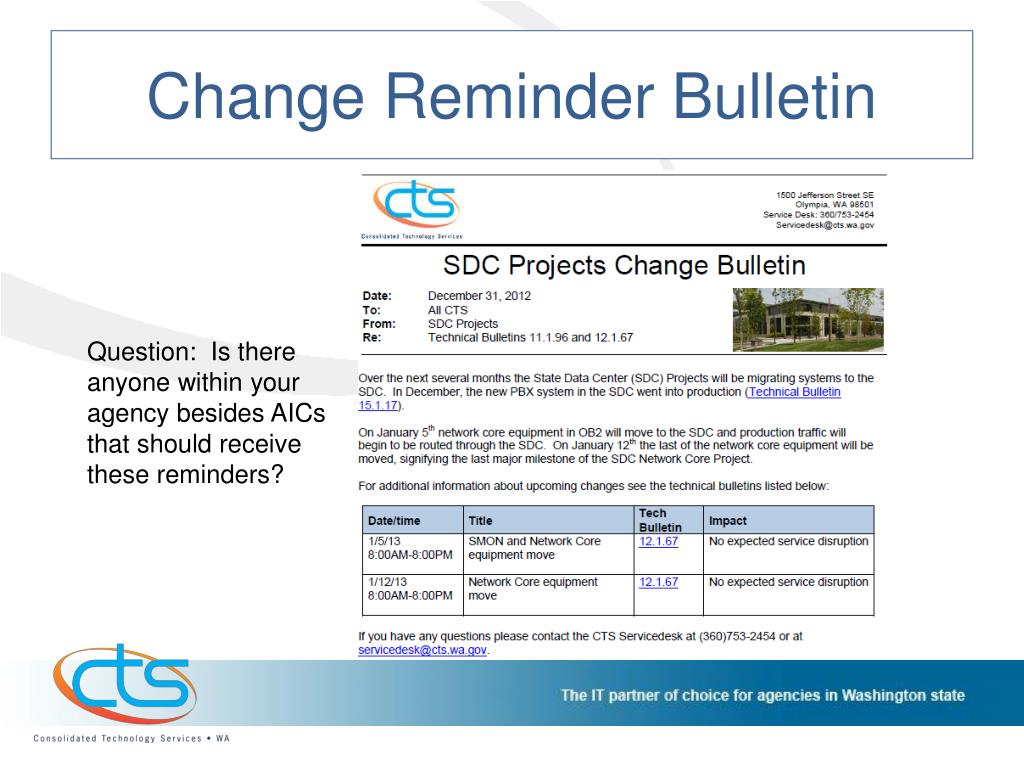

  11. Change Reminder Bulletin Question: Is there anyone within your agency besides AICs that should receive these reminders?
