Managing Project Planning Risk

Fouzi A. Hossen. Managing Project Planning Risk. Risk and Uncertainty Objectives Project risk management PRM process Capital good companies Product structure Industrial case study Conclusions. Overview.

mimis
Télécharger la présentation

Managing Project Planning Risk

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Fouzi A. Hossen Managing Project Planning Risk

  2. Risk and Uncertainty Objectives Project risk management PRM process Capital good companies Product structure Industrial case study Conclusions Overview

  3. Risk is defined as “the exposure to the possibility of economic and financial loss or gain, physical damage or injury, or delay as a consequence of the uncertainty associated with pursuing a particular course of action” (Chapman et al., 1991). Project risk exists where uncertainty threaten the project’s ability to meet its objectives within the given limitations (CCTA,1996) Risk

  4. Uncertainty is defined as “the unknown future event that cannot be predicted quantitatively within useful limits” (APICS, 1998, p98). Uncertainty has a common meaning which is the lack of certainty; risk also has general meaning which is the exposure to loss or injury as a consequence of uncertainty (Chapman et al., 1987). Uncertainty

  5. The objectives of the paper are to: Review the literature relating to the project risk management process; Investigate the risk associated with project scheduling that result from activity duration uncertainty; Analyse the activity completion time risk quantitatively by developing a simulation model. Objectives

  6. The PRM process is defined as “the process of taking management action in order to respond appropriately to all identified risks to maximise the likelihood of the project meeting its objectives within its constraints, by monitoring risk exposure and adjusting project strategy to keep risk within acceptable levels” (CCTA, 1996, p12). Project risk management PRM process

  7. Project risk management PRM process • Risk identification • Risk Analysis - Qualitative risk analysis - Quantitative risk analysis • Risk mitigation • Risk Monitoring and follow up Project risk Management process

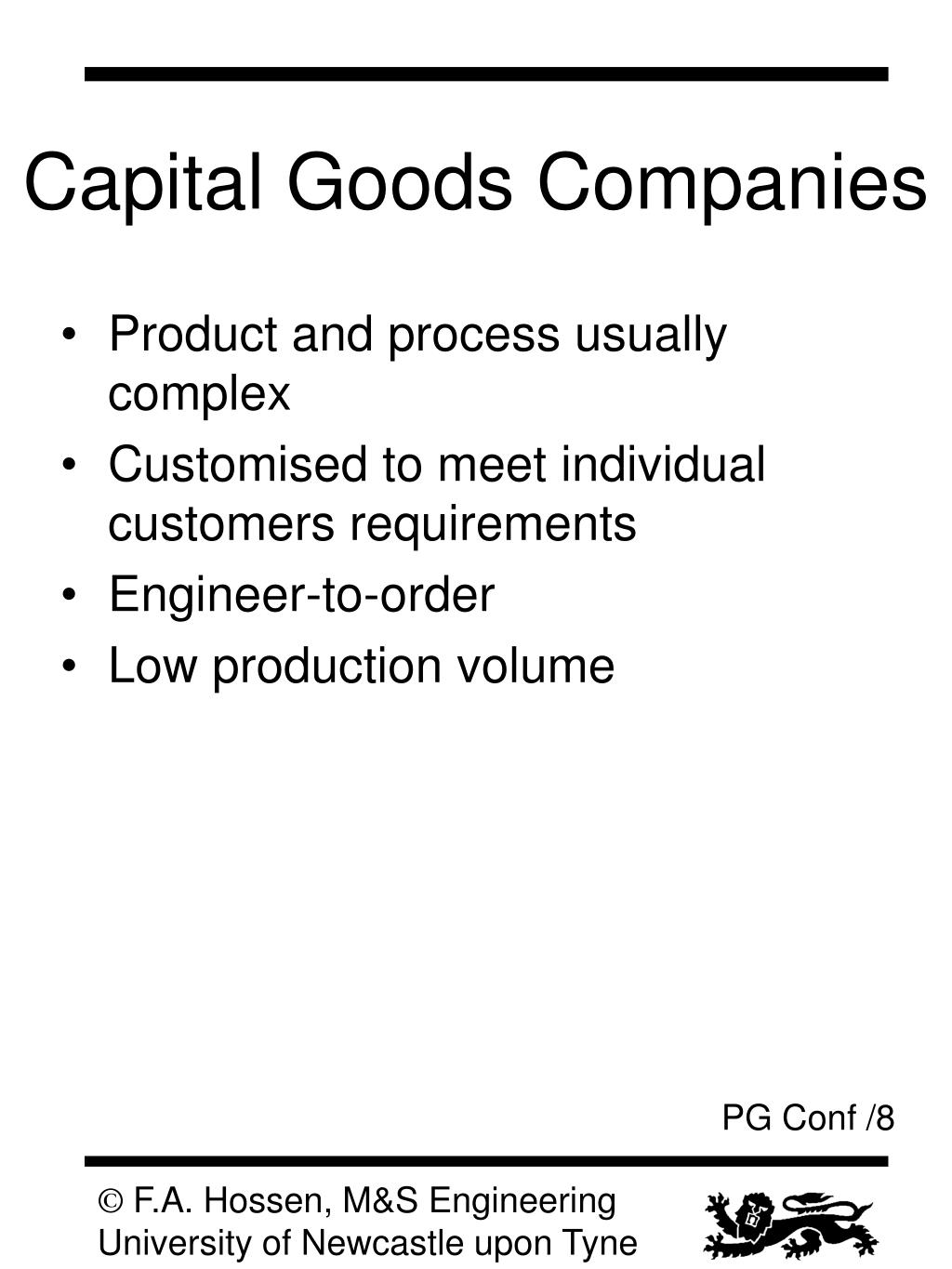

  8. Product and process usually complex Customised to meet individual customers requirements Engineer-to-order Low production volume Capital Goods Companies

  9. Product Structure See the product structure considered in this study

  10. Industrial case study Component finishing time Assembly finishing time

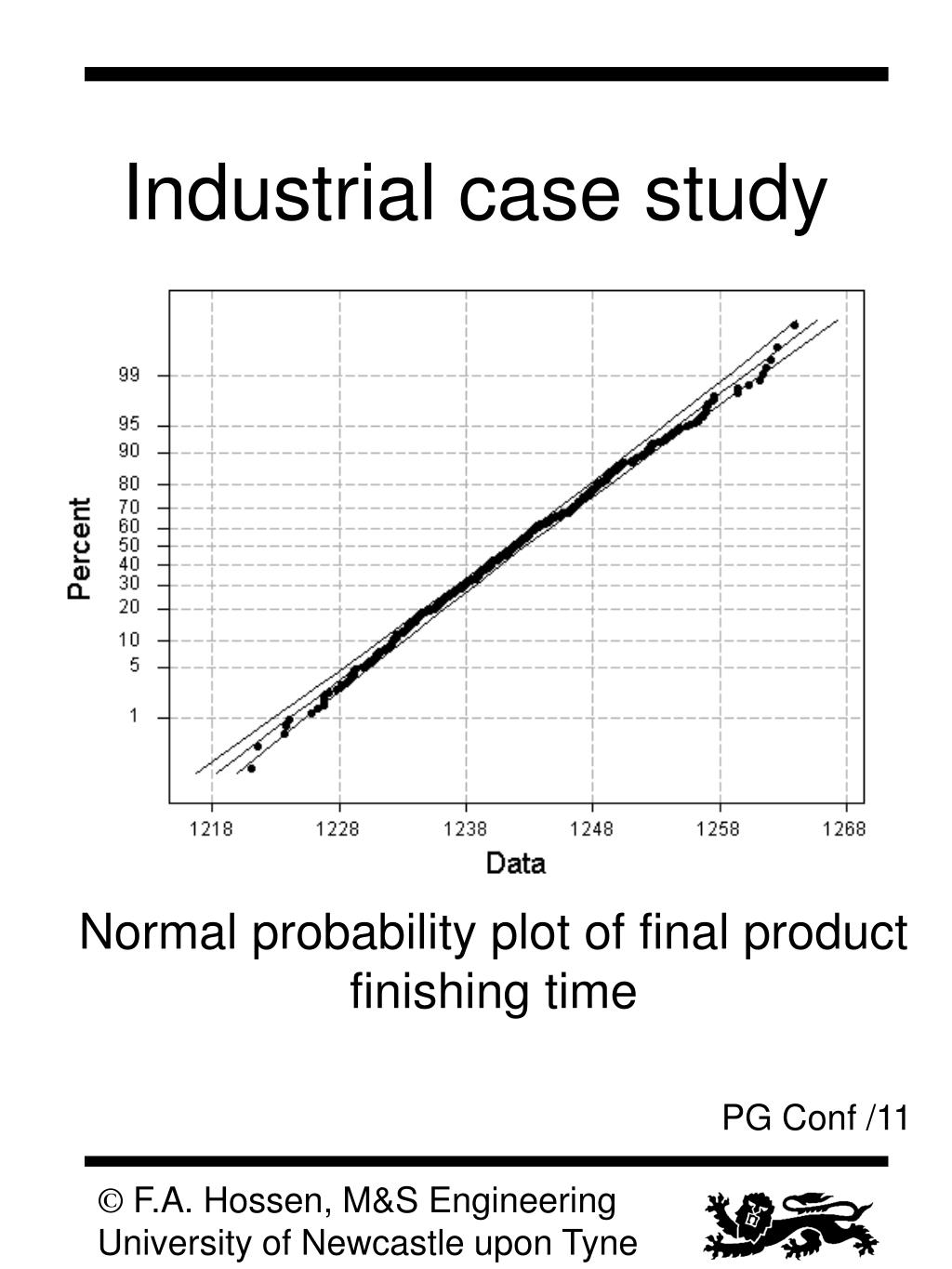

  11. Industrial case study Normal probability plot of final product finishing time

  12. Industrial case study 0.1 Sd Due date Final product finishing time 0.2 Sd Final product finishing time 0.3 Sd Final product finishing time

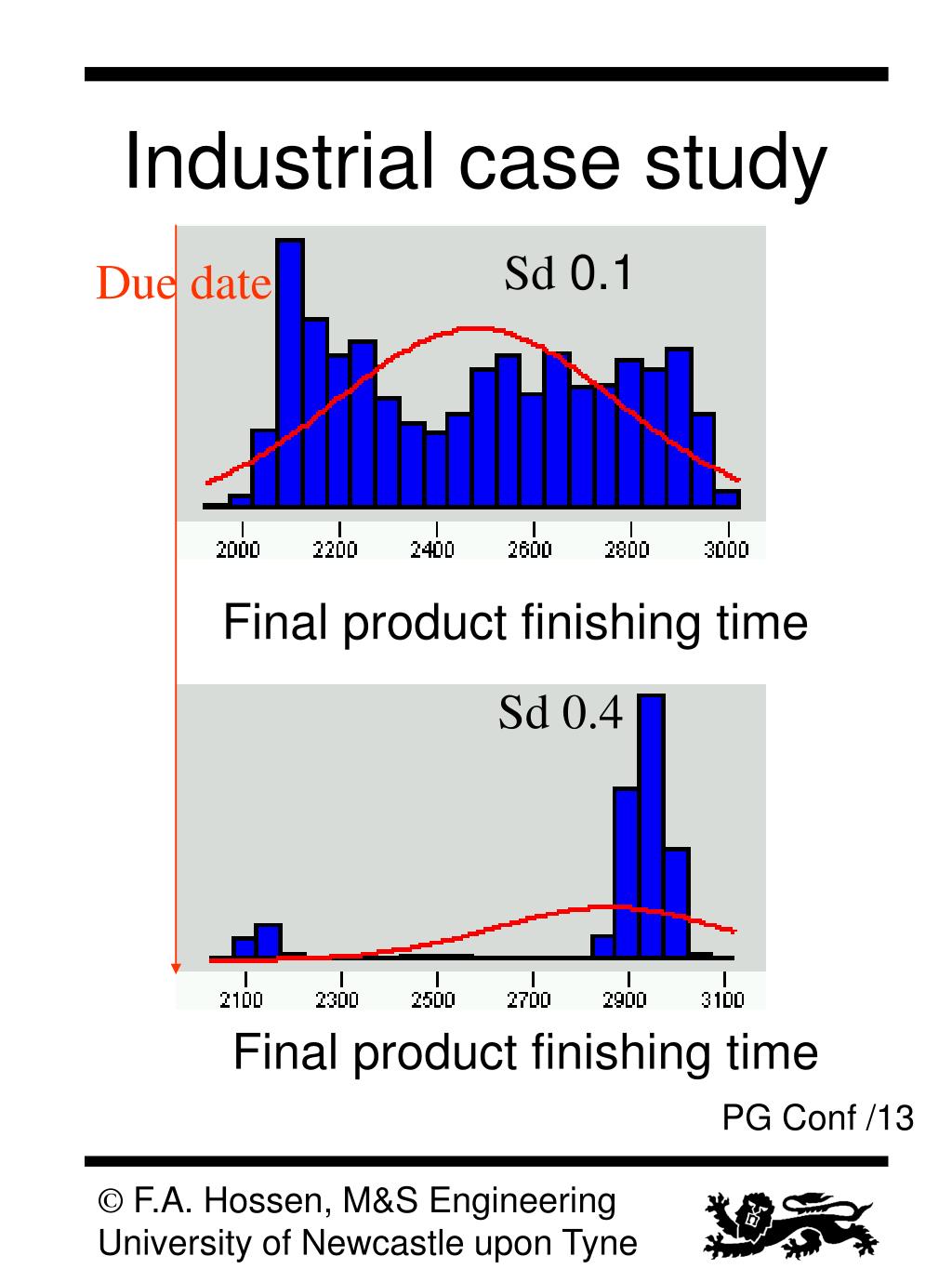

  13. Industrial case study Sd 0.1 Due date Final product finishing time Sd 0.4 Final product finishing time

  14. Capital goods are customised and the processing times are uncertain. The uncertainty becomes cumulative throughout the production stages. Due to the uncertainty and complexity of production in ETO products, it is difficult to estimate accurately the product lead-time. Conclusions

  15. The effect of cumulative uncertainty is to shift the distribution of product completion time to the right. As a result of this the probability of delivering a product on due date becomes very small. Increasing of the standard deviation from 0.1 to 0.2 and 0.3 times the mean, the distribution of product completion times are increasingly shifted to the right and the uncertainty is additionally increased. Managers need to minimise the risks associated with these uncertainties. Conclusions

  16. I would like to thank my supervisor, Dr C. Hicks, for his advise and Dr P. Pongcharoen for his support. Any Questions? Acknowledgement
