  1. Recommended Implementation Schedule NTIP Meeting Havre, MT November 4, 2004

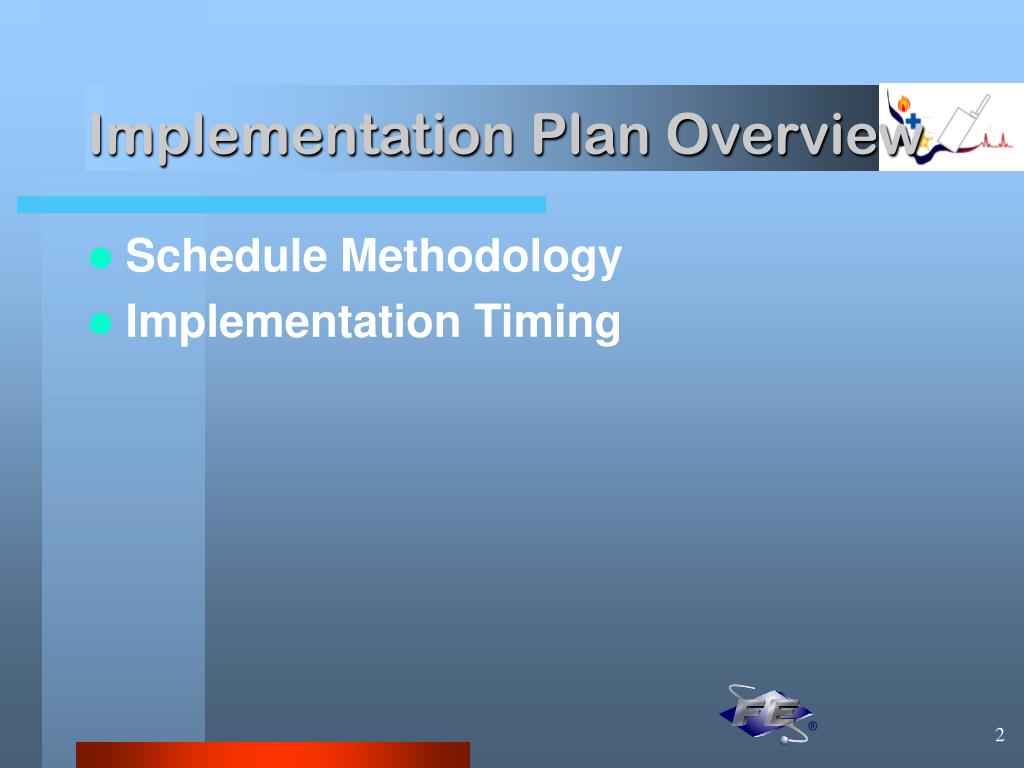

  2. Implementation Plan Overview • Schedule Methodology • Implementation Timing

  3. System Implementation Timeline

  4. System Implementation Prioritization • Wide Area Trunked Voice System • Includes interconnect network requirements • Includes site improvements • Remainder of Interconnect Network • Includes site improvements • Local Area Trunked Voice Systems • Includes site improvements • Local Area Conventional Voice Systems • Includes site improvements • P25 Data Systems As Required • Includes site improvements

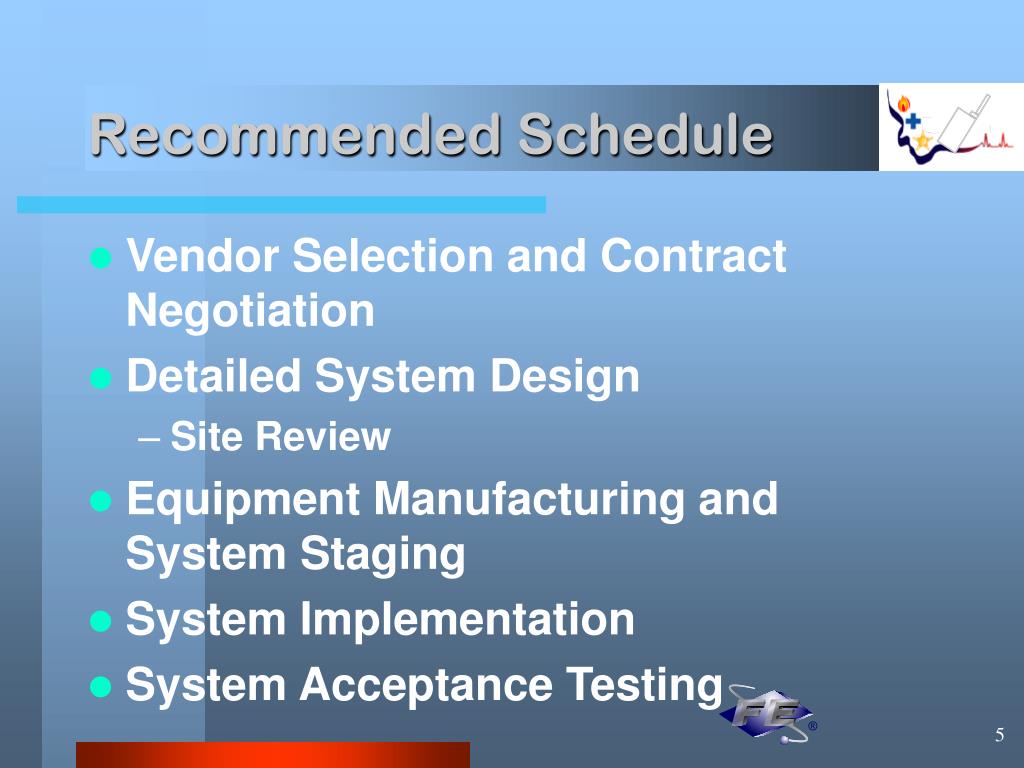

  5. Recommended Schedule • Vendor Selection and Contract Negotiation • Detailed System Design • Site Review • Equipment Manufacturing and System Staging • System Implementation • System Acceptance Testing

  6. Vendor Selection and Contract Negotiation • Release of Request for Proposal (RFP) • Pre-Bid Conference • Proposals Submittal, Review and Vendor Selection • Contract Negotiation

  7. Detailed System Design • Vendor Detailed System Design • Site Review • System Implementation Plan • Implementation Contract Development

  8. Equipment Manufacturing and System Staging • Equipment Ordering Process • Delivery of Equipment to a Staging Facility • Construction of the System • or Sub-Systems • Optimization of the System • Documentation of the System

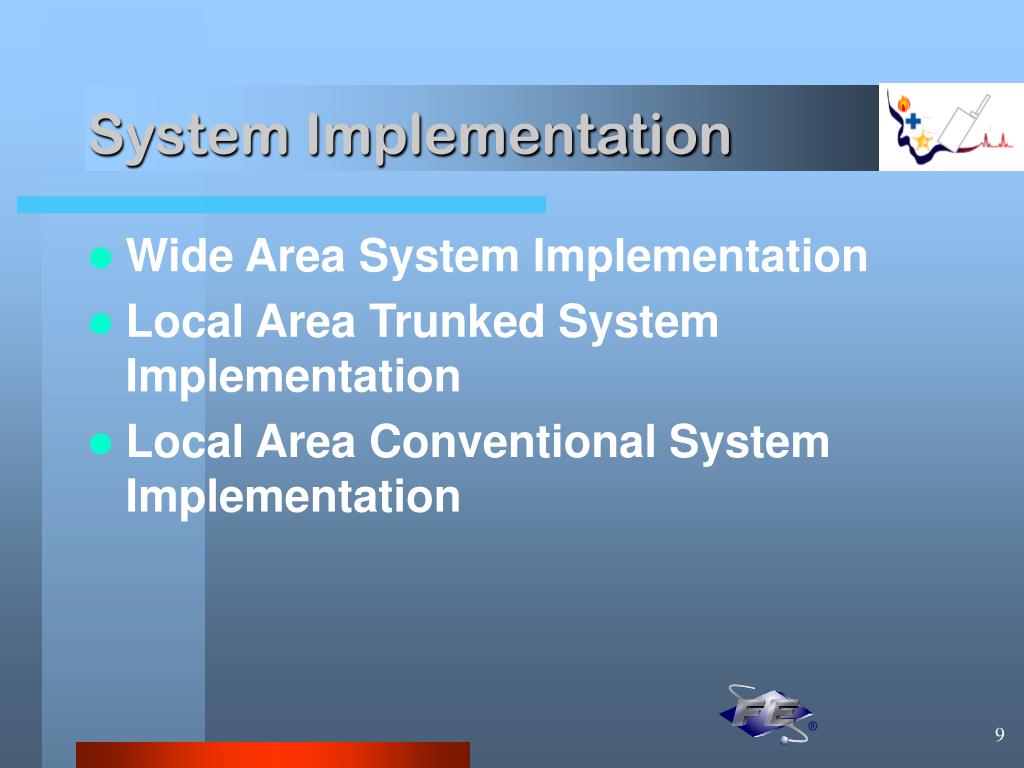

  9. System Implementation • Wide Area System Implementation • Local Area Trunked System Implementation • Local Area Conventional System Implementation

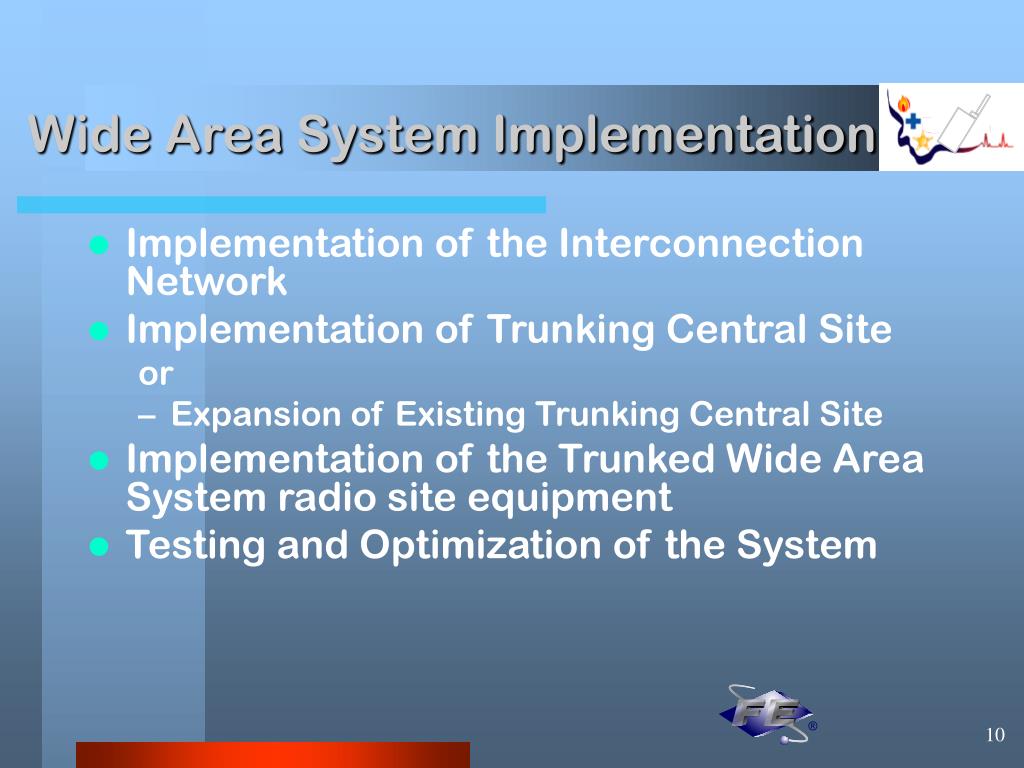

  10. Wide Area System Implementation • Implementation of the Interconnection Network • Implementation of Trunking Central Site or • Expansion of Existing Trunking Central Site • Implementation of the Trunked Wide Area System radio site equipment • Testing and Optimization of the System

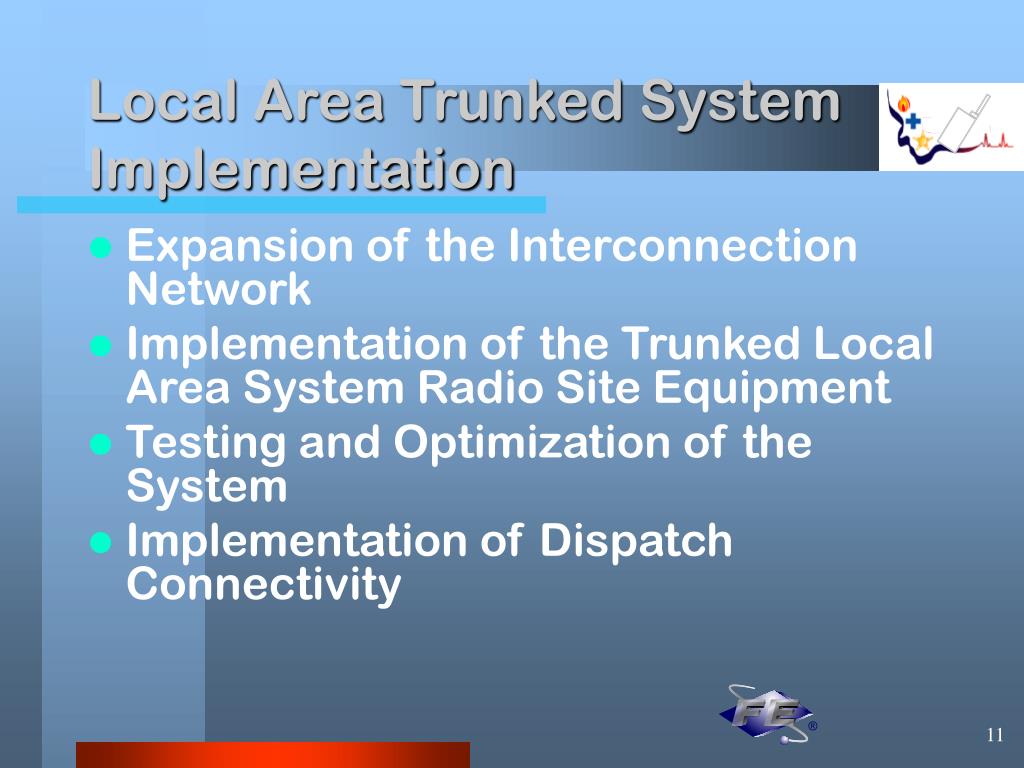

  11. Local Area Trunked System Implementation • Expansion of the Interconnection Network • Implementation of the Trunked Local Area System Radio Site Equipment • Testing and Optimization of the System • Implementation of Dispatch Connectivity

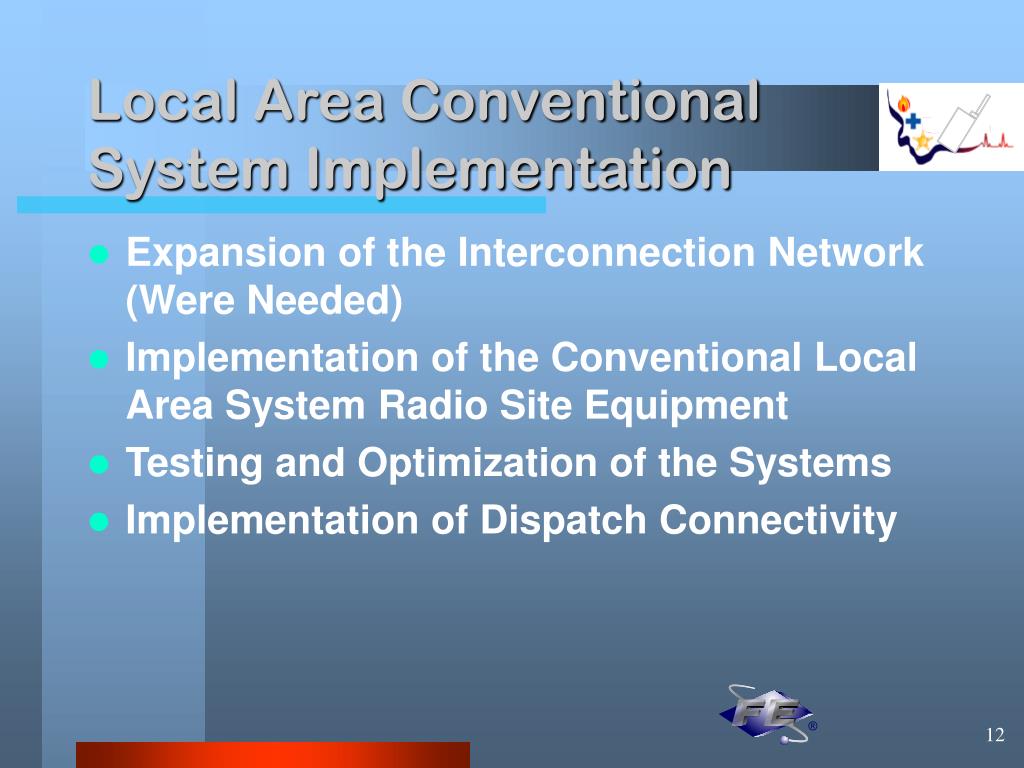

  12. Local Area Conventional System Implementation • Expansion of the Interconnection Network (Were Needed) • Implementation of the Conventional Local Area System Radio Site Equipment • Testing and Optimization of the Systems • Implementation of Dispatch Connectivity

  13. System Acceptance Testing • Scheduled after all implementation tasks • Verification of system functionality • Verification of system performance • Verification of system capacity • Verification of system radio coverage • Correction of all deficits in critical parameters

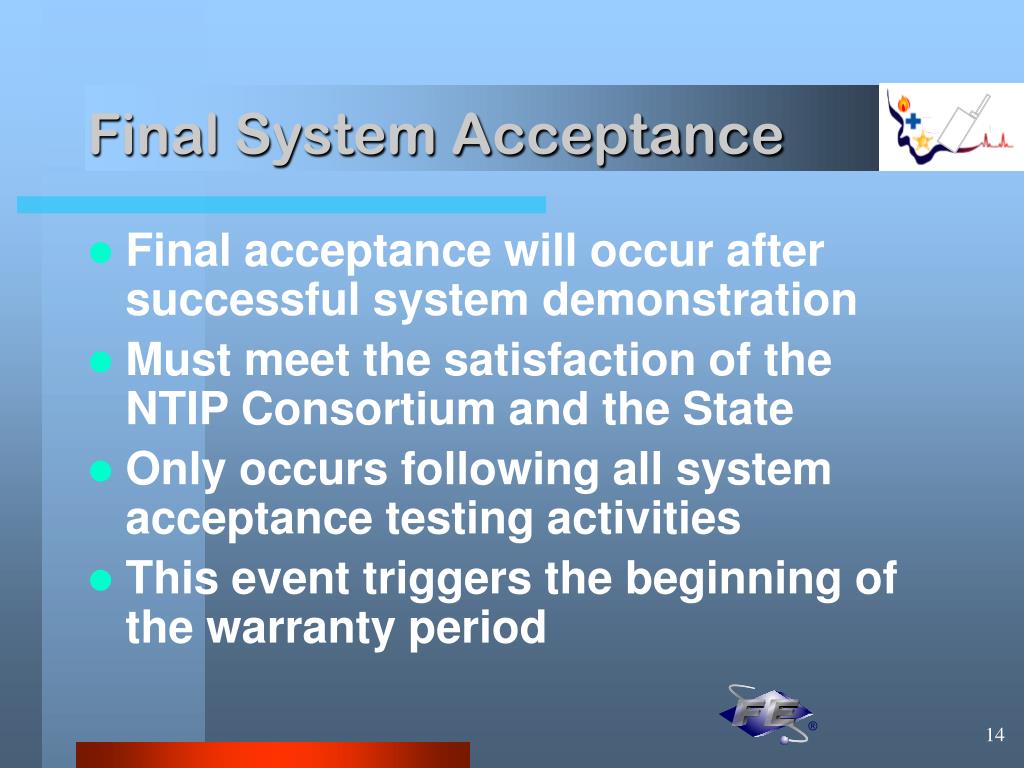

  14. Final System Acceptance • Final acceptance will occur after successful system demonstration • Must meet the satisfaction of the NTIP Consortium and the State • Only occurs following all system acceptance testing activities • This event triggers the beginning of the warranty period

  15. System Implementation Timeline

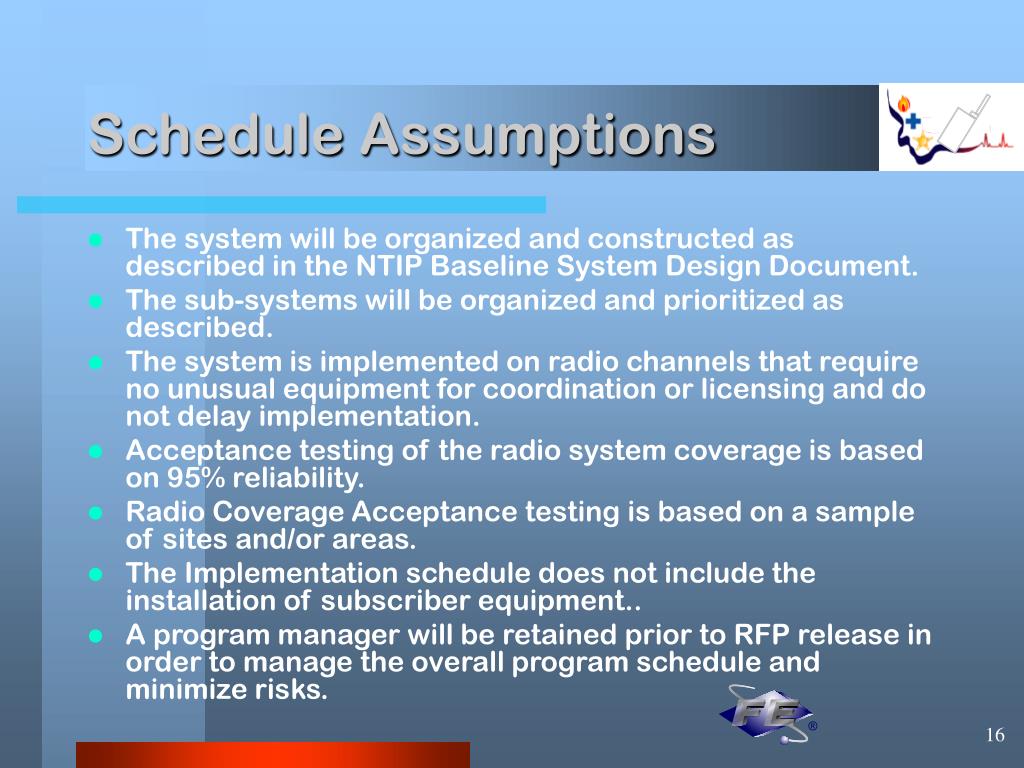

  16. Schedule Assumptions • The system will be organized and constructed as described in the NTIP Baseline System Design Document. • The sub-systems will be organized and prioritized as described. • The system is implemented on radio channels that require no unusual equipment for coordination or licensing and do not delay implementation. • Acceptance testing of the radio system coverage is based on 95% reliability. • Radio Coverage Acceptance testing is based on a sample of sites and/or areas. • The Implementation schedule does not include the installation of subscriber equipment.. • A program manager will be retained prior to RFP release in order to manage the overall program schedule and minimize risks.

  17. Risk Issues • Risk of violating one or more of the Schedule Assumptions. • The appropriate funding will be available throughout the system implementation schedule. • No more than ten new site buildings are required to be constructed using prefabricated construction methods. • No significant equipment delivery delays will occur during system implementation. • No significant weather issues will delay the system implementation. • A program manager will be retained prior to RFP release in order to manage the overall program schedule and minimize risks.
