  1. USArray Year 10 IRIS CoCom Meeting Chicago April 9-10, 2012

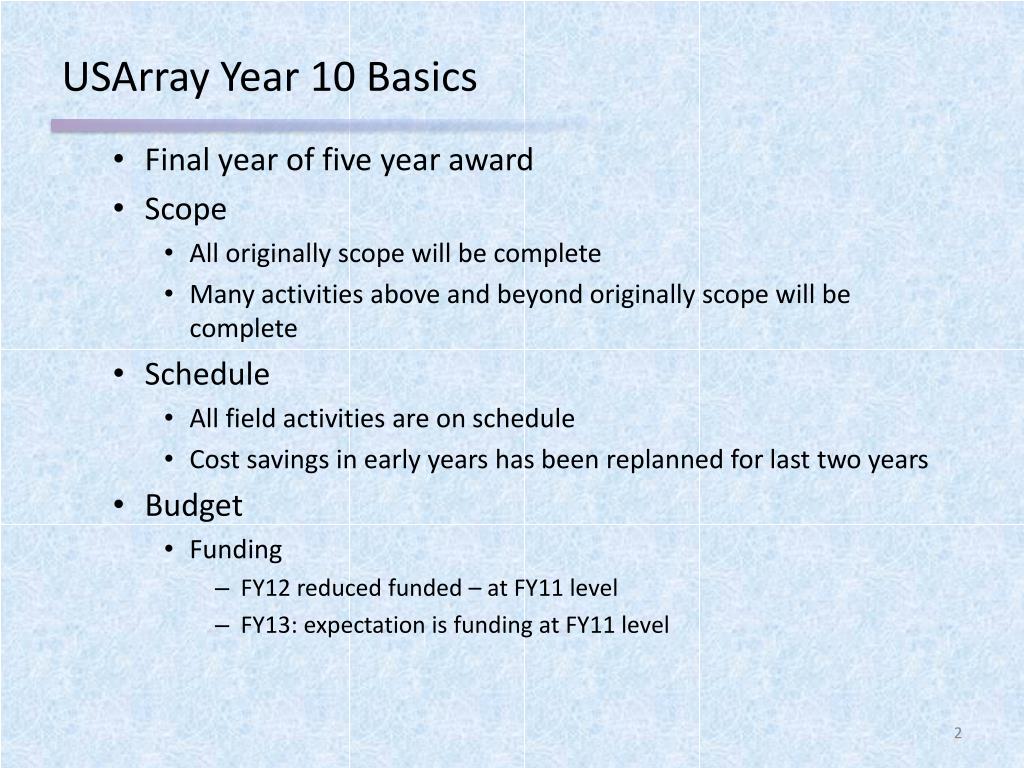

  2. USArray Year 10 Basics • Final year of five year award • Scope • All originally scope will be complete • Many activities above and beyond originally scope will be complete • Schedule • All field activities are on schedule • Cost savings in early years has been replanned for last two years • Budget • Funding • FY12 reduced funded – at FY11 level • FY13: expectation is funding at FY11 level

  3. Funding Summary - EAR-0733069 - USArray O&M • FY09 fully funded • Last 20% via ARRA funds • FY10 fully funded • Supplement of $197,579 for EarthScope Science Plan Workshop • Remainder applied to ESNM in 2011 • Cascadia Initiative supplement • $2.5 M in ARRA funds • Covers all costs through FY13 (4 years) • FY11 fully funded • $163,639 supplement for 2011 ESNM • FY12 funded at FY11 level • FY13 funding: funded at? • $811k received in forward funding

  4. Current Activities • Completed cost review with NSF in January • Will submit Change Order 34 to “re-baseline” • Propose to use revised spend plan through end of award • Propose to submit CO35 for increased scope • Collaboration on integrated web services with COOPEUS / EPOS European efforts • PBO submitting similar re-baseline CO, plus several COs that add scope

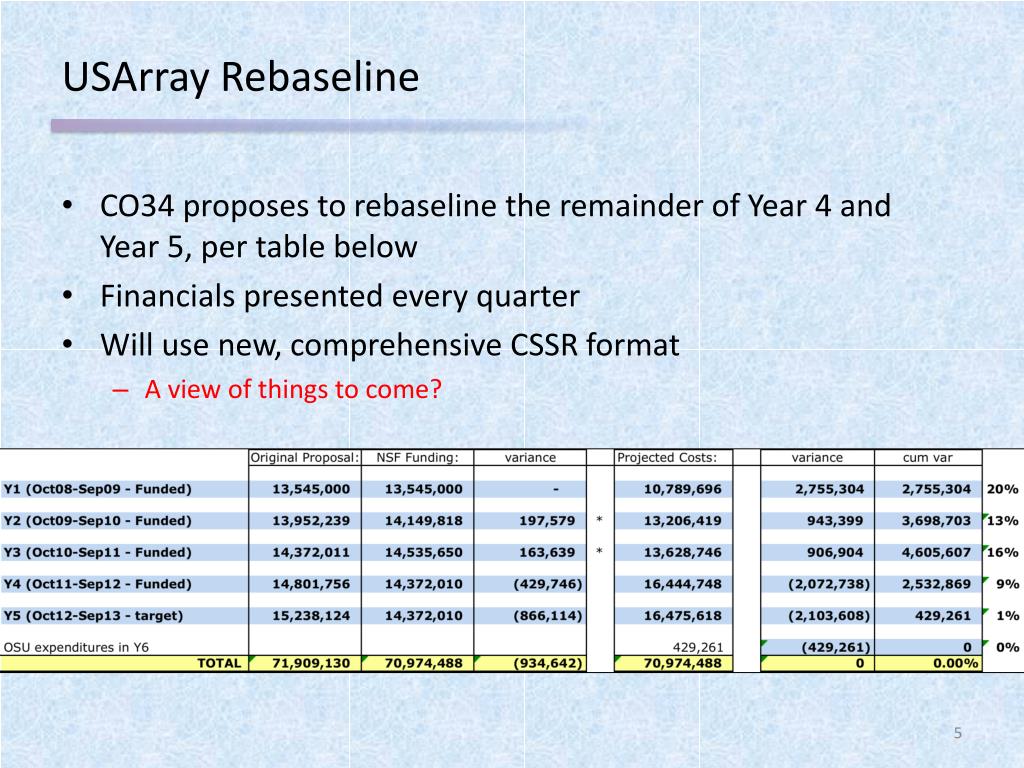

  5. USArray Rebaseline • CO34 proposes to rebaseline the remainder of Year 4 and Year 5, per table below • Financials presented every quarter • Will use new, comprehensive CSSR format • A view of things to come?

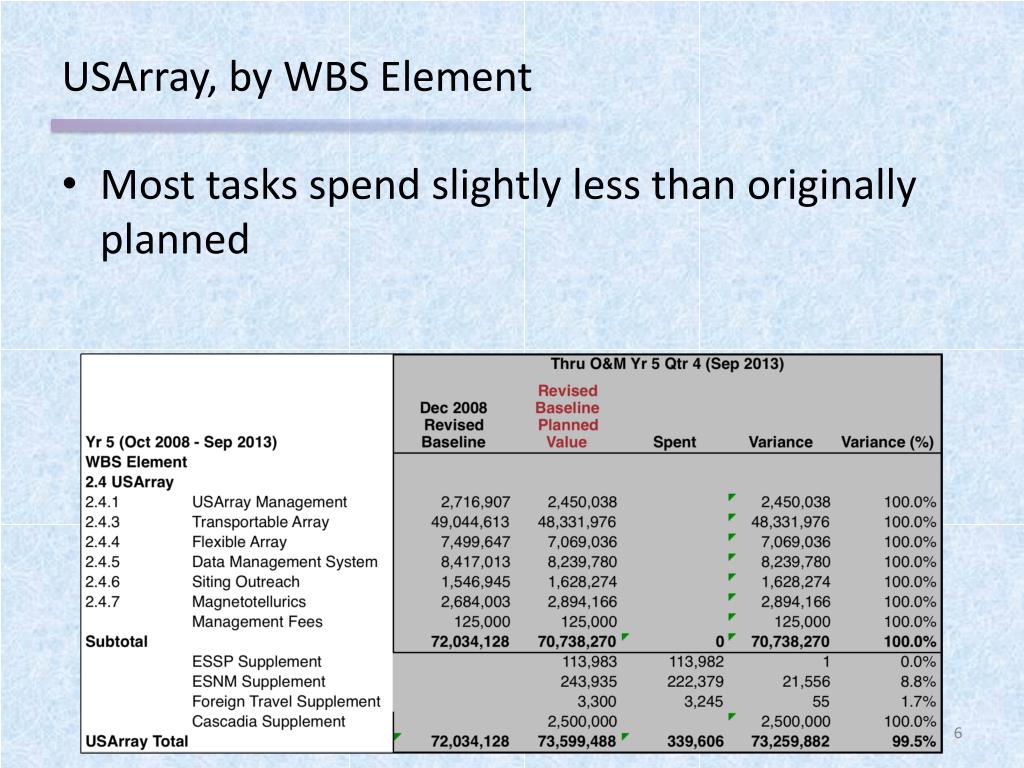

  6. USArray, by WBS Element • Most tasks spend slightly less than originally planned

  7. Instrumentation Services: FY13-14 IRIS CoCom Meeting Chicago April 9-10, 2012

  8. Status • Mostly: Salary for IS management team • Note: some are fractionally supported from other awards (USArray, Polar, GLISN, etc.) • Small amounts for travel, M&S, Pubs & Printing • Revised downwards from previous projections • Mostly due to lower than expected salary for Fowler • Delayed hiring (all planned hiring now complete) • Note that this will change substantially for FY14-18 due to inclusion of full salaries

  9. Instrumentation Services: FY14-18 IRIS CoCom Meeting Chicago April 9-10, 2012

  10. WBS 3.1 – IS Management • Same structure as at present • Salaries, travel, M&S, Pubs and printing • Salaries will include 100% of IS managers • Some fine tuning of this required

  11. WBS 3.1.7 - Magnetotellurics • Scoped a slightly more ambitious plan than asked • Should achieve three significant “footprints” • Proposed structure and activities are essentially the same as today • But – may need to trade some field work against buying replacement equipment • No sensors replaced in nine years (running the same 20 instruments the whole time)

  12. WBS 3.1.7 – Magnetotellurics – New Initiatives • Presented two concepts for new initiatives at last BoD meeting • Full-48 • Expanding the MT TA to cover the full 70 x 70 km grid in the lower 48 • Cost: ~ double the base MT budget (additional ~$600-700K / year) • Prototype Alaska transect • A road-based transect of up to MTsite in Alaska • Setting stage for post-2018 MT activities • Cost: ~$150-170K / year • BoD meeting takeaways • These new initiatives are non-starters
