Status

Status. Repaired MH2 and Q10 power supplies Seems to have stabilized beam MiniBooNE had the highest rate in quite a while. Elliott McCrory added linac time of flight feedback loop Stabilized beam very well for two weeks

sandra_john
Télécharger la présentation

Status

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Status • Repaired MH2 and Q10 power supplies • Seems to have stabilized beam • MiniBooNE had the highest rate in quite a while. • Elliott McCrory added linac time of flight feedback loop • Stabilized beam very well for two weeks • Then put linac into a strange state, which resulted in some unstable behavior two days ago • Elliott is investigating. In the mean time, it just means that Elliott or Larry Allen will have to check things every few days. • Having some problem with coalescing tuning resulting in high losses on MiniBooNE and stacking cycles • Totally don’t understand this problem yet. Looking into it with Jim Lackey and Dave Capista Prebys

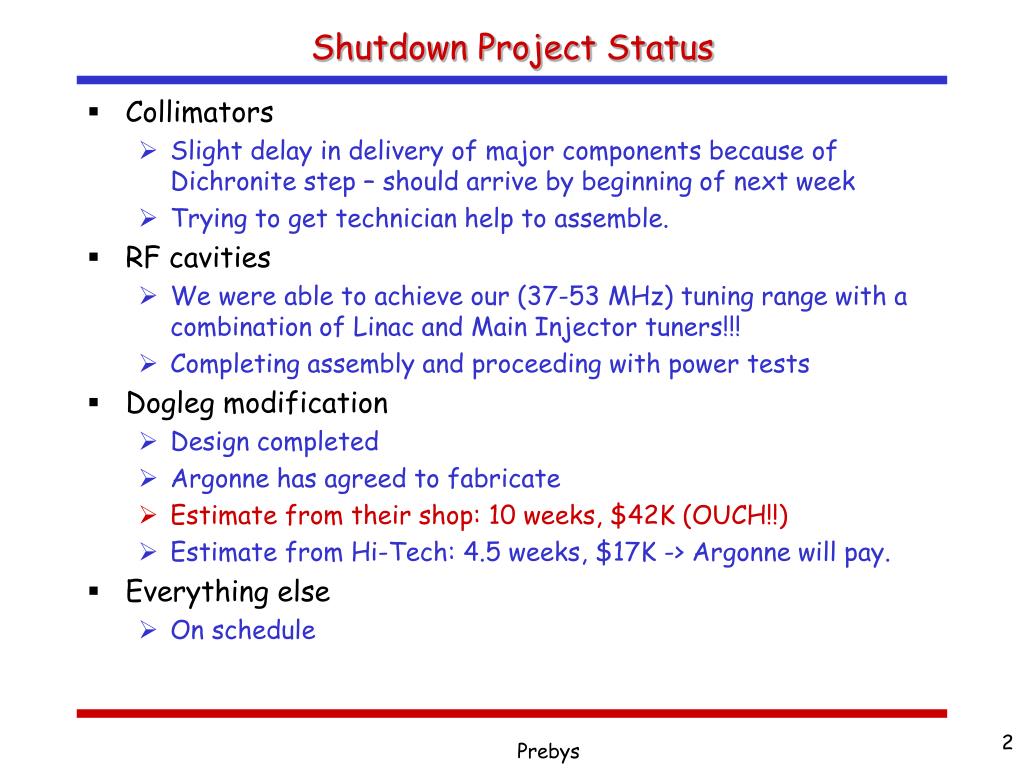

  2. Shutdown Project Status • Collimators • Slight delay in delivery of major components because of Dichronite step – should arrive by beginning of next week • Trying to get technician help to assemble. • RF cavities • We were able to achieve our (37-53 MHz) tuning range with a combination of Linac and Main Injector tuners!!! • Completing assembly and proceeding with power tests • Dogleg modification • Design completed • Argonne has agreed to fabricate • Estimate from their shop: 10 weeks, $42K (OUCH!!) • Estimate from Hi-Tech: 4.5 weeks, $17K -> Argonne will pay. • Everything else • On schedule Prebys

  3. Shutdown Schedule • Start date: • “Unofficially” delayed two weeks (Aug. 25th->Sept. 8th) • Final decision at today’s Run II PMG • We’re OK either way • Length: • “As long as it takes for the recycler vacuum and civil engineering work” • This is probably 10 weeks. • Booster work is 5 weeks. • Considering waiting a full week to start work to let things cool. • MiniBooNE will probably run nights and weekends once we’re up (after a tuning period). Prebys
