Single Line Tethered Glider System Level Design Review Team P14462 Kyle Ball Matthew Douglas William Charlock Jon Erbelding Paul Grossi Sajid Subhani
Agenda • Project Description Review • Customer Needs Review • Customer Requirements Review • Functional Decomposition • Concept Development • Concept Comparison • Data Collection Architecture • Risk Assessment • Project Planning • Work Breakdown Structure
Project Description • Goal: Design, build, and test a tethered, small-scale, human-controlled glider. • Critical Project Objectives: • Maintain maximum tension on the tether • Sustaining horizontal and vertical flight paths • Measure and record tether tension and position • Understand the influential parameters for sustained, tethered, unpowered flight Glider Tether Base Station Operator w/ controller
Engineering Requirements Yellow: Major design Biege: DAQ Grey: Test flight White: System environment
Art’s Plane • Sustained multiple damages • Gained crash experience • Possible tethered flight concept tests • Salvage parts • Sorry Art
Concept Development • Gliders • Buy an RC glider • Design and build an RC glider • Measurement Devices on Base Station • Buy a 3-axis Load Cell • Build Load Cell from three 1-axis Load Cells • GPS with Force Gauge • Resistance Gyro with Force Gauge • IMU with 1-axis Load Cell
Buy Glider Pros: • Pre-Engineered to Fly • Can purchase spare parts • Fast shipping • Modifiable Cons: • Not guaranteed to fly with tether • Expensive • Limited modifications
Benchmarking (Buy) Bixler 2 Sky Eye Airwing WingSurfer Phoenix 2000
Build Glider Pros: • Can optimize plane for tethered flight • Build spare sparts • Resources available Cons: • Not guaranteed to fly • Requires time to build • Complex • Hard to balance • Could become expensive if mistakes are made
Benchmarking (Build) • Experimental Airlines tutorials (Photon Model as baseline) • Custom/interchangable design (wing, fuselage, rudder, etc.) • ~$80 - $100 (~50%-70% “1 time cost”)
Force Gauge and Resistance Gyro Pros: • Innovative Cons: • Expensive • Complex Data • Internal Turbulence • Requires current line on tether • Difficult to calibrate • Difficult to set up
3 Single-Axis Load Cells Pros: • Can repair individual components • Accurate • Cheap Components Cons: • Difficult to calibrate • Potential for noisy data
3-Axis Load Cell Pros: • Accurate • Precalibrated • Intuitive Setup Cons: • Expensive • Dead zones
IMU Board and 1-Axis Load Cell Pros: • Provides accurate position and orientation data Cons: • Requires noise filtering • Difficult to calibrate • IMU system would be on glider
Force Gauge and GPS Pros: • Digital Data • Accurate force measure Cons: • Expensive • GPS on glider changes weight • Difficult to calibrate • Difficult to set up • Innacurate position
2 Potentiometers and 1-Axis Load Cell Pros • Inexpensive • Accurate angles Cons • Easily breakable • Require precise machining
Top 3 System Concepts IMU with Single Axis Load Cell 3 Single Axis Load Cell 2 Potentiometers with Single Axis Load Cell
Data Collection Architecture • Data acquisition: LabVIEW or Arduino • Storage: SD Card or Laptop Data Collection Requirements:
Preliminary Budget Outline Purchase Price ($) Glider Glider 100 Receiver 60 Battery x2 40 Base Station Materials 100 Electronics 100 Total 400 Remaining (For Mistakes and Repairs) 100

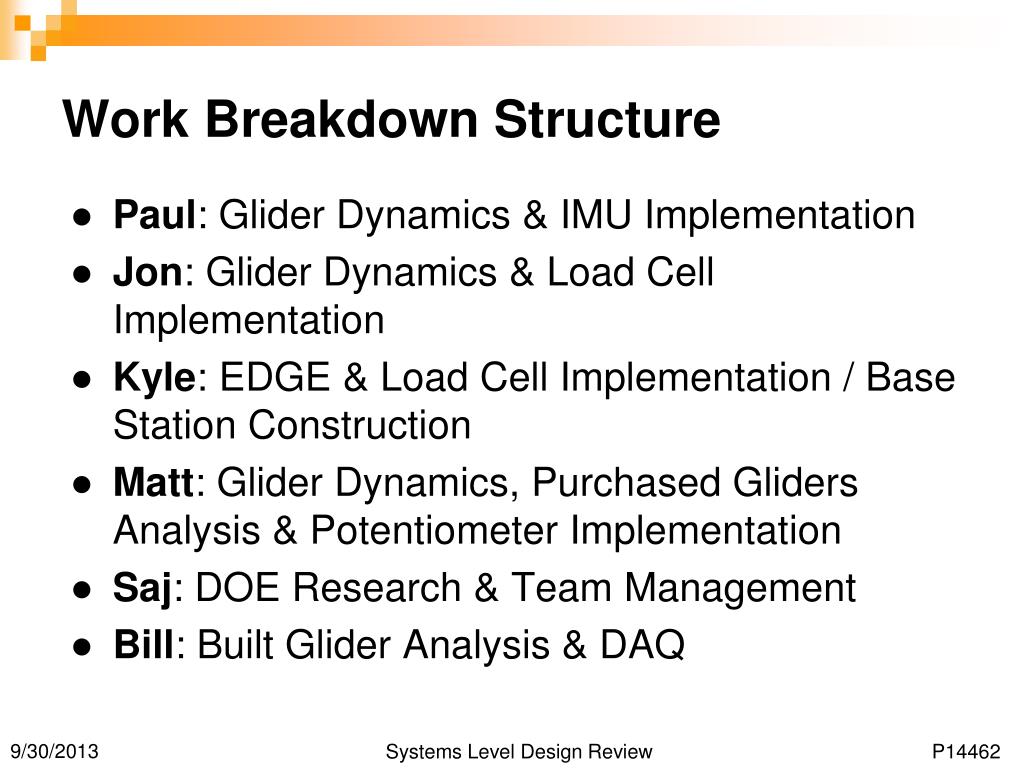

Work Breakdown Structure • Paul: Glider Dynamics & IMU Implementation • Jon: Glider Dynamics & Load Cell Implementation • Kyle: EDGE & Load Cell Implementation / Base Station Construction • Matt: Glider Dynamics, Purchased Gliders Analysis & Potentiometer Implementation • Saj: DOE Research & Team Management • Bill: Built Glider Analysis & DAQ
