240 likes | 421 Vues
System Design Review Project Team 13453. Brandon Niescier Erin Sullivan Mike Gorevski Sean Deshaies. Agenda. Team and Project Introduction (5 min) Customer Needs and Specifications (5 min) Concept Generation (5 min) Concept Selection (10 min) Risk Assessment (5 min)
E N D
System Design ReviewProject Team 13453 Brandon Niescier Erin Sullivan Mike Gorevski Sean Deshaies
Agenda • Team and Project Introduction (5 min) • Customer Needs and Specifications (5 min) • Concept Generation (5 min) • Concept Selection (10 min) • Risk Assessment (5 min) • Project Plan (5 min) • Q&A

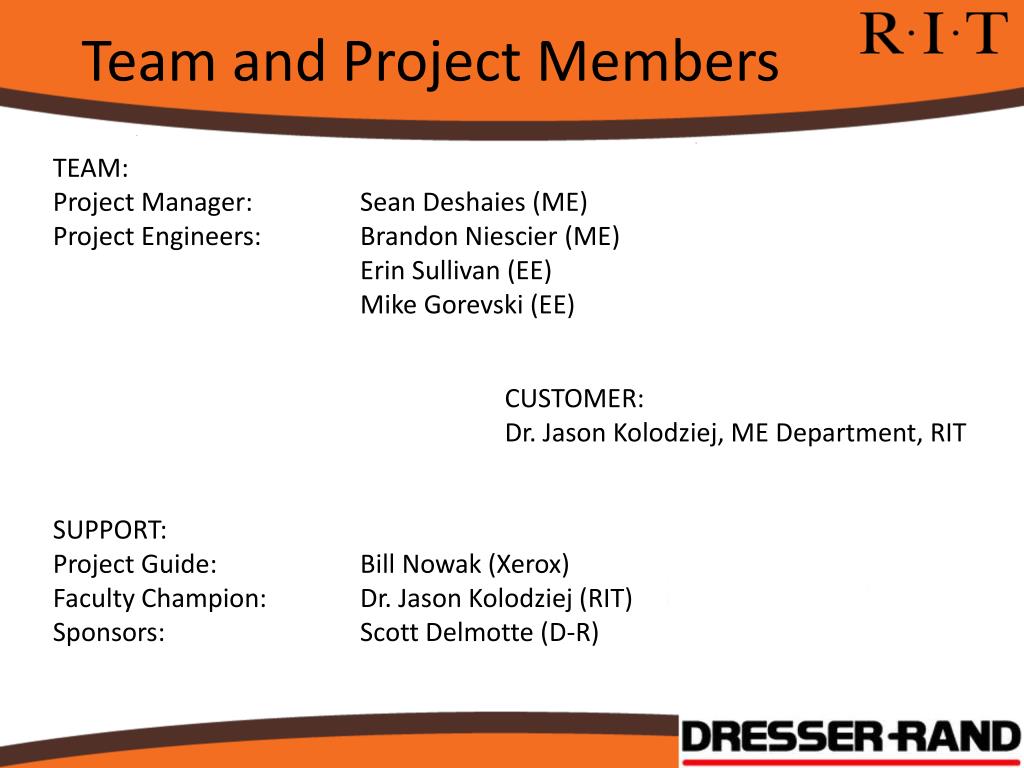

Team and Project Members TEAM: Project Manager: Sean Deshaies (ME) Project Engineers: Brandon Niescier (ME) Erin Sullivan (EE) Mike Gorevski (EE) CUSTOMER: Dr. Jason Kolodziej, ME Department, RIT SUPPORT: Project Guide: Bill Nowak (Xerox) Faculty Champion: Dr. Jason Kolodziej(RIT) Sponsors: Scott Delmotte (D-R)

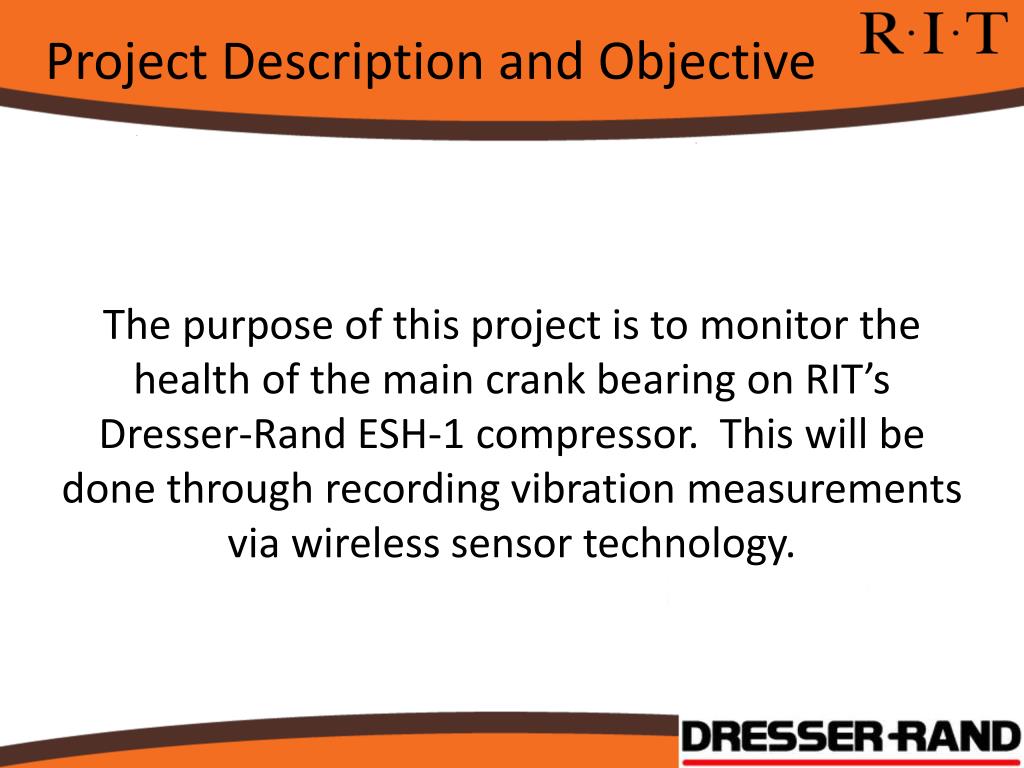

Project Description and Objective The purpose of this project is to monitor the health of the main crank bearing on RIT’s Dresser-Rand ESH-1 compressor. This will be done through recording vibration measurements via wireless sensor technology.

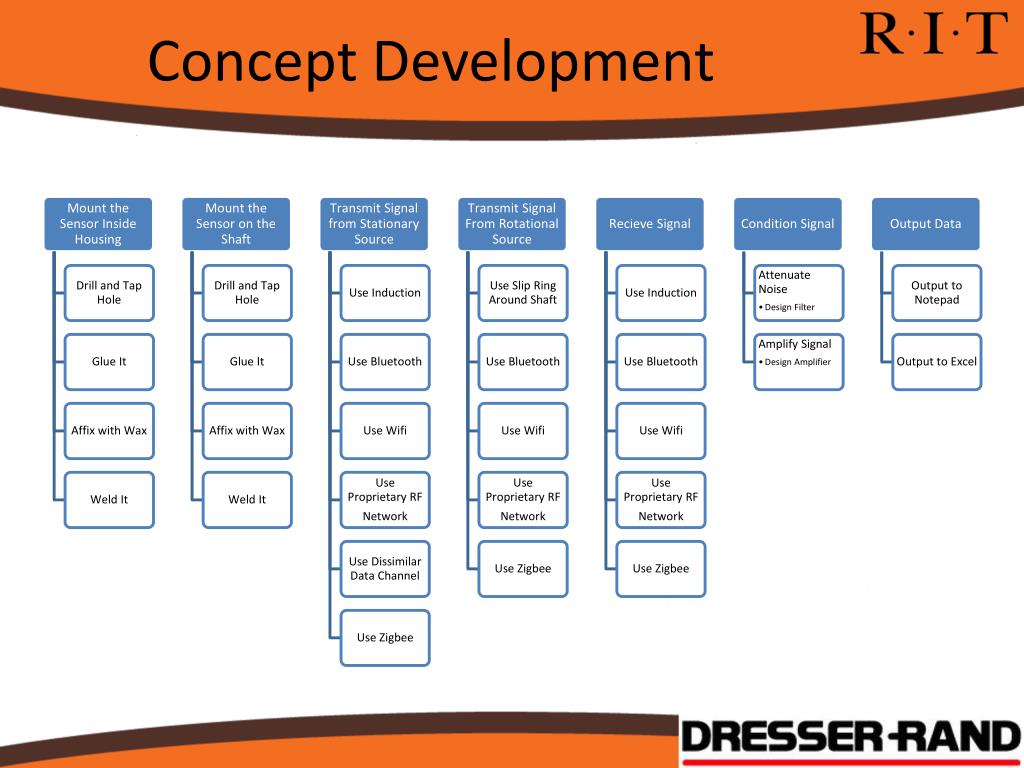

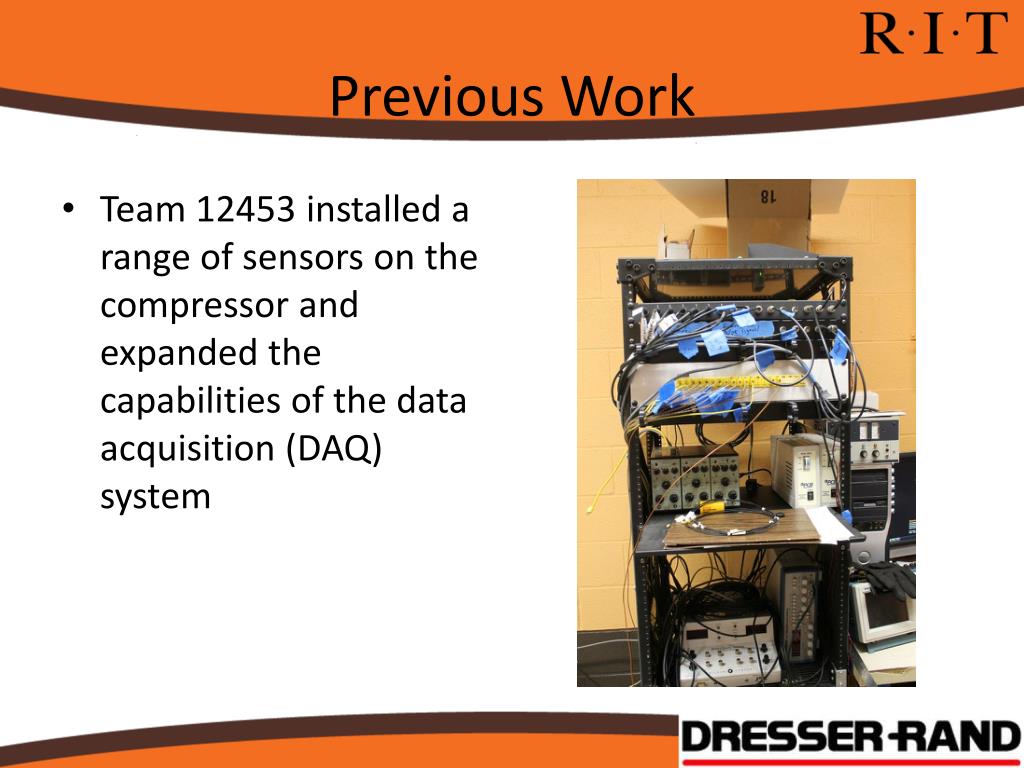

Previous Work • Team 12453 installed a range of sensors on the compressor and expanded the capabilities of the data acquisition (DAQ) system
House of Quality Relationships: 9 = Strong 3 = Moderate 1 = Weak 0 or Blank = No Relationship Importance Rating: 1 = Low Importance 3 = Moderate Importance 9 = High Importance
Drill and Tap Hole Affix With Wax Concepts Weld It Glue It Criteria D A T U M Secure Fit - - + Resist Maximum Operating Temperature - - + Oil Resistant S - S Vibration Resistant - - + Ease of Removal - + - Clarity of Vibration Measurement - + S Ease of Installation + + - Life Expectancy - - S Ease of Maintenance - - - Total + 1 3 3 Total - 7 6 3 Total S 1 0 3 Pugh Chart for Mounting Sensor Inside Housing • Drill and Tap is chosen method • Glue and Wax clearly eliminated • Weld eliminated due to difficultly with maintenance

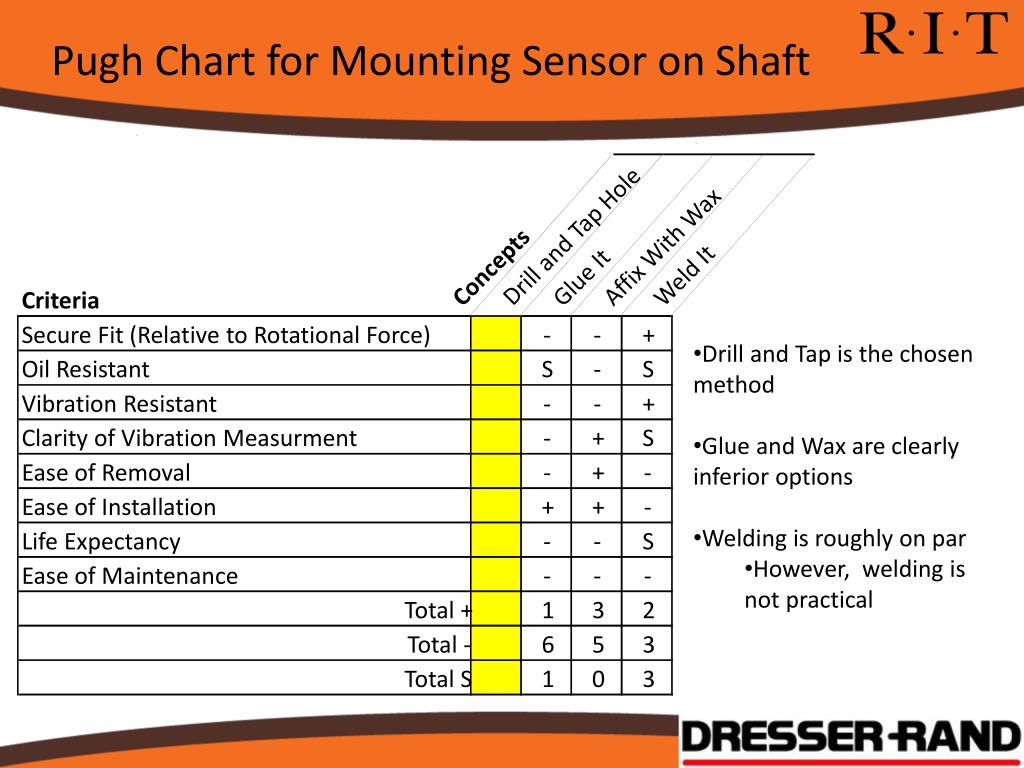

Drill and Tap Hole Affix With Wax Concepts Weld It Glue It Criteria Secure Fit (Relative to Rotational Force) - - + Oil Resistant S - S Vibration Resistant - - + Clarity of Vibration Measurment - + S Ease of Removal - + - Ease of Installation + + - Life Expectancy - - S Ease of Maintenance - - - Total + 1 3 2 Total - 6 5 3 Total S 1 0 3 Pugh Chart for Mounting Sensor on Shaft • Drill and Tap is the chosen method • Glue and Wax are clearly inferior options • Welding is roughly on par • However, welding is not practical

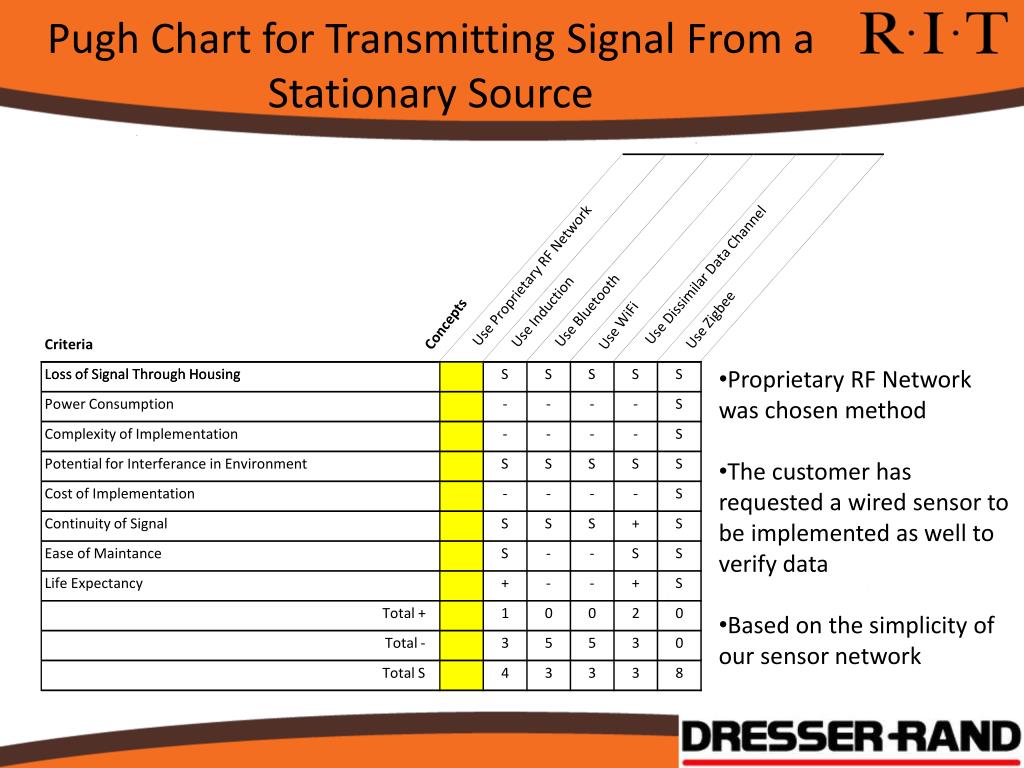

Use Proprietary RF Network Use Dissimilar Data Channel Use Bluetooth Use Induction Use Zigbee Concepts Use WiFi Criteria Loss of Signal Through Housing Loss of Signal Through Housing S S S S S Power Consumption - - - - S Complexity of Implementation - - - - S Potential for Interferance in Environment S S S S S Cost of Implementation - - - - S Continuity of Signal S S S + S Ease of Maintance S - - S S Life Expectancy + - - + S Total + 1 0 0 2 0 Total - 3 5 5 3 0 Total S 4 3 3 3 8 Pugh Chart for Transmitting Signal From a Stationary Source • Proprietary RF Network was chosen method • The customer has requested a wired sensor to be implemented as well to verify data • Based on the simplicity of our sensor network

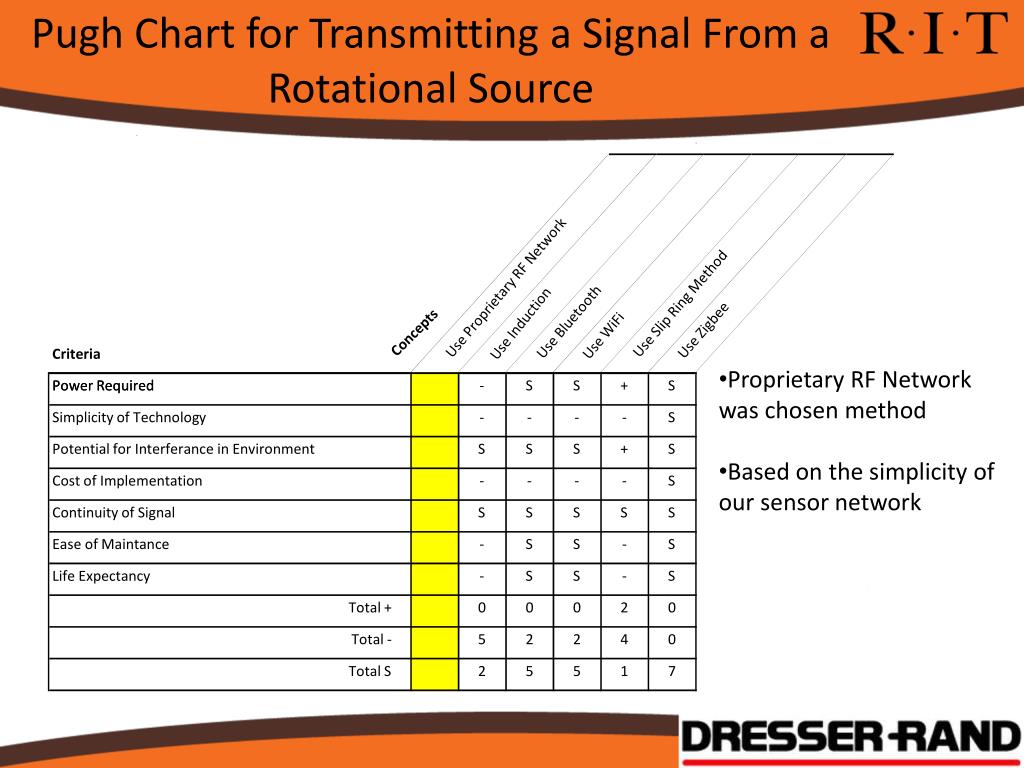

Use Proprietary RF Network Use Slip Ring Method Use Bluetooth Use Induction Use Zigbee Concepts Use WiFi Criteria Power Required Power Required - S S + S Simplicity of Technology - - - - S Potential for Interferance in Environment S S S + S Cost of Implementation - - - - S Continuity of Signal S S S S S Ease of Maintance - S S - S Life Expectancy - S S - S Total + 0 0 0 2 0 Total - 5 2 2 4 0 Total S 2 5 5 1 7 Pugh Chart for Transmitting a Signal From a Rotational Source • Proprietary RF Network was chosen method • Based on the simplicity of our sensor network

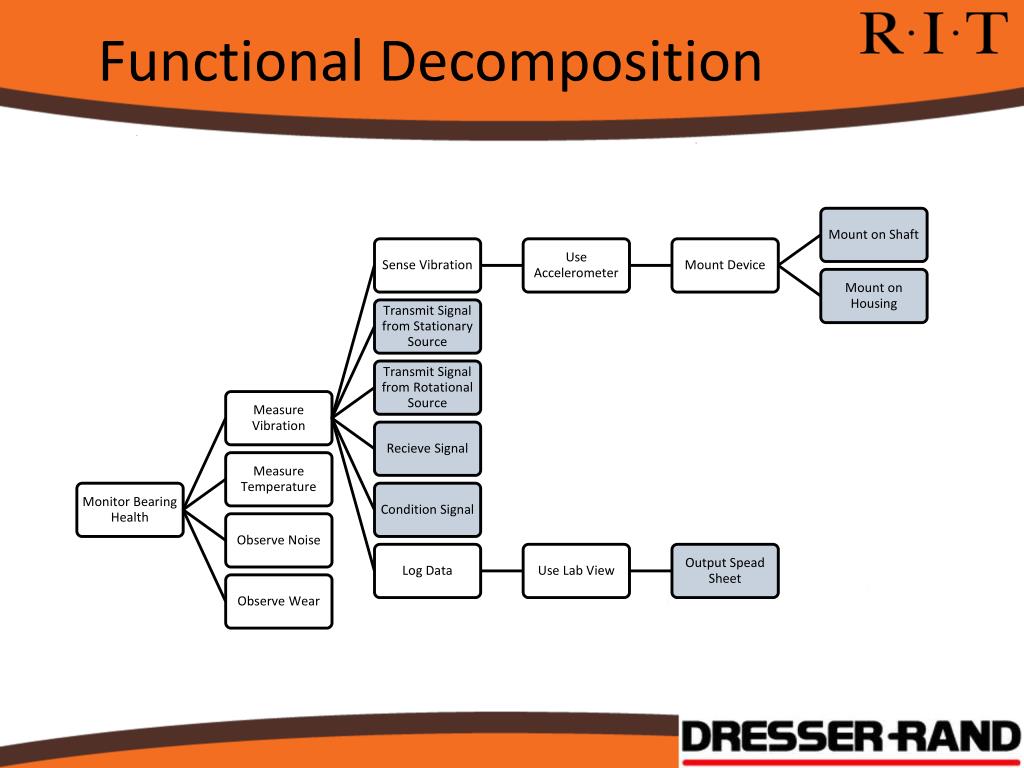

System Block Diagram • Option 1: Commercial Off The Shelf • Option 2: Develop In-House with PCB Mounted Accelerometer • Option 3: Develop In-House with Commercial Accelerometer Option 3 was chosen due to expert reccommedation

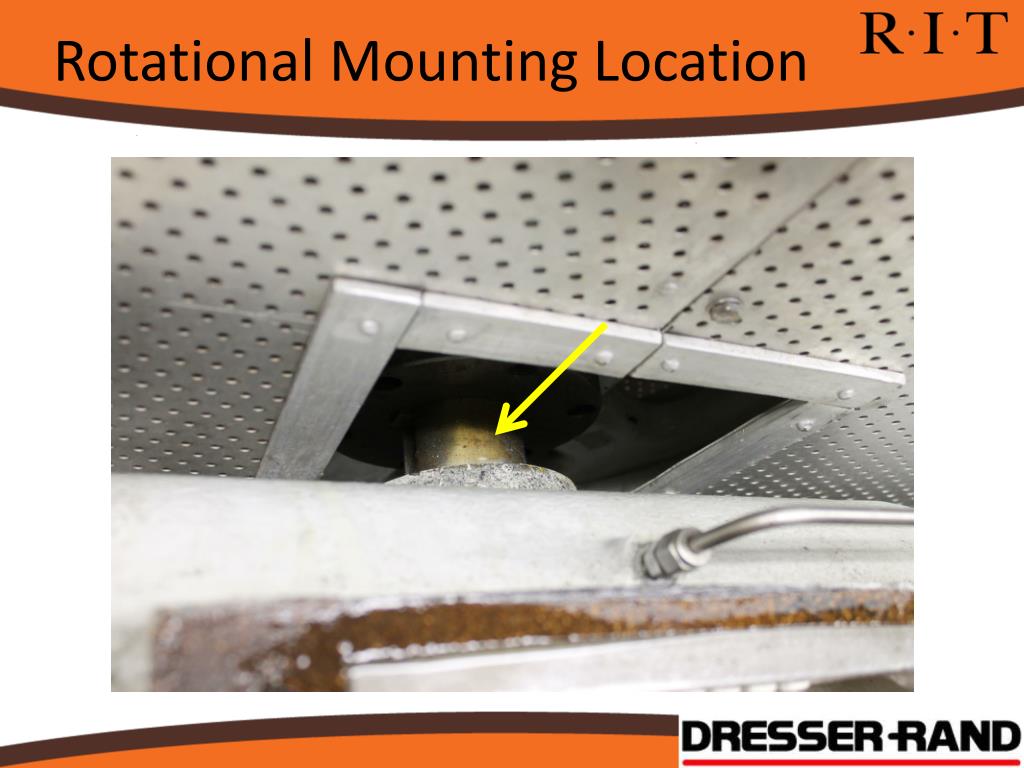

Test Rig • In order to validate the wireless signal transmission on the rotating shaft, a model test facility will be constructed • 1:1 scale for shaft diameter and rotational speed • Bearing configuration will not be identical to actual compressor for the sake of simplicity

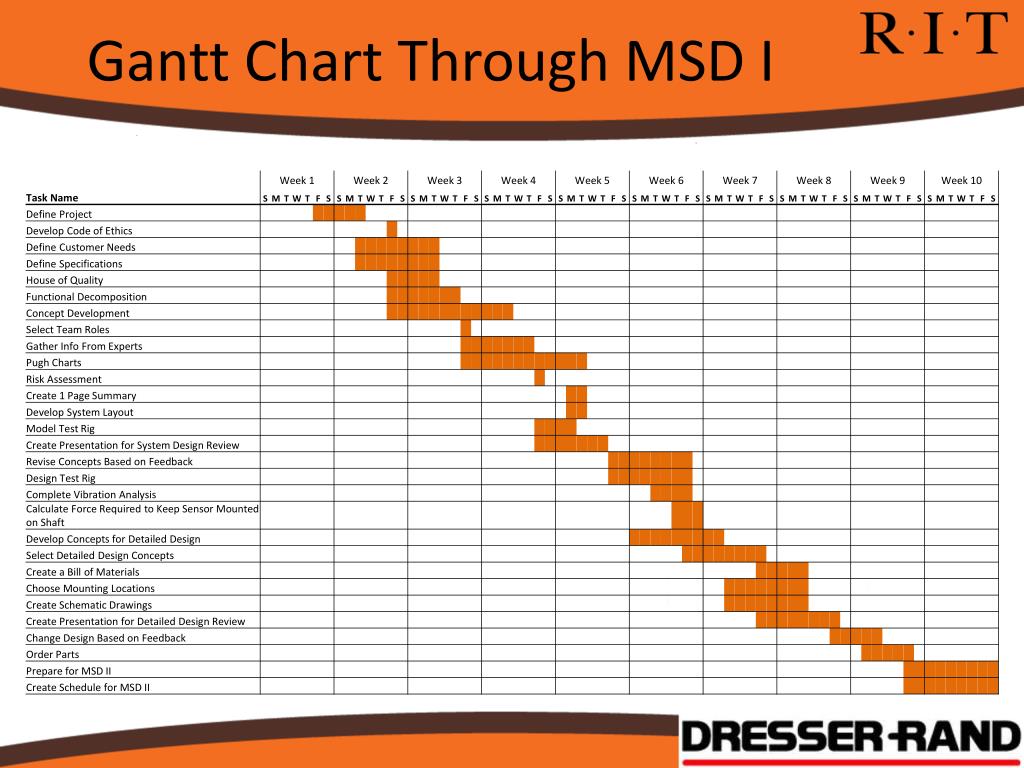

Test Rig Model Power Supply Coupling Encoder Motor
