An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. STATUS OF CARLSBORG SEWER PROJECT Carlsborg Community Advisory Council Bob Martin June 6, 2013

  2. UPDATE SINCE LAST CCAC MEETING • Conditional Approval of Facility Plan by Ecology • The PUD Board has decided to withdraw from most aspects of the project. • The PWTF loan has been executed and assigned to the County. • Wastewater treatment and reuse in Sequim

  3. Reasons to Consider Treatment in Sequim: • Sufficient excess capacity exists at Sequim WRF. • Only minor upgrades to Sequim collection system needed to accommodate Carlsborg flow. • Less than 3 miles of 6” force main needed to connect. • “State of the Art” facility producing Class A reclaimed water. • Good record of consistently meeting permit standards. • Sequim aggressively pursuing utilization of reclaimed water. • Resolves siting issues in Carlsborg. • Cost Savings

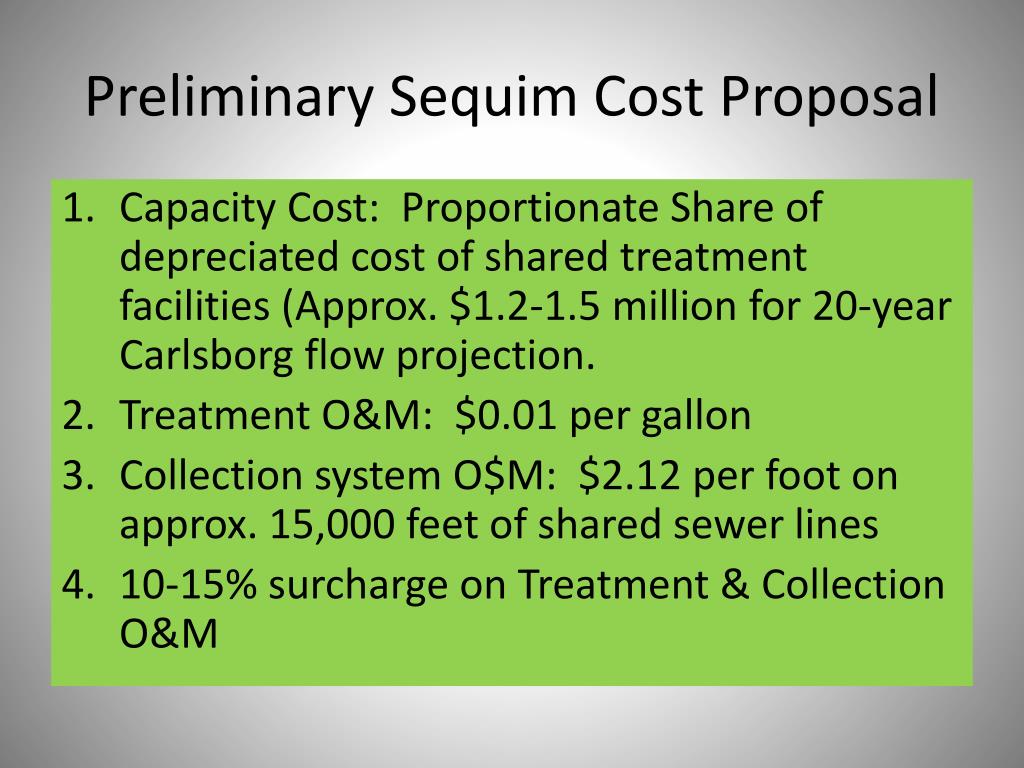

  4. Preliminary Sequim Cost Proposal • Capacity Cost: Proportionate Share of depreciated cost of shared treatment facilities (Approx. $1.2-1.5 million for 20-year Carlsborg flow projection. • Treatment O&M: $0.01 per gallon • Collection system O$M: $2.12 per foot on approx. 15,000 feet of shared sewer lines • 10-15% surcharge on Treatment & Collection O&M

  5. Present Worth – 20 Years(X $1,000) Notes: 1) Assumes constant 2012 dollars and 0% discount. 2) Assumes Purchase of 20-Year Capacity in two increments.

  6. Carlsborg – Initial Sequim WRF - 2011 Source: Comparison of Costs for Wastewater Management Systems Applicable to Cape Cod, Barnstable County Wastewater Cost Control Task Force, April 2010.

  7. UPDATE SINCE LAST CCAC MEETING • Conditional Approval of Facility Plan by Ecology • The PUD Board has decided to withdraw from most aspects of the project. • The PWTF loan has been executed and assigned to the County. • Wastewater treatment and reuse in Sequim • Evaluation of conveyance route to Sequim

  8. Sequim Conveyance Options • Crossing at RR Bridge • Old Olympic Highway • Directional Drilling • Crossing at SR 101 Bridge • Utility Bridge

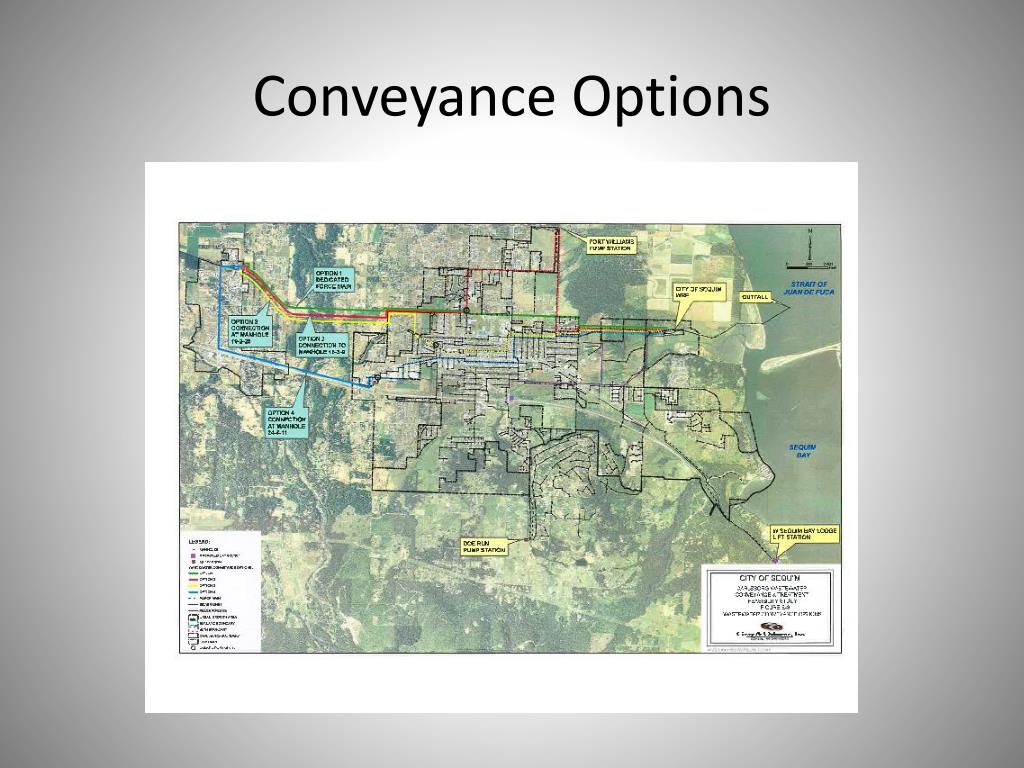

  9. Conveyance Options

  10. UPDATE SINCE LAST CCAC MEETING • Conditional Approval of Facility Plan by Ecology • The PUD Board has decided to withdraw from most aspects of the project. • The PWTF loan has been executed and assigned to the County. • Wastewater treatment and reuse in Sequim • Evaluation of conveyance route to Sequim • Request for Proposals for Engineering Consultant

  11. RFP WORK TASKS • Design the initial Carlsborg Collection System

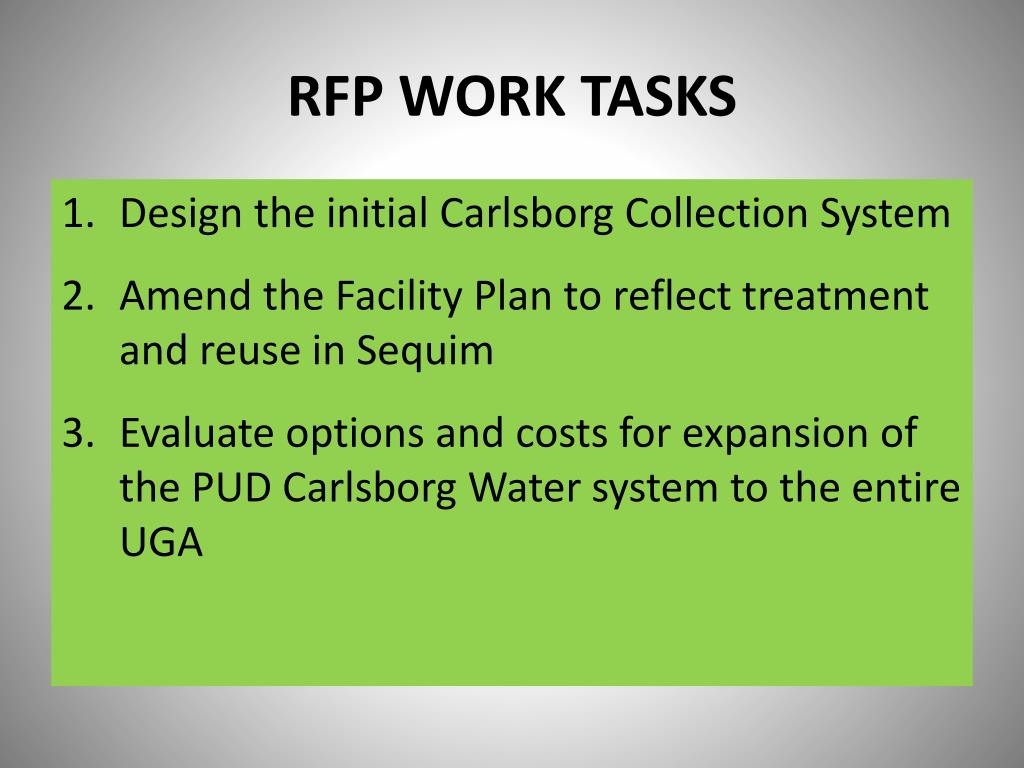

  12. RFP WORK TASKS • Design the initial Carlsborg Collection System • Amend the Facility Plan to reflect treatment and reuse in Sequim • Evaluate options and costs for expansion of the PUD Carlsborg Water system to the entire UGA

  13. NEXT STEPS: • Connection Policies and Costs – Priority • Inter-local Agreement between County and City of Sequim • Design Conveyance system to Sequim • Construction – completion by end of 2015

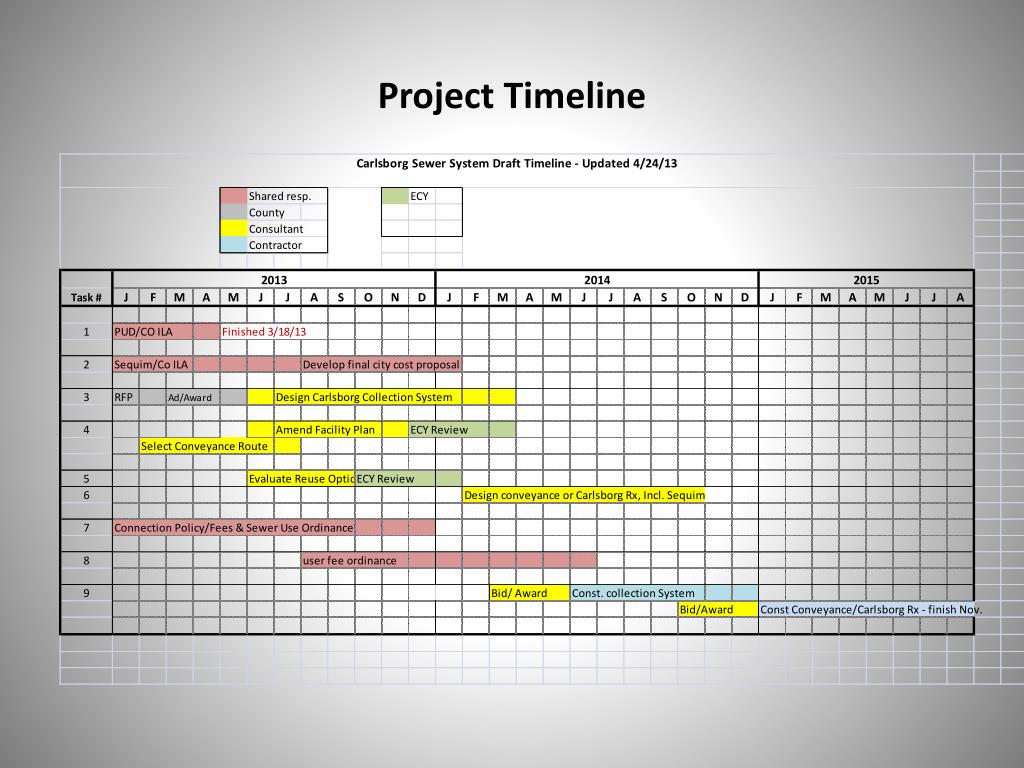

  14. Project Timeline
