This update provides an overview of the ongoing construction at Supalai Park Asoke-Ratchada as of February 2020. The project features the latest developments, including the front façade, groundworks up to level 6, and progress on structural installations, such as steel reinforcement and flooring. Key activities include preparing for concrete pouring on floor level 6 and installing plumbing and electrical systems. Additionally, we showcase the rear of the project site, indicating progress in formwork and reinforcement between living units and the parking area.
E N D

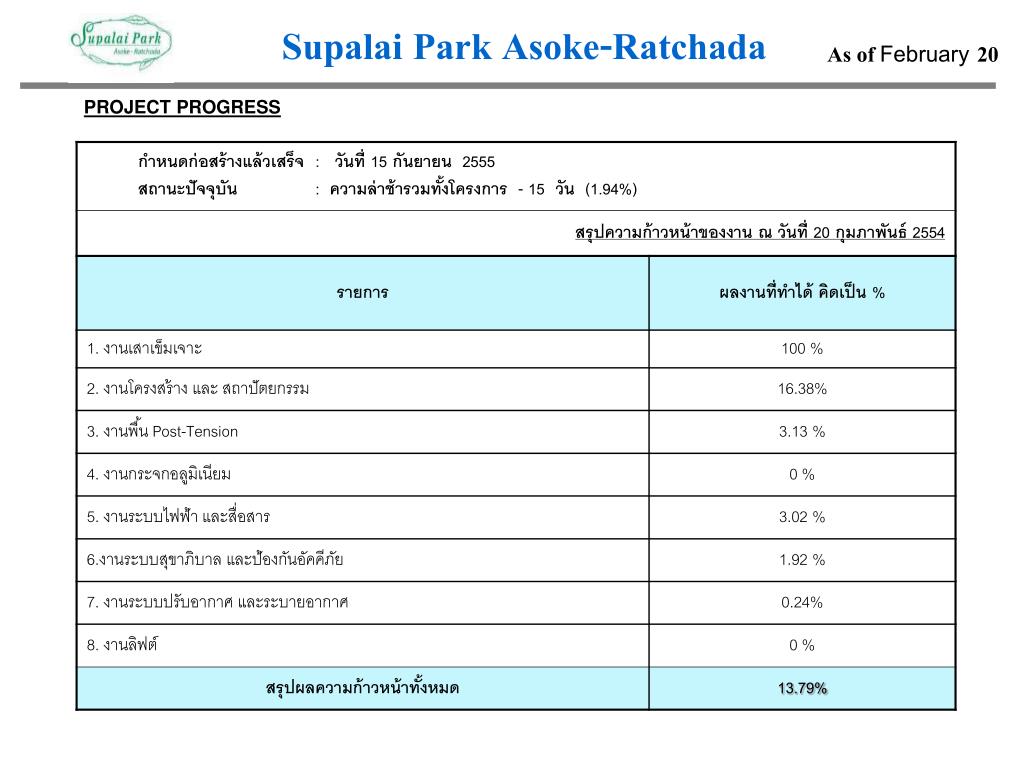

Supalai Park Asoke-Ratchada As of February 20 PROJECT PROGRESS
Supalai Park Asoke-Ratchada As of February 20 รูปแสดง :ภาพรวมของโครงการฯ
Supalai Park Asoke-Ratchada As of February 20 รูปแสดง :ด้านหน้าโครงการฯและงานพื้นถึงชั้นที่ 6 zone 1,2,3
Supalai Park Asoke-Ratchada As of February 20 รูปแสดง :ด้านหน้าโครงการฯ
Supalai Park Asoke-Ratchada As of February 20 รูปแสดง :เตรียมงานติดตั้งเหล็กเสาชั้นที่ 6 และงานปูพื้นชั้นที่ 6
Supalai Park Asoke-Ratchada As of February 20 รูปแสดง : งานวางเหล็กพื้น, งานติดตั้งระบบประปาและงานติดตั้งระบบไฟฟ้าชั้น ที่ 6 zone 1 เพื่อที่จะเตรียมเทคอนกรีตพื้นชั้น 6 zone 1
Supalai Park Asoke-Ratchada As of February 20 รูปแสดง :ด้านหลังโครงการฯงานติดตั้งไม้แบบท้องพื้นชั้นที่ P2 และวางเหล็กพื้น
Supalai Park Asoke-Ratchada As of February 20 รูปแสดง :ด้านหลังโครงการฯระหว่างส่วนที่เป็นห้องพักชั้นที่ 6 กับ ลานจอดรถชั้น P2
Supalai Park Asoke-Ratchada As of February 20 รูปแสดง :แบบแสดงความก้าวหน้าของโครงการฯ
