  1. Gamma-ray Large Area Space Telescope Lessons Learned and Earned Value Management System Assessment GLAST Large Area Telescope: Lowell A. Klaisner Stanford Linear Accelerator Center Project Manager Klaisner@slac.stanford.edu 650-926-2726

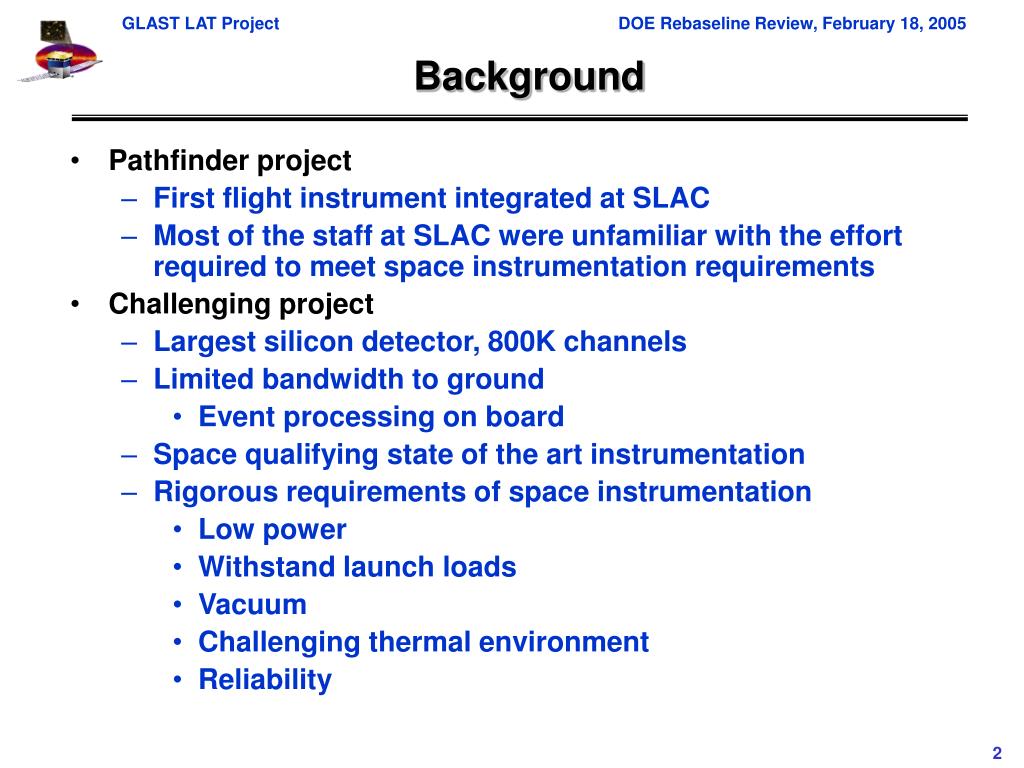

  2. Background • Pathfinder project • First flight instrument integrated at SLAC • Most of the staff at SLAC were unfamiliar with the effort required to meet space instrumentation requirements • Challenging project • Largest silicon detector, 800K channels • Limited bandwidth to ground • Event processing on board • Space qualifying state of the art instrumentation • Rigorous requirements of space instrumentation • Low power • Withstand launch loads • Vacuum • Challenging thermal environment • Reliability

  3. EVMS Assessment • The EVMS system could not anticipate problems that arose from insufficient engineering in critical areas early in the project and showed up in environmental testing as the project moved into the flight hardware fabrication phase • The EVMS system did not track earned value for work being done by foreign partners on independent budgets (eg the work in Italy supported by INFN and ASI) • The GLAST mission office exercised rigorous control of the requirements while the Office of Science exercised rigorous control of the funding which limited ability to respond to cost growth and schedule stretch out

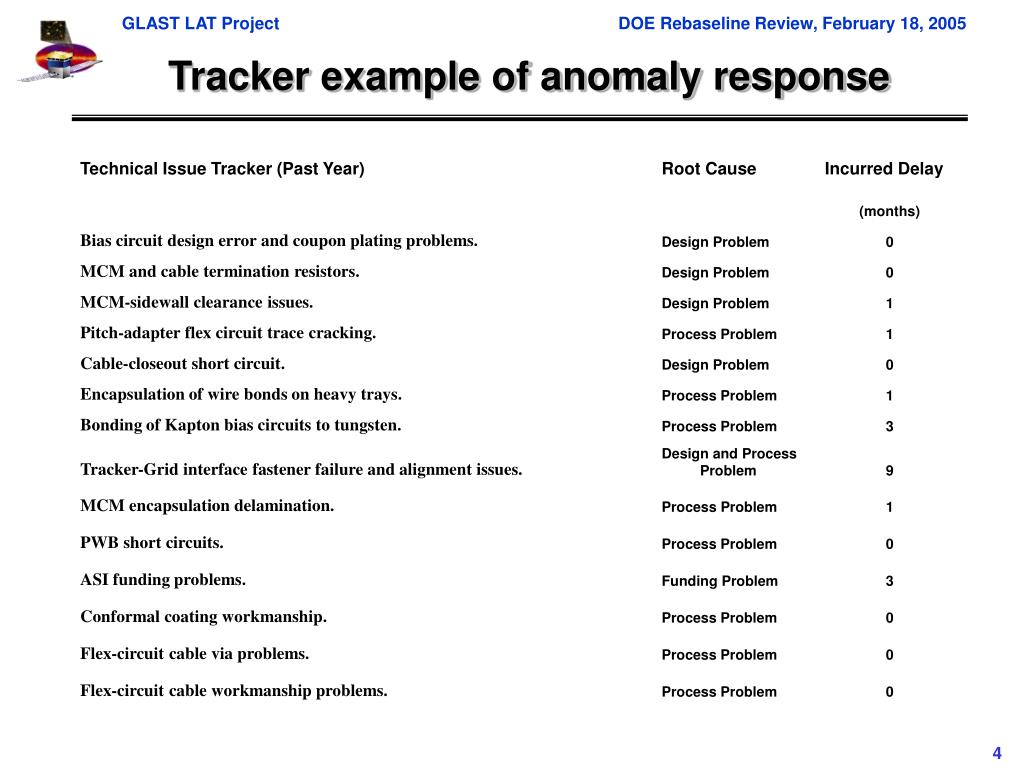

  4. Tracker example of anomaly response

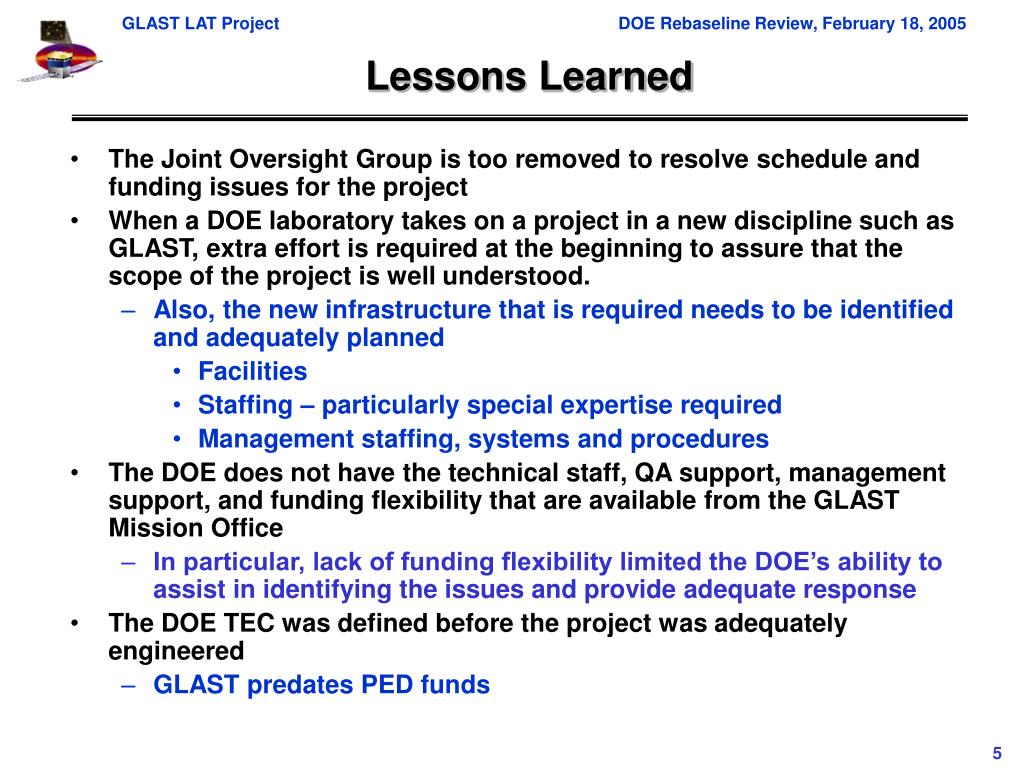

  5. Lessons Learned • The Joint Oversight Group is too removed to resolve schedule and funding issues for the project • When a DOE laboratory takes on a project in a new discipline such as GLAST, extra effort is required at the beginning to assure that the scope of the project is well understood. • Also, the new infrastructure that is required needs to be identified and adequately planned • Facilities • Staffing – particularly special expertise required • Management staffing, systems and procedures • The DOE does not have the technical staff, QA support, management support, and funding flexibility that are available from the GLAST Mission Office • In particular, lack of funding flexibility limited the DOE’s ability to assist in identifying the issues and provide adequate response • The DOE TEC was defined before the project was adequately engineered • GLAST predates PED funds

  6. Path Forward • SLAC now has the facilities in place to integrate a space instrument • Key staff are in place to execute future space-based instrumentation projects • In particular, a strong data acquisition system staff is in place with experience with space hardware and software • The Kavli institute is attracting renown astro-physicists • Executing key science with GLAST • Planning and executing future astro-physics projects.
