30 likes | 146 Vues
This document outlines the latest discussions from the Draft Capacity and Connection Plan Initial Transmission Workgroup. It provides updated scenario timelines, detailing the stages of the PARCA process, including the next steps for formal capacity applications and the timing involved. Additionally, it compares business rules and methodologies, highlights the review process, and recommends principles for user commitment and funding. Emphasis is placed on the development of legal texts, systems impacts, and ongoing consultations, ensuring thorough communication and stakeholder engagement.
E N D
Initial Transmission Workgroup Discussions Updated scenario timelines with detail of PARCA stages LTNF - Next Stages Formal Capacity Applications – How and When? LTNF - Next Stages PARCA Business Rules Comparison of Split Auctions / PARCA / Status Quo LTNF High Level Business Rules & Scenarios PARCA Business Rules LTNF - Next Stages Continuous Review of Methodology Statements

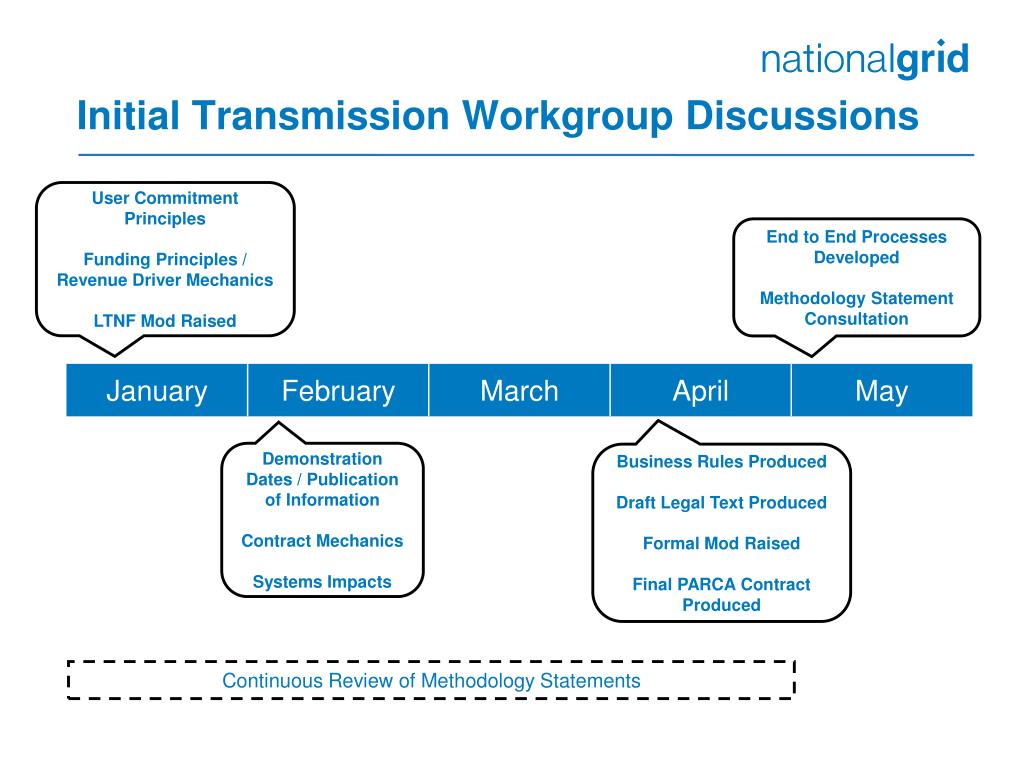

Initial Transmission Workgroup Discussions User Commitment Principles Funding Principles / Revenue Driver Mechanics LTNF Mod Raised End to End Processes Developed Methodology Statement Consultation Demonstration Dates / Publication of Information Contract Mechanics Systems Impacts Business Rules Produced Draft Legal Text Produced Formal Mod Raised Final PARCA Contract Produced Continuous Review of Methodology Statements
