„Progress Reports“ On project level and on Project Partner level Dennis Ehm, ARL

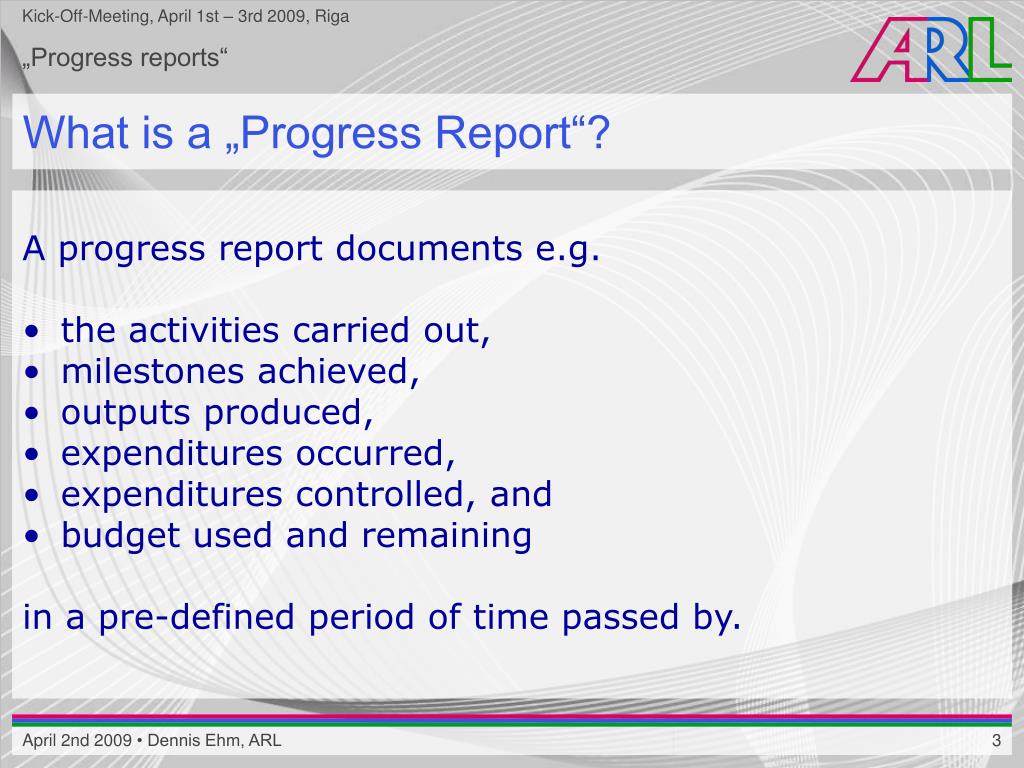

What is a „Progress Report“? A progress report documents e.g. • the activities carried out, • milestones achieved, • outputs produced, • expenditures occurred, • expenditures controlled, and • budget used and remaining in a pre-defined period of time passed by.

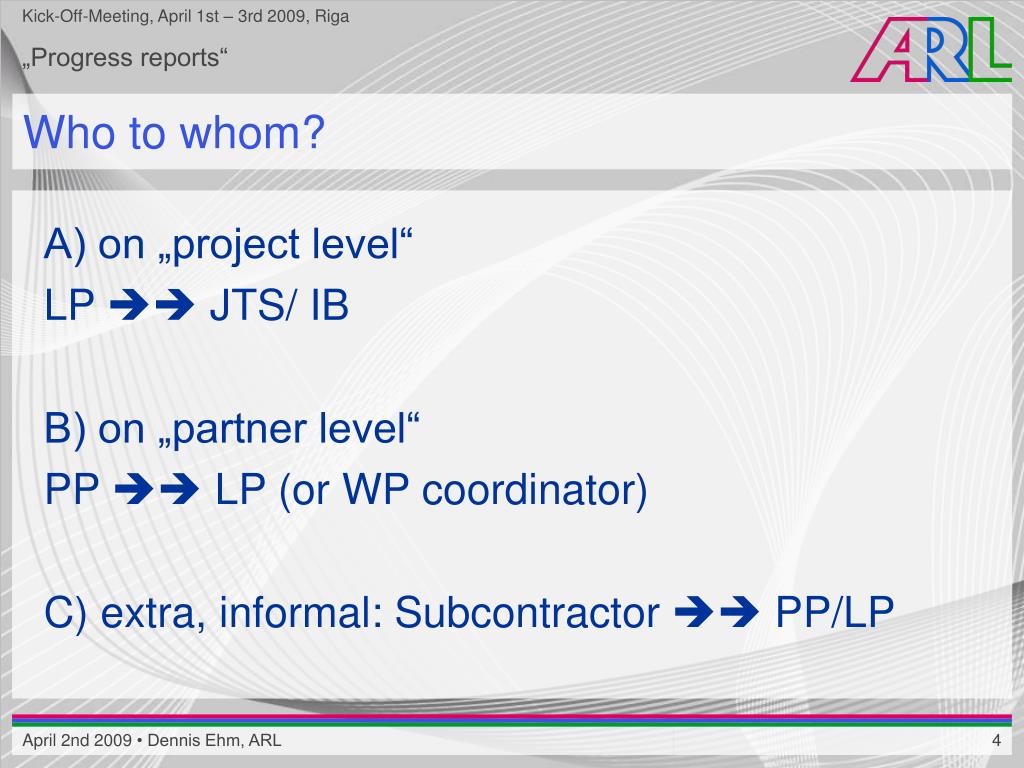

Who to whom? A) on „project level“ LP JTS/ IB B) on „partner level“ PP LP (or WP coordinator) C) extra, informal: Subcontractor PP/LP

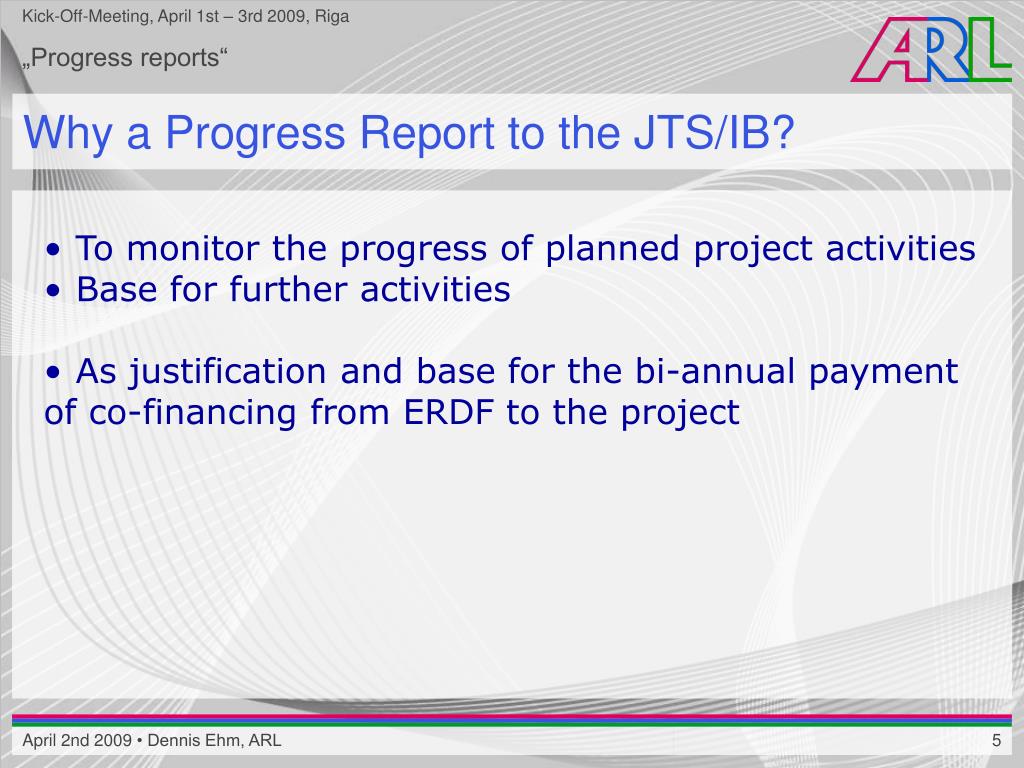

Why a Progress Report to the JTS/IB? • To monitor the progress of planned project activities • Base for further activities • As justification and base for the bi-annual payment of co-financing from ERDF to the project
Reporting periods and due date on project level Reports are due 3 months after end of each reporting period. Exactly defined in the Grant Contract:
Subjects of the progress reports Every Progress Report: • activities = Activity progress Report (AR) • finances = Financial Report (FR) remark: so far only a draft version of the progress report exists, thus amendments are still possible
Extra contents of the 1st progress report • Partnership Agreement signed by all Project Partners • Outputs defined, their indicators and their targets • communication plan (due already July 31st 2009) • preparation activities and expenditures (remark: so far only a draft version of the progress report exists, thus amendments are still possible)

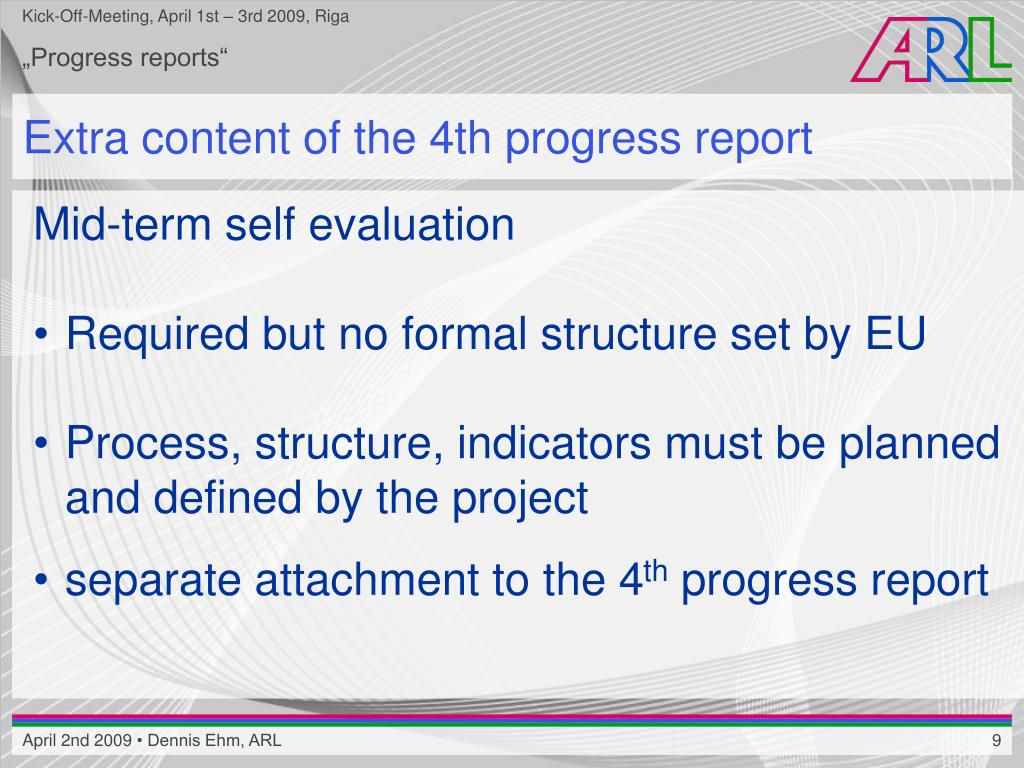

Extra content of the 4th progress report Mid-term self evaluation • Required but no formal structure set by EU • Process, structure, indicators must be planned and defined by the project • separate attachment to the 4th progress report
Content of the Activity Report (AR) to JTS/IB probably (so far only a draft version of the progress report exists, thus amendments are still possible): • project summary (for official website) • achievements • overview of the work plan‘s progress • progress per WP (activities and milestones) • main outputs • marketing information and material
Content of the Financial Report (FR) to JTS/IB probably (so far only a draft version of the progress report exists, thus amendments are still possible): • Eligible expenditures occurred per WP/ per BL • specification of external services, equipment and investments • total expenditures per Project Partner • interests/ revenues (if applicable) • complementary activities • First Level Control (FLC) confirmation on project level
Progress reports on „partner level“ PP LP (or to WP coordinator) • activities = Activity progress Report (AR) • in more detail than on project level • selected topics for report on project level • finances = Financial Report (FR) • expenditures basing on partner budget • First Level Control (FLC) on partner level
Timing/ Schedule Allow one month for the LP • to summarize single reports, • to possibly ask for additional information and documents from single PPs and • to get First Level Control Certification on project level.

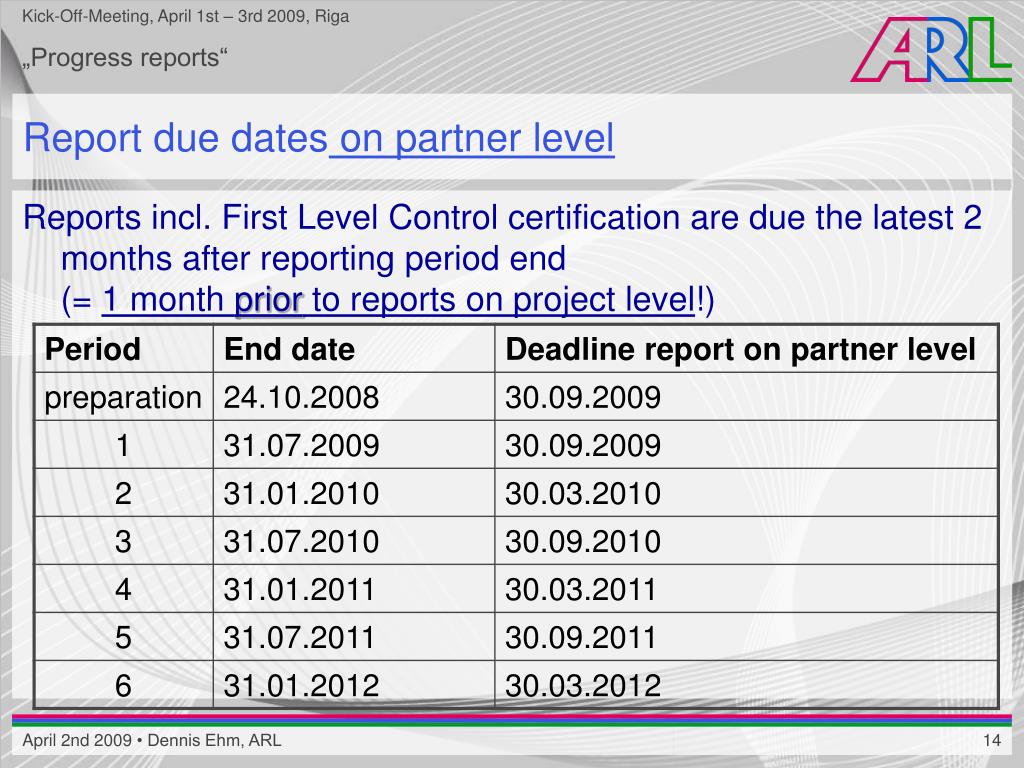

Report due dates on partner level Reports incl. First Level Control certification are due the latest 2 months after reporting period end (= 1 month prior to reports on project level!)
Reporting „system“ • reporting system is a puzzle of single reports (activity, financial) • sum of each level is base for next higher level

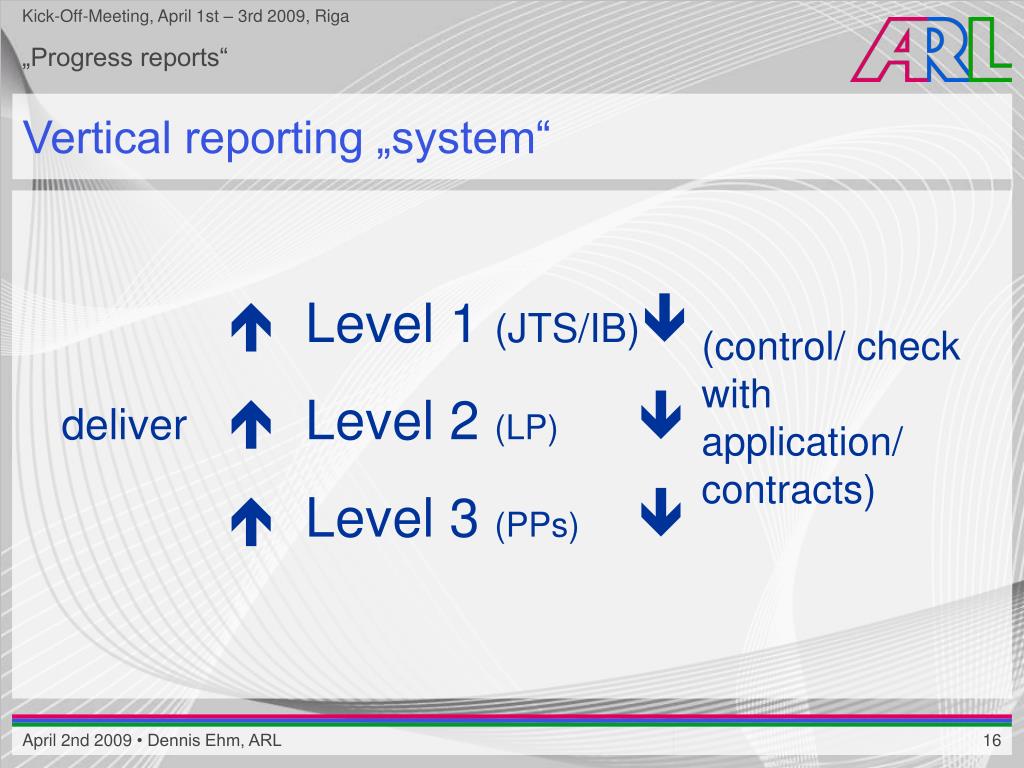

Vertical reporting „system“ Level 1 (JTS/IB) Level 2 (LP) Level 3 (PPs) (control/ check with application/contracts) deliver
Horizontal reporting „system“ e.g. output/activity WP1+WP2+WP3 = project outputs/activities BL 2 of PP1 + PP2 + PP3-n = BL 2 of project
„System“ Every single reporting partner is part of the whole reporting system. Only functions if everybodydelivers its report(s).

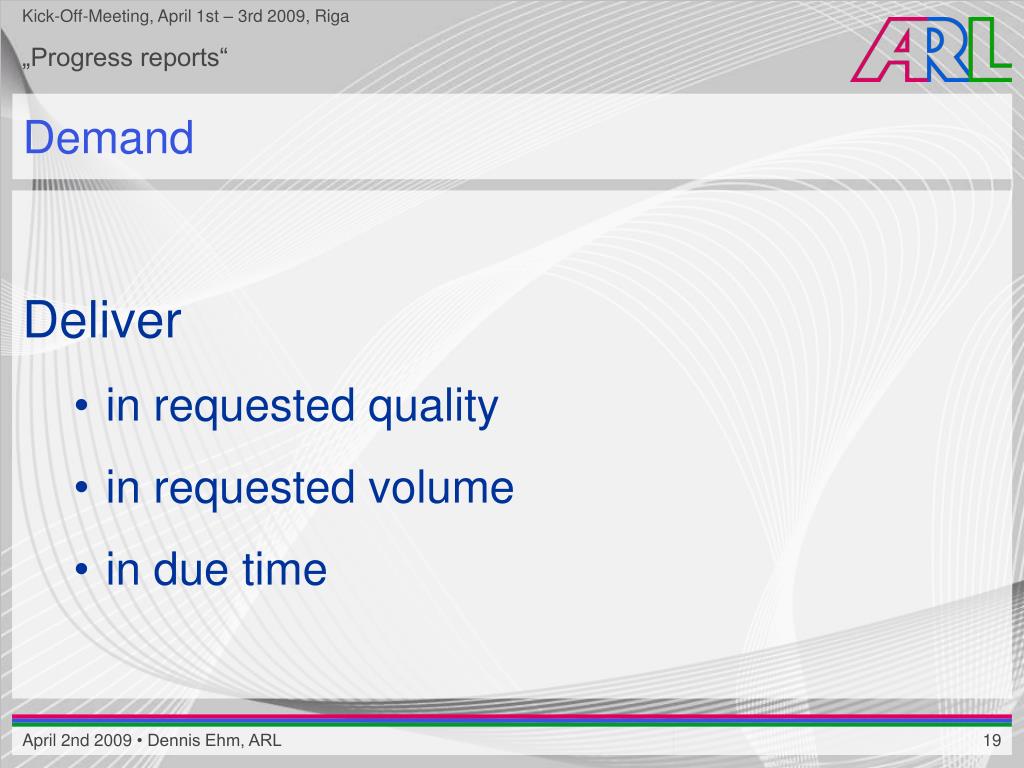

Demand Deliver • in requested quality • in requested volume • in due time

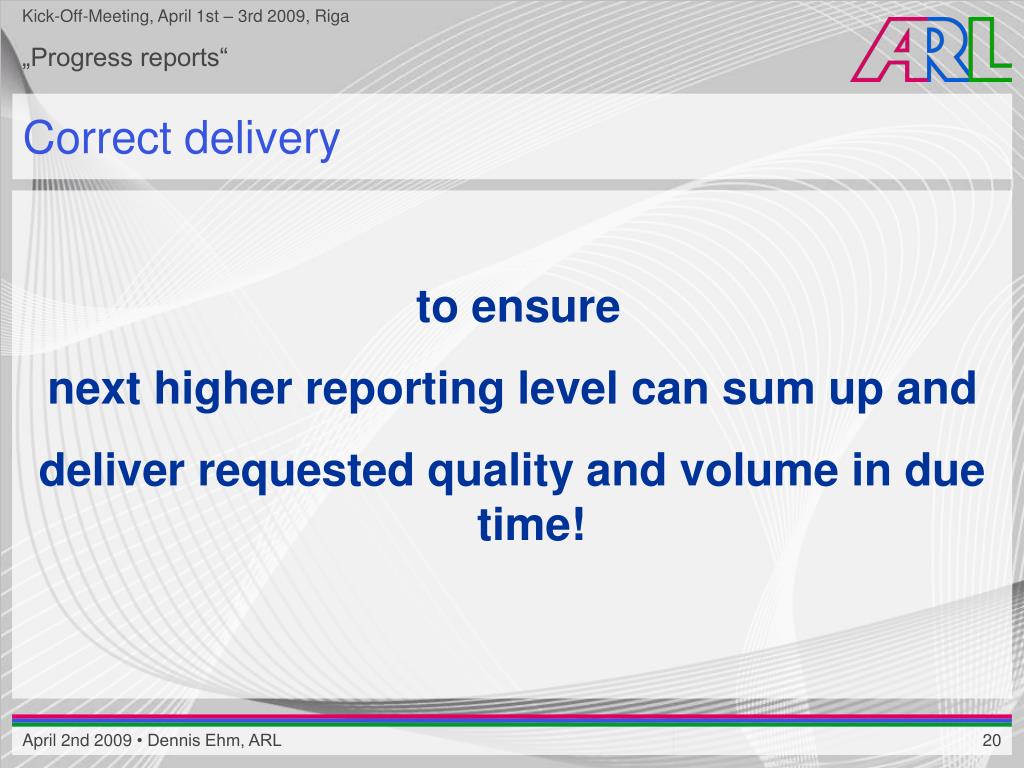

Correct delivery to ensure next higher reporting level can sum up and deliver requested quality and volume in due time!
Subsidy Payment base Keep in mind: Reports are the base for payment of the subsidy!

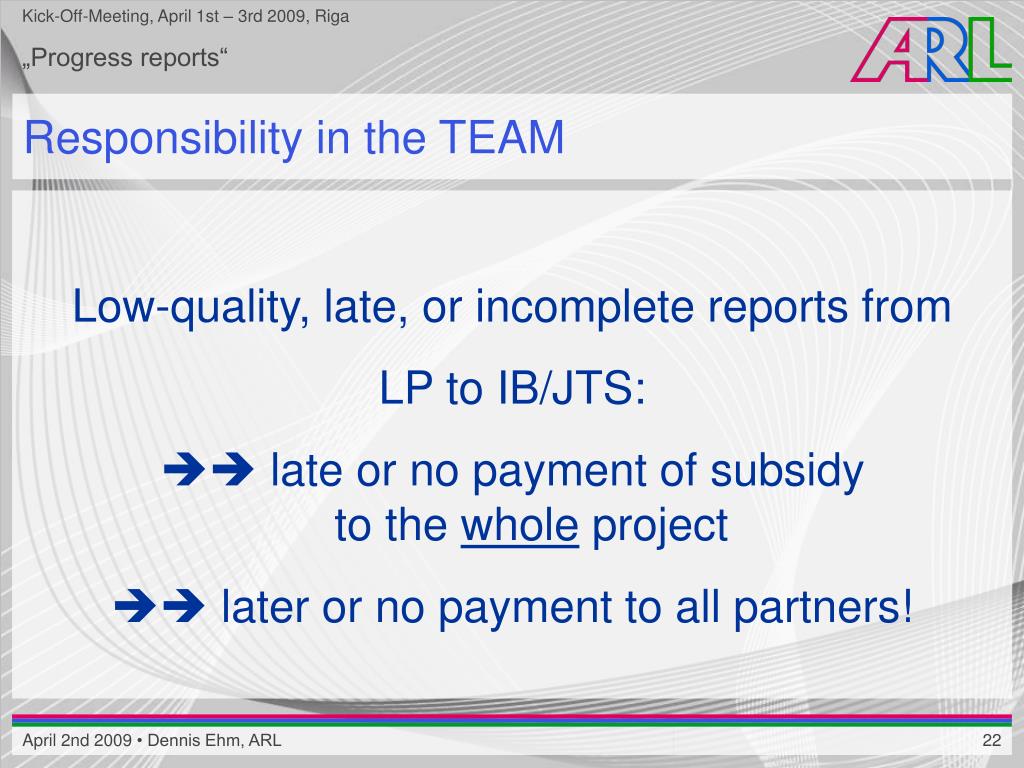

Responsibility in the TEAM Low-quality, late, or incomplete reports from LP to IB/JTS: late or no payment of subsidy to the whole project later or no payment to all partners!
Consequences E.g. Financial report of one partner missing/ not accepted: IB will not pay out any subsidy for the reporting period! (even though all other partners delivered AR and FR in requested quality, volume and time!)
Awareness for work-flow • Timing • Every single report is base for higher level report • Subsidy for whole project only if all single reports delivered in correct quality, volume and time

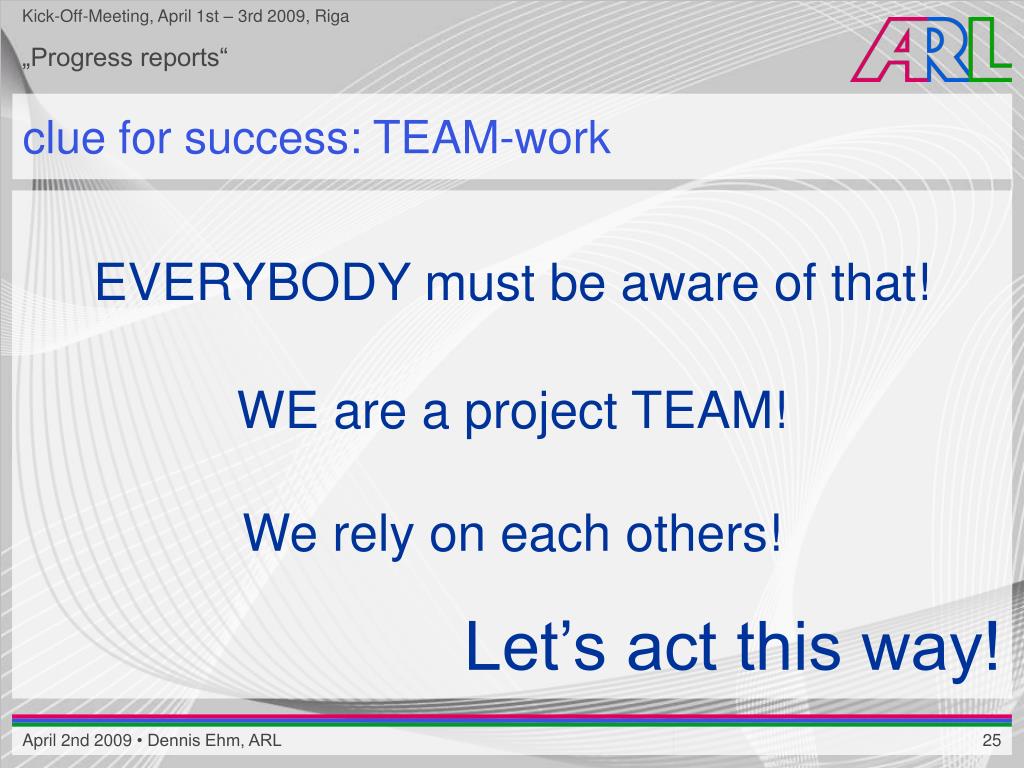

clue for success: TEAM-work EVERYBODY must be aware of that! WE are a project TEAM! We rely on each others! Let’s act this way!
