“First In the Nation” Diverging Diamond Interchange IS 44 and MO 13 - Springfield, MO. Joseph C Rickman, PE, ACTAR District Traffic Engineer MoDOT – Springfield Region. Kansas & I-44, 2008. Kansas & I-44, 2008. Norton Rd. 681 ft’. Evergreen 296 ft’. Basic Interchange Problems.

donny
Télécharger la présentation

“First In the Nation” Diverging Diamond Interchange IS 44 and MO 13 - Springfield, MO

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. “First In the Nation” Diverging Diamond Interchange IS 44 and MO 13 - Springfield, MO Joseph C Rickman, PE, ACTAR District Traffic Engineer MoDOT – Springfield Region

  2. Kansas & I-44, 2008

  3. Kansas & I-44, 2008 Norton Rd. 681 ft’ Evergreen 296 ft’

  4. Basic Interchange Problems • Congestion • 15-30% left turns • 10-15% HGV • Closely spaced signals • Crashes • Pedestrian Accommodations

  5. Congestion

  6. Concept Design of the DDI

  7. VISSIM Model

  8. inVISION Studios Simulation

  9. Opening Day – June 21st, 2009

  10. Opening Day Signal Timing • Interchange still under construction • Norton Rd Autoscope System failed • No Evergreen Rd signals due to construction • Time Travels run each plan throughout the day

  11. Finishing the DDI • Islands installed • Pedestrian buttons added • Temporary signals moved from gores • Permanent advanced signals added in islands

  12. July 7th, 2009

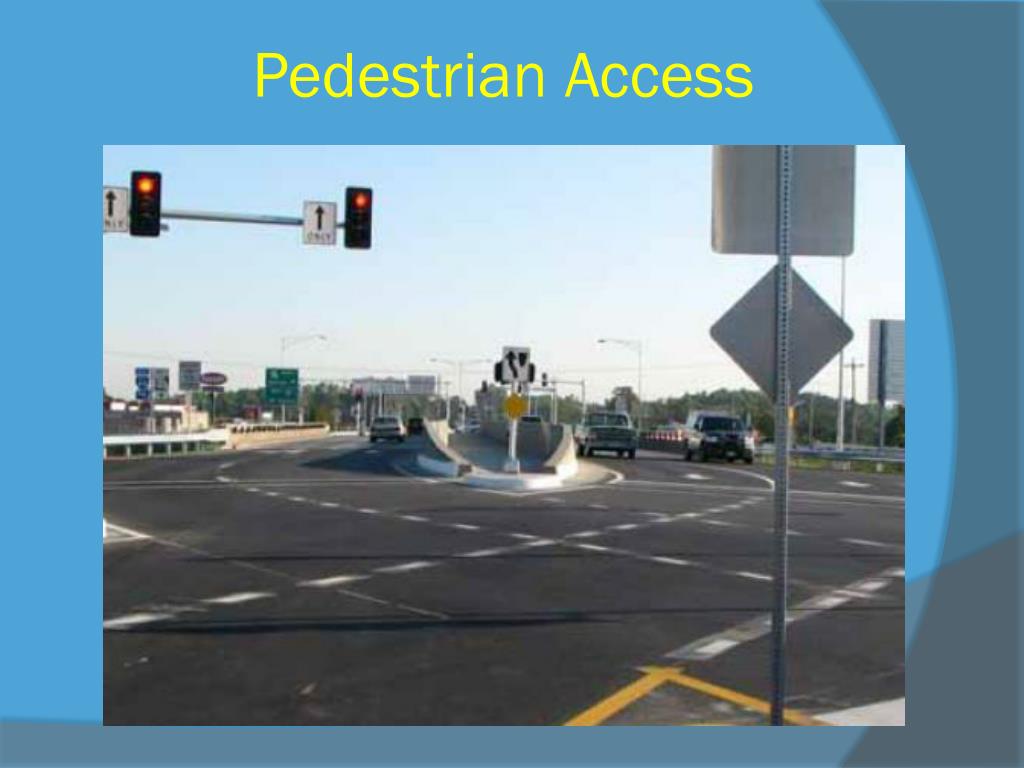

  13. Pedestrian Access

  14. Pedestrian Access

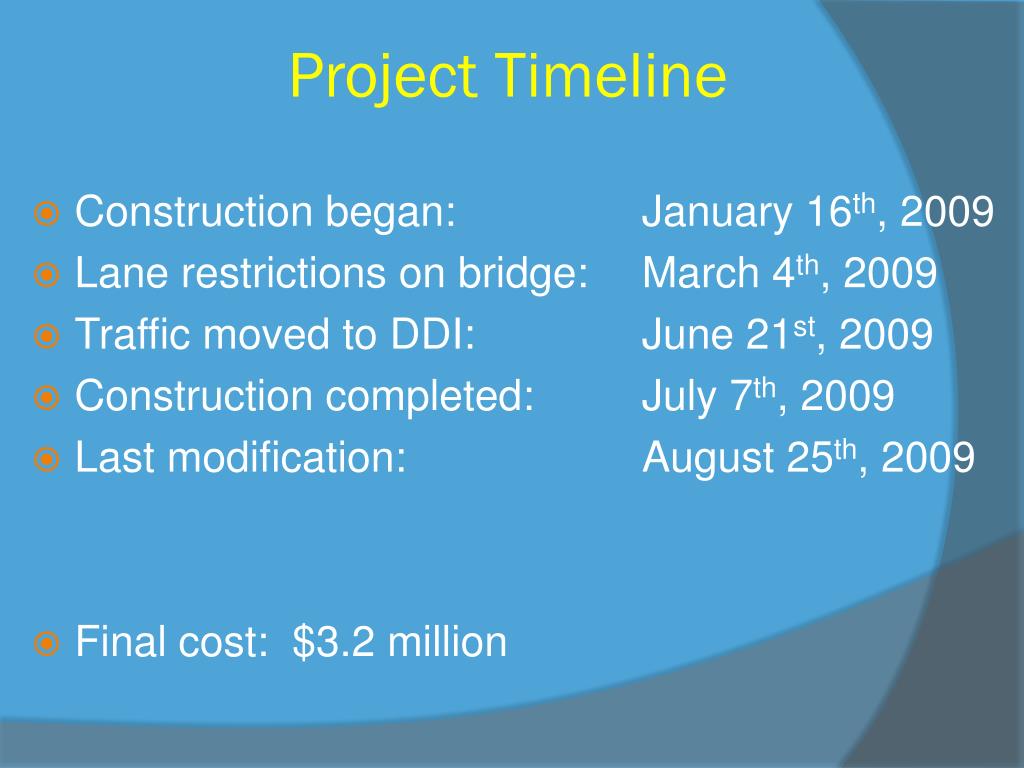

  15. Project Timeline • Construction began: January 16th, 2009 • Lane restrictions on bridge: March 4th, 2009 • Traffic moved to DDI: June 21st, 2009 • Construction completed: July 7th, 2009 • Last modification: August 25th, 2009 • Final cost: $3.2 million

  16. Operational Effects Superload on March 3, 2010

  17. Operational Effects • Accidents • Total Reduction 24% (50% between ramps) • Injury Reduction 50% • Congestion removed on the bridge • Consultant Performance Evaluation (HDR)

  18. Public Perception • MoDOT survey of 8 zip codes • 400 sent, 75 returned • The Right Solution – 89.4% • More Convenient – 95.1% • Less Congested – 95.2% • Safer – 96.7%

  19. Questions? Joseph C Rickman, PE, ACTAR District Traffic Engineer 417-895-7635 Joseph.Rickman@modot.mo.gov
