Highway 169 Phase 2 (Part 2) – Cross Range Expressway

Highway 169 Phase 2 (Part 2) – Cross Range Expressway. April 30, 2014 Public Information Meeting Taconite Community Center . Today’s Meeting. Agenda Overview Short Presentation ~ 15 min Questions/Comments. Agenda. History of the Cross Range Expressway Corridors of Commerce (COC) Program

gerik
Télécharger la présentation

Highway 169 Phase 2 (Part 2) – Cross Range Expressway

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Highway 169Phase 2 (Part 2) – Cross Range Expressway April 30, 2014 Public Information Meeting Taconite Community Center

  2. Today’s Meeting Agenda Overview Short Presentation ~ 15 min Questions/Comments

  3. Agenda History of the Cross Range Expressway Corridors of Commerce (COC) Program MnDOT District 1 COC Project - TH 169 • Proposed Improvements • Project Update • Next Steps ROW Acquisition Process Questions

  4. Cross Range Expressway

  5. Project History 1986 Draft Environmental Impact Statement 1989 Final Environmental Impact Statement 1994 Phase I Construction 2003 Phase II Environmental Assessment 2006-2007 Phase II (Part 1) Construction 2016 Phase II (Part 2) Construction (COC)

  6. Expressway Segments Phases Length Constructed Remaining Phase I 6.7 mi. 1994 Phase II (part 1) 2.8 mi. 2006 & 2007 Phase II (part 2)1.6 mi. X Phase III 3.8 mi. X Phase IV 1.9 mi X Phase V 2.1 mi X Total 18.9 miles 9.4 miles

  7. Corridors of Commerce Program The 2013 Minnesota Legislature created the Corridors of Commerce program by authorizing the sale of up to $300 million in new bonds for the construction, reconstruction and improvement of trunk highways. District 1 proposed TH 169 Expansion Project • Selected November 2013 • Legislature allocated $14M to $20M

  8. Corridors of Commerce Program TH 169 Freight Route

  9. District 1 – Corridors of Commerce Project TH 169 2-lane to 4-lane expansion 1.55 mile segment Existing AADT 6,600 (2011) TH 169 – Supplemental Freight Route Part of Phase II of the Cross Range Expressway Environmental Assessment completed for this segment in 2003 Const. Cost Estimate = $9.5M

  10. Phase 2 (Part 2) East End of Bovey Bypass 0.3 Mi E. of CSAH 7

  11. Project Improvements • TH 169 • Better Clear Zone, Center Median • Install Intersection Lighting (CSAH 15 and CSAH 7) • Construct designated Turn Lanes • Access Control (Combine Access in Holman) • Replace Plate Steel Box Culvert • CSAH 15 • Realign Intersection to 90 degrees • Realign Intersection with Rail Corridor to near 90 degrees • CSAH 7 • Replace Plate Steel Box Culvert

  12. Project Update Project Alignment and Limits Established Wetland Delineation – completed Fall of 2013 Preliminary Design - continued Field Surveys – nearly completed Property Acquisition – Titles Acquired Agency Coordination – • MnDNR - permit • Corp of Engineers – wetland permit • MPCA – stormwater treatment

  13. Project Update (cont’d) Project Outreach and Coordination started– • Itasca County • City of Taconite • Western Mesabi Mine Planning Board • Canadian National Railway • Mesabi Bike Trail • Local Snowmobile Clubs • Utility Companies

  14. Next Steps Survey Mapping, Soil Investigations – May 2014 Environmental Assessment (Re-Evaluation) – Fall 2014 ROW Acquisition Complete – Spring 2016 Final Design – Start July 2014 & Finish Spring 2016 Project Permitting Project Letting – June 2016

  15. ROW Acquisition Process MnDOT Determines Land Ownership - MnDOT Design Finalizes Construction Limits MnDOT Notifies Affected Property Owners- - Anticipated Late 2014 or Early 2015 MnDOT has affected Parcels Appraised MnDOT prepares written Offers to Purchase

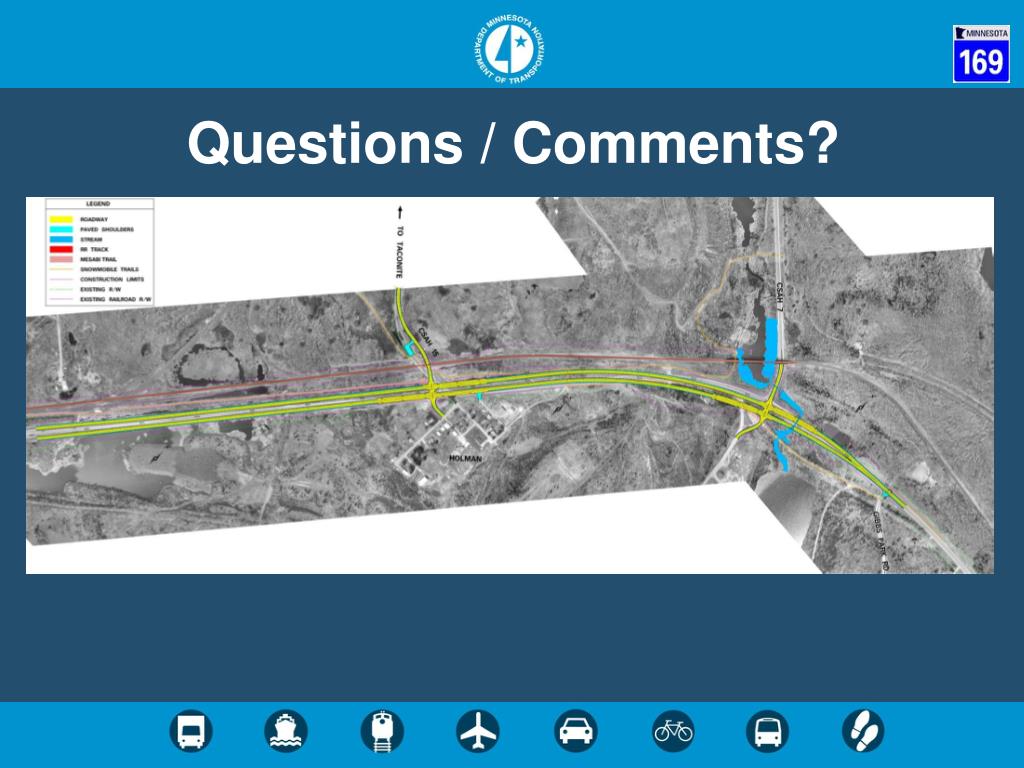

  16. Questions / Comments?

  17. Expressway Segment Costs Project Estimated Phases Cost Total Project Cost Phase I $10.0 M Phase II (part 1) $14.6 M Phase II (part 2) $11.5M - $12.5M Phase III $35M - $46M** Phase IV $17M - $22M** Phase V $58M - $77M** Total $121.5M – 157.5M ** 2018 Dollars

  18. Traffic Data (AADT) Segments 2000 2011 2032* 2032 ** Bovey to CSAH 7 5,800 6,600 7,700 9,500 CSAH 7 to Marble 5,500 5,800 7,300 9,100 Marble to Calumet 4,900 5,600 6,200 8,000 Calumet to Pengilly 4,750 5,600 7,200 9,000 * Based on MnDOT Projections ** Based on Projected AADT of 1800 from SEH Traffic Analysis for Essar Steel Project
