Tidal Energy in Alaska Permitting Issues

Tidal Energy in Alaska Permitting Issues. Michael Murphy Devine Tarbell & Associates. Overview. Interest in United States and Alaska Differences - Conventional Hydro and Tidal Power Federal Regulatory Jurisdiction Federal Energy Regulatory Commission Other Applicable Regulations

graham
Télécharger la présentation

Tidal Energy in Alaska Permitting Issues

An Image/Link below is provided (as is) to download presentation Download Policy: Content on the Website is provided to you AS IS for your information and personal use and may not be sold / licensed / shared on other websites without getting consent from its author. Content is provided to you AS IS for your information and personal use only. Download presentation by click this link. While downloading, if for some reason you are not able to download a presentation, the publisher may have deleted the file from their server. During download, if you can't get a presentation, the file might be deleted by the publisher.

E N D

Presentation Transcript


  1. Tidal Energy in AlaskaPermitting Issues Michael Murphy Devine Tarbell & Associates

  2. Overview • Interest in United States and Alaska • Differences - Conventional Hydro and Tidal Power • Federal Regulatory Jurisdiction • Federal Energy Regulatory Commission • Other Applicable Regulations • Minerals Management Service • Issues/Challenges • Discussion Panel

  3. Activity in United States • EPRI Reports • Currently 43 Applications for Wave and Tidal Preliminary Permits at FERC • 36 Applications for Tidal • Verdant Power RITE Project

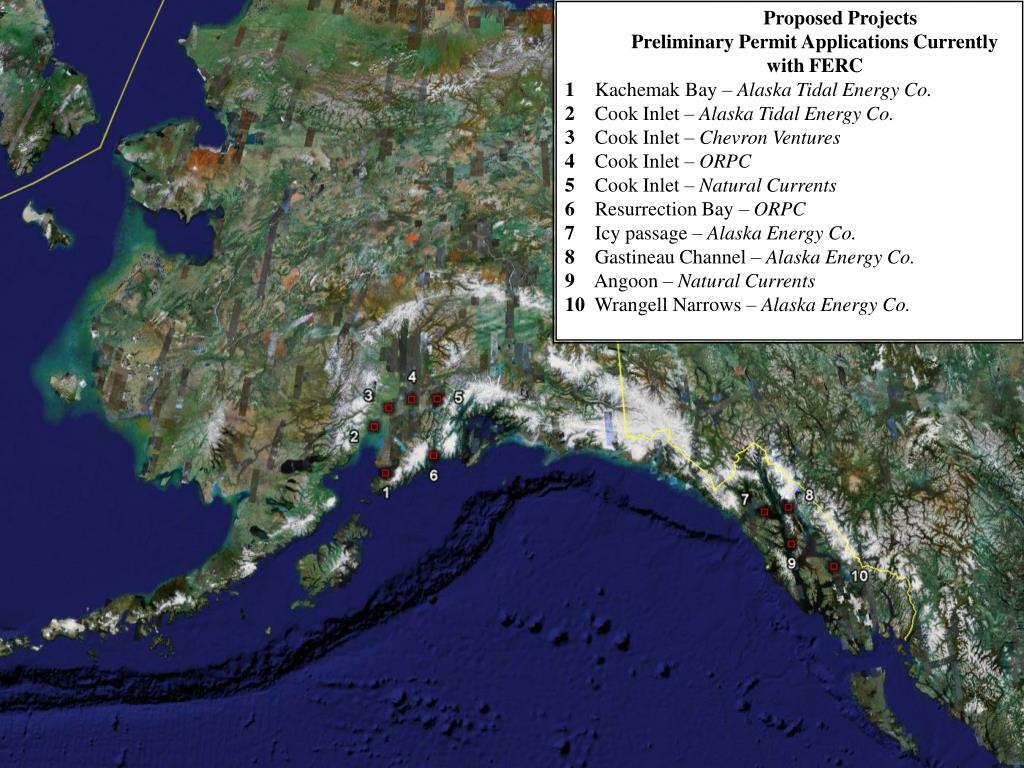

  4. Proposed Projects • Preliminary Permit Applications Currently with FERC • 1 Kachemak Bay – Alaska Tidal Energy Co. • 2 Cook Inlet – Alaska Tidal Energy Co. • 3 Cook Inlet – Chevron Ventures • 4 Cook Inlet – ORPC • 5 Cook Inlet – Natural Currents • 6 Resurrection Bay – ORPC • 7 Icy passage – Alaska Energy Co. • 8 Gastineau Channel – Alaska Energy Co. • 9 Angoon – Natural Currents • 10 Wrangell Narrows – Alaska Energy Co.

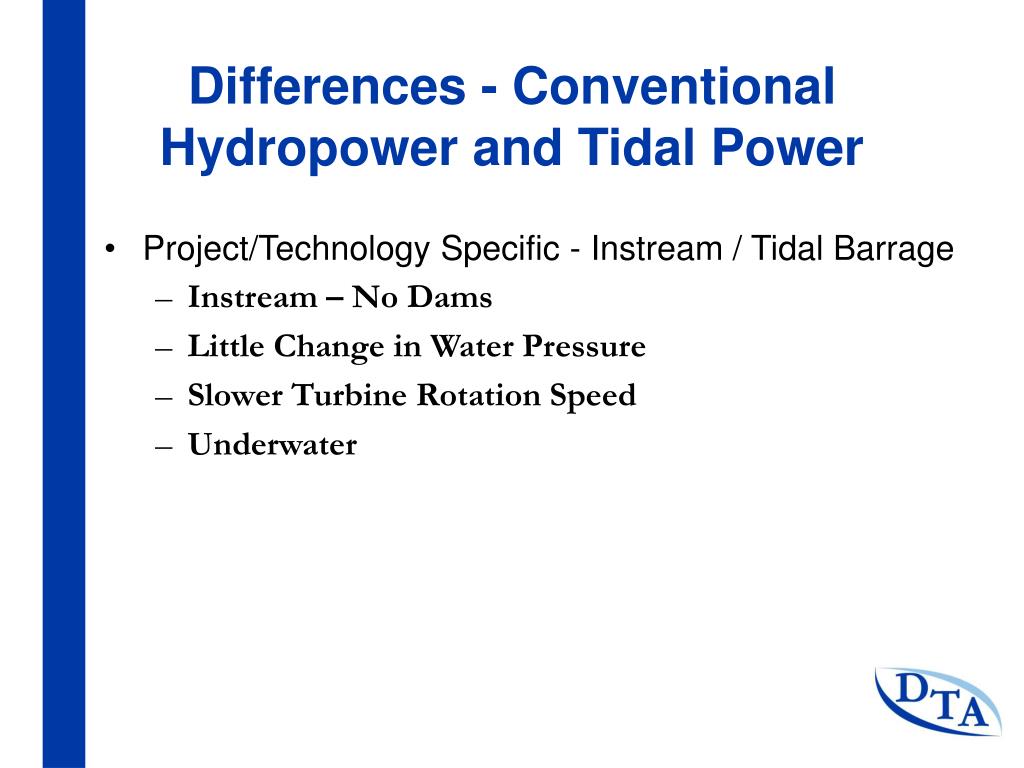

  5. Differences - Conventional Hydropower and Tidal Power • Project/Technology Specific - Instream / Tidal Barrage • Instream – No Dams • Little Change in Water Pressure • Slower Turbine Rotation Speed • Underwater

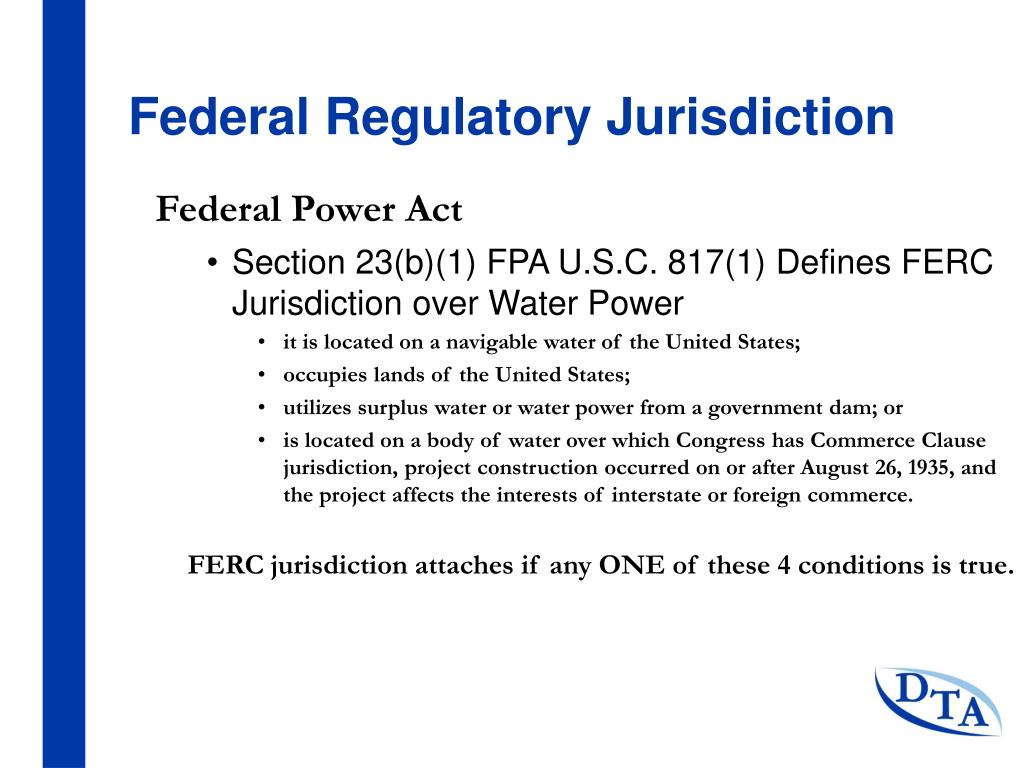

  6. Federal Regulatory Jurisdiction Federal Power Act • Section 23(b)(1) FPA U.S.C. 817(1) Defines FERC Jurisdiction over Water Power • it is located on a navigable water of the United States; • occupies lands of the United States; • utilizes surplus water or water power from a government dam; or • is located on a body of water over which Congress has Commerce Clause jurisdiction, project construction occurred on or after August 26, 1935, and the project affects the interests of interstate or foreign commerce. FERC jurisdiction attaches if any ONE of these 4 conditions is true.

  7. Federal Regulatory Jurisdiction • FERC issues licenses for up to 50 years for constructing, operating and maintaining non federal hydropower projects • The Electric Consumers Protection Act mandated that FERC give equal consideration to both power and non power resources when issuing hydropower licenses. Each license will include terms and conditions to protect, mitigate for damage, and enhance fish and wildlife and their habitat. • Applicability to Ocean Energy Projects?

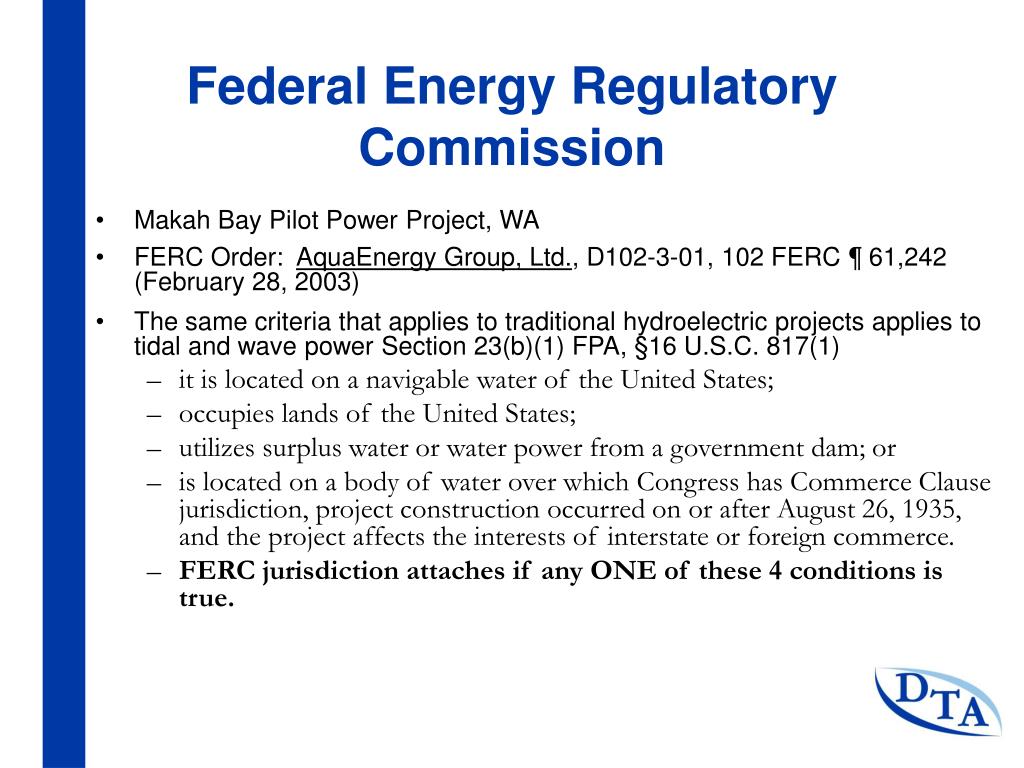

  8. Federal Energy Regulatory Commission • Makah Bay Pilot Power Project, WA • FERC Order: AquaEnergy Group, Ltd., D102-3-01, 102 FERC ¶ 61,242 (February 28, 2003) • The same criteria that applies to traditional hydroelectric projects applies to tidal and wave power Section 23(b)(1) FPA, §16 U.S.C. 817(1) • it is located on a navigable water of the United States; • occupies lands of the United States; • utilizes surplus water or water power from a government dam; or • is located on a body of water over which Congress has Commerce Clause jurisdiction, project construction occurred on or after August 26, 1935, and the project affects the interests of interstate or foreign commerce. • FERC jurisdiction attaches if any ONE of these 4 conditions is true.

  9. Federal Energy Regulatory Commission • Green Wave Rhode Island Ocean Wave Energy Project • FERC Order: Energetech America, LLC., 113 FERC ¶ 62,027 (2005) • Does not provide licensing relief for Oscillating Water Column Technologies that rely on air to generate electricity

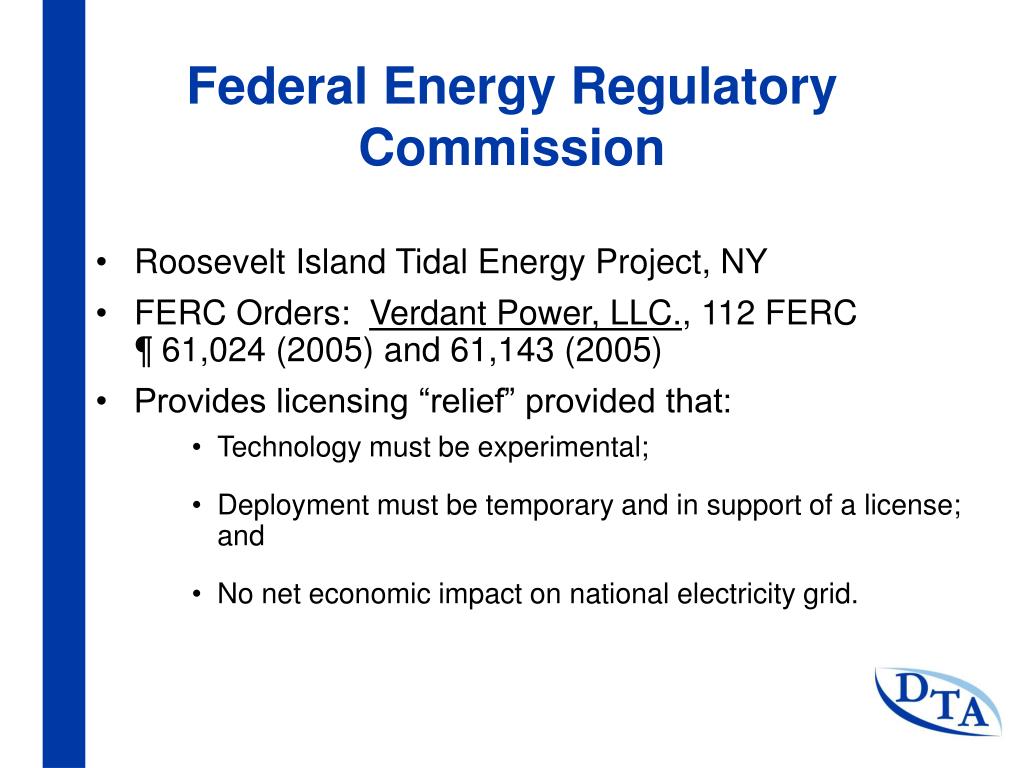

  10. Federal Energy Regulatory Commission • Roosevelt Island Tidal Energy Project, NY • FERC Orders: Verdant Power, LLC., 112 FERC ¶ 61,024 (2005) and 61,143 (2005) • Provides licensing “relief” provided that: • Technology must be experimental; • Deployment must be temporary and in support of a license; and • No net economic impact on national electricity grid.

  11. What is the FERC Process? • Preliminary Permit • Three Years • Section 5 of the Federal Power Act (16 U.S.C. §798) authorizes FERC to issue preliminary permits. As defined in this section, a preliminary permit is issued “for the sole purpose of maintaining priority of application for a license.” As further described in the Commission’s regulations, in addition to securing priority of application for license, a preliminary permit also provides a prospective developer time to evaluate the feasibility of and complete the studies required for a development application (18 CFR §4.80). • Does not authorize construction • Not a pre requisite for a license application, does not start the licensing process • No license application can be accepted by FERC

  12. What is the FERC Process? • Licensing Process - Integrated Licensing Process (ILP) is the Default Process • Traditional Licensing Process and Alternative Licensing Processes • Pre-Application Document/Notice of Intent • Request for Waiver • FERC Consultation – Stakeholder Involvement - Resource Concerns • Study Plan Development • Draft and Final License Applications Exemption from Licensing – If project is less than 5 MW applicant may apply for exemption. Procedure for applying is similar (3 stage process) as for a license. If granted FERC will impose terms and conditions.

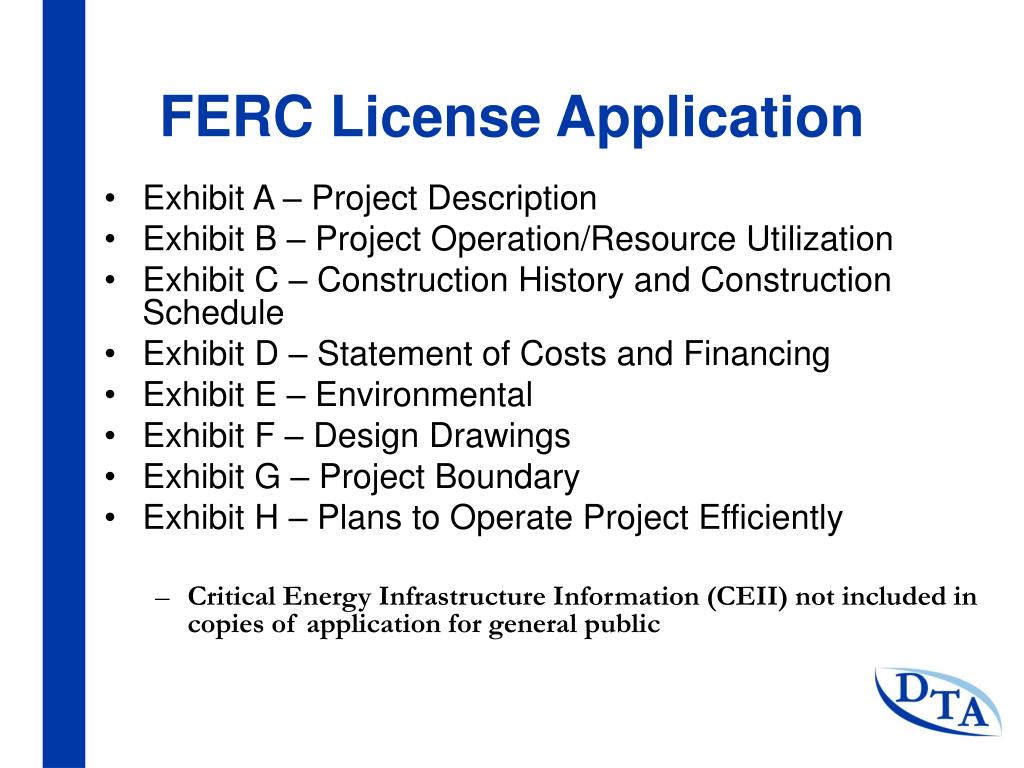

  13. FERC License Application • Exhibit A – Project Description • Exhibit B – Project Operation/Resource Utilization • Exhibit C – Construction History and Construction Schedule • Exhibit D – Statement of Costs and Financing • Exhibit E – Environmental • Exhibit F – Design Drawings • Exhibit G – Project Boundary • Exhibit H – Plans to Operate Project Efficiently • Critical Energy Infrastructure Information (CEII) not included in copies of application for general public

  14. Other Applicable Statues • Section 404 Clean Water Act • Section 10 River and Harbors Act • Section 401 Clean Water Act • Endangered Species Act • Coastal Zone Management Act • National Historic Preservation Act • Marine Mammal Protection Act • Migratory Bird Protection Act • Magnuson-Stevenson Fishery Act • Applicable State Regulations

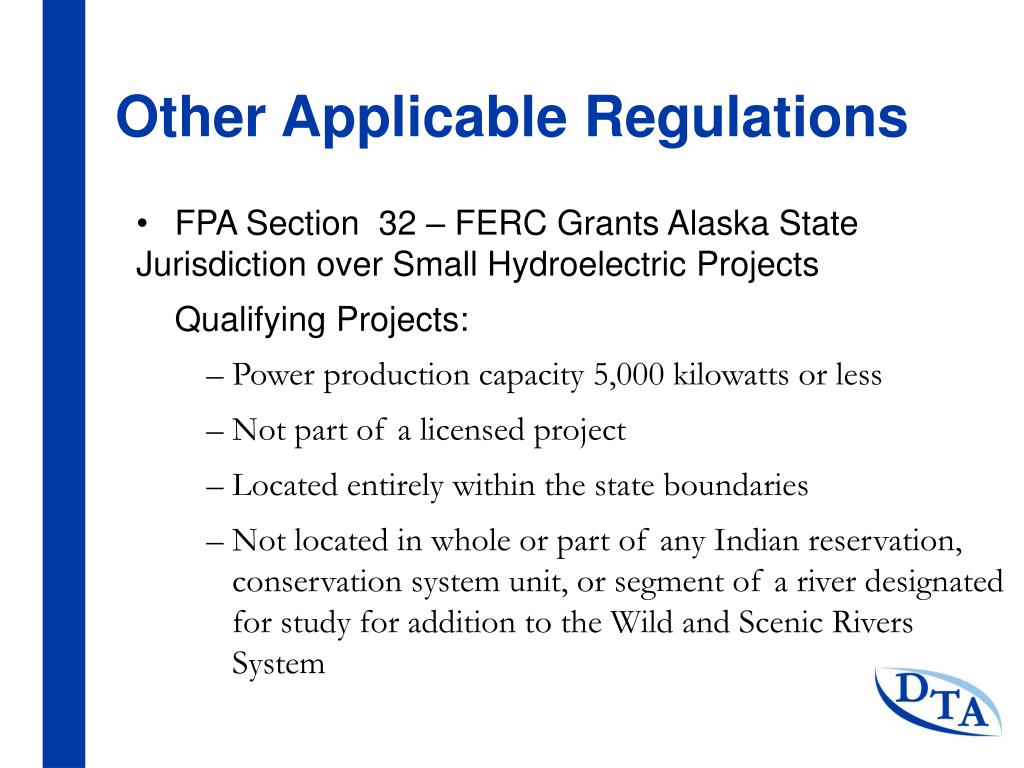

  15. Other Applicable Regulations • FPA Section 32 – FERC Grants Alaska State Jurisdiction over Small Hydroelectric Projects Qualifying Projects: • Power production capacity 5,000 kilowatts or less • Not part of a licensed project • Located entirely within the state boundaries • Not located in whole or part of any Indian reservation, conservation system unit, or segment of a river designated for study for addition to the Wild and Scenic Rivers System

  16. Other Applicable Regulations • Regulatory Commission of Alaska • Jan 31, 2003 AS 42.45.350 effectively states that RCA shall adopt regulations to establish a state regulatory program for qualifying water power development projects • RCA must protect the public interest and environment to the same extent provided by the FPA, the Endangered Species Act, and other applicable federal laws, i.e. Clean Water Act (Section 401) • Status - Ongoing

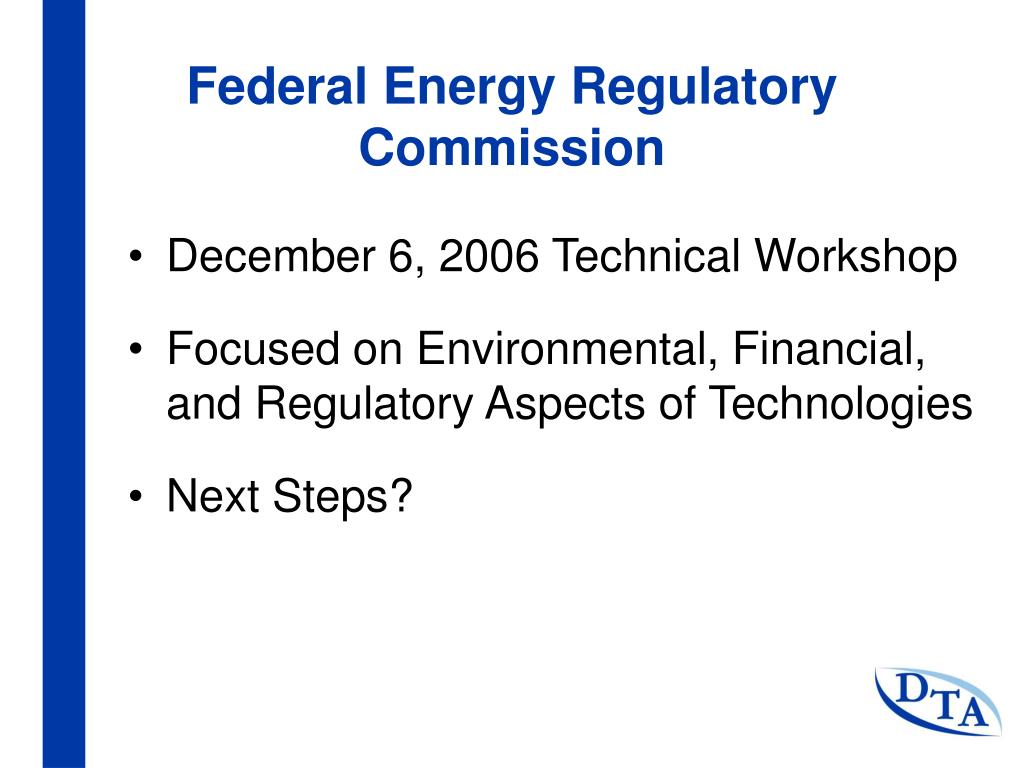

  17. Federal Energy Regulatory Commission • December 6, 2006 Technical Workshop • Focused on Environmental, Financial, and Regulatory Aspects of Technologies • Next Steps?

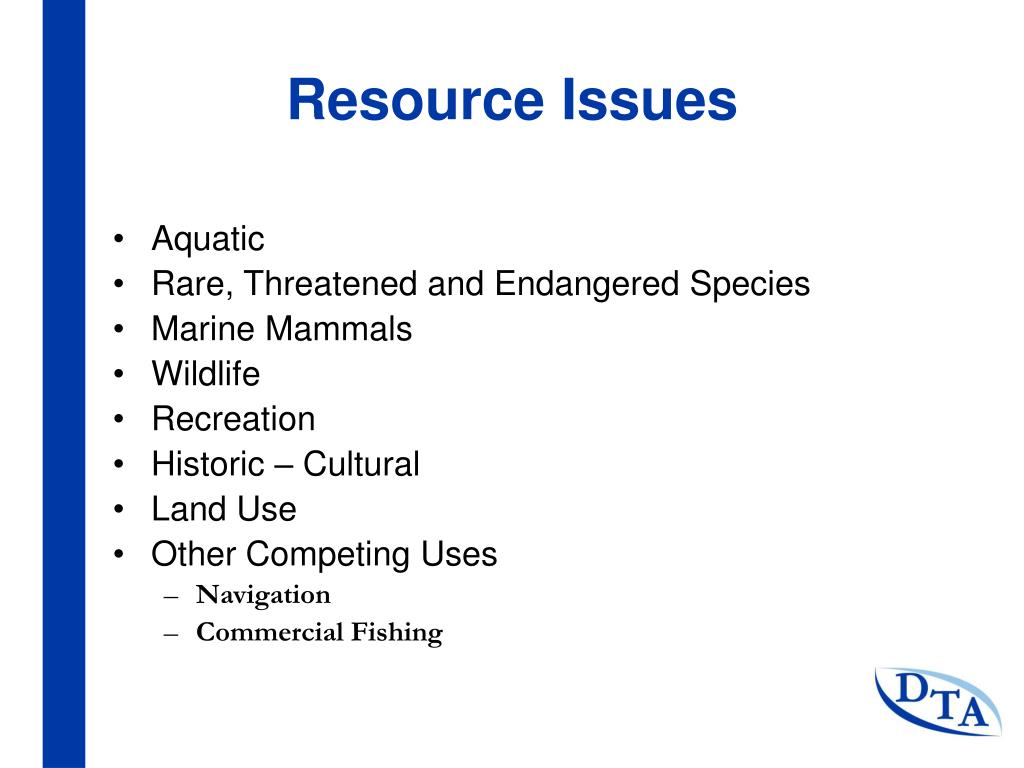

  18. Resource Issues • Aquatic • Rare, Threatened and Endangered Species • Marine Mammals • Wildlife • Recreation • Historic – Cultural • Land Use • Other Competing Uses • Navigation • Commercial Fishing

  19. Process Issues 36 Pending Preliminary Tidal Permit applications at FERC Adequate progress during permit term Preliminary Permit term versus licensing process Overlapping boundaries Competing applications Site banking

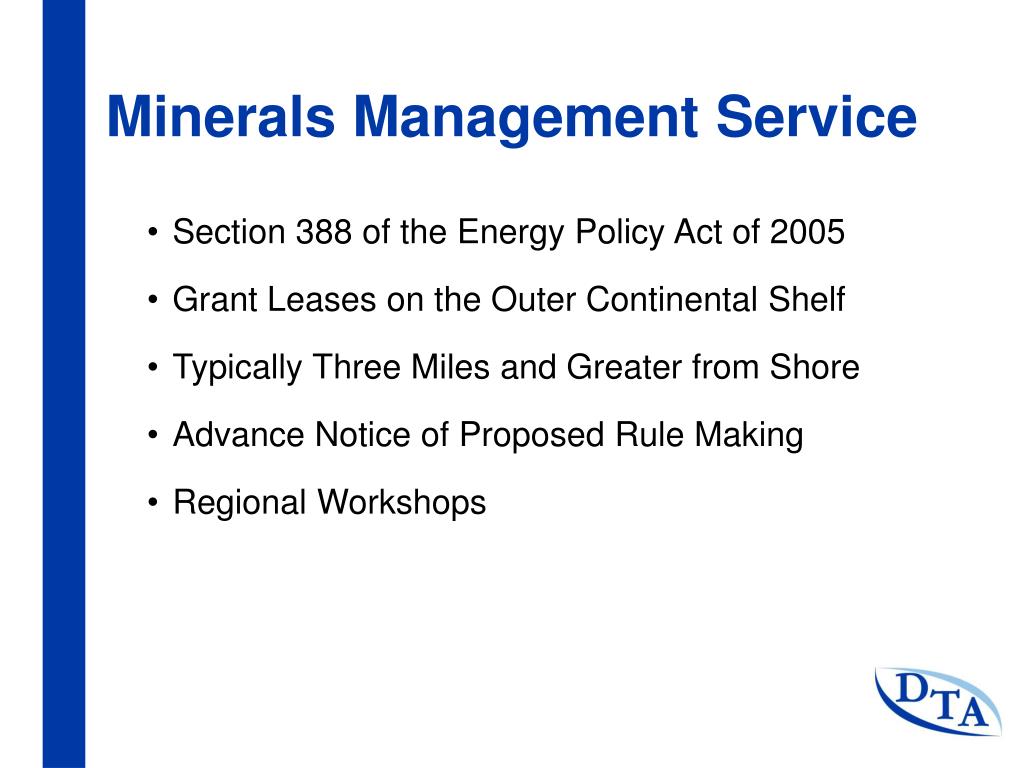

  20. Minerals Management Service • Section 388 of the Energy Policy Act of 2005 • Grant Leases on the Outer Continental Shelf • Typically Three Miles and Greater from Shore • Advance Notice of Proposed Rule Making • Regional Workshops

  21. Additional Information Michael Murphy 207.233.8291 (Cell) 207.775.4495 (Office)
